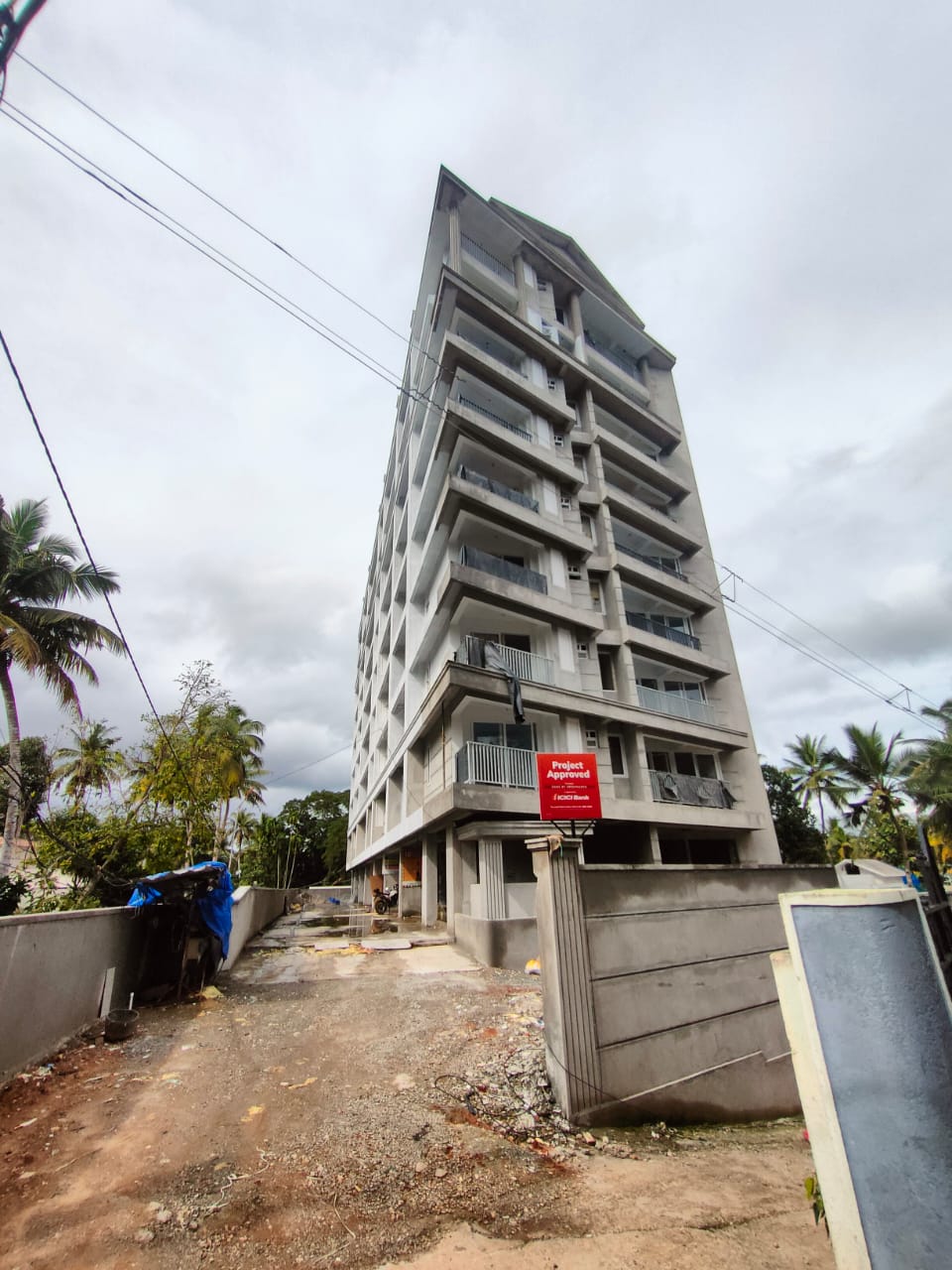

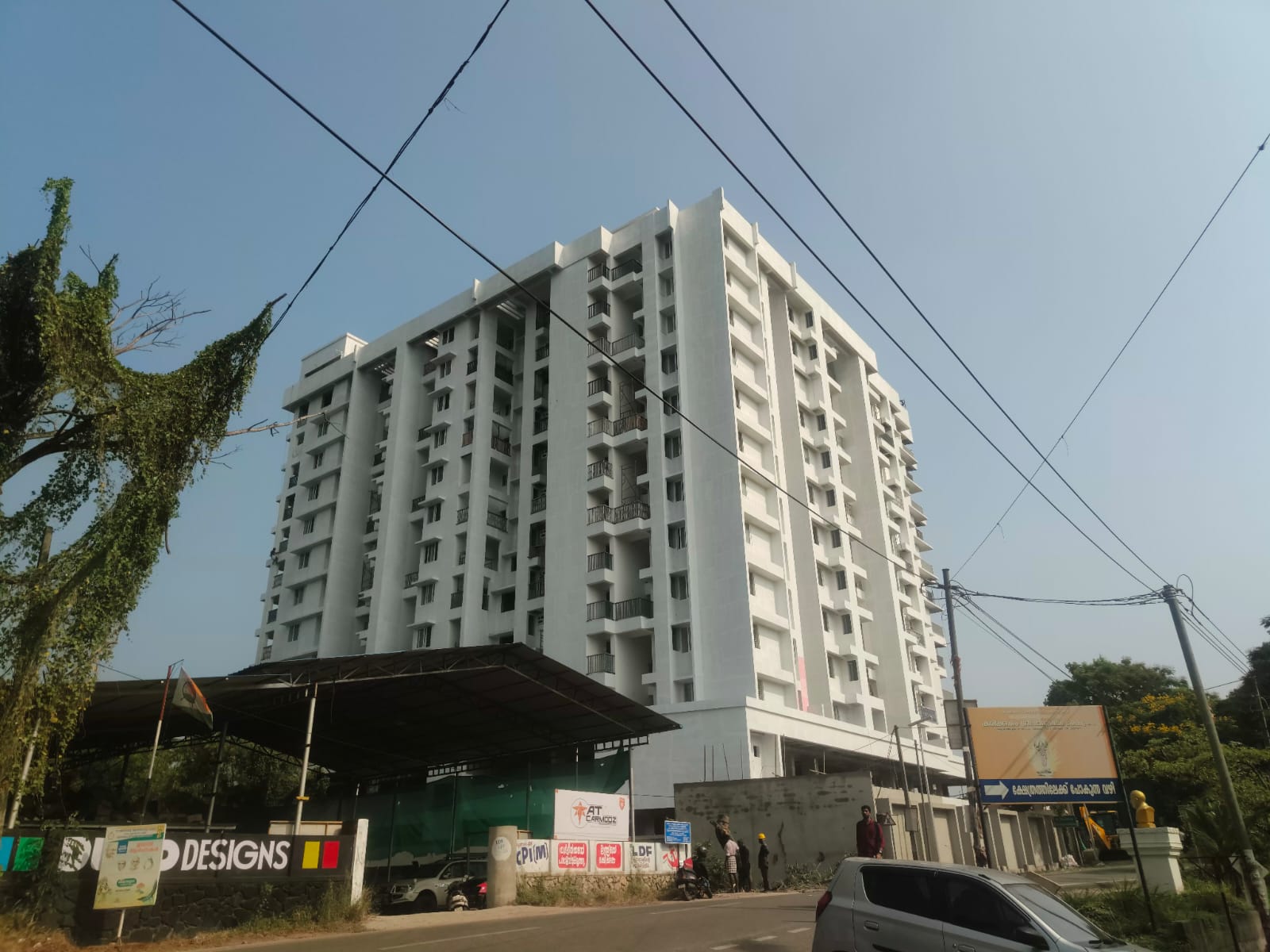

ROME
ROME
BY SREEDHANYA HOMES
AFFORDABLE LUXURY WITH A ROMAN ACCENT
2&3 BHK APARTMENTS – MUTTADA
Sree Dhanya’s newest apartment project encapsulates the age-old charm and the luxury of Roman structures with the amenities of the modern age.It’s not everyday that you come across a residence that doubles as a work of art. With forty-two artistically designed 2 & 3 BHK units spread across 8 floors, this residential project promises to be a feast for both the eyes and the soul.Sree Dhanya offers you the regal lifestyle of Rome at a price that will surprise you. Experience premium lifestyle amenities from the comfort of your home without stepping a foot outside. Get ready, the time has come to embrace affordable luxury.
HIGHLIGHTS
LOCATION
Strategically developed to ensure both connectivity and privacy, Rome is nestled in the heart of Trivandrum and offers easy accessibility to leading colleges, schools, malls, hospitals, and other important locations in the city.
Community Features:
- Multi-purpose recreation hall with indoor games

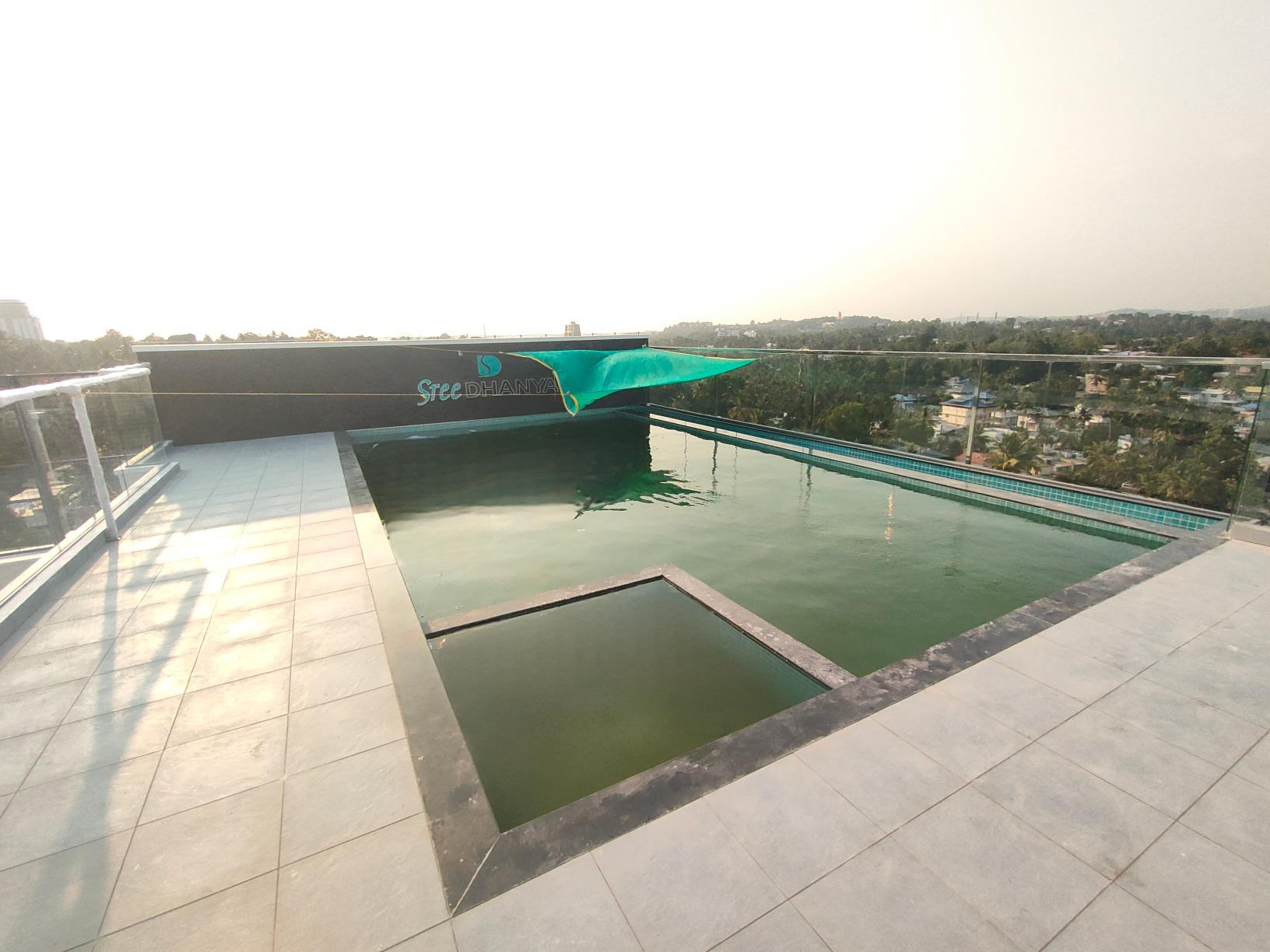

- Rooftop swimming pool

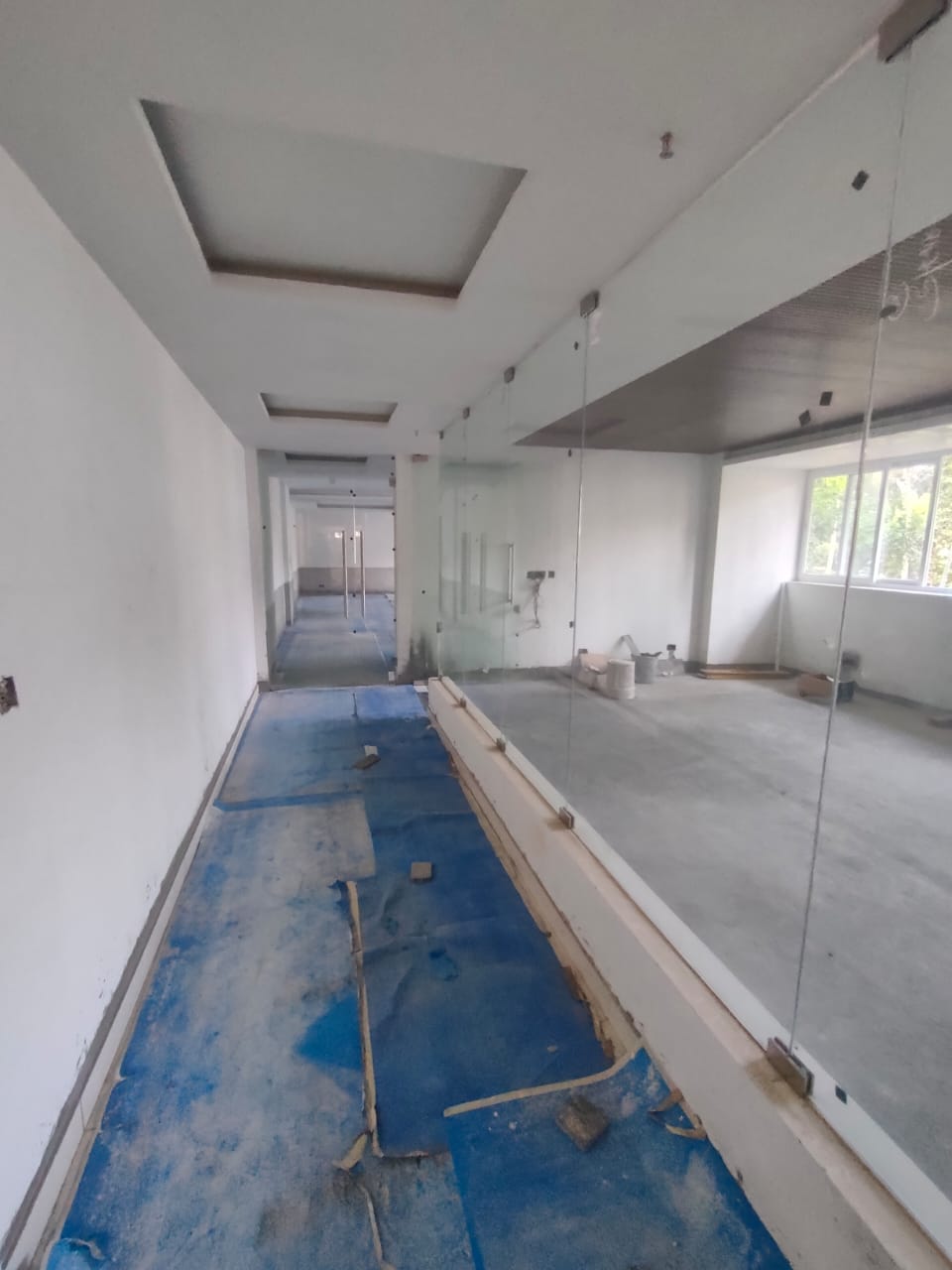

- AC Gym

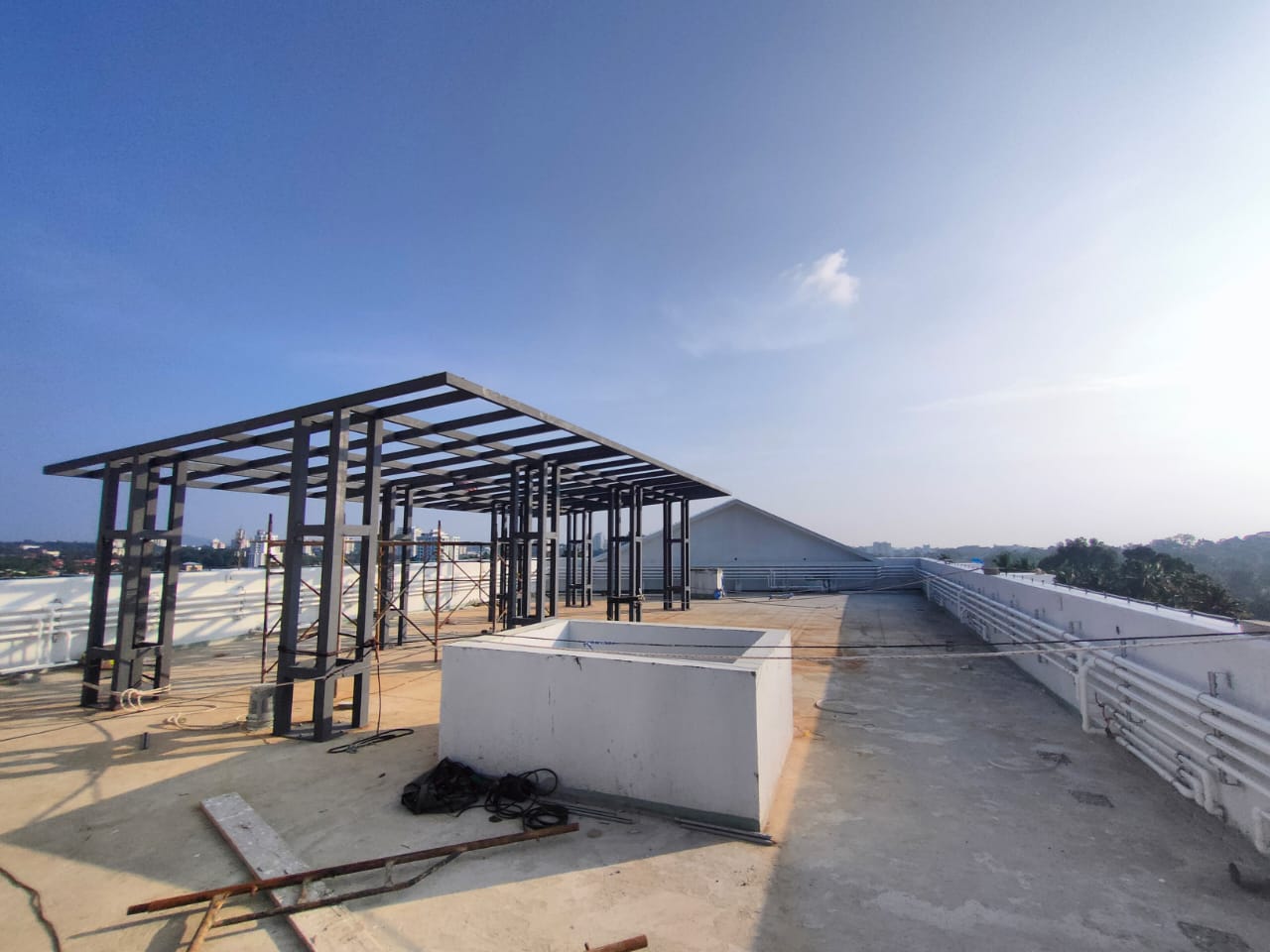

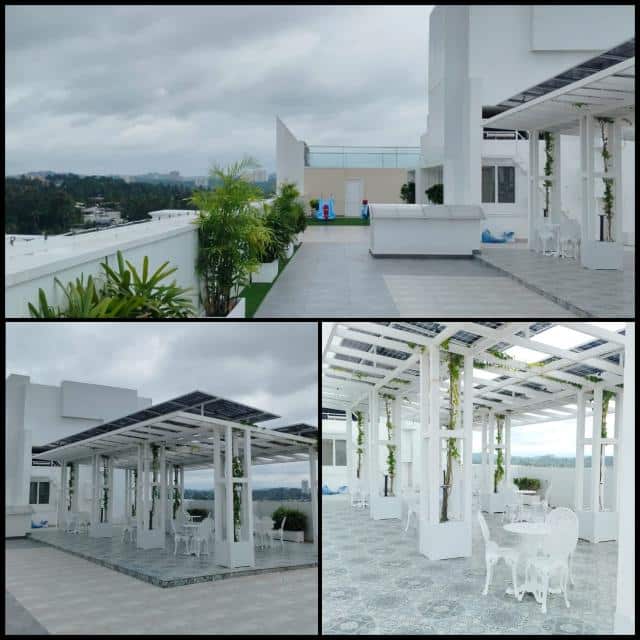

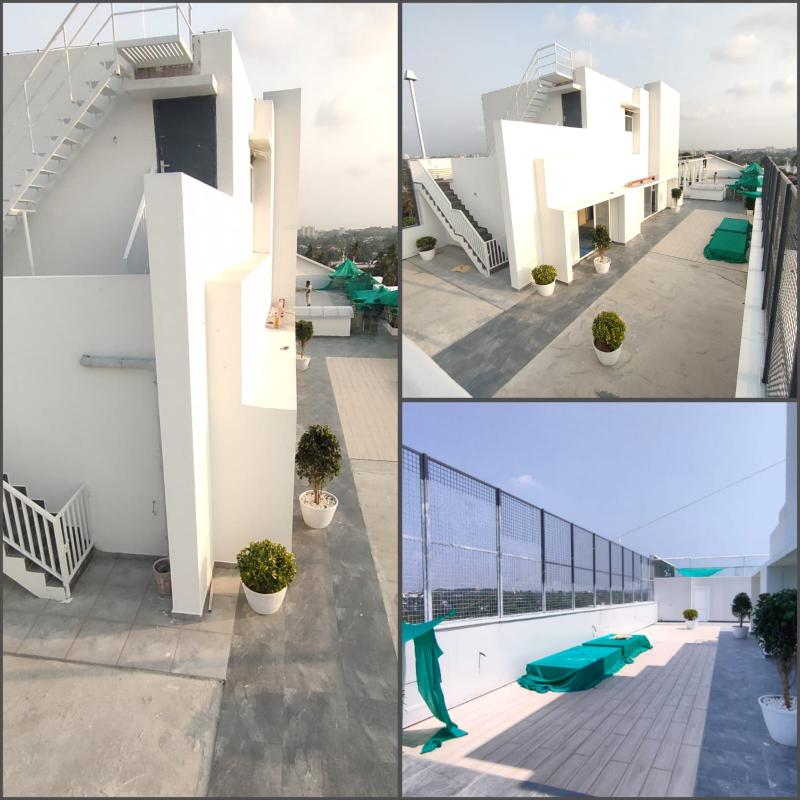

- Rooftop party area
- Driver’s room
- Caretaker’s room
- 24 hrs Generator backup

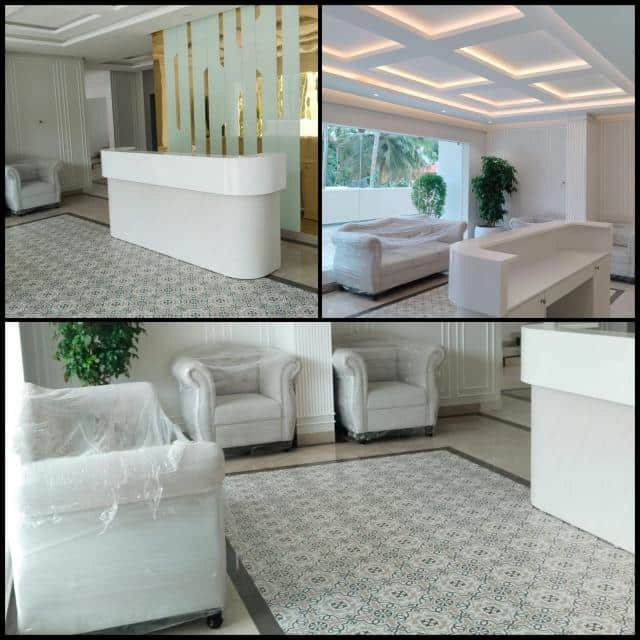

- Grand lobby
- Mini movie theater
- Waste management system
Security Features:
- Round-the-clock security
- CCTV surveillance
- Access control video door phone
Eco Features:

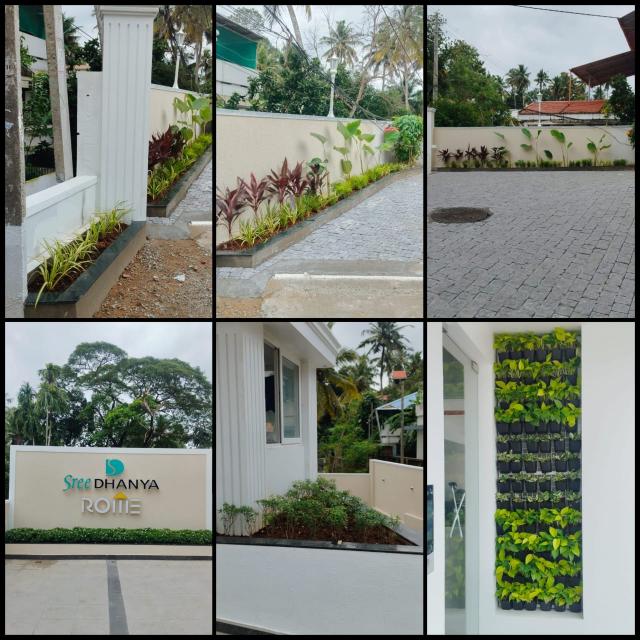

- Landscaped greenery
- Rainwater harvesting
- Solar panels

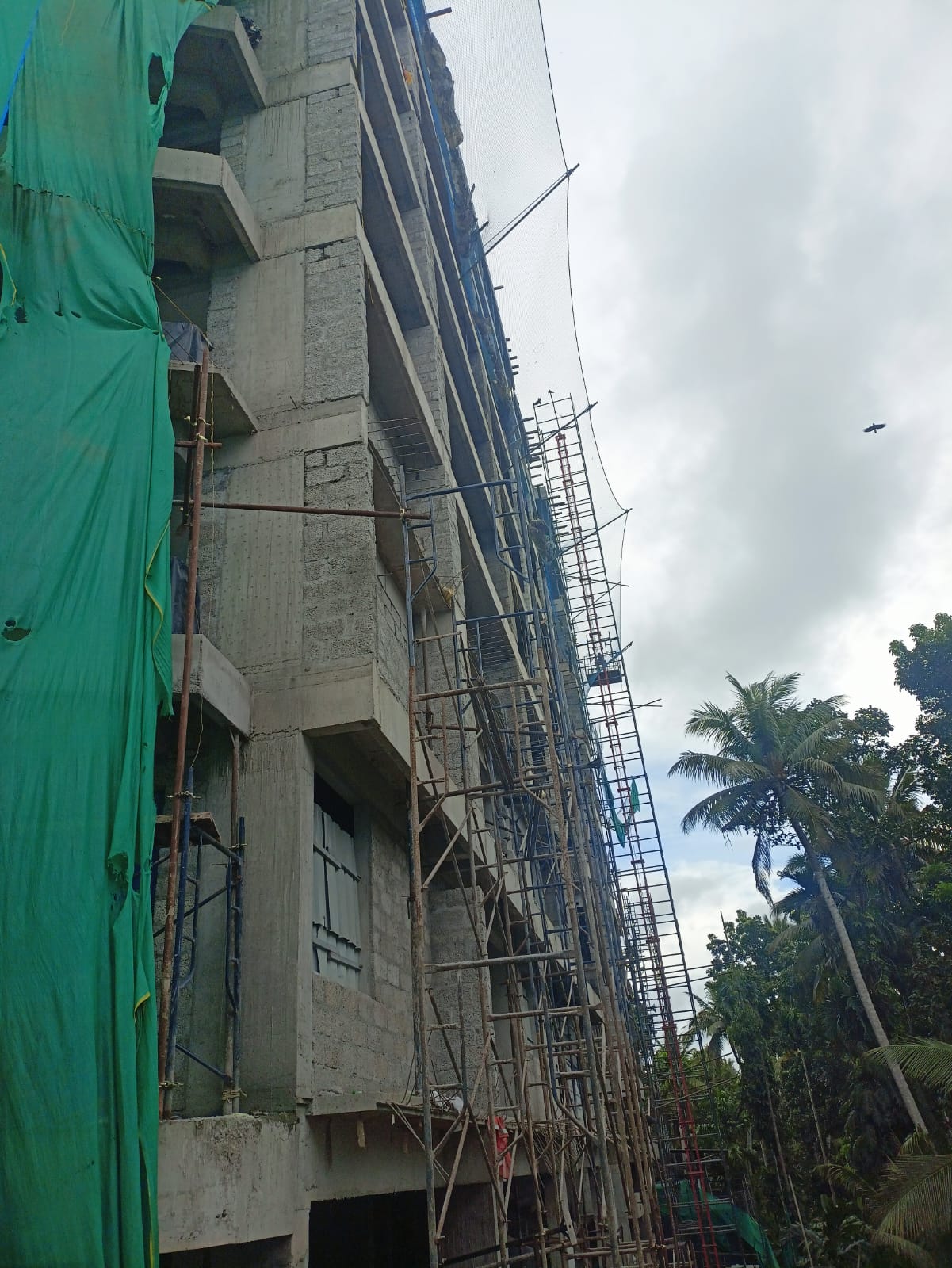

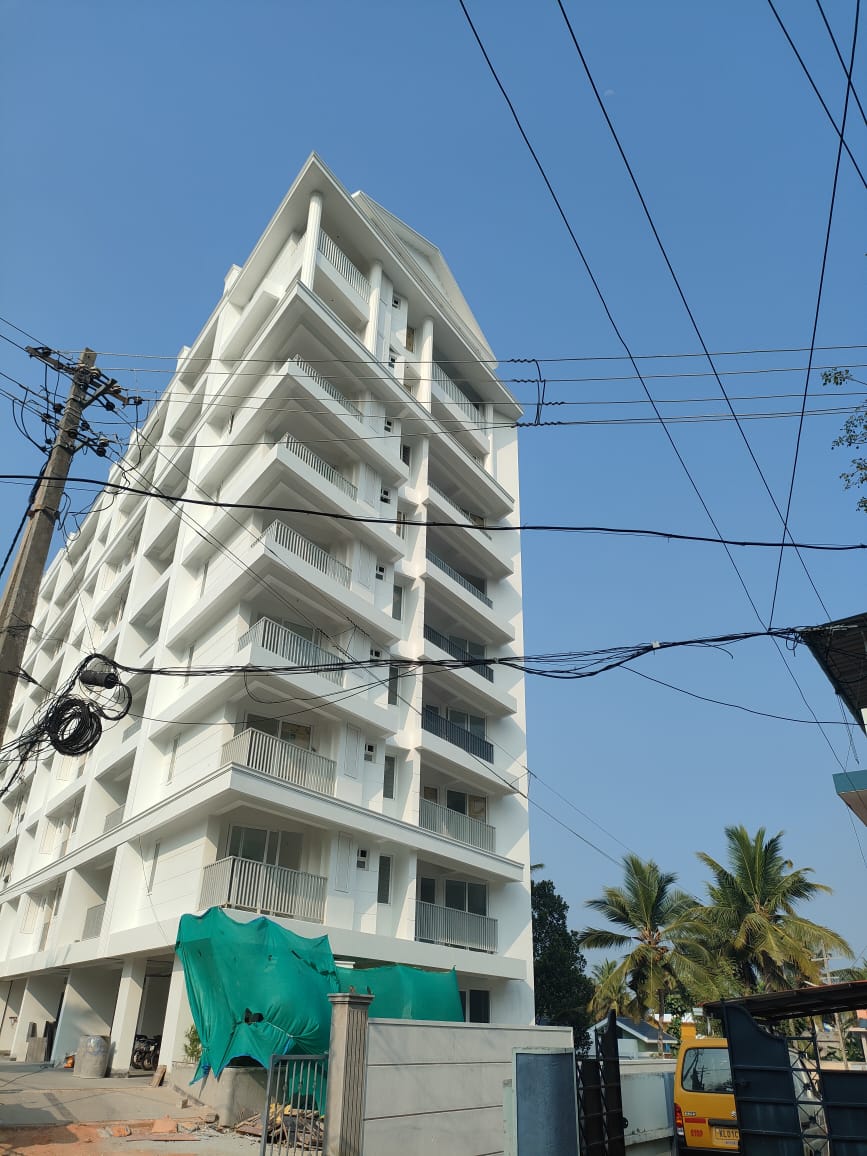

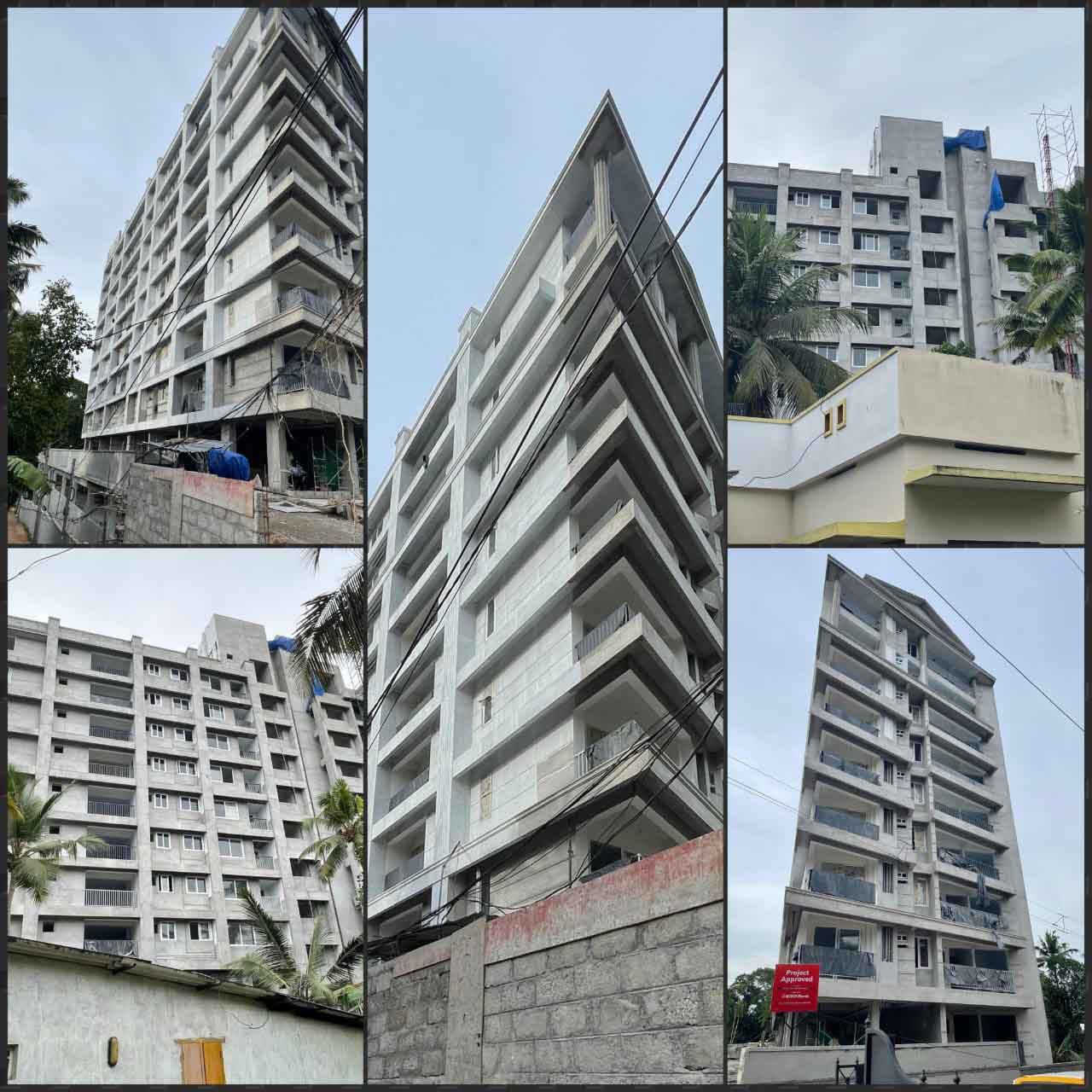

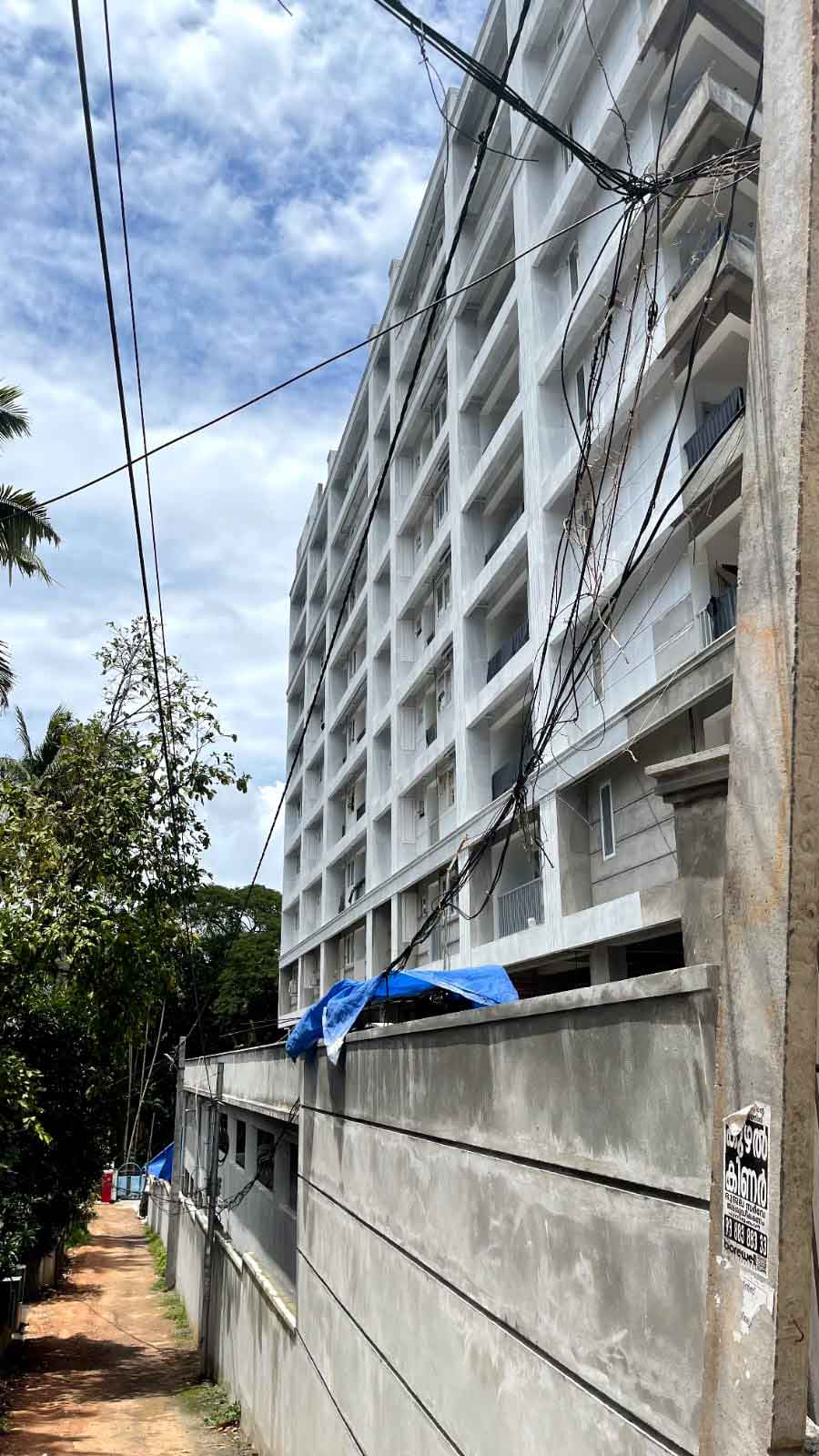

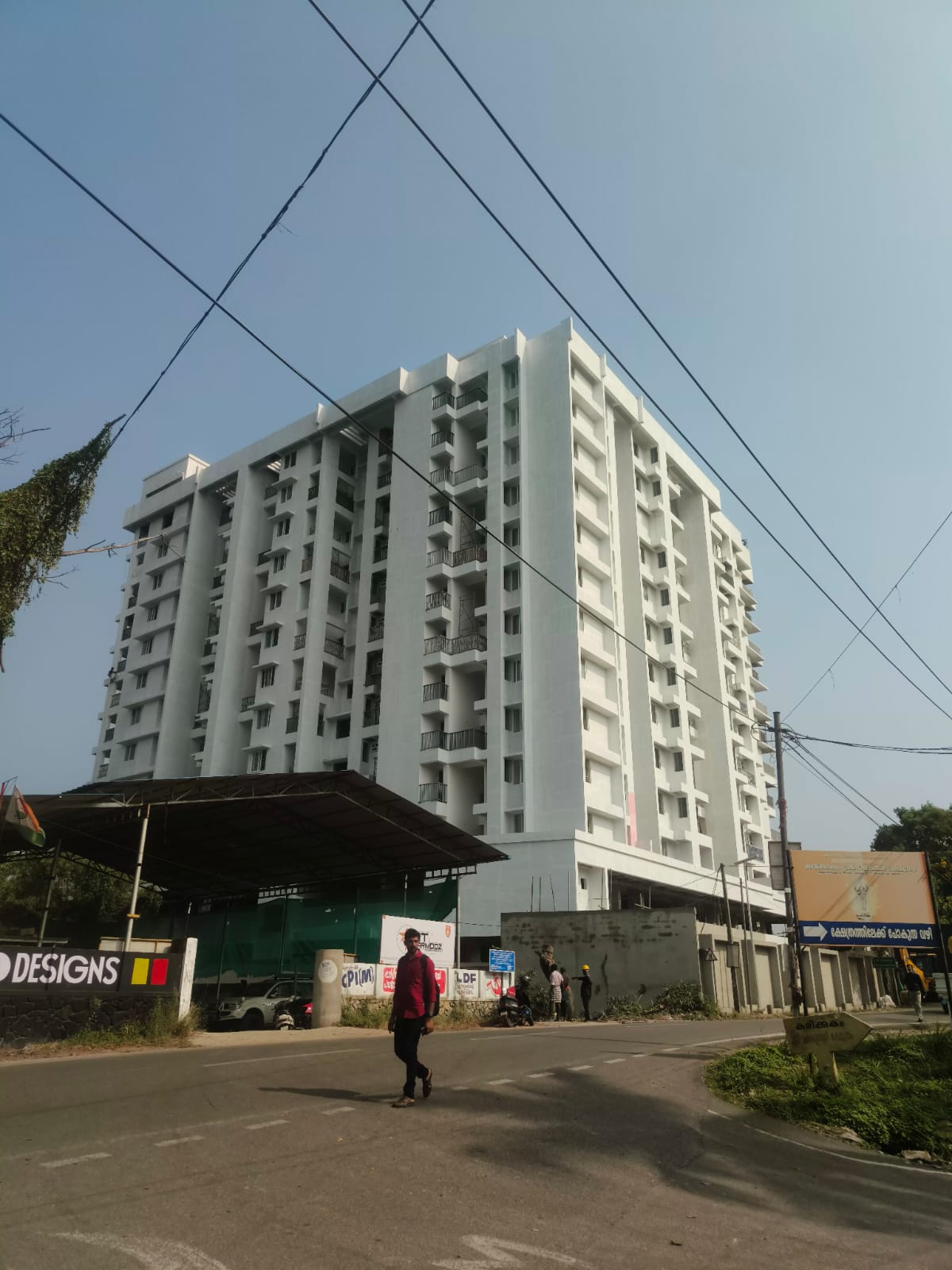

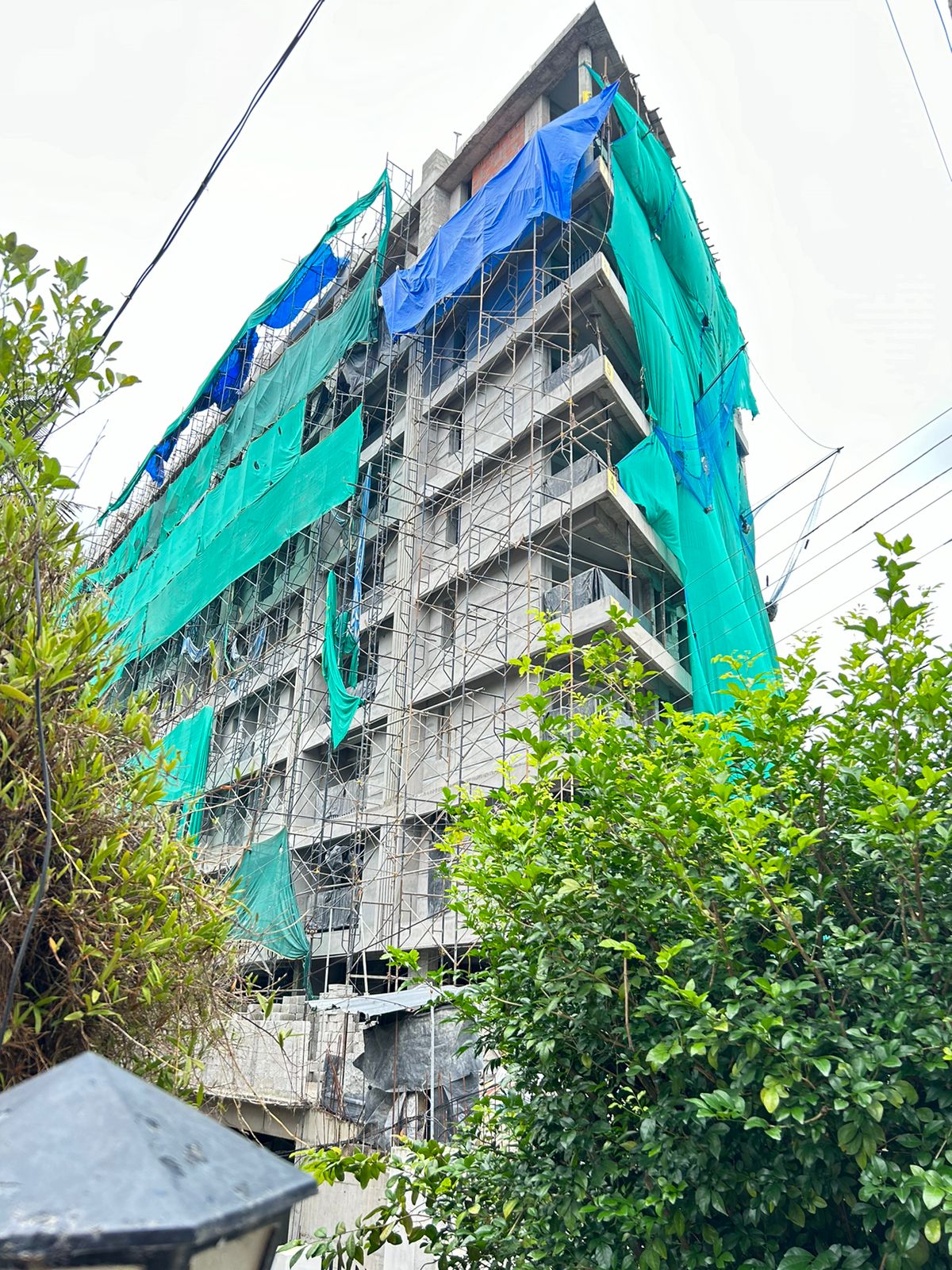

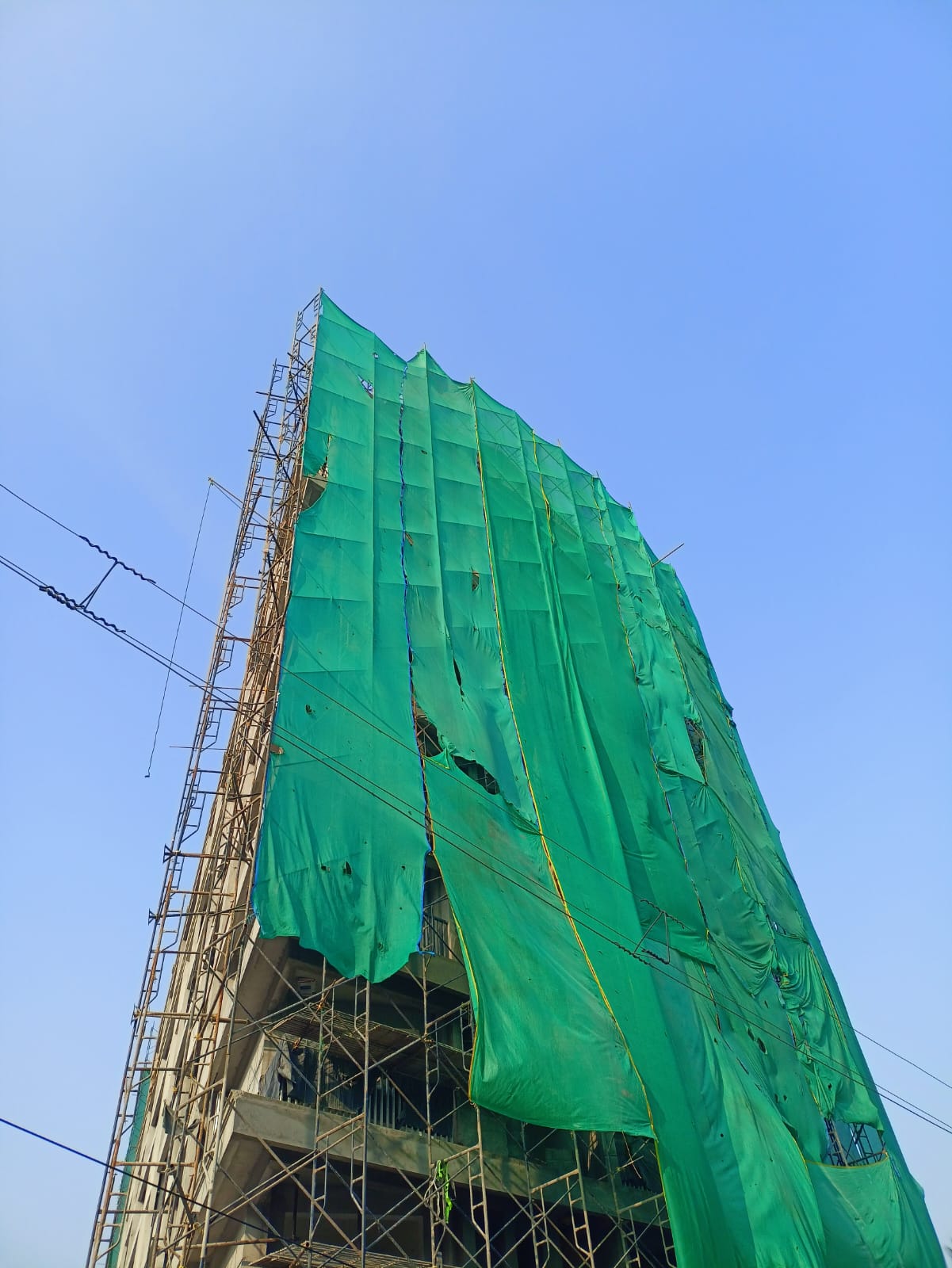

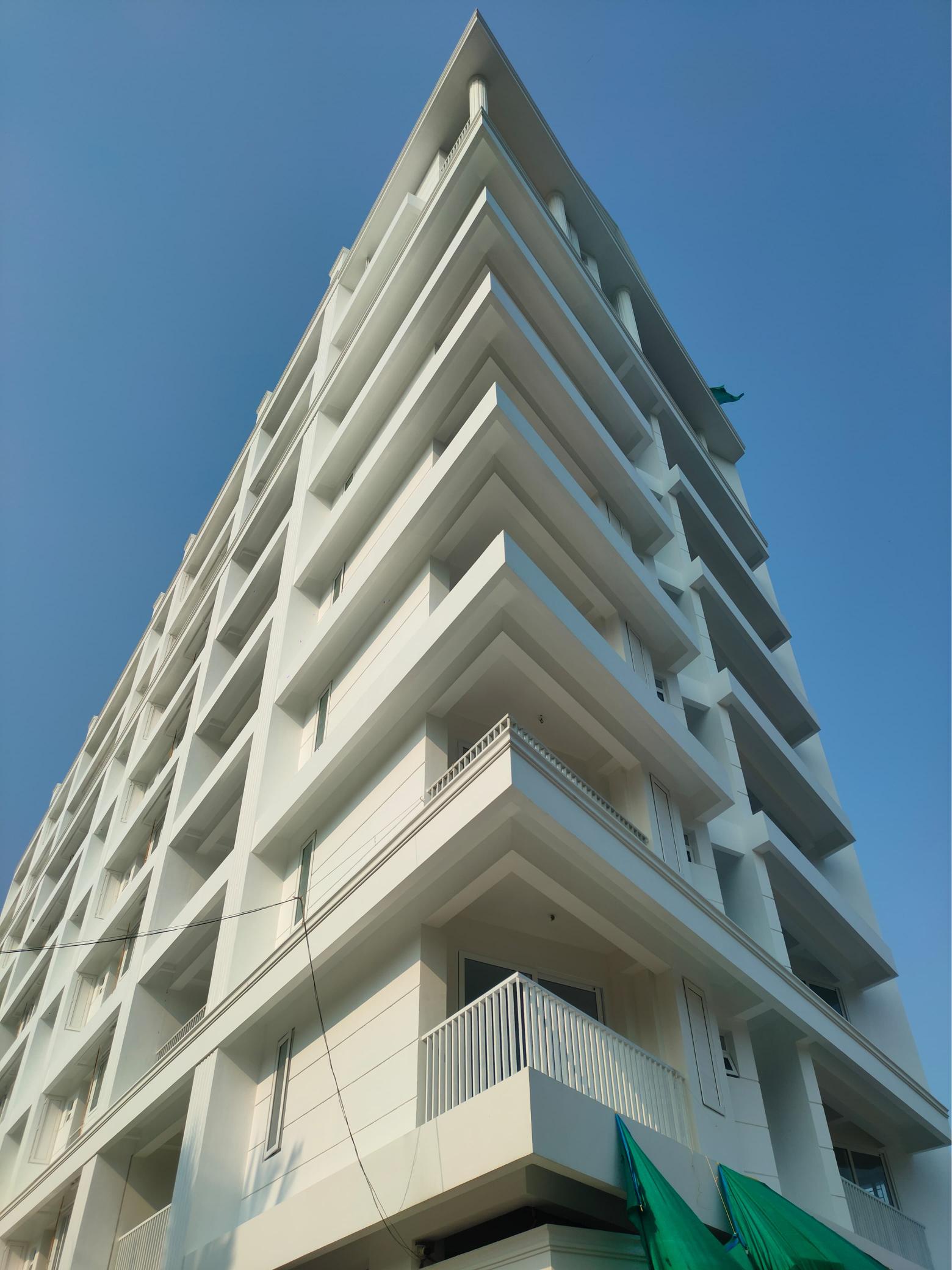

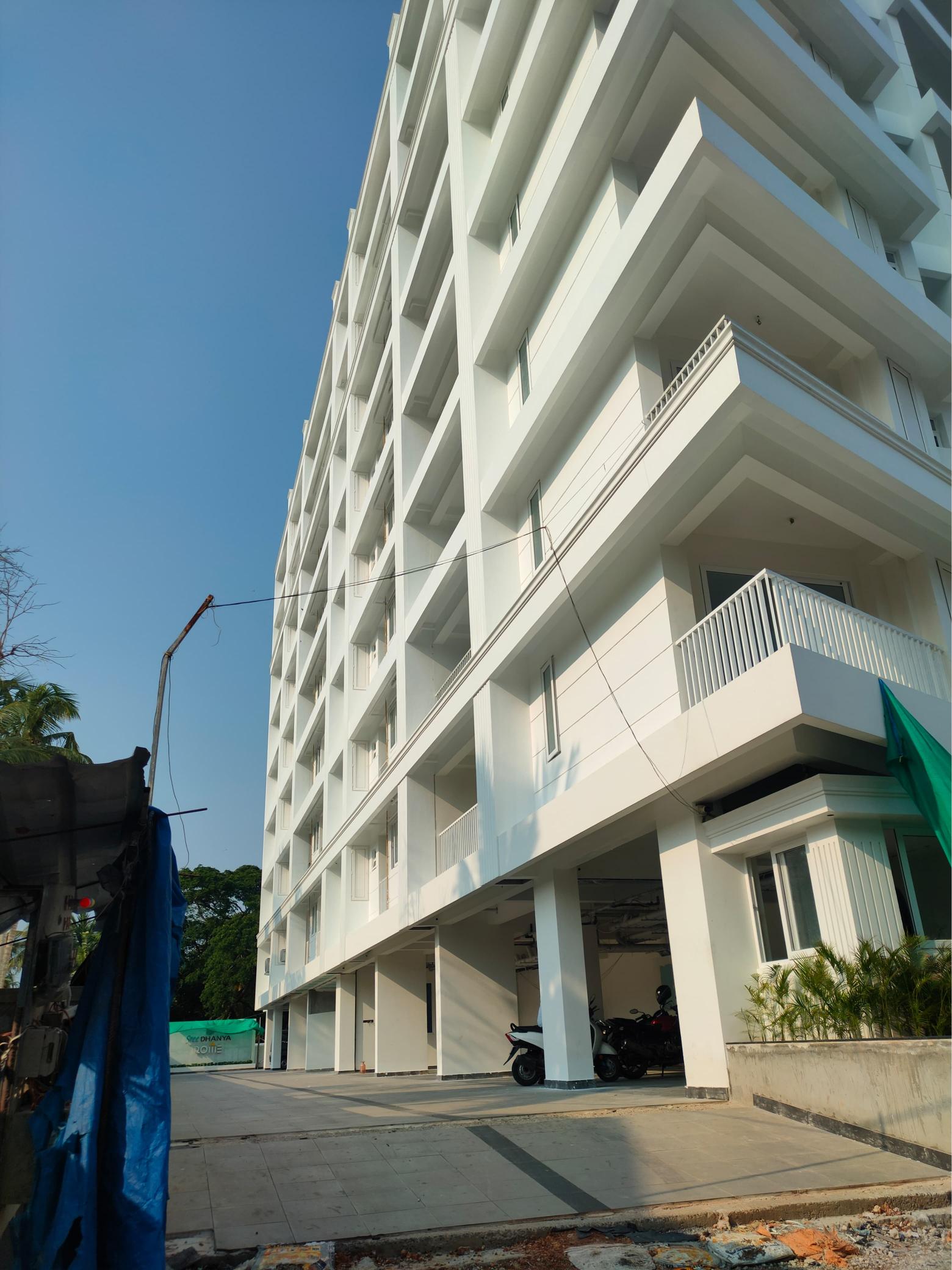

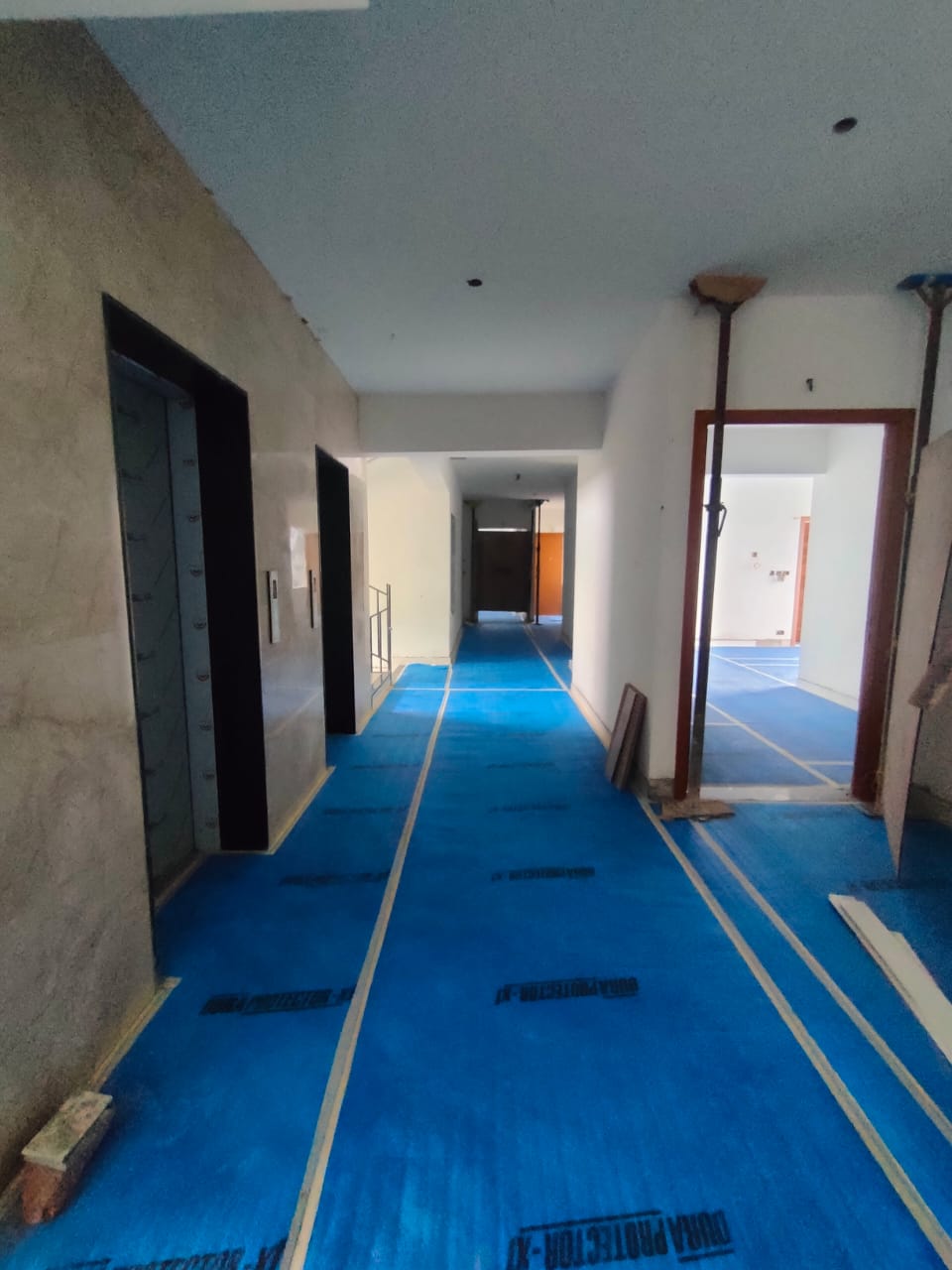

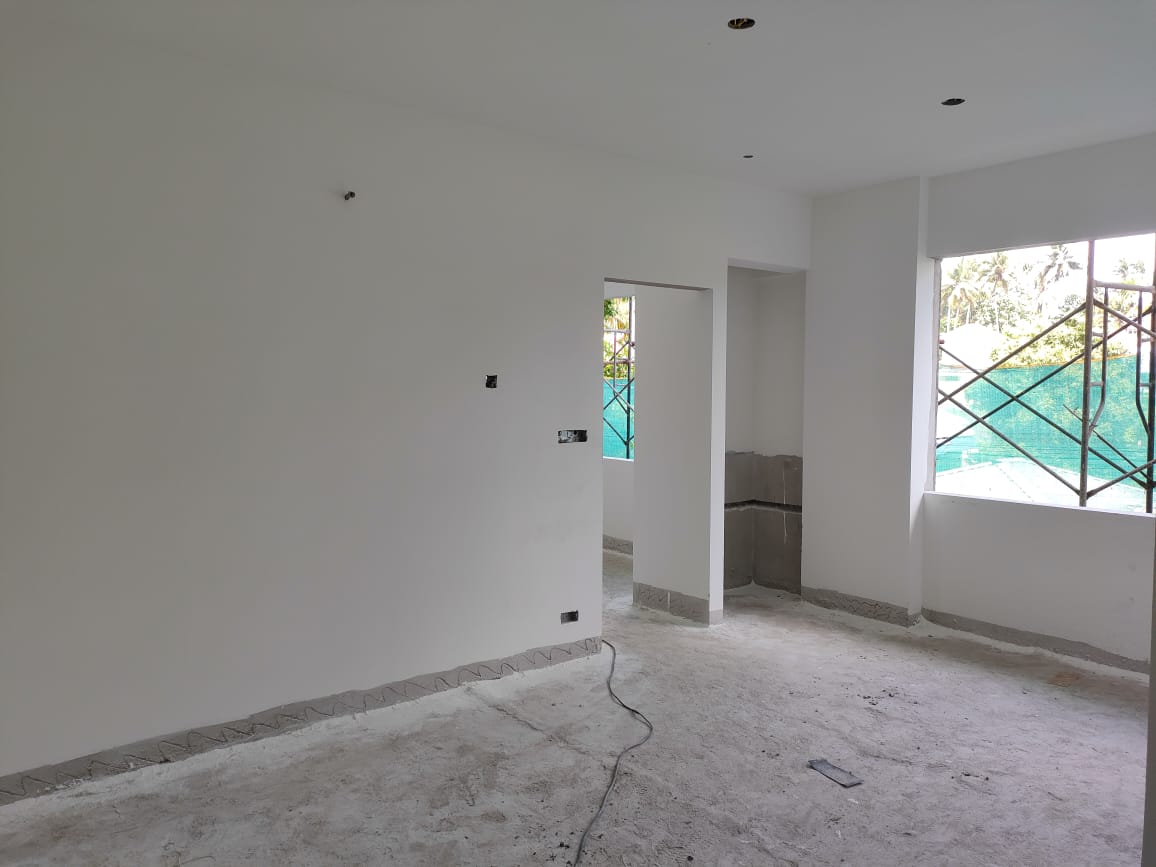

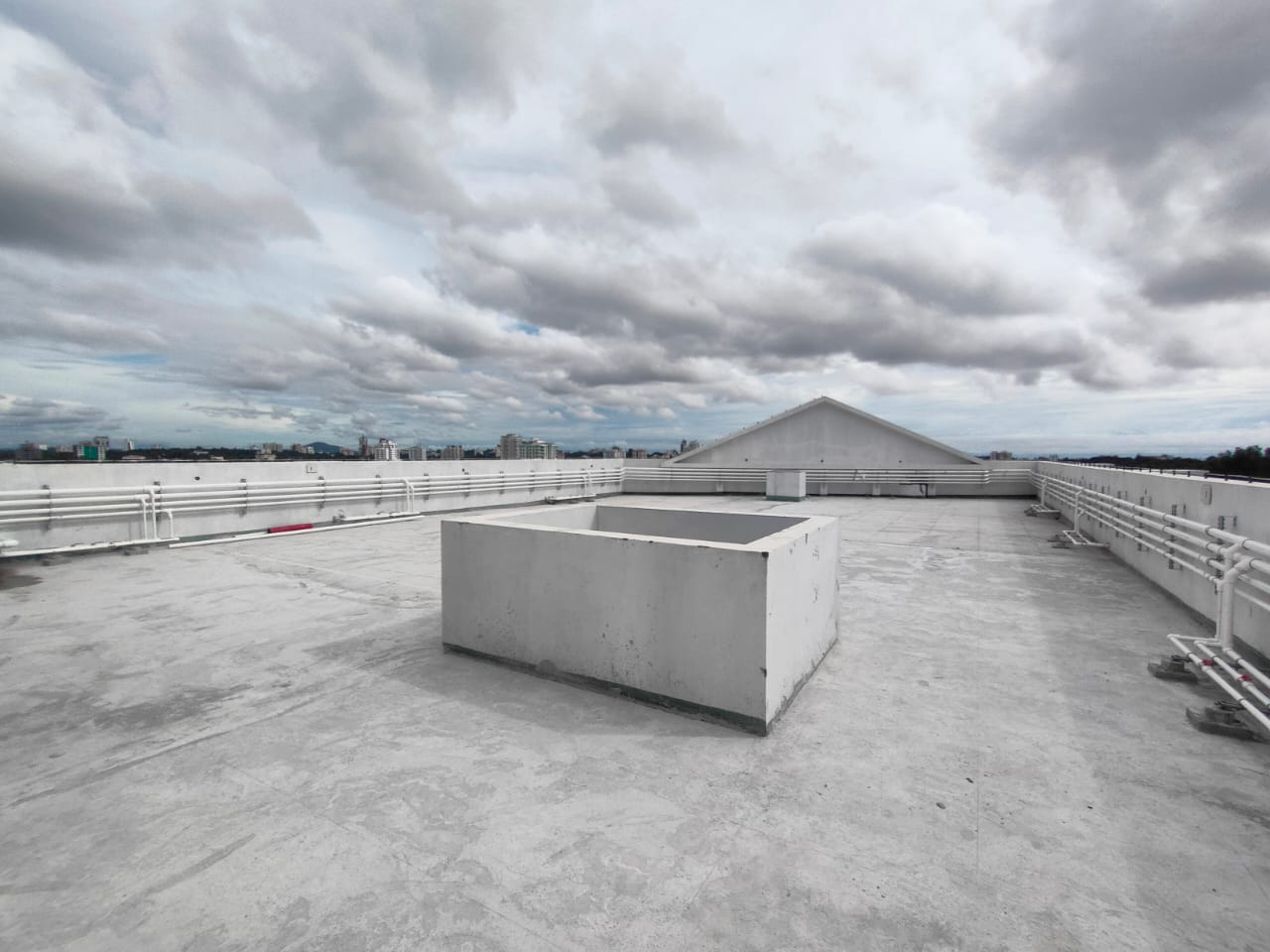

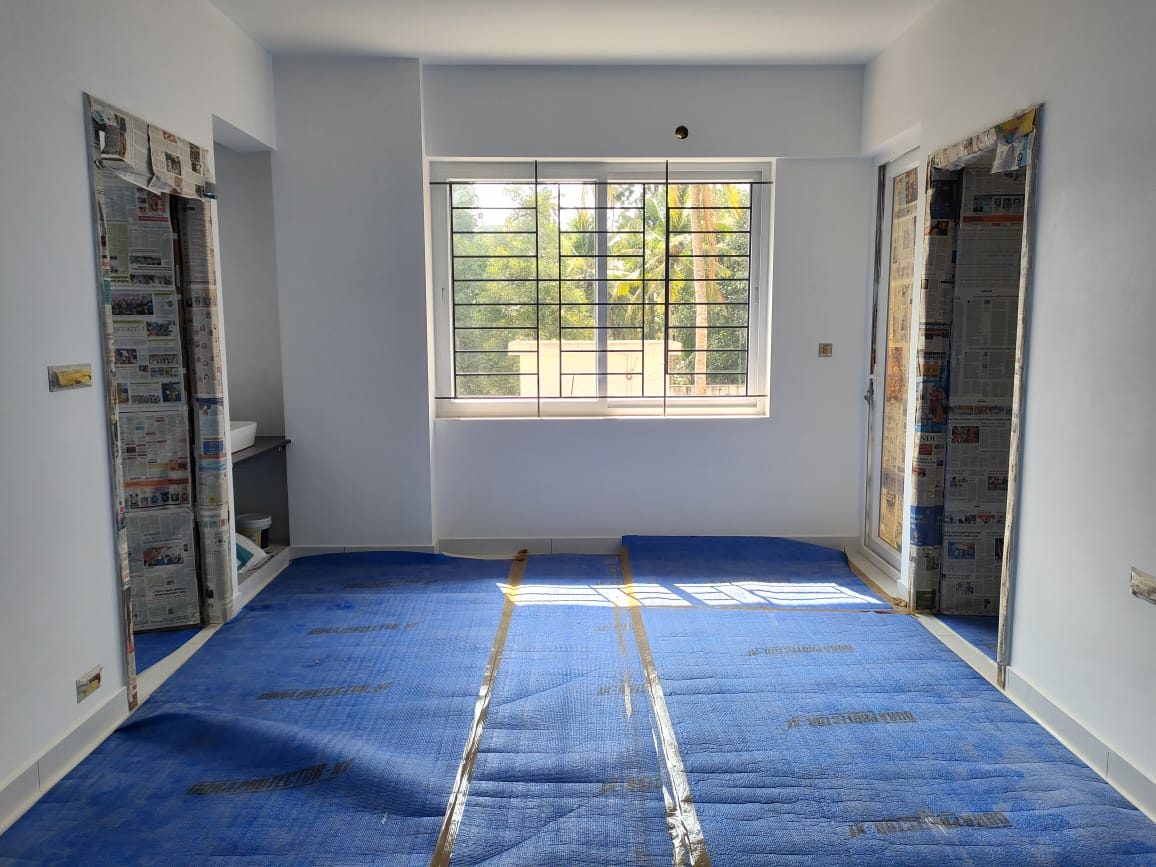

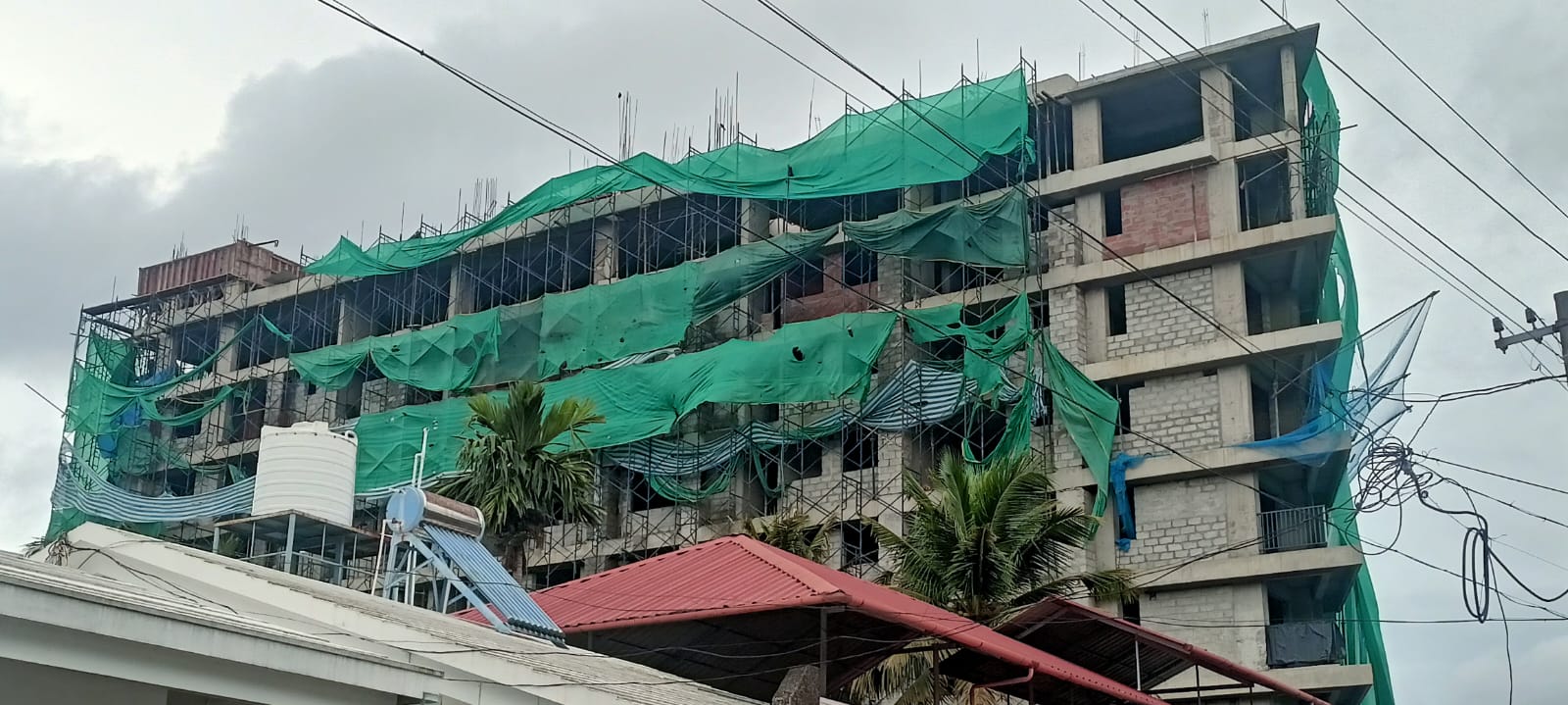

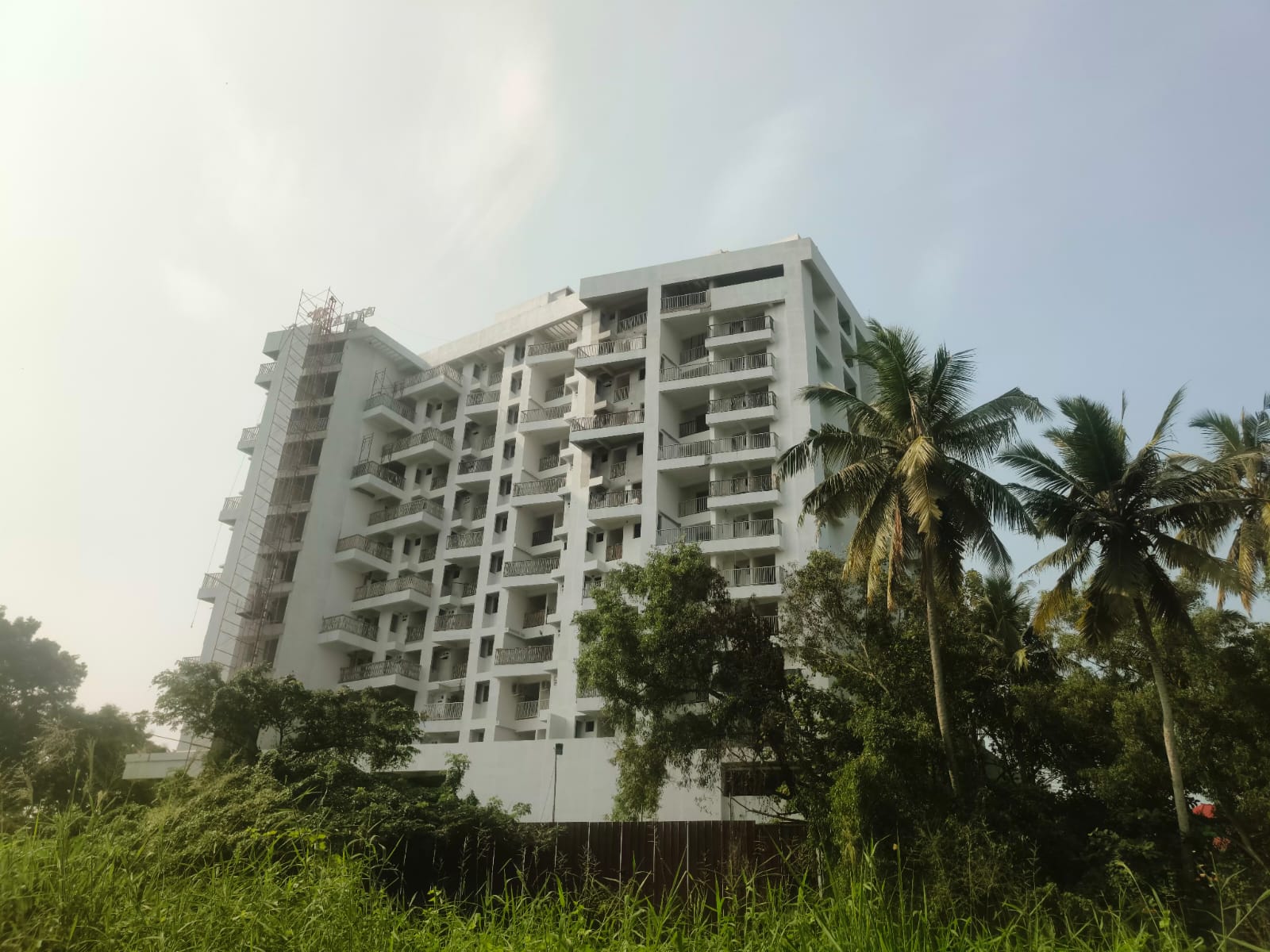

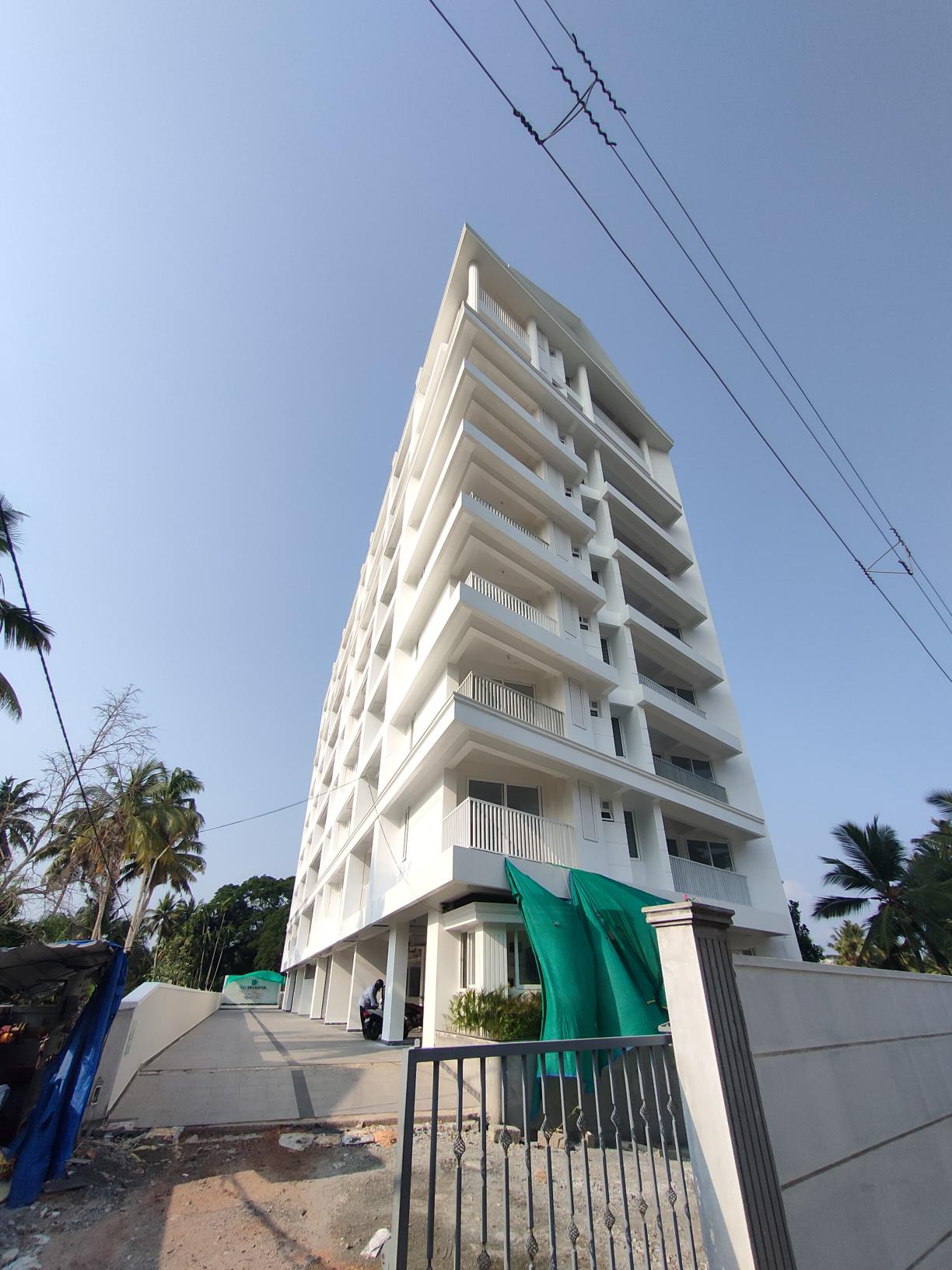

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS ON 14th December 2024

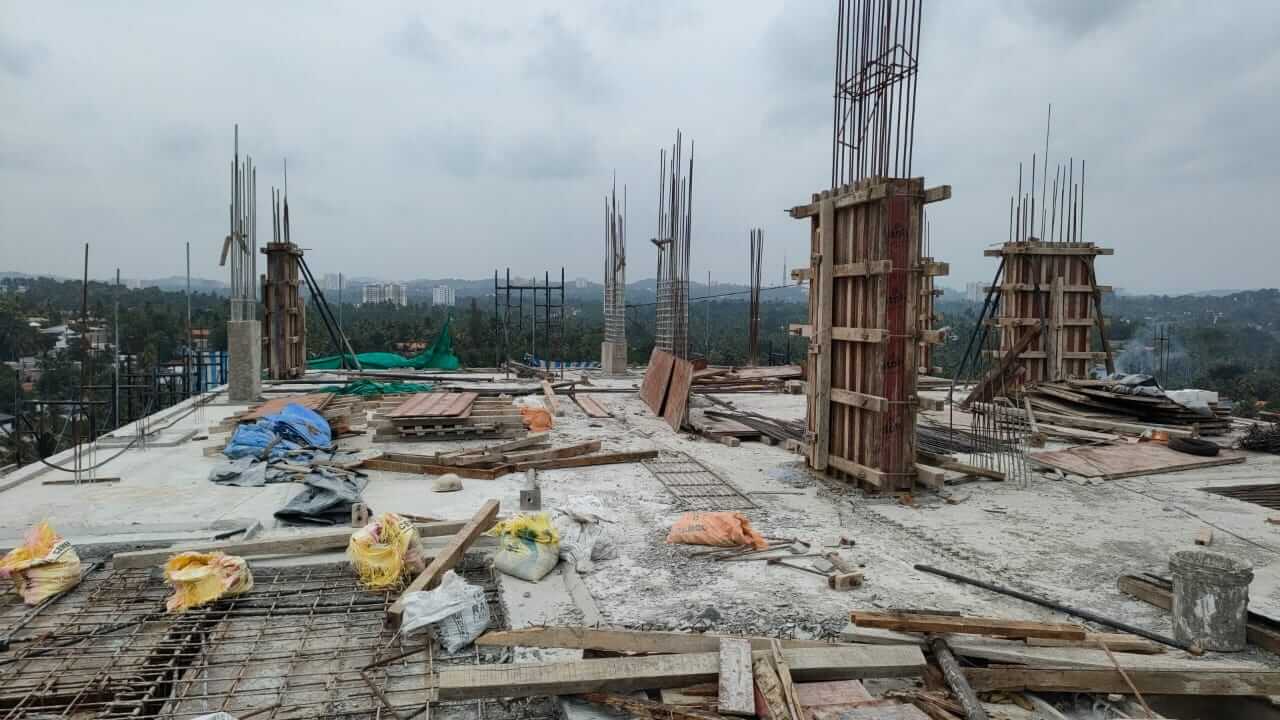

- RCC for Terrace Floor – 100% Completed
- Ceiling Plastering – 39/39 Apartments Completed
- Block Masonry – 39/39 Apartments Completed
- Inside Wall Plastering – 39/39 Apartments Completed

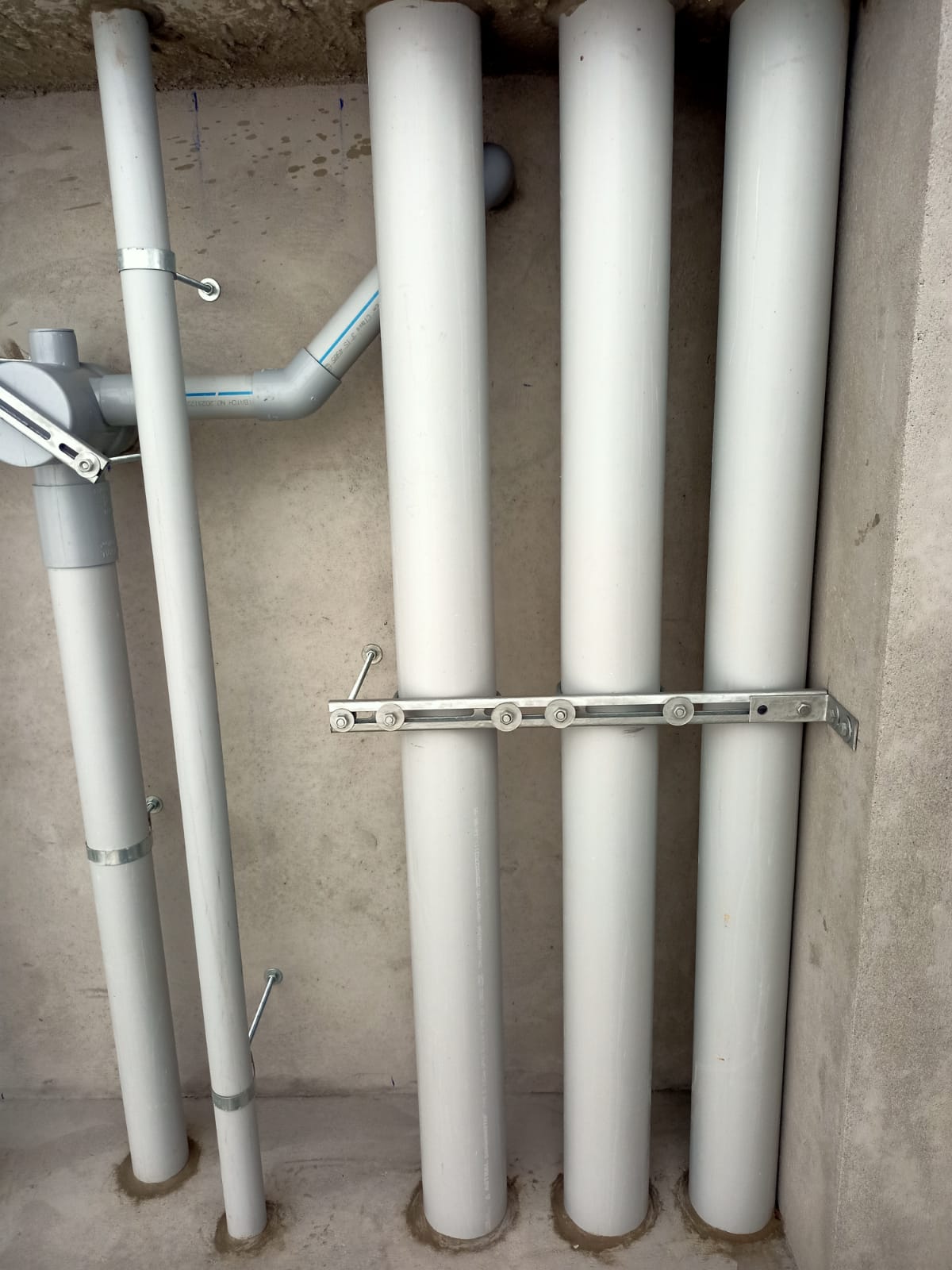

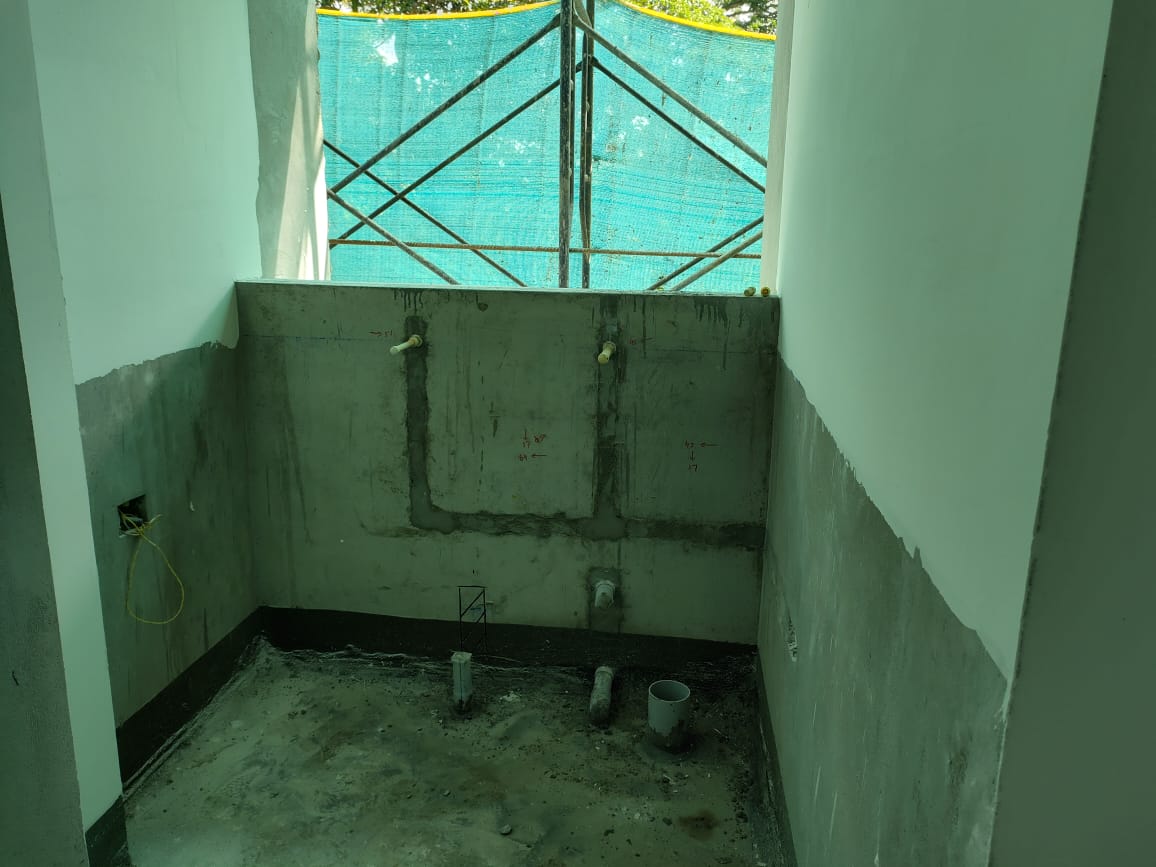

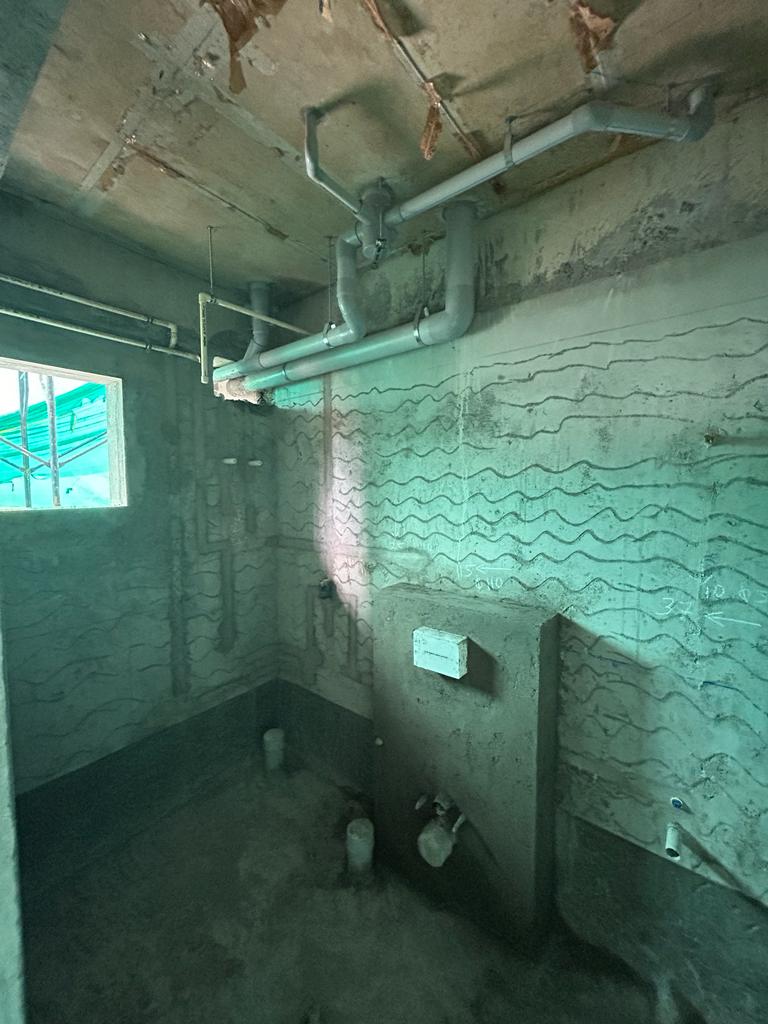

- Internal Plumbing Work – 39/39 Apartments Completed
- Plumbing Work in Duct – 18/18 Apartments Completed
- Apartment Internal Waterproofing – 39/39 Apartments Completed

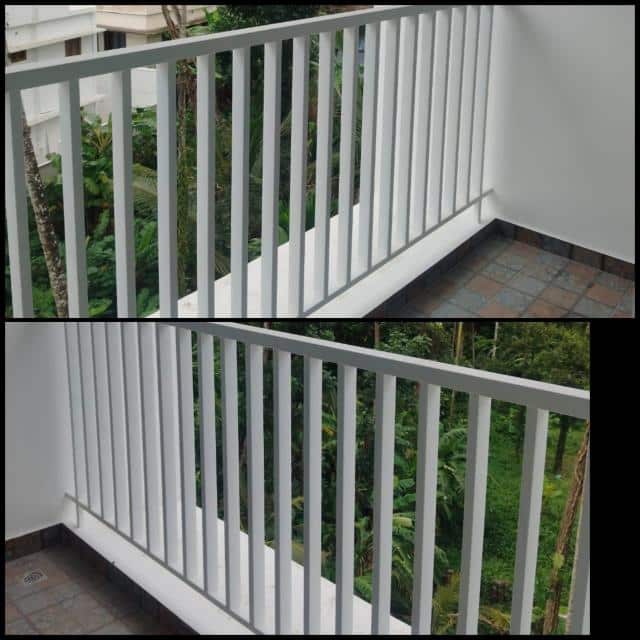

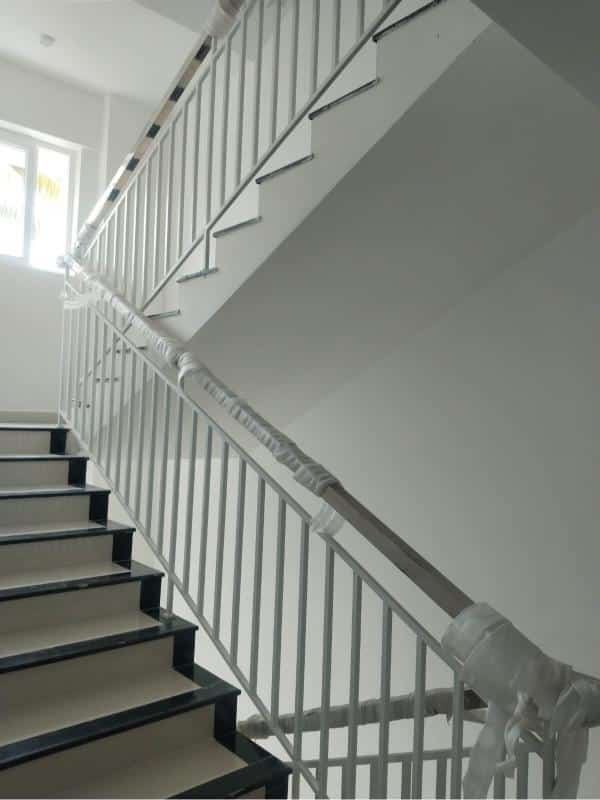

- Balcony Handrail Fixing – 39/39 Apartments Completed

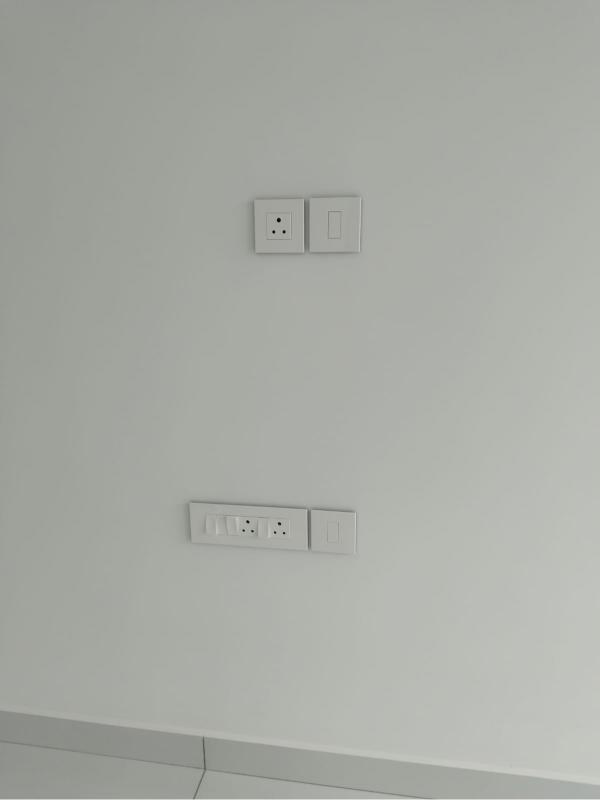

- Electrical Wall Chasing & Conduiting – 39/39 Apartments Completed

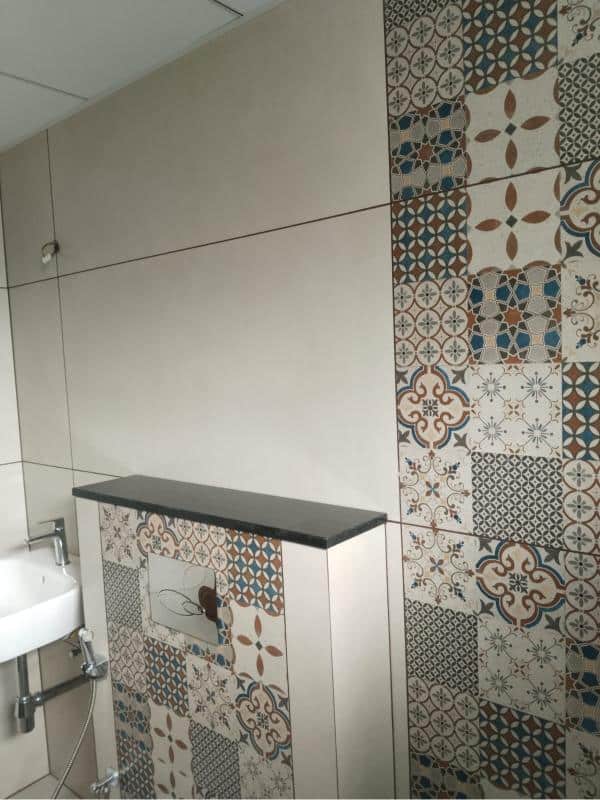

- Wall Tiling Work – 39/39 Apartments Completed
- Floor Tiling Work – 39/39 Apartments Completed
- Passage Flooring – 11/12 Floors Completed

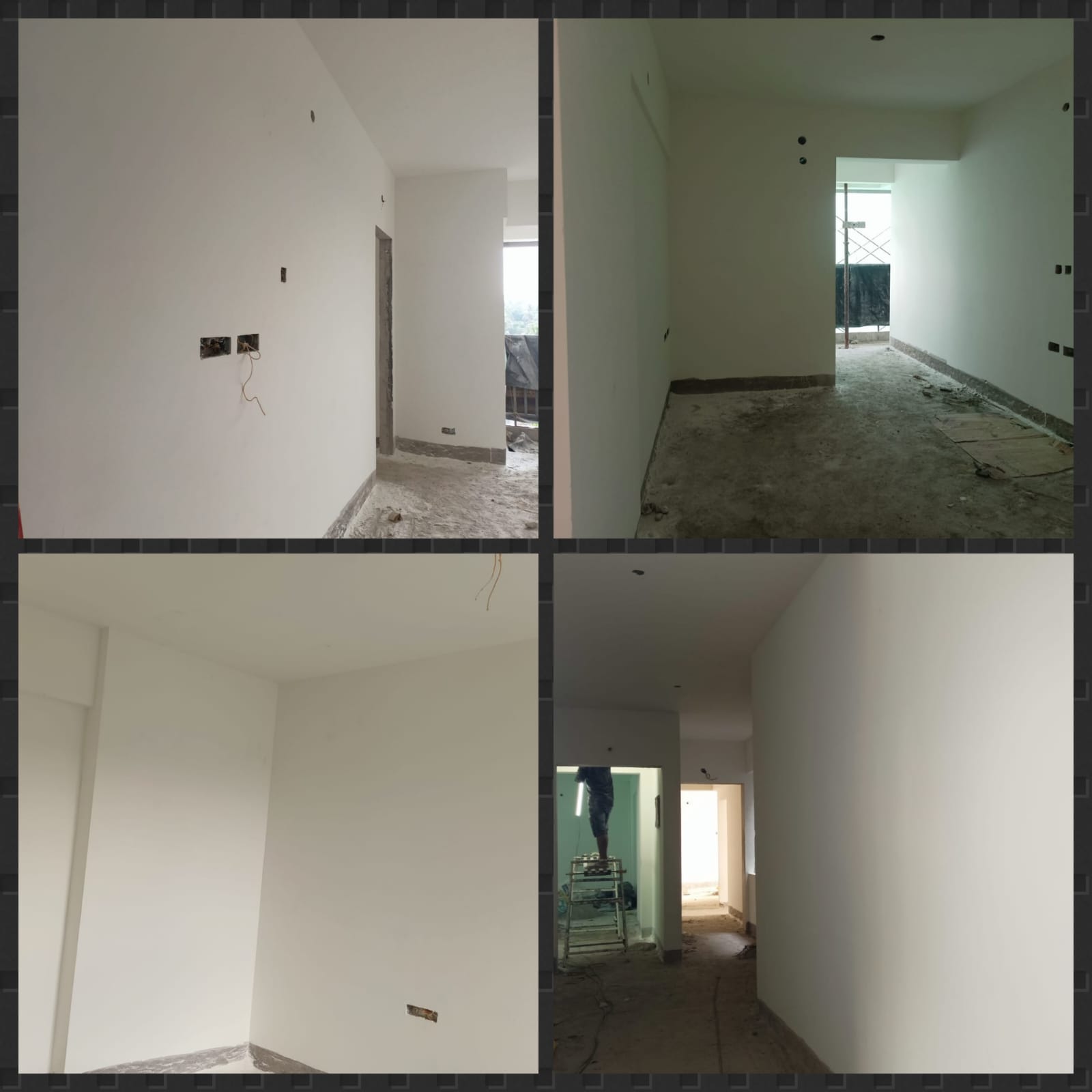

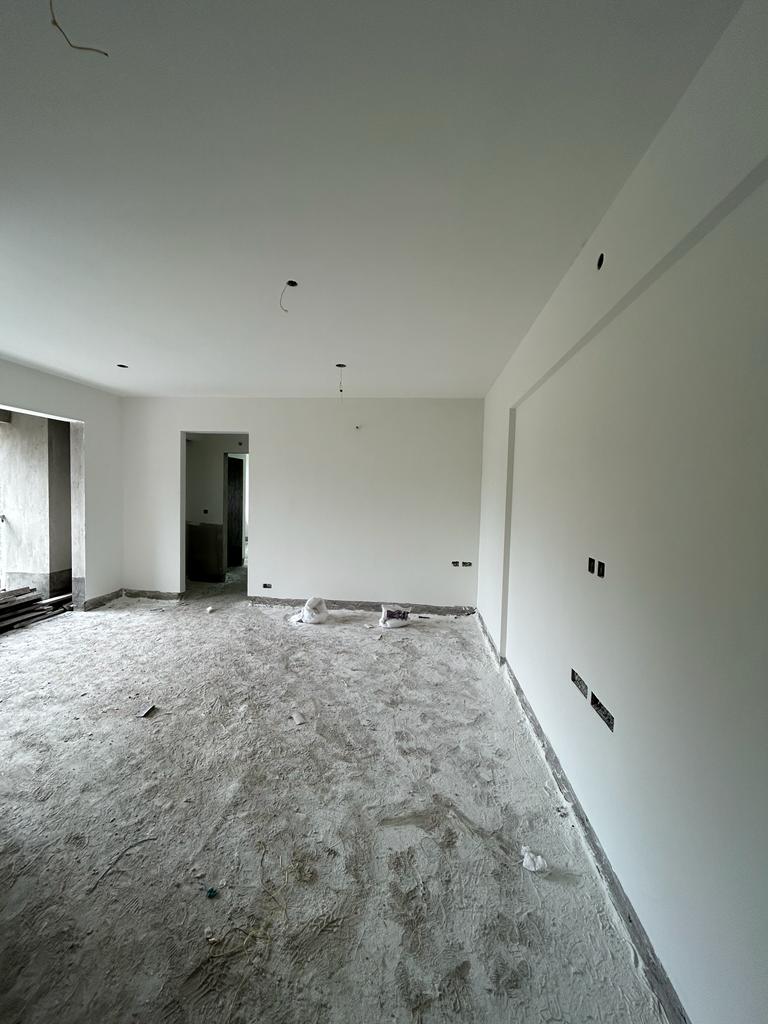

- Wall Putty Work – 39/39 Apartments Completed
- UPVC Window Fixing – 37/39 Apartments Completed
- UPVC Door Fixing – 37/39 Apartments Completed

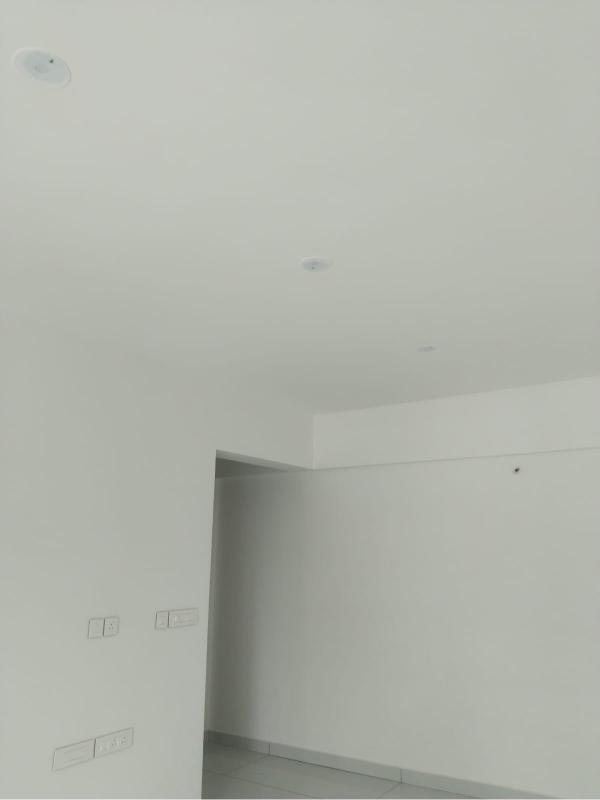

- Internal Wall Painting – 13/39 Apartments Completed
- External Wall Primer & First Coat Painting – 75% Completed
- Prehung Door Fixing – 37/39 Apartments Completed
- External Wall Plastering – 100% Completed

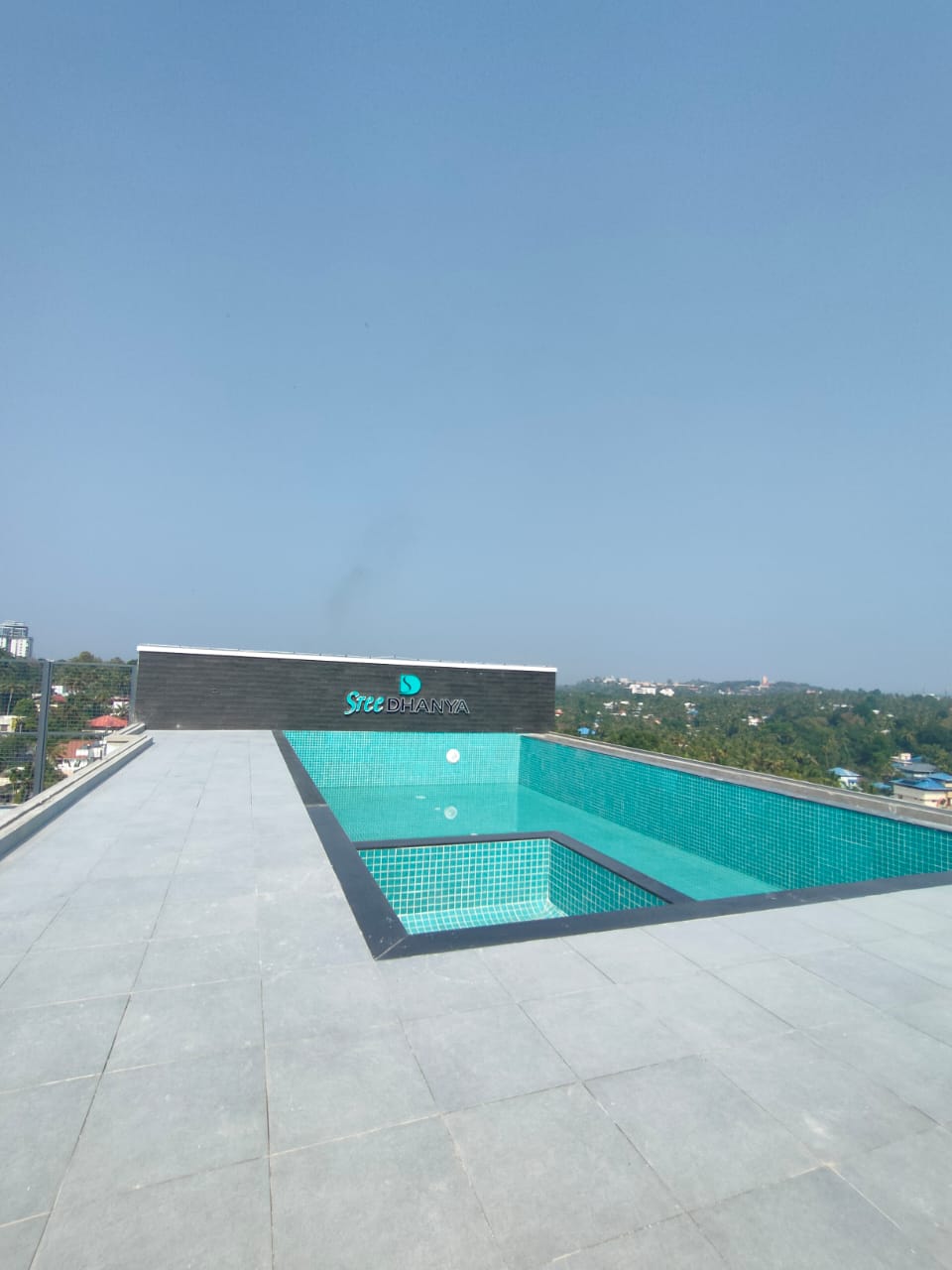

- Swimming Pool Structure – 100% Completed

- Overhead Tank (OHT) Structure Work – 100% Completed
- UG Sump Structure Work – 100% Completed
- Lift Work – 95% Completed
- Grill Fixing – 29/39 Apartments Completed
- Waterproofing for Swimming Pool, OHT, and UG Sump – 100% Completed

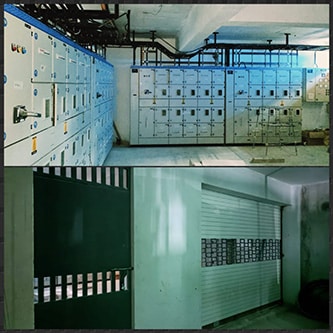

- Electrical HT Work – 90% Completed
- Firefighting Work – 75% Completed

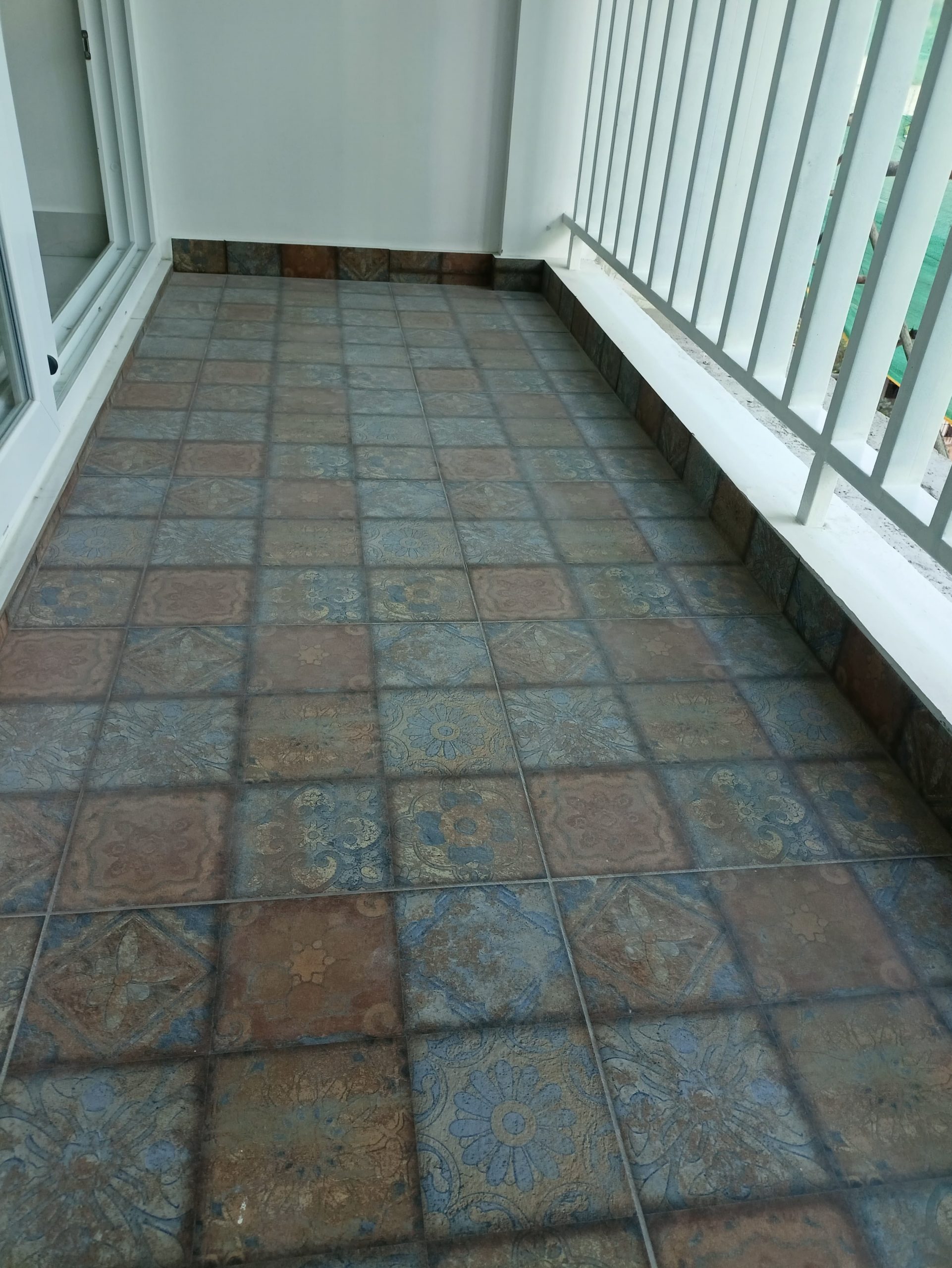

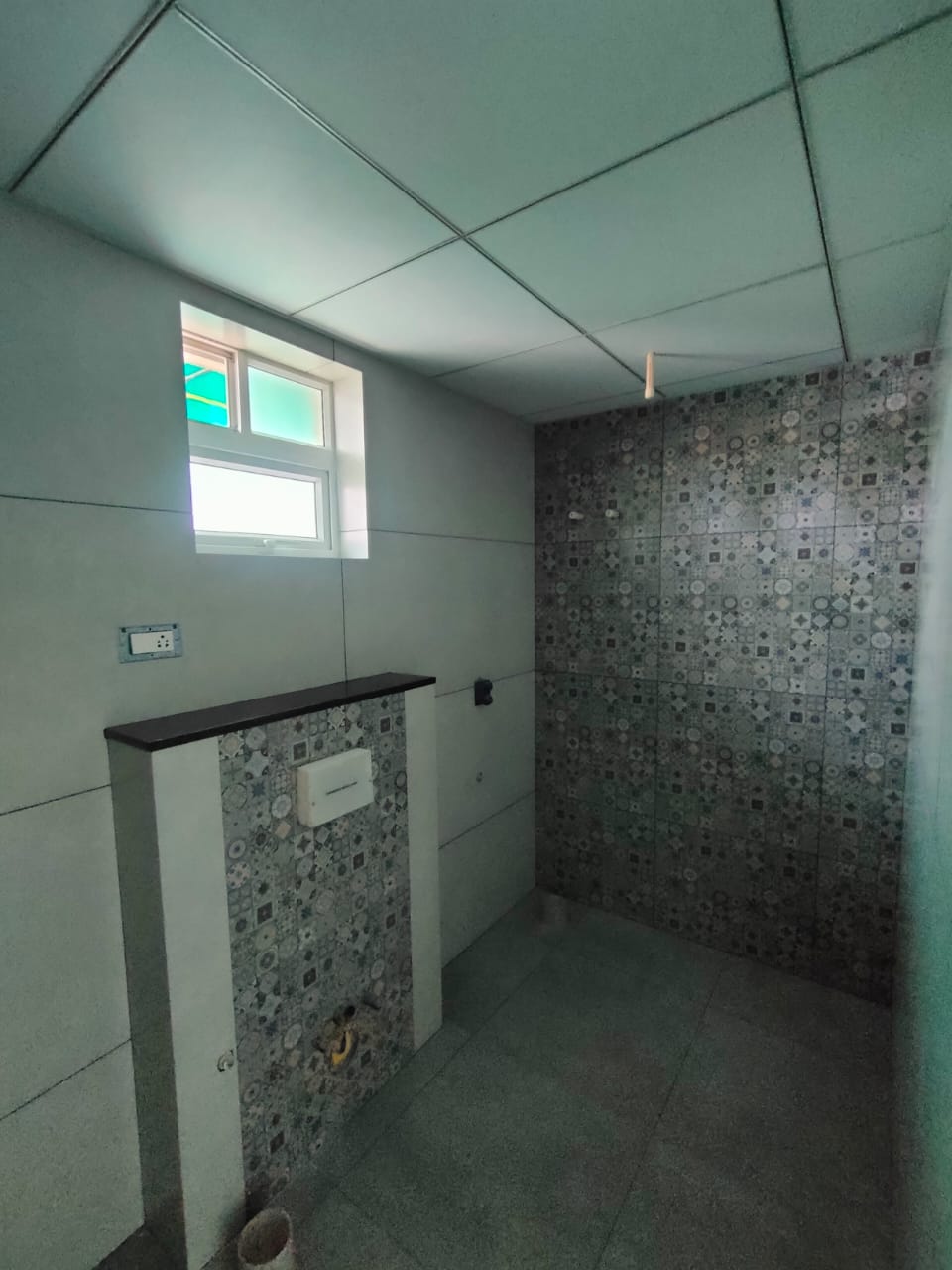

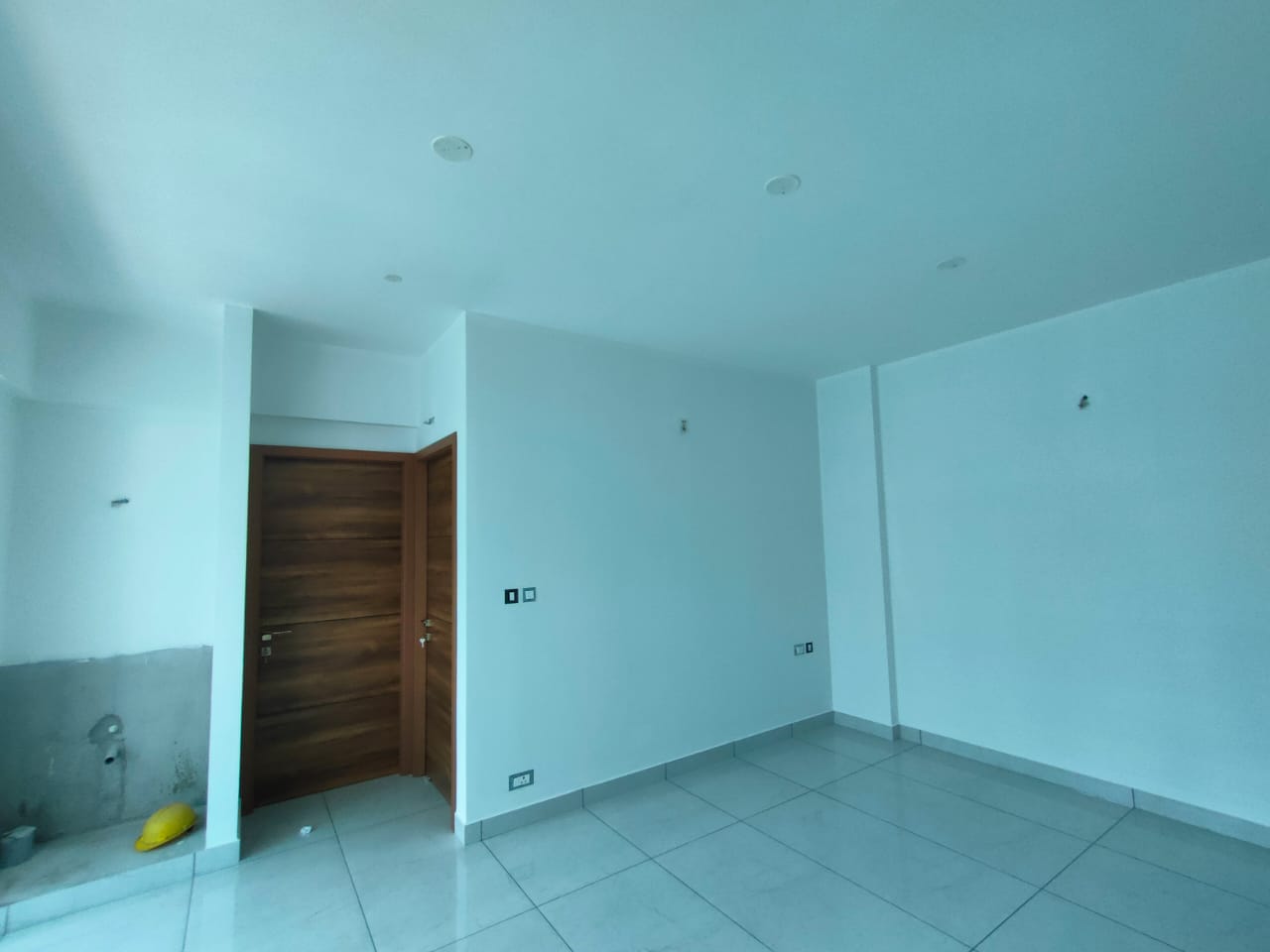

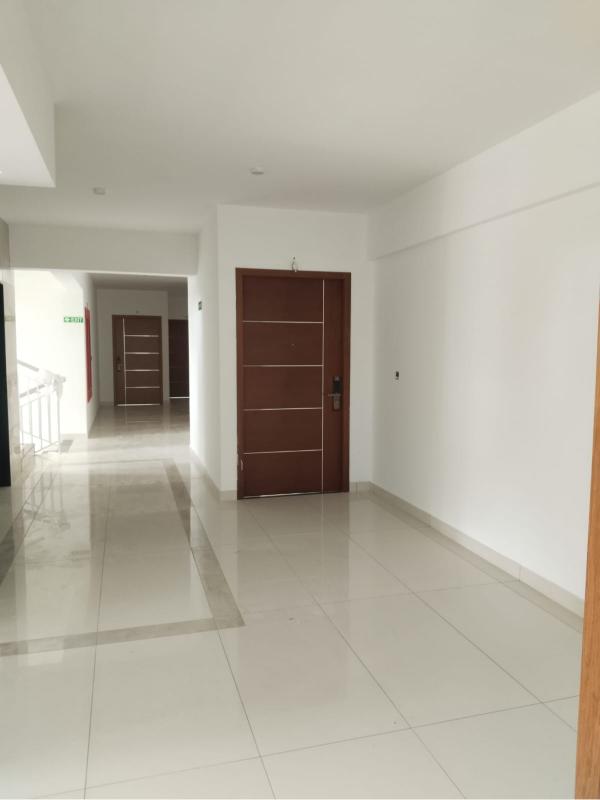

- Mock-Up (1D) & Standard Finish (1E) – Ready for Visit

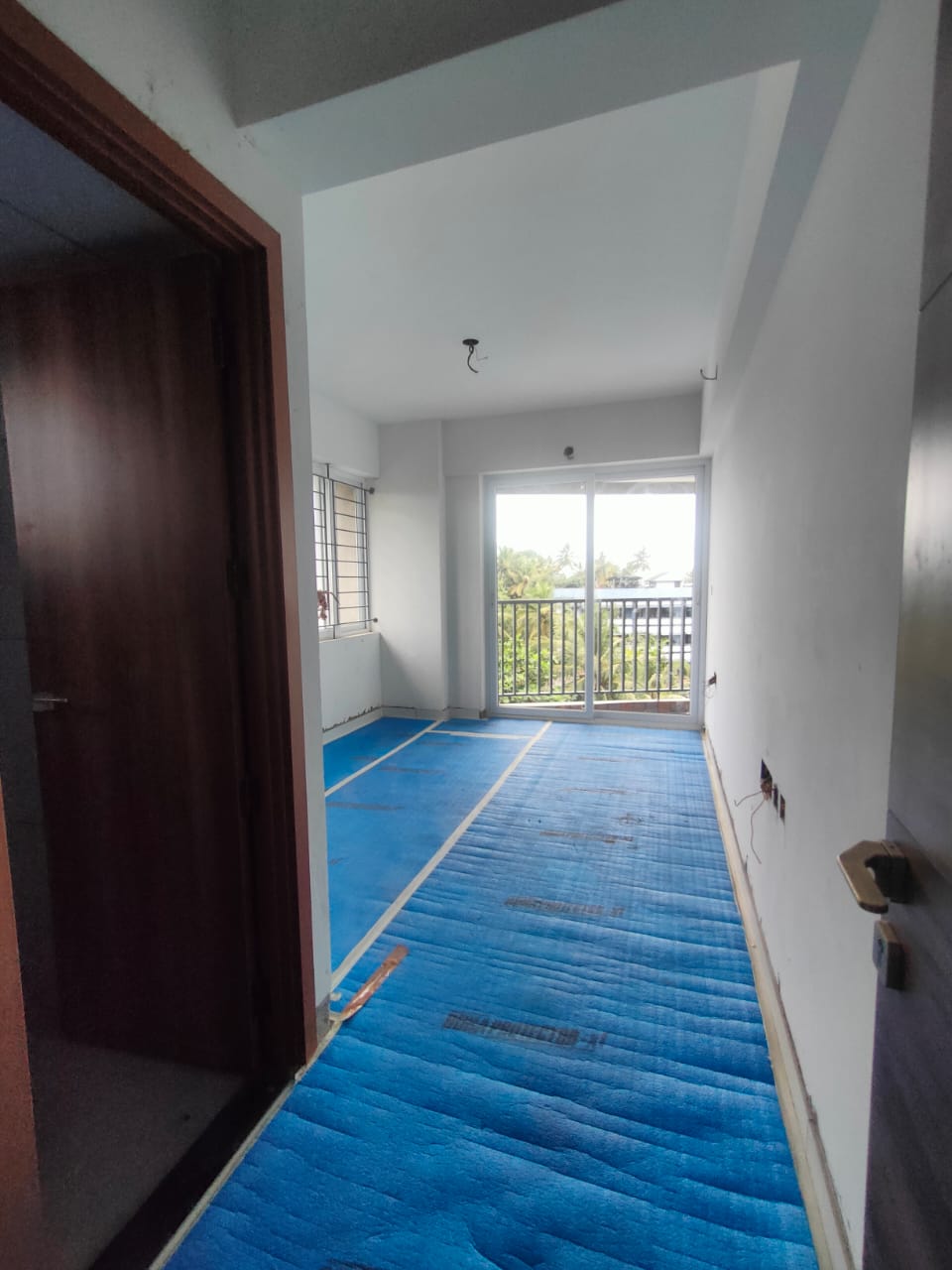

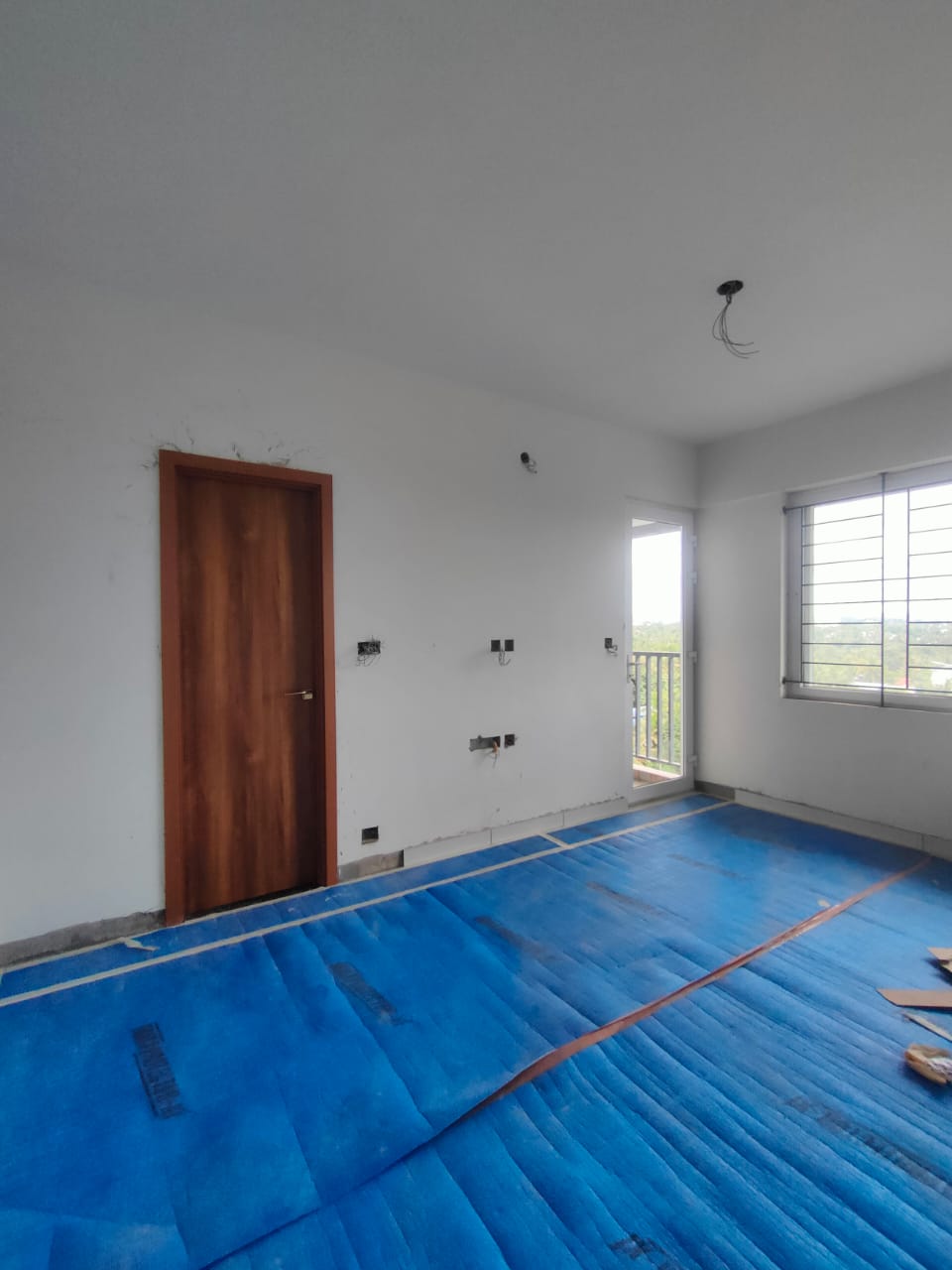

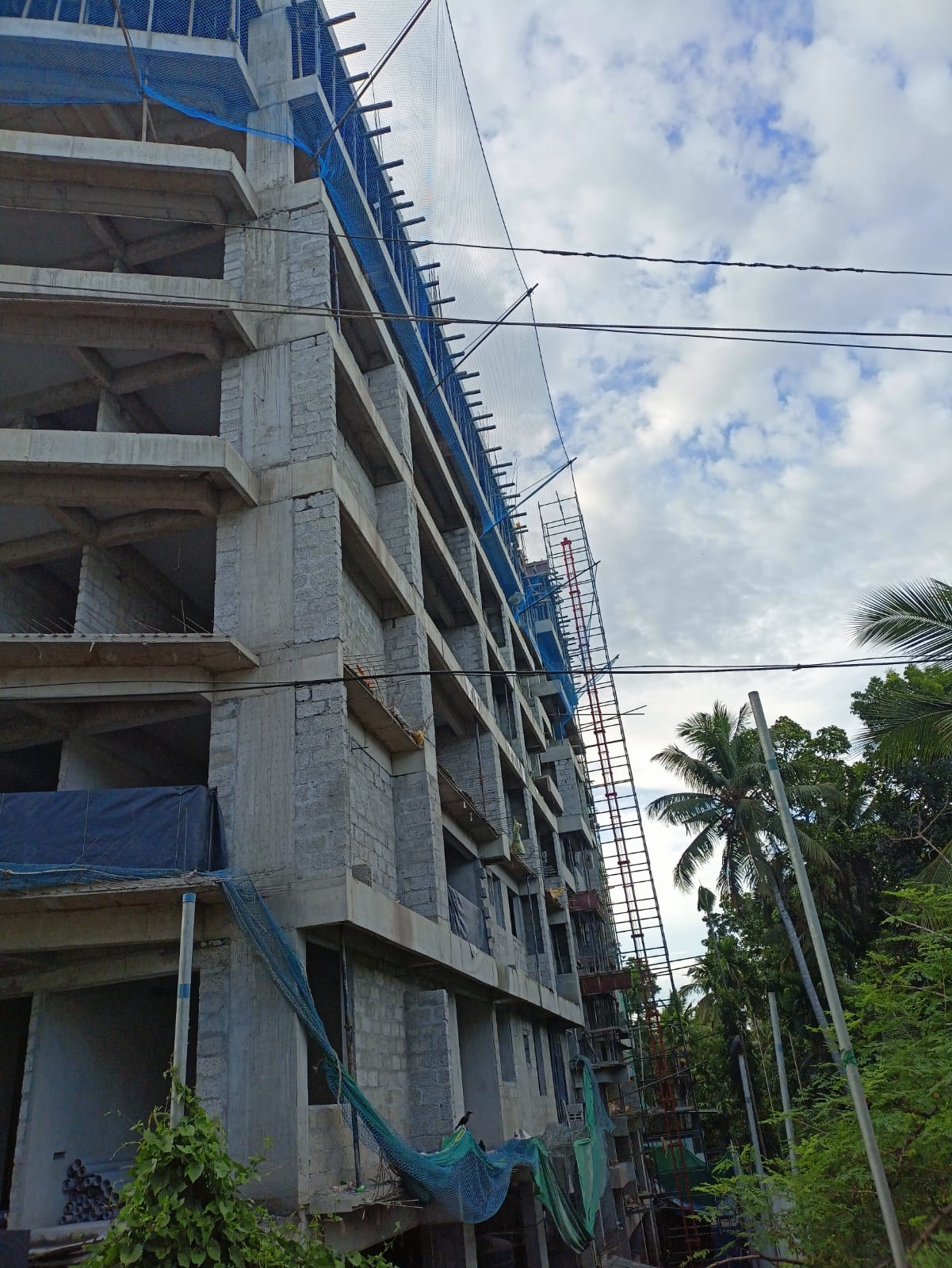

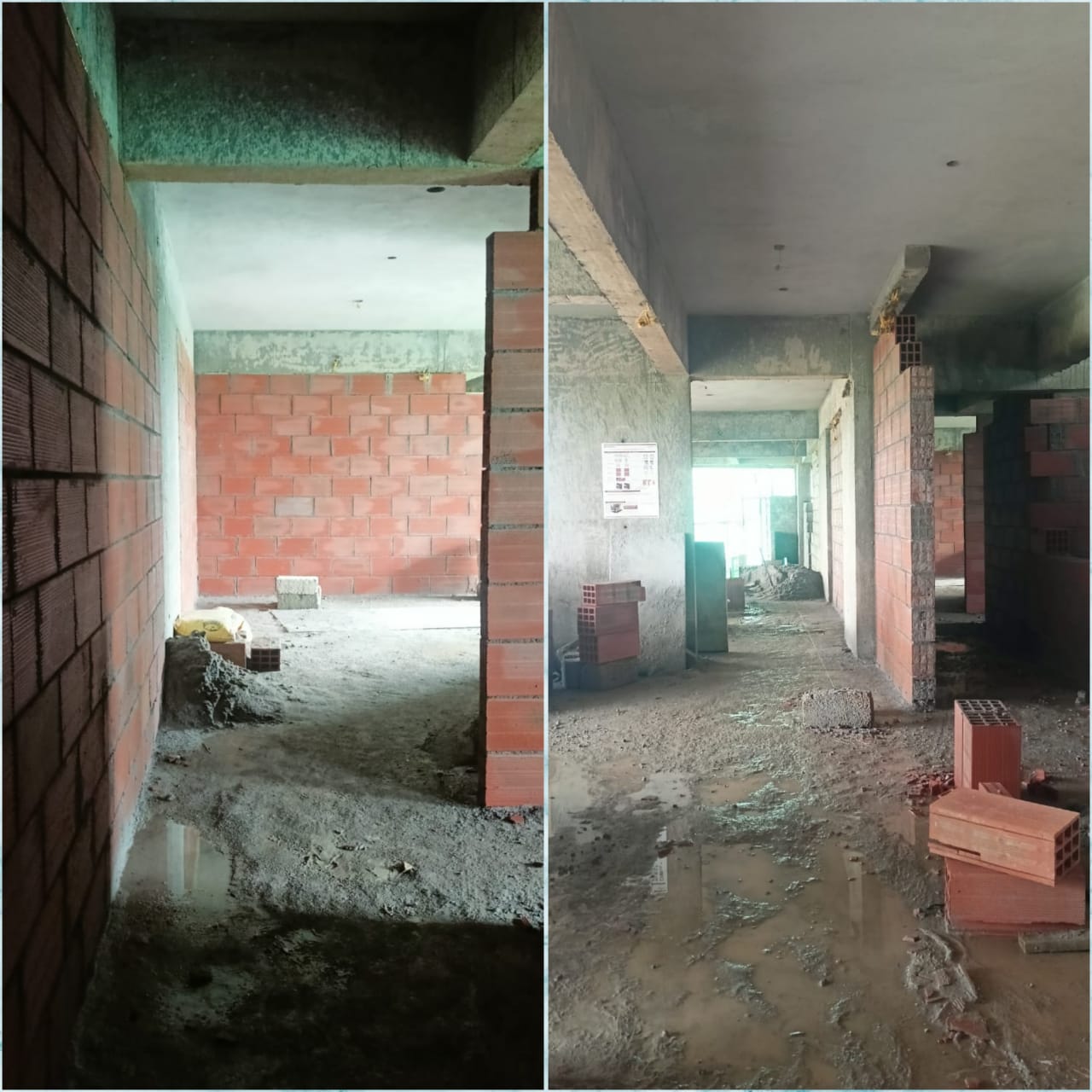

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS ON 24.10.2024
- RCC FOR TERRACE FLOOR – 100% COMPLETED
- CEILING PLASTERING – 39 OUT OF 39 APTS COMPLETED
- BLOCK MASONRY – 39 OUT OF 39 APTS COMPLETED
- INSIDE WALL PLASTERING – 39 OUT OF 39 APTS COMPLETED
- INTERNAL PLUMBING WORK – 39 OUT OF 39 APTS COMPLETED
- PLUMBING WORK IN DUCT – 18 OUT OF 18 APTS COMPLETED
- APT INTERNAL WATERPROOFING – 39 OUT OF 39 APTS COMPLETED
- BALCONY HANDRAIL FIXING – 39 OUT OF 39 APTS COMPLETED
- ELECTRICAL WALL CHASING AND CONDUITING – 39 OUT OF 39 APTS COMPLETED
- WALL TILING WORK – 39 OUT OF 39 APTS COMPLETED
- FLOOR TILING WORK – 38 OUT OF 39 APTS COMPLETED
- PASSAGE FLOORING – 9 OUT OF 12 FLOORS COMPLETED
- WALL PUTTY WORK – 37 OUT OF 39 APTS COMPLETED
- UPVC WINDOW FIXING – 32 OUT OF 39 APTS COMPLETED
- UPVC DOOR FIXING – 28 OUT OF 39 APTS COMPLETED
- ELECTRICAL WIRING – 39 OUT OF 39 APTS COMPLETED
- PRIMER WORK -5 OUT OF 39 APTS COMPLETED
- PREHUNG DOOR FIXING – 28 OUT OF 39 APTS COMPLETED
- EXTERNAL WALL PLASTERING – 100% COMPLETED
- SWIMMING POOL STRUCTURE – 100% COMPLETED
- OHT STRUCTURE WORK – 100% COMPLETED
- UG SUMP STRUCTURE WORK – 100% COMPLETED
- LIFT WORK – 95% COMPLETED
- GRILL FIXING – 29OUT OF 39 APTS COMPLETED
- WATERPROOFING: SWIMMING POOL, OHT, UG SUMP 100% COMPLETED
- ELECTRICAL HT – 90% COMPLETED
- MOCK UP (1D) – READY TO VISIT
- STANDARD FINISH (1E) – READY TO VISIT
PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS ON 06.09.2024
- RCC FOR TERRACE FLOOR – 100% COMPLETED
- CEILING PLASTERING – 39 OUT OF 39 APTS COMPLETED
- BLOCK MASONRY – 39 OUT OF 39 APTS COMPLETED
- INSIDE WALL PLASTERING – 39 OUT OF 39 APTS COMPLETED
- INTERNAL PLUMBING WORK – 39 OUT OF 39 APTS COMPLETED
- PLUMBING WORK IN DUCT – 18 OUT OF 18 APTS COMPLETED
- APT INTERNAL WATERPROOFING – 39 OUT OF 39 APTS COMPLETED
- BALCONY HANDRAIL FIXING – 39 OUT OF 39 APTS COMPLETED
- ELECTRICAL WALL CHASING AND CONDUITING – 39 OUT OF 39 APTS COMPLETED
- WALL TILING WORK – 38 OUT OF 39 APTS COMPLETED
- FLOOR TILING WORK – 36 OUT OF 39 APTS COMPLETED
- PASSAGE FLOORING – 8 OUT OF 12 FLOORS COMPLETED
- WALL PUTTY WORK – 37 OUT OF 39 APTS COMPLETED
- UPVC WINDOW FIXING – 32 OUT OF 39 APTS COMPLETED
- UPVC DOOR FIXING – 21 OUT OF 39 APTS COMPLETED
- ELECTRICAL WIRING – 37 OUT OF 39 APTS COMPLETED
- PRIMER WORK – 4 OUT OF 39 APTS COMPLETED
- PREHUNG DOOR FIXING – 17 OUT OF 39 APTS COMPLETED
- EXTERNAL WALL PLASTERING – 100% COMPLETED
- SWIMMING POOL STRUCTURE – 100% COMPLETED
- OHT STRUCTURE WORK – 100% COMPLETED
- UG SUMP STRUCTURE WORK – 100% COMPLETED
- LIFT WORK – 90% COMPLETED
- GRILL FIXING – 26 OUT OF 39 APTS COMPLETED
- WATERPROOFING: SWIMMING POOL, OHT, UG SUMP 100% COMPLETED
- ELECTRICAL HT – 85% COMPLETED
- MOCK UP (1D) – READY TO VISIT

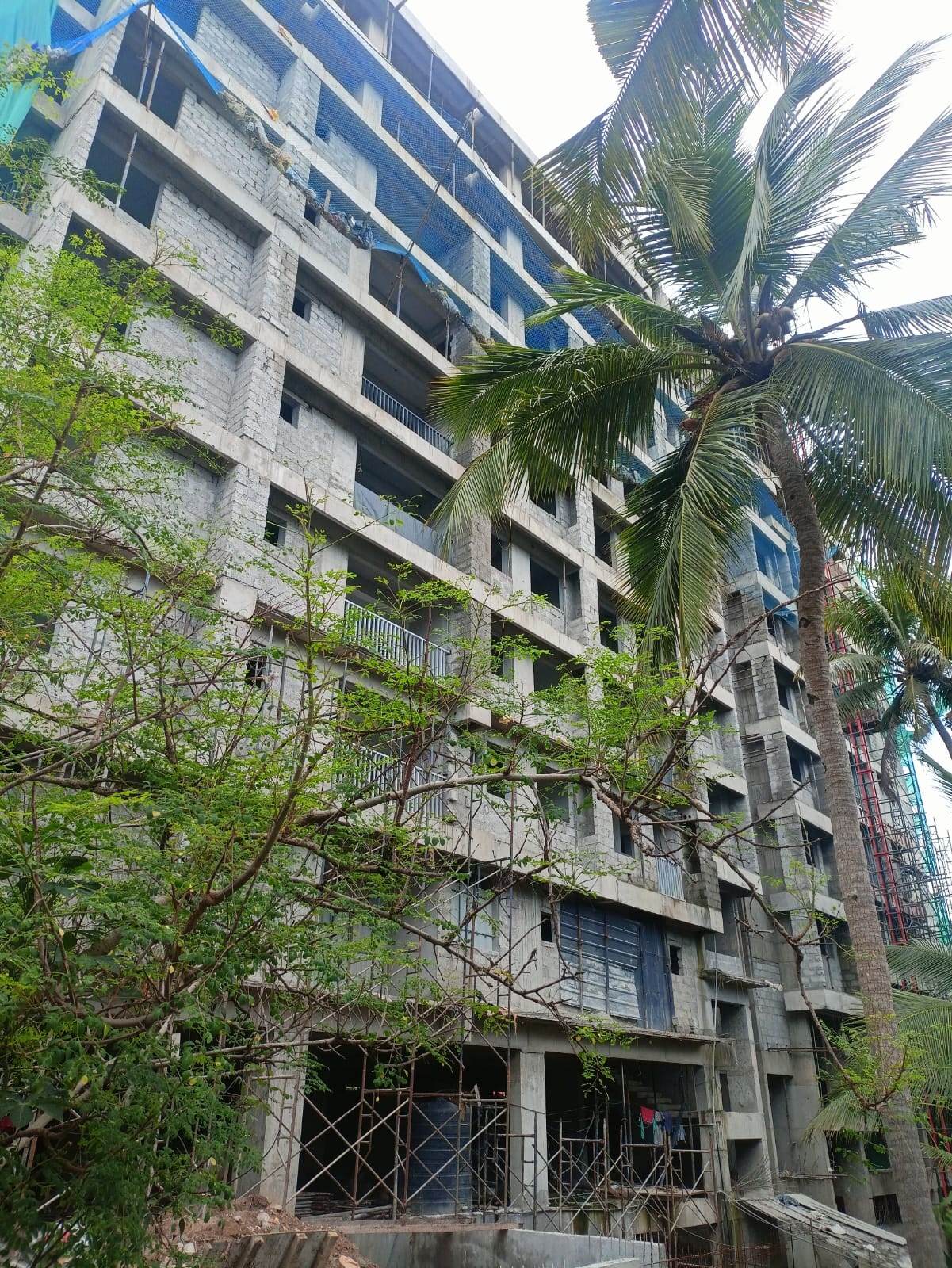

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 29.07.2024
- RCC FOR TERRACE FLOOR – 100% COMPLETED
- CEILING PLASTERING – 39 APT OUT 39 COMPLETED
- BLOCK MASONRY – 39 APT OUT OF 39 COMPLETED
- INSIDE WALL PLASTERING – 39 APT OUT OF 39 COMPLETED
- INTERNAL PLUMBING WORK – 39 APT OUT OF 39 COMPLETED
- PLUMBING WORK IN DUCT – 18 OUT OF 18 COMPLETED
- APT INTERNAL WATERPROOFING – 38 APT OUT OF 39 COMPLETED
- BALCONY HANDRAIL FIXING – 39 APT OUT OF 39 COMPLETED
- ELECTRICAL WALL CHASING AND CONDUITING – 39 APT COMPLETED
- WALL TILING WORK – 34 APT OUT OF 39 COMPLETED
- FLOOR TILING WORK – 31 APT OUT OF 39 COMPLETED
- WALL PUTTY WORK – 37APT OUT OF 39 COMPLETED
- UPVC WINDOW FIXING – 32 APT OUT OF 39 COMPLETED
- UPVC DOOR FIXING – 14 APT OUT OF 39 COMPLETED
- ELECTRICAL WIRING – 37 APT OUT OF 39 COMPLETED
- PRIMER WORK – 3 APT OUT OF 39 COMPLETED
- PREHUNG DOOR FIXING – 10 APT OUT OF 39 COMPLETED
- EXTERNAL WALL PLASTERING – 100% COMPLETED
- SWIMMING POOL STRUCTURE – 100% COMPLETED
- OHT STRUCTURE WORK – 100% COMPLETED
- UG SUMP STRUCTURE WORK – 100% COMPLETED
- LIFT WORK – 85% COMPLETED
- GRILL FIXING – 17APT OUT OF 39 COMPLETED
- WATERPROOFING – SWIMMING POOL, OHT, UG SUMP – 100% COMPLETED
- ELECTRICAL HT – 80% COMPLETED

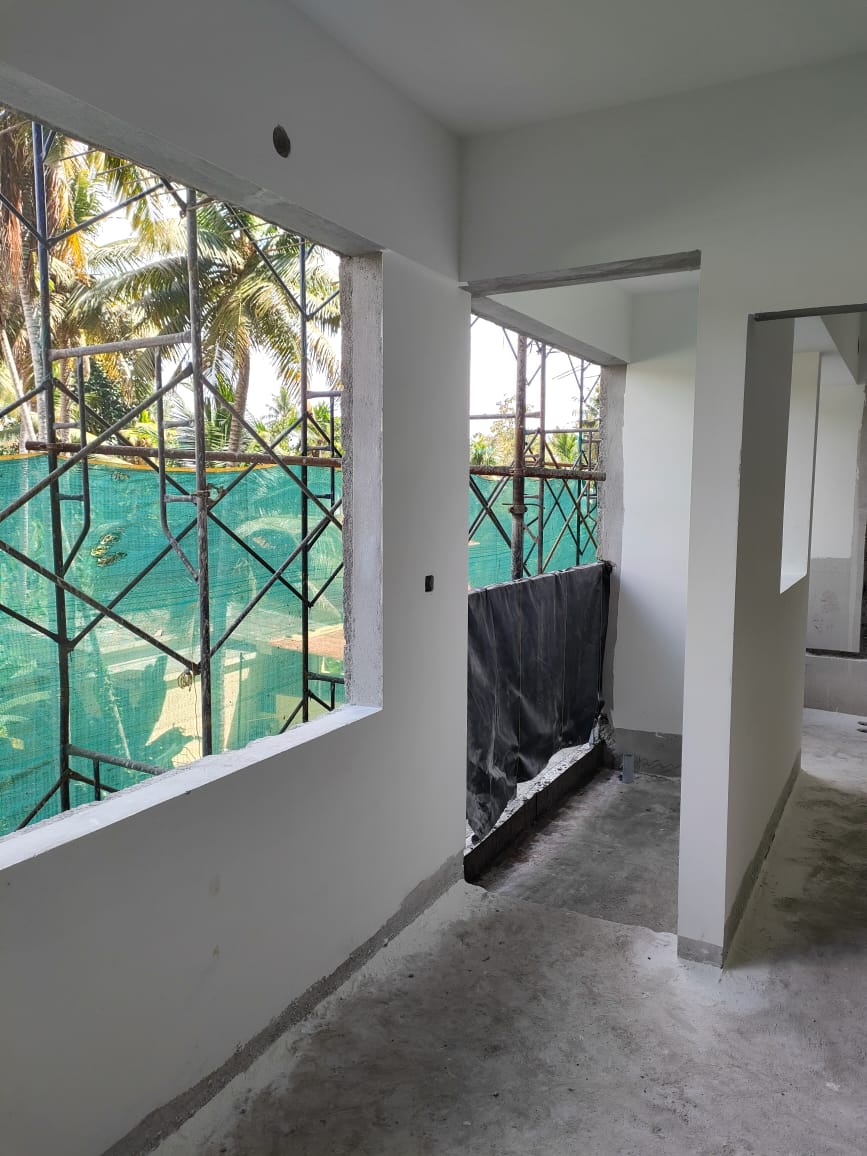

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 21.06.2024
- RCC FOR TERRACE FLOOR – 100% COMPLETED
- CEILING PLASTERING – 39 OUT 39 APTS COMPLETED
- BLOCK MASONRY – 39 OUT OF 39 APTS COMPLETED
- INSIDE WALL PLASTERING – 39 OUT OF 39 APTS COMPLETED
- INTERNAL PLUMBING WORK – 39 OUT OF 39 APTS COMPLETED
- PLUMBING WORK IN DUCT – 18 OUT OF 18 COMPLETED
- APT INTERNAL WATERPROOFING – 37 OUT OF 39 APTS COMPLETED
- BALCONY HANDRAIL FIXING – 39 OUT OF 39 APTS COMPLETED
- ELECTRICAL WALL CHASING AND CONDUITING – 39 APTS COMPLETED
- WALL TILING WORK – 27 OUT OF 39 APTS COMPLETED
- FLOOR TILING WORK – 26 OUT OF 39 APTS COMPLETED
- WALL PUTTY WORK – 37 OUT OF 39 APTS COMPLETED
- UPVC WINDOW FIXING – 21 OUT OF 39 APTS COMPLETED
- UPVC DOOR FIXING – 14 OUT OF 39 APTS COMPLETED
- ELECTRICAL WIRING – 37 OUT OF 39 APTS COMPLETED
- PRIMER WORK – MOCK UP APT 1D COMPLETED
- PREHUNG DOOR FIXING – 6 APT OUT OF 39 COMPLETED
- EXTERNAL WALL PLASTERING – 96% COMPLETED
- SWIMMING POOL STRUCTURE – 100% COMPLETED
- OHT STRUCTURE WORK – 100% COMPLETED
- UG SUMP STRUCTURE WORK – 100% COMPLETED

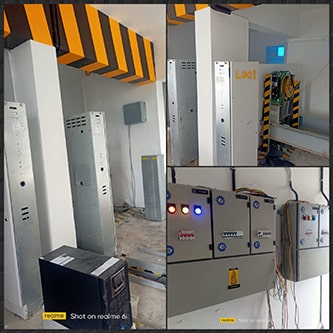

- LIFT MACHINE ROOM CIVIL WORK COMPLETED
- LIFT WORK – 85% COMPLETED
- GRILL FIXING – 17APT OUT OF 39 COMPLETED
- WATERPROOFING – SWIMMING POOL, OHT, UG SUMP – 100% COMPLETED
- ELECTRICAL HT – 75% COMPLETED
PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 07.05.2024
- RCC FOR TERRACE FLOOR – 100% COMPLETED
- CEILING PLASTERING – 39 APT OUT 39 COMPLETED
- BLOCK MASONRY – 39 APT OUT OF 39 COMPLETED
- INSIDE WALL PLASTERING – 39 APT OUT OF 39 COMPLETED
- INTERNAL PLUMBING WORK – 39 APT OUT OF 39 COMPLETED
- PLUMBING WORK IN DUCT – 18 OUT OF 18 COMPLETED
- APT INTERNAL WATERPROOFING – 34 APT OUT OF 39 COMPLETED
- BALCONY HANDRAIL FIXING – 39 APT OUT OF 39 COMPLETED
- ELECTRICAL WALL CHASING AND CONDUITING – 39 APT COMPLETED
- WALL TILING WORK – 24 APT OUT OF 39 COMPLETED
- FLOOR TILING WORK – 22 APT OUT OF 39 COMPLETED
- WALL PUTTY WORK – 35 APT OUT OF 39 COMPLETED
- UPVC WINDOW FIXING – 17 APT OUT OF 39 COMPLETED
- UPVC DOOR FIXING – 12 APT OUT OF 39 COMPLETED
- ELECTRICAL WIRING – 32 APT OUT OF 39 COMPLETED
- PRIMER WORK – APTs 1D & 1E COMPLETED
- PREHUNG DOOR FIXING – 6 APTS COMPLETED
- EXTERNAL WALL PLASTERING – 95% COMPLETED
- SWIMMING POOL STRUCTURE – 100% COMPLETED
- OHT STRUCTURE WORK – 100% COMPLETED
- UG SUMP STRUCTURE WORK – 100% COMPLETED
- LIFT MACHINE ROOM CIVIL WORK COMPLETED
- LIFT WORK – 65% COMPLETED
- GRILL FIXING – 9 APT OUT OF 39 COMPLETED
- WATERPROOFING – SWIMMING POOL, OHT, UG SUMP – 100% COMPLETED
- ELECTRICAL HT – 60% COMPLETED

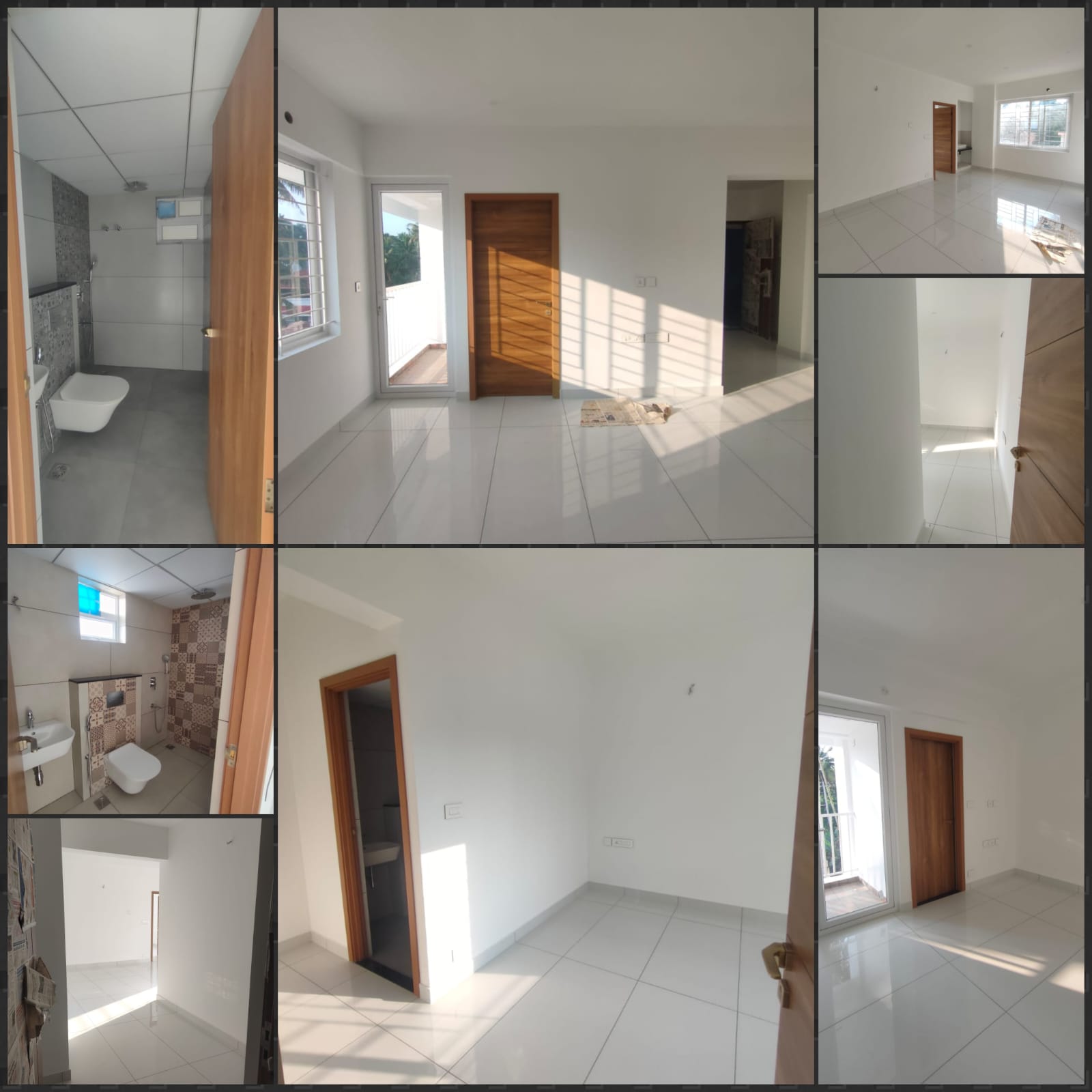

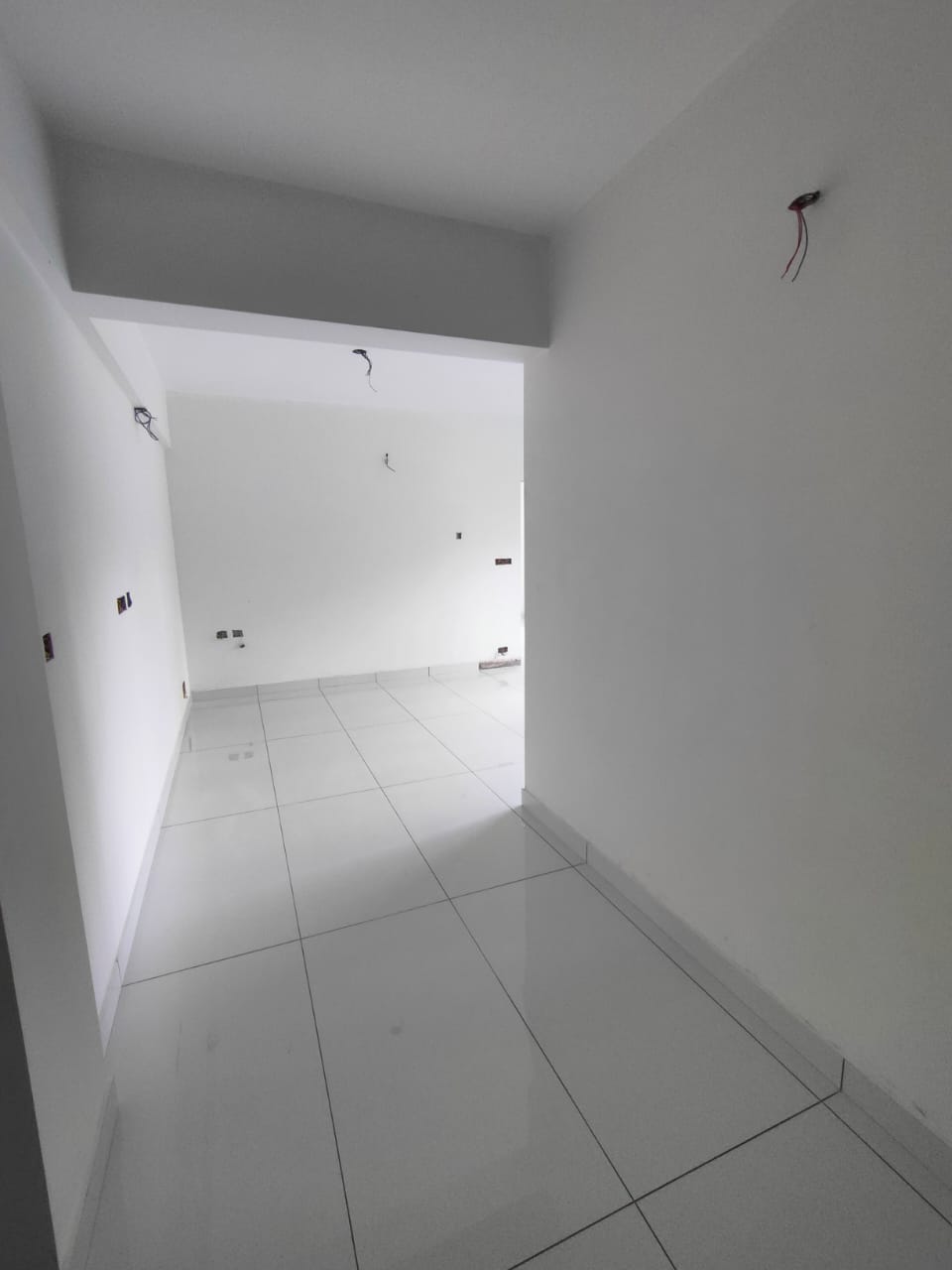

- MOCK UP APARTMENT 1D: READY
PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 25.03.2024
- RCC FOR TERRACE FLOOR – 100% COMPLETED
- CEILING PLASTERING – 39 APT OUT 39 COMPLETED
- BLOCK MASONRY – 39 APT OUT OF 39 COMPLETED
- INSIDE WALL PLASTERING – 39 APT OUT OF 39 COMPLETED
- INTERNAL PLUMBING WORK – 37 APT OUT OF 39 COMPLETED
- APT INTERNAL WATERPROOFING-25 APT OUT OF 39 COMPLETED
- BALCONY HANDRAIL FIXING – 39 APT OUT OF 39 COMPLETED
- ELECTRICAL WALL CHASING AND CONDUCTING – 39 APT COMPLETED
- WALL TILING WORK -16 APT OUT OF 39 COMPLETED
- FLOOR TILING WORK -16 APT OUT OF 39 COMPLETED
- WALL PUTTY WORK – 33 APT OUT OF 39 COMPLETED
- UPVC WINDOW FIXING -17 APT OUT OF 39 COMPLETED
- UPVC DOOR FIXING -6 APT OUT OF 39 COMPLETED
- ELECTRICAL WIRING – 21 APT OUT OF 39 COMPLETED
- PRIMER WORK – MOCK UP APT (1D& 1E) COMPLETED
- PREHUNG DOOR FIXING – MOCKUP APT (1D ,1E & 2E) COMPLETED
- EXTERNAL WALL PLASTERING -88% COMPLETED
- SWIMMING POOL STRUCTURE-100% COMPLETED
- OHT STRUCTURE WORK -100% COMPLETED
- UG SUMP STRUCTURE WORK -100% COMPLETED
- LIFT MACHINE ROOM CIVIL WORK COMPLETED
- LIFT WORK- 50% COMPLETED
- GRILL FIXING- 9 APT OUT OF 39 COMPLETED
- WATERPROOFING- SWIMMING POOL, OHT, UG SUMP-100% COMPLETED
- MOCK UP (1D) AND STANDARD FINISH FLAT (1E) READY TO VISIT
PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 12.02.2024

- RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
- RCC FOR WATER TANK, SWIMMING POOL, LIFT HEADROOM – 100% COMPLETED
- BLOCK WORK – 100% COMPLETED
- CEILING PLASTERING – 100% COMPLETED
- INSIDE WALL PLASTERING – 93 APT OUT OF 93 APT COMPLETED
- EXTERNAL WALL PLASTERING – 99% COMPLETED
- WALL TILING – 88 APT OUT OF 93 APT COMPLETED
- FLOOR TILING – 80 APT OUT OF 93 COMPLETED
- LIFT ARCHITRAVE WORK – 8 FLOOR OUT OF 15 COMPLETED
- PASSAGE FLOORING – 9 FLOOR OUT OF 15 COMPLETED
- MAIN STAIR STEP TILE LAYING – 6 FLOOR OUT OF 15 COMPLETED
- FIRE STAIR STEP TILE LAYING – 7 FLOOR OUT OF 15 COMPLETED
- WALL PUTTY WORK – 92 APT OUT 93 APT COMPLETED
- WATERPROOFING OF TOILETS – 92 APT OUT OF 93 APT COMPLETED
- WIRING COMPLETION – 92 OUT OF 93 COMPLETED
- INTERNAL PLUMBING – 92 OUT OF 93 COMPLETED
- BALCONY HANDRAIL FIXING – 93 OUT OF 93 COMPLETED
- DOOR SHUTTER FIXING – 33 OUT OF 93 COMPLETED
- UPVC DOORS FIXING – 60 OUT OF 93 COMPLETED
- UPVC WINDOWS FIXING – 92 OUT OF 93 COMPLETED
- 1ST COAT INSIDE WALL PAINTING – 4 OUT OF 93 COMPLETED
- EXTERNAL WALL PRIMER PAINTING 1ST COAT – 100% COMPLETED, PRIMER PAINTING 2ND COAT – 30% COMPLETED

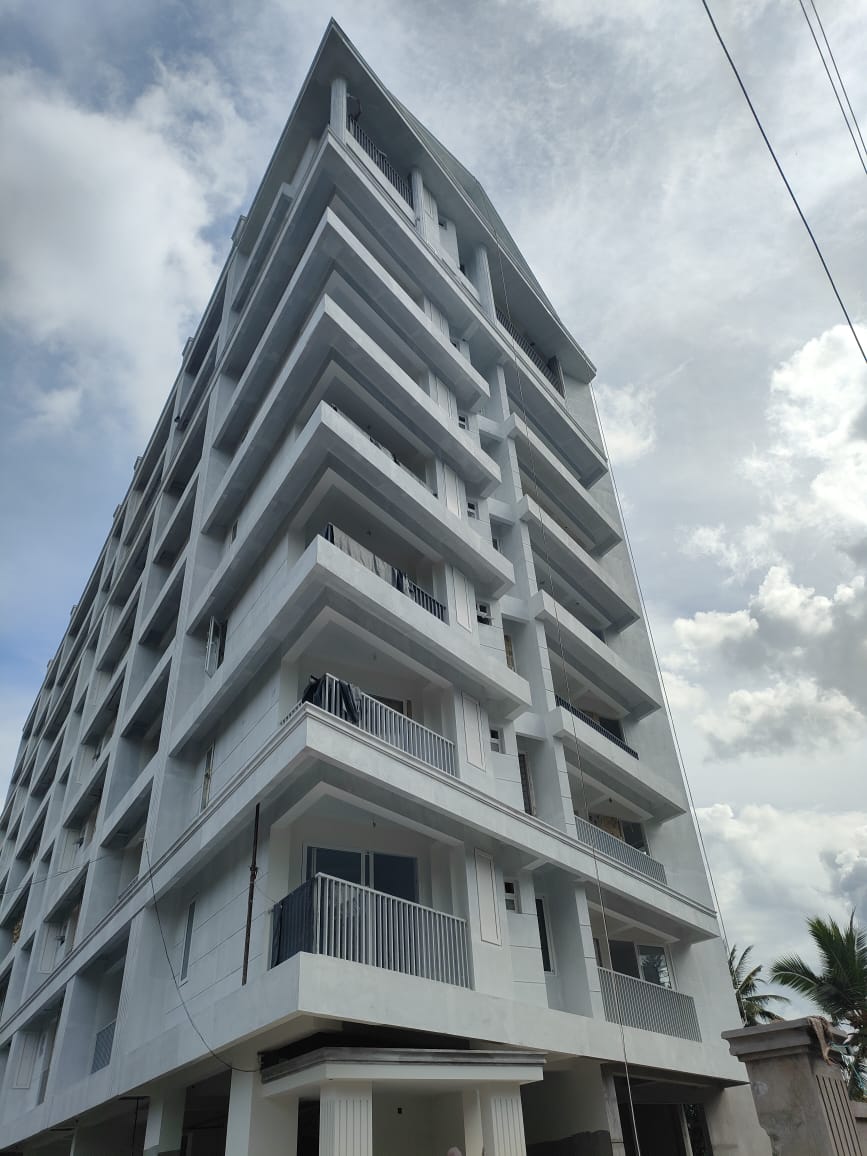

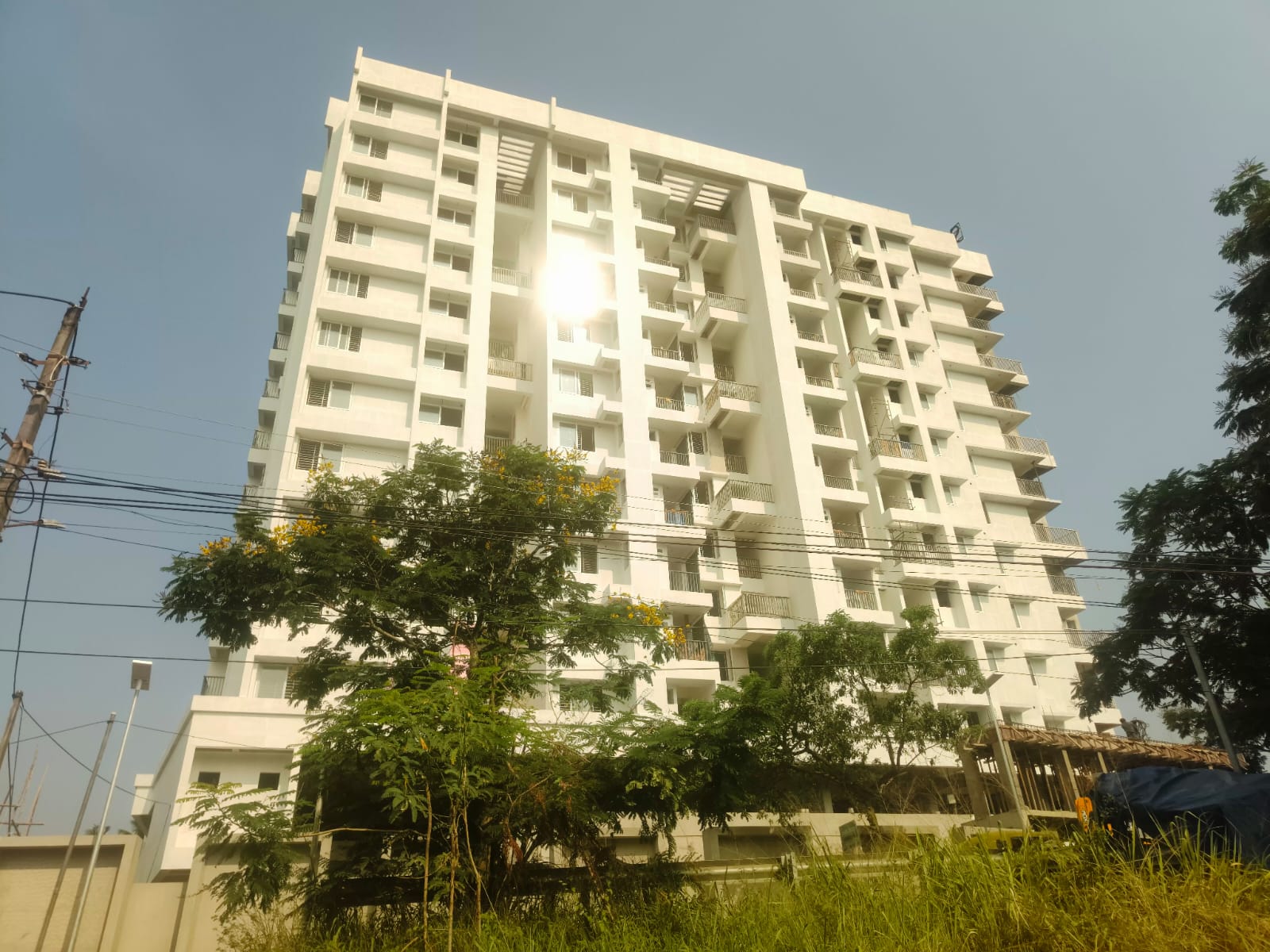

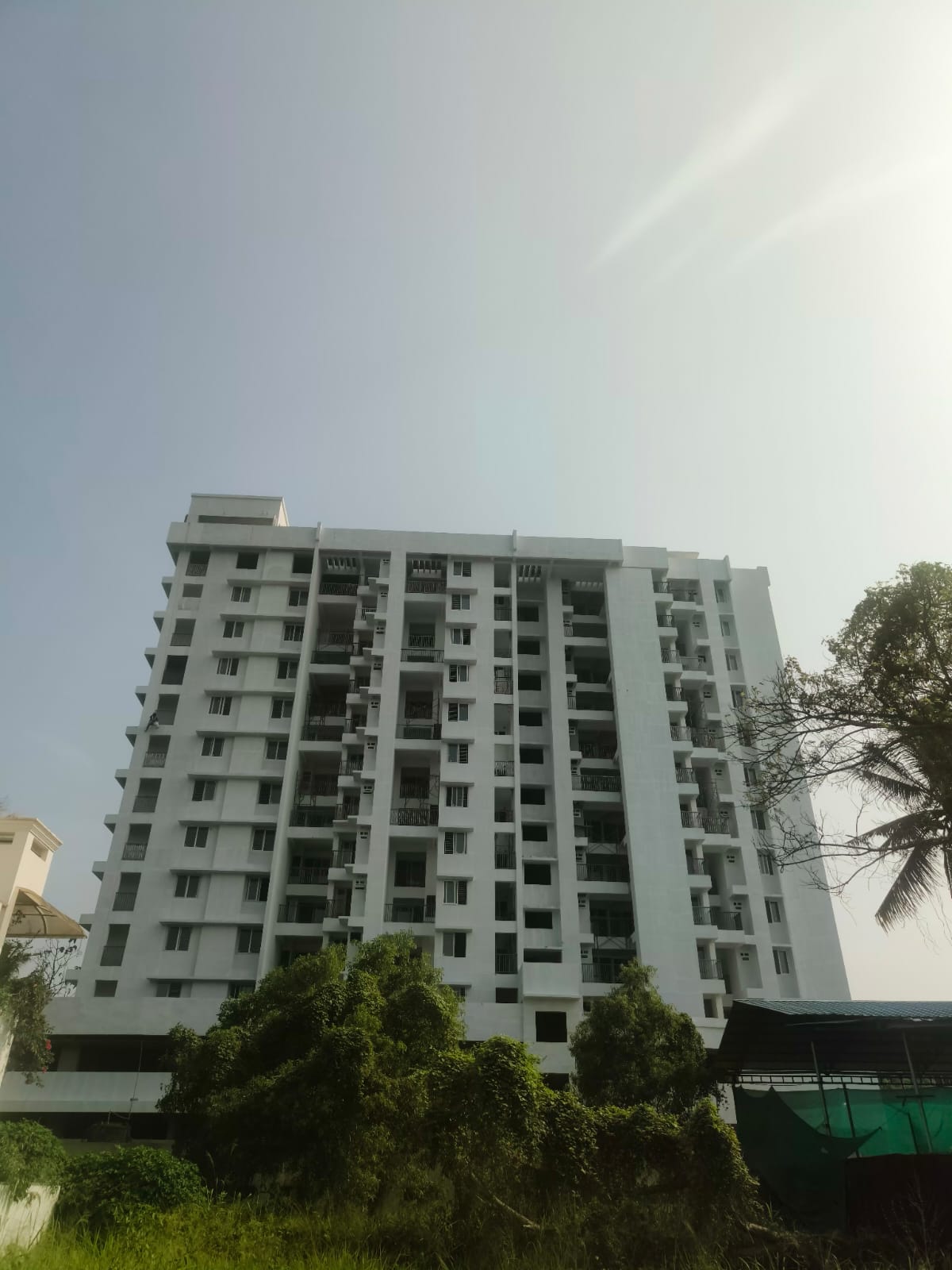

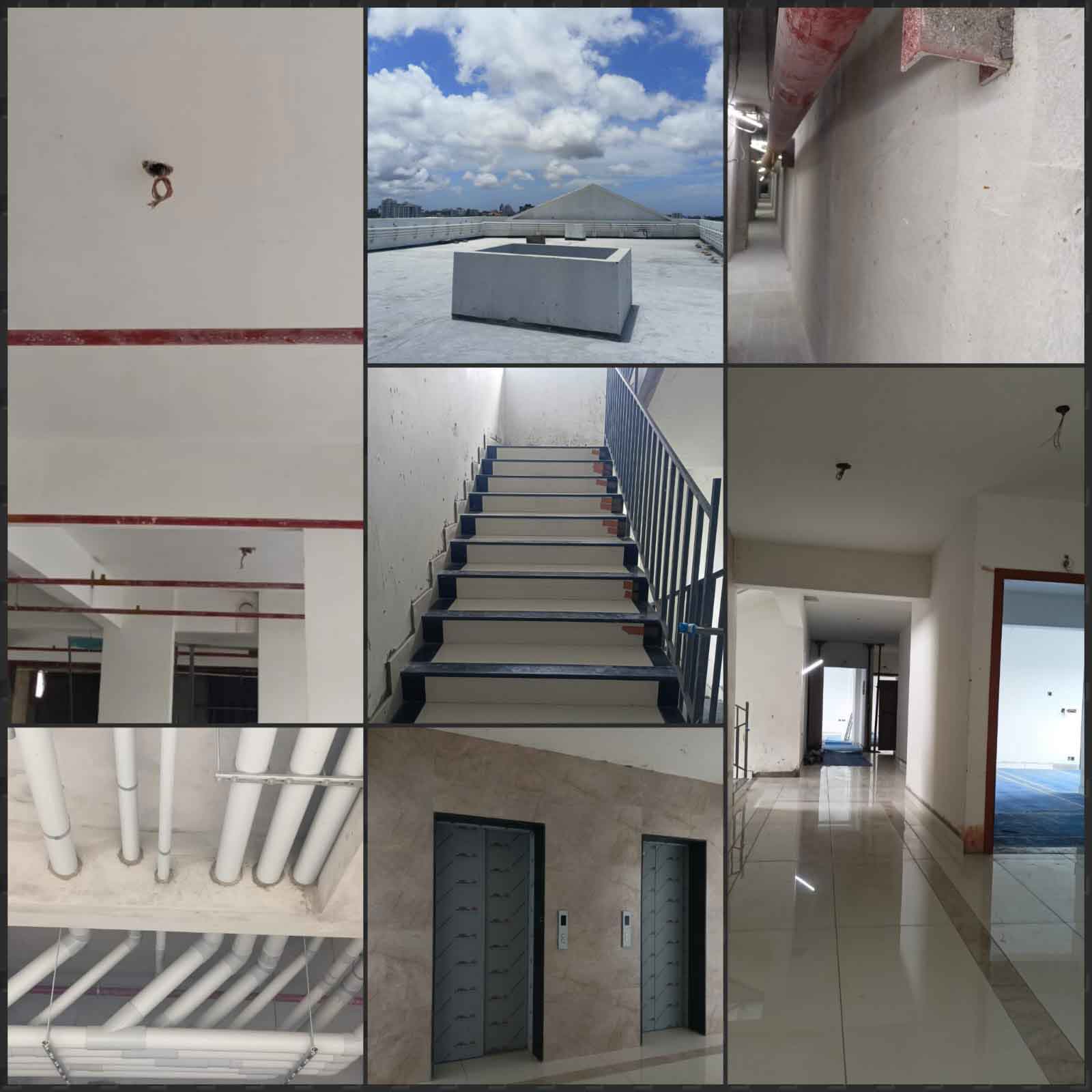

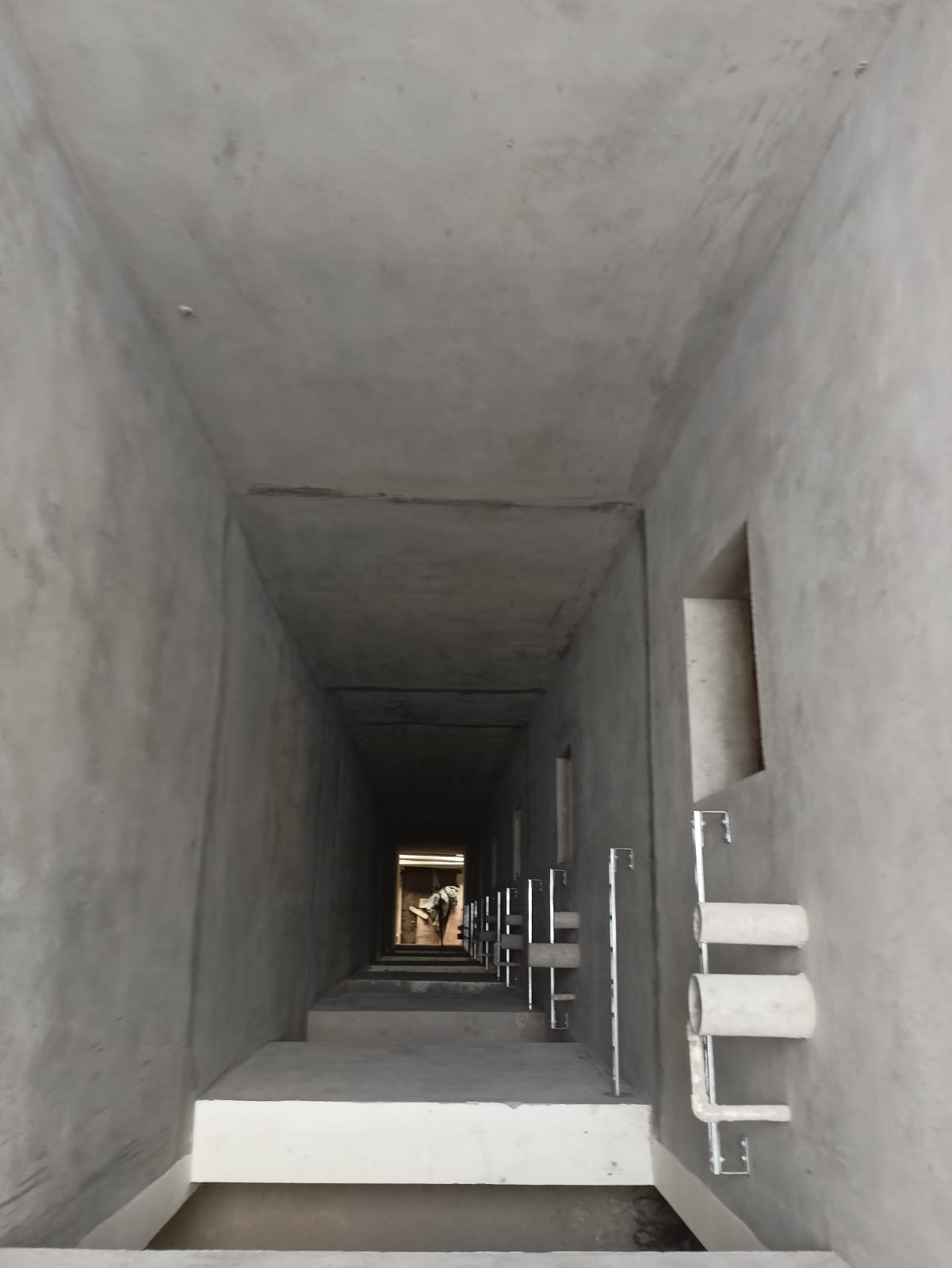

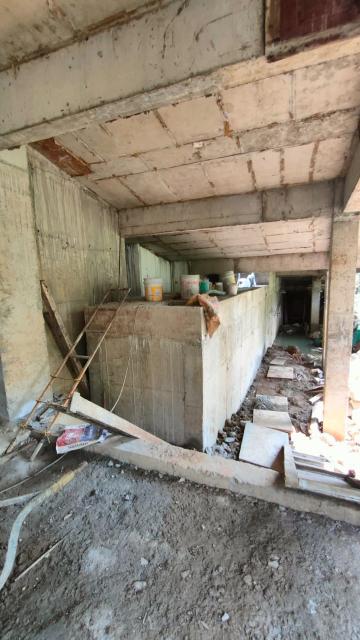

- PLUMBING WORK IN DUCTS – 36 OUT OF 36 COMPLETED
- WINDOW GRILL FIXING – 88 OUT OF 93 COMPLETED.
- ELECTRICAL HT WORK – 90% COMPLETED

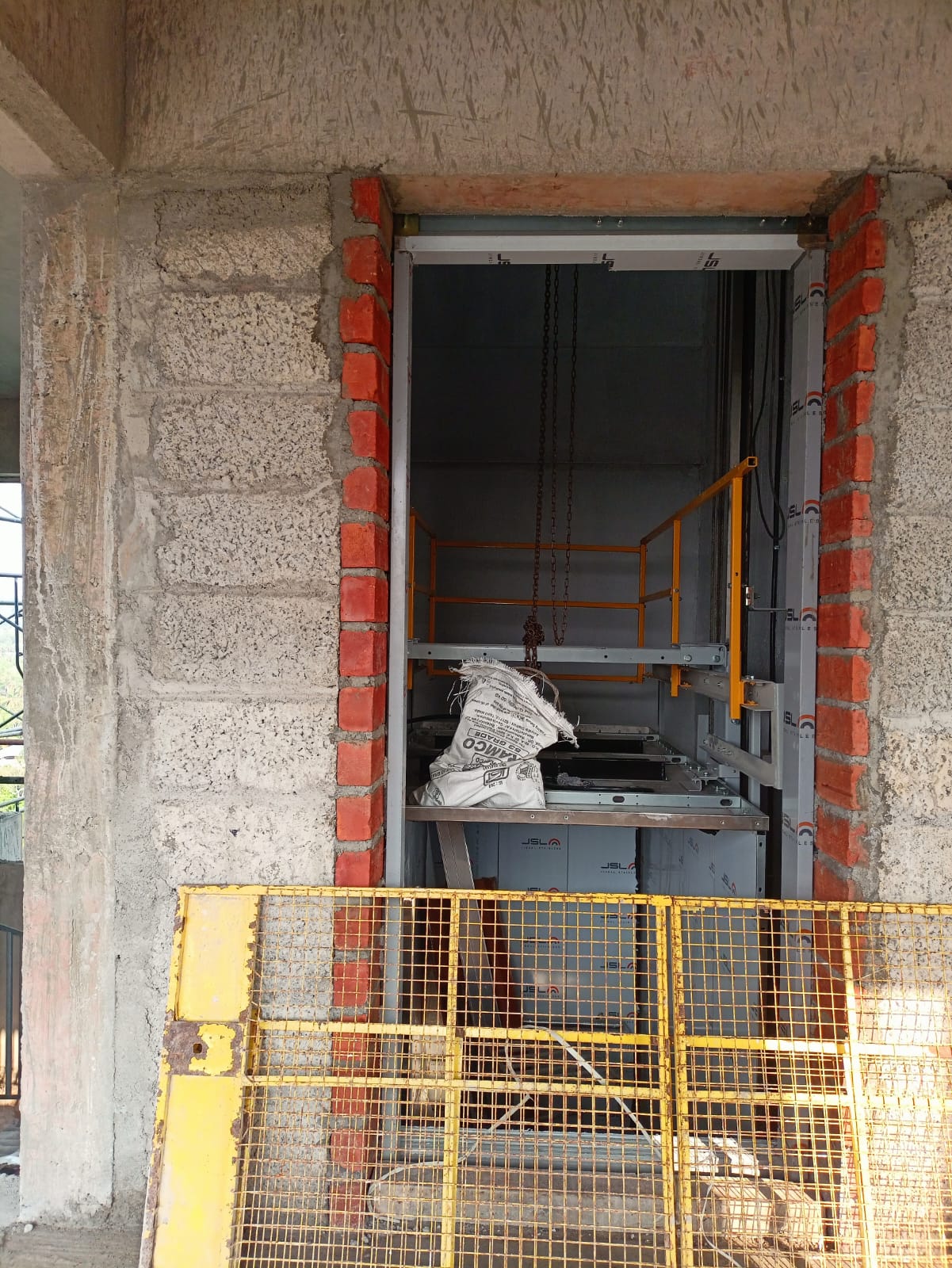

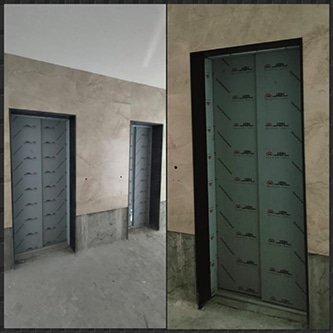

- LIFT ERECTION – (2 LIFTS – 100% & OTHER 2 LIFTS – 80% COMPLETED
- RCC FOR UG SUMP – 100% COMPLETED

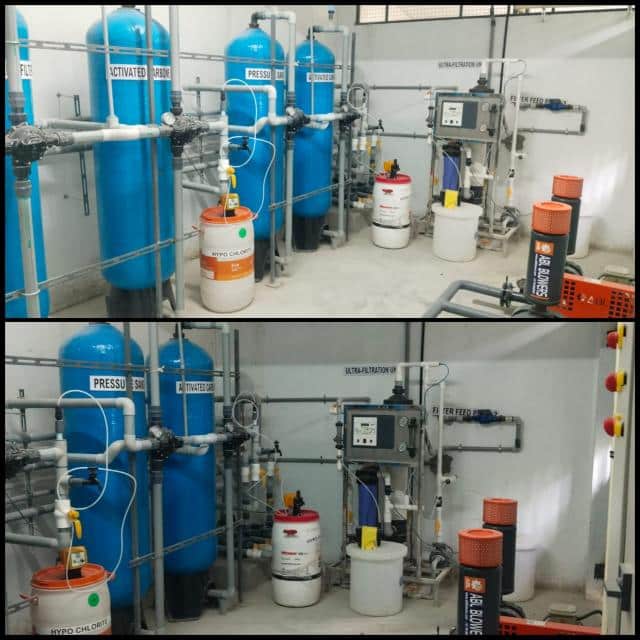

- RCC FOR STP – 100% COMPLETED

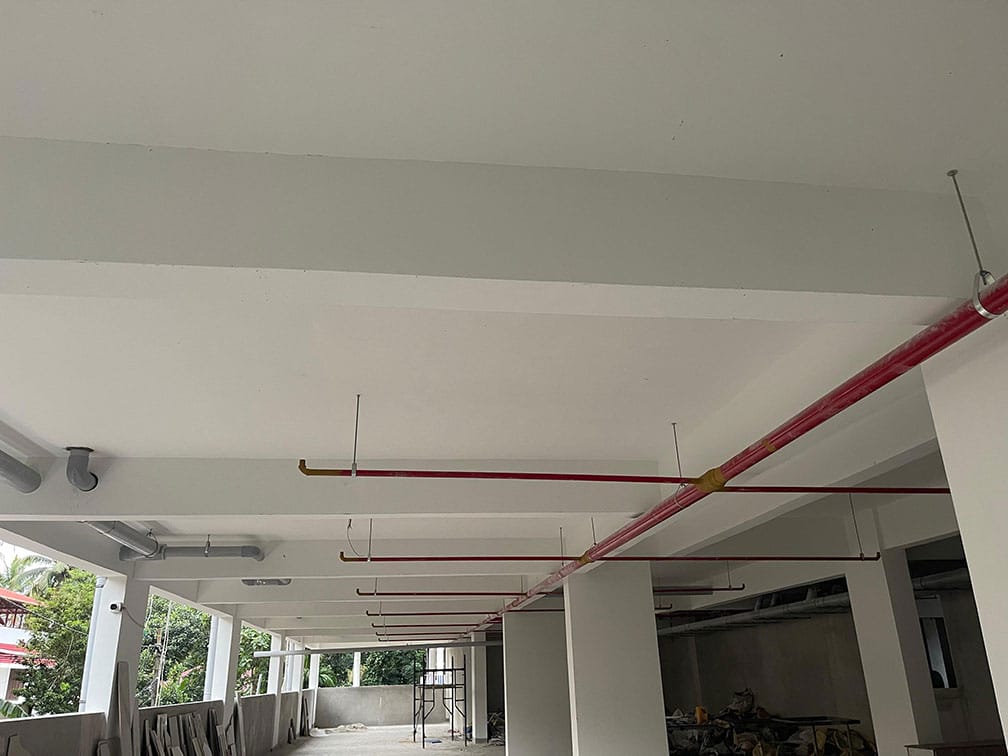

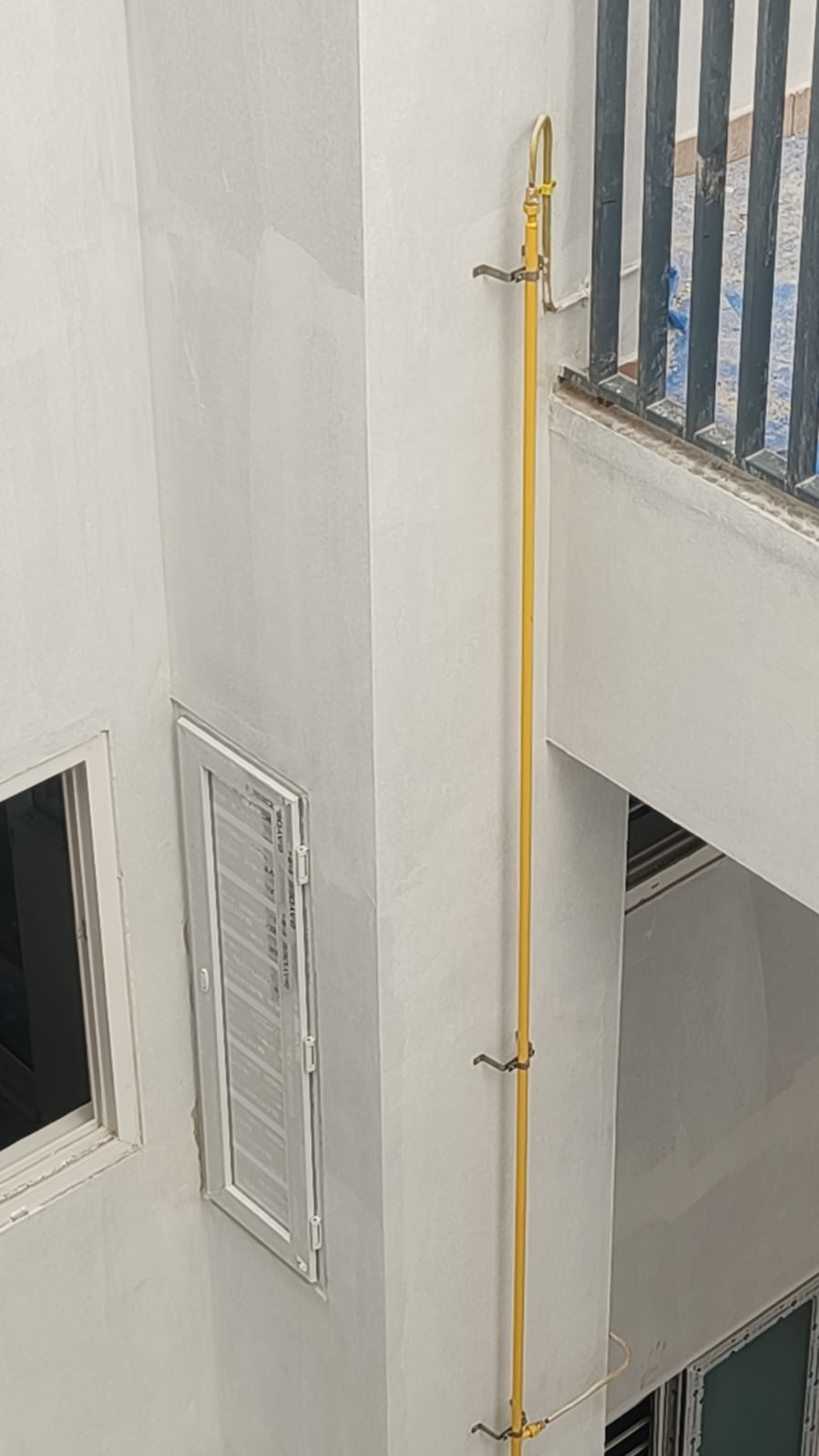

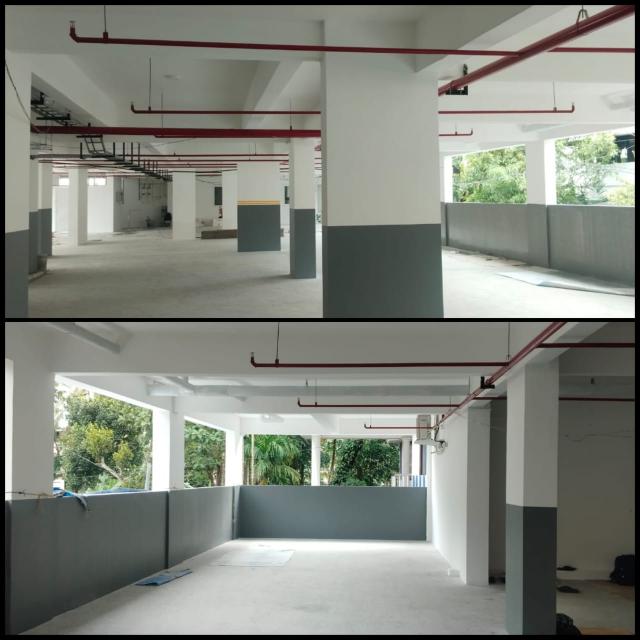

- FIRE FIGHTING WORK – 90% COMPLETED

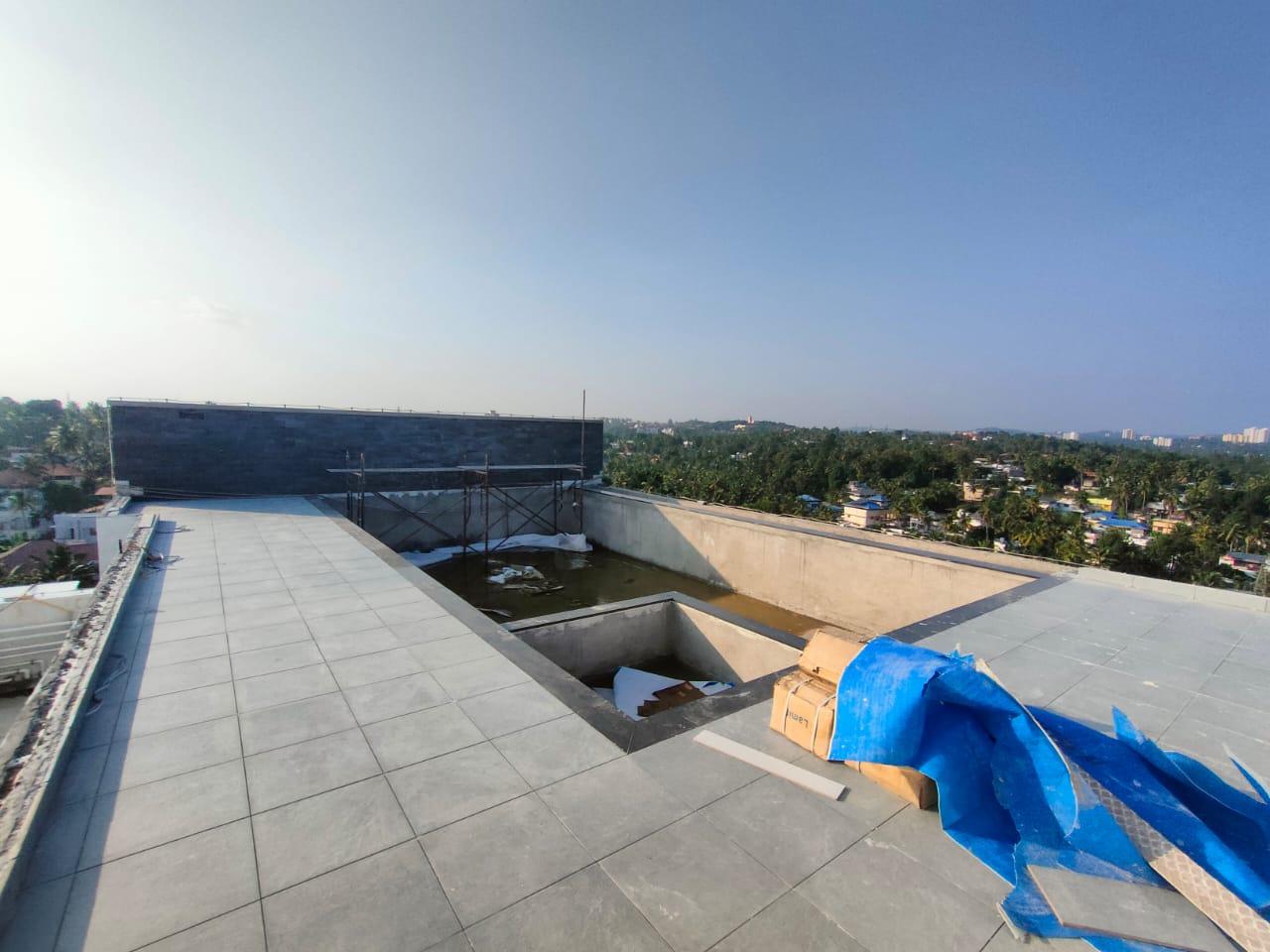

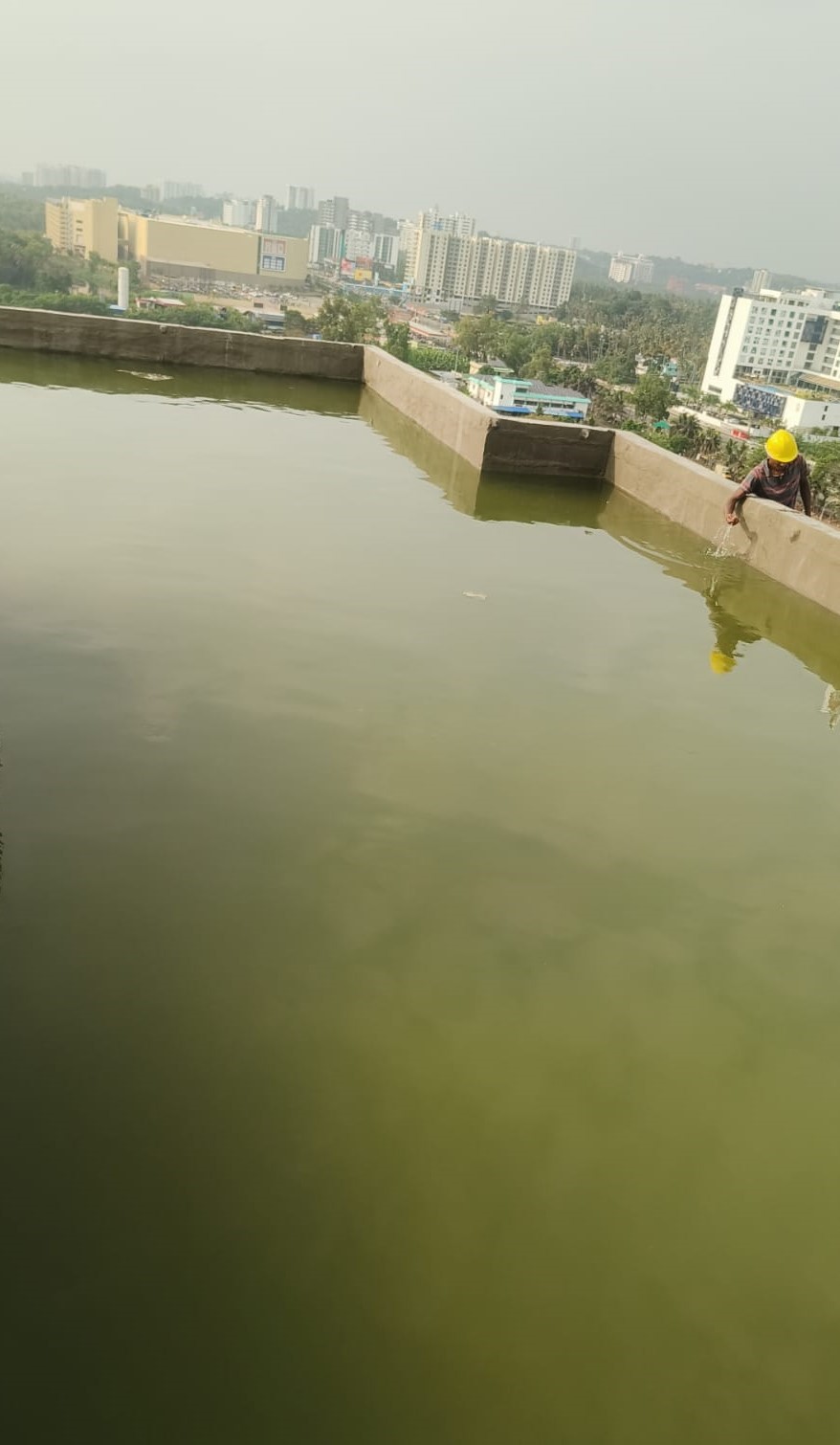

- COMMON AREA WATER PROOF IN WT, UG SUMP, STP, SWIMMING POOL & TERRACE – 90% COMPLETED

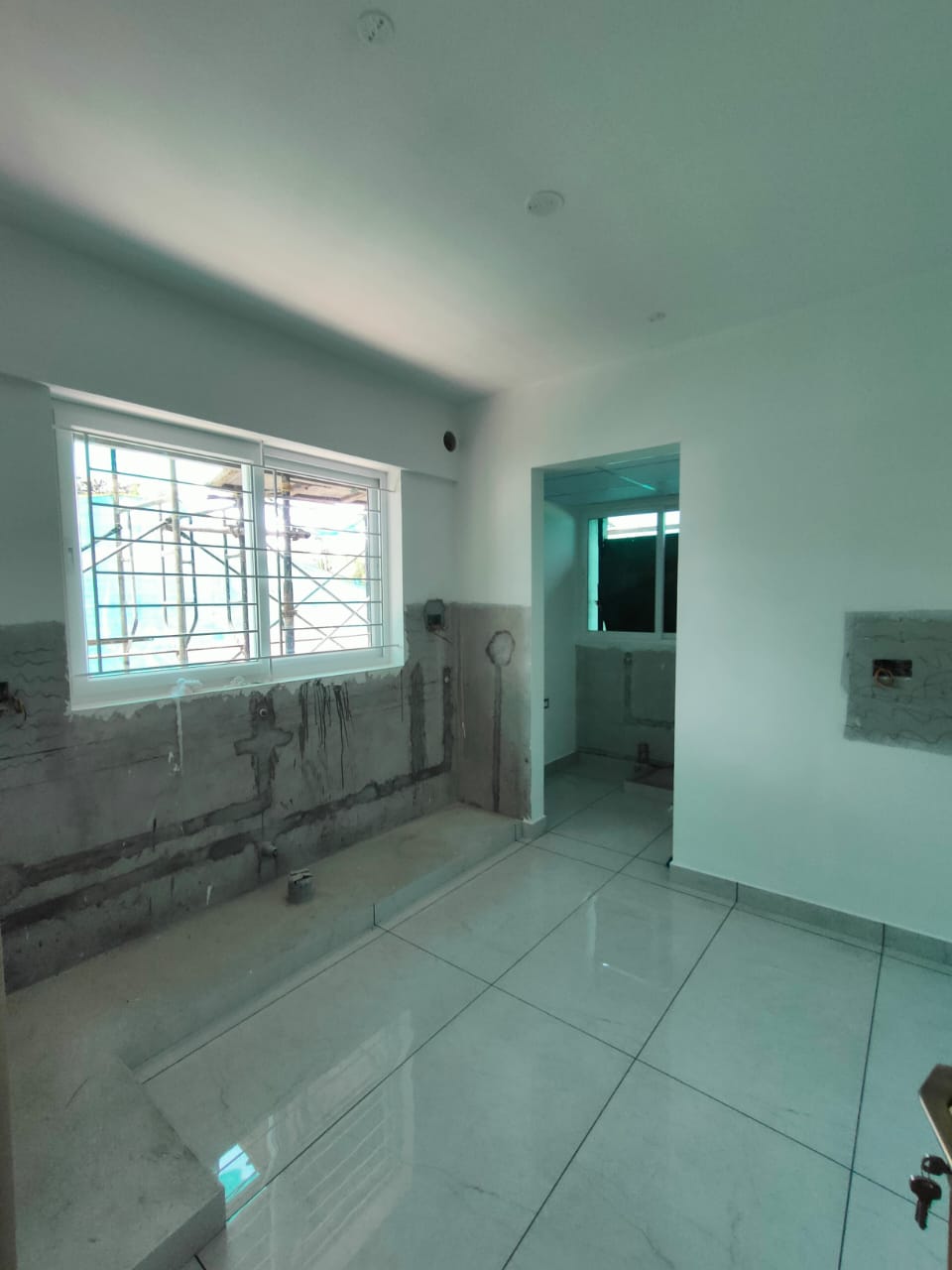

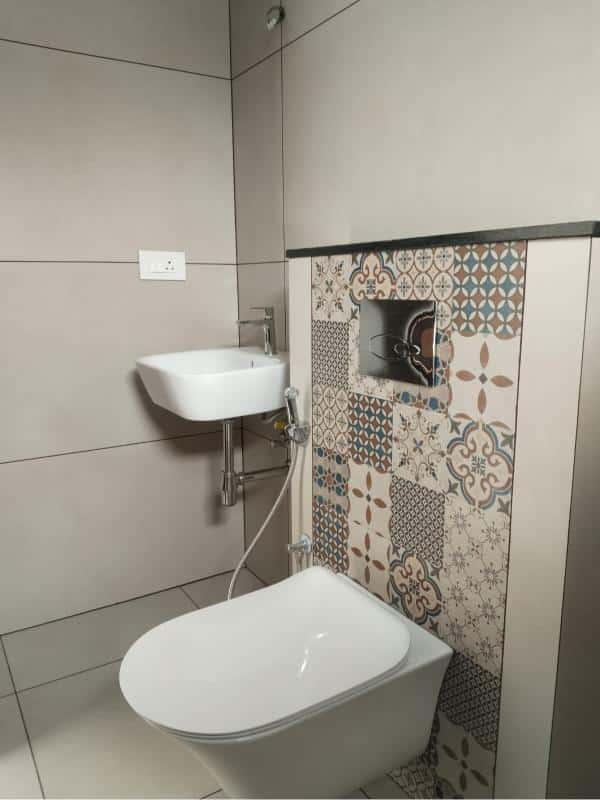

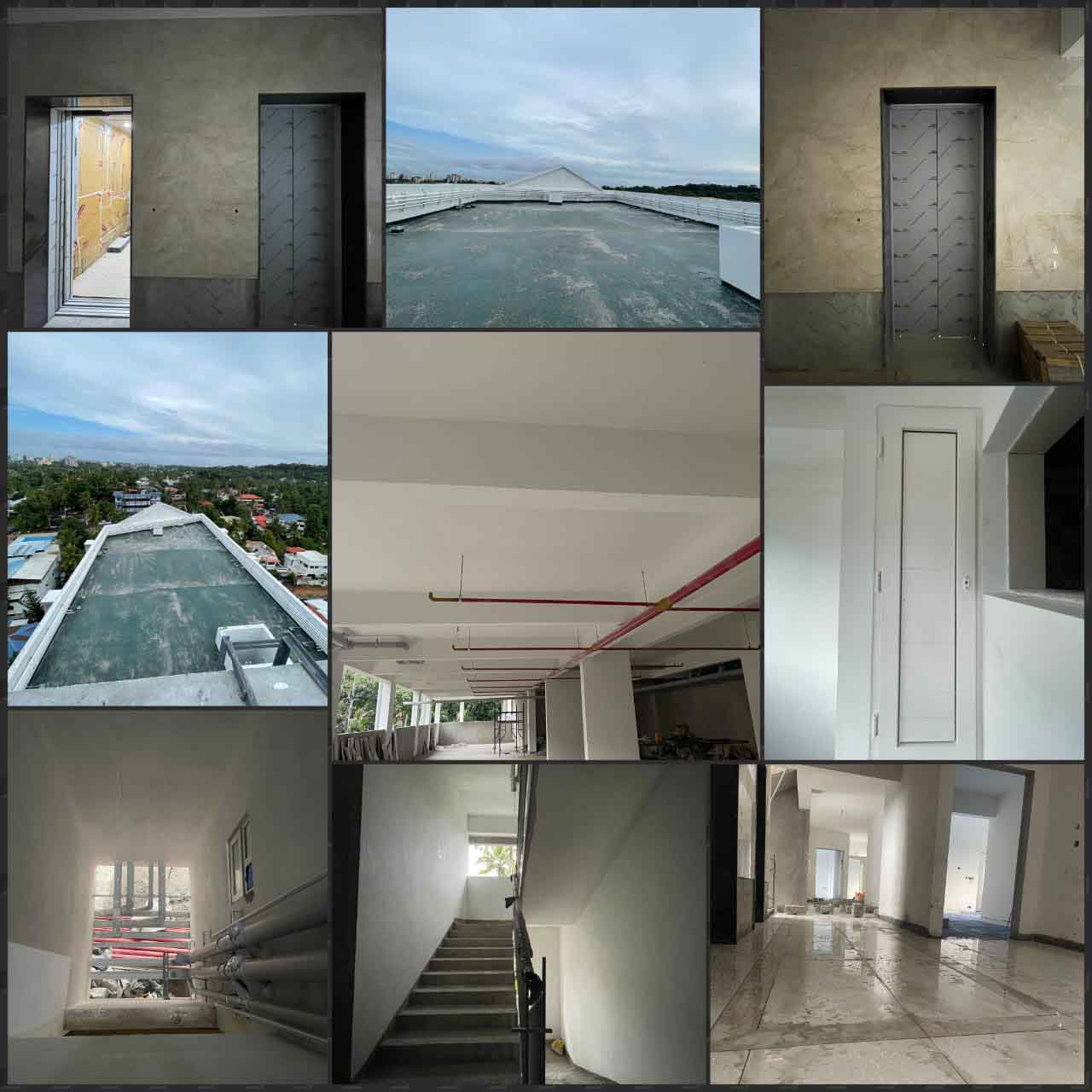

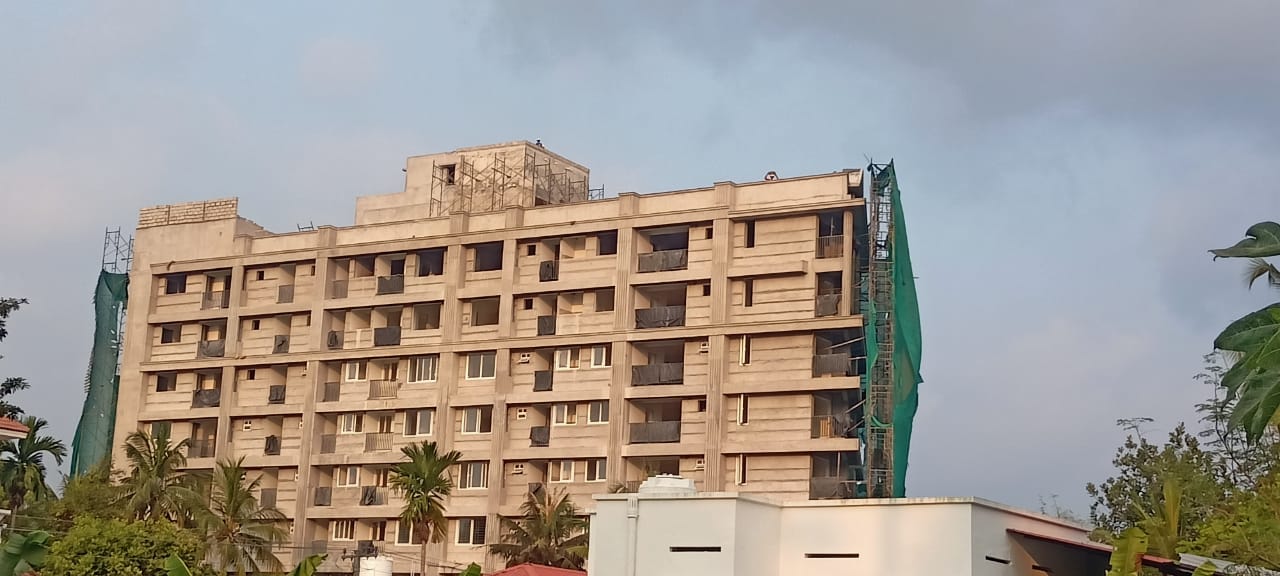

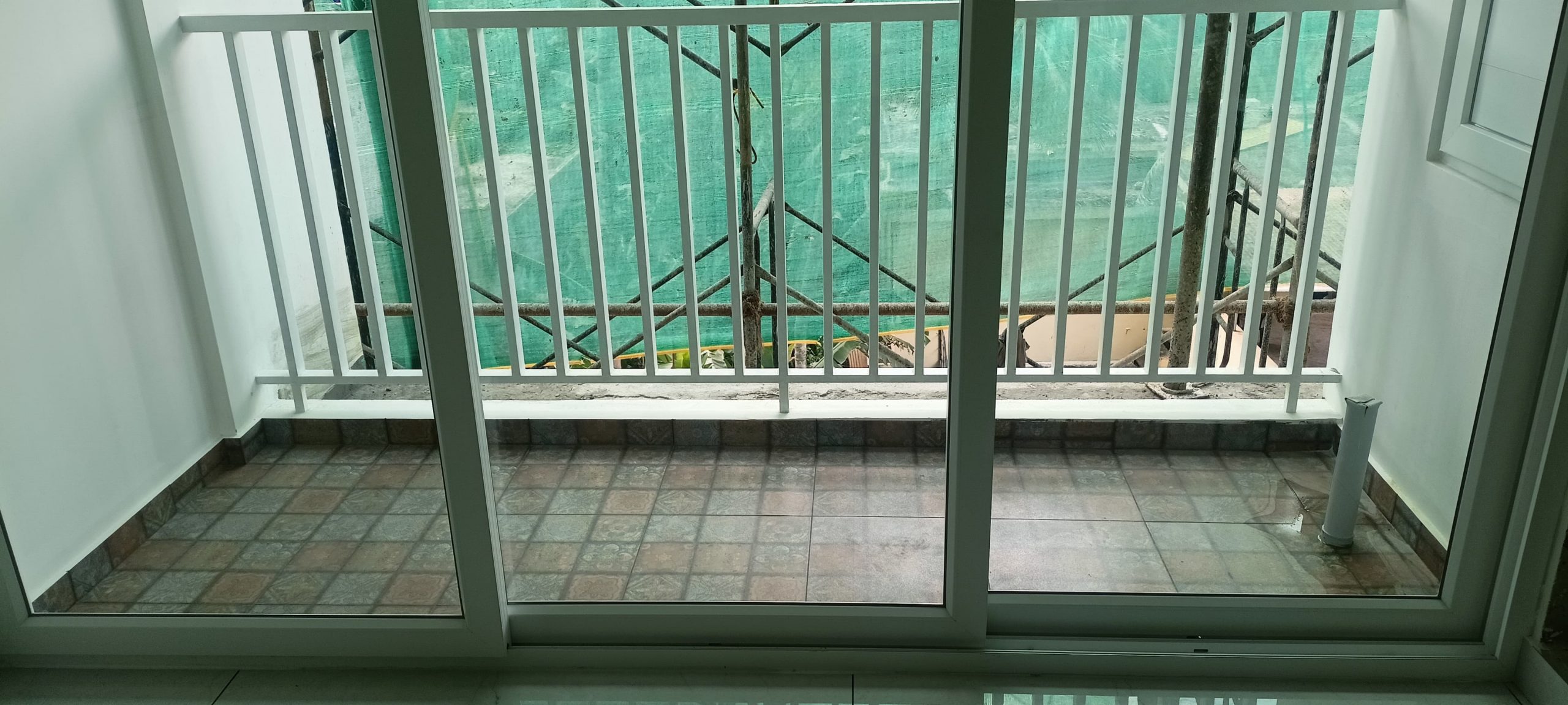

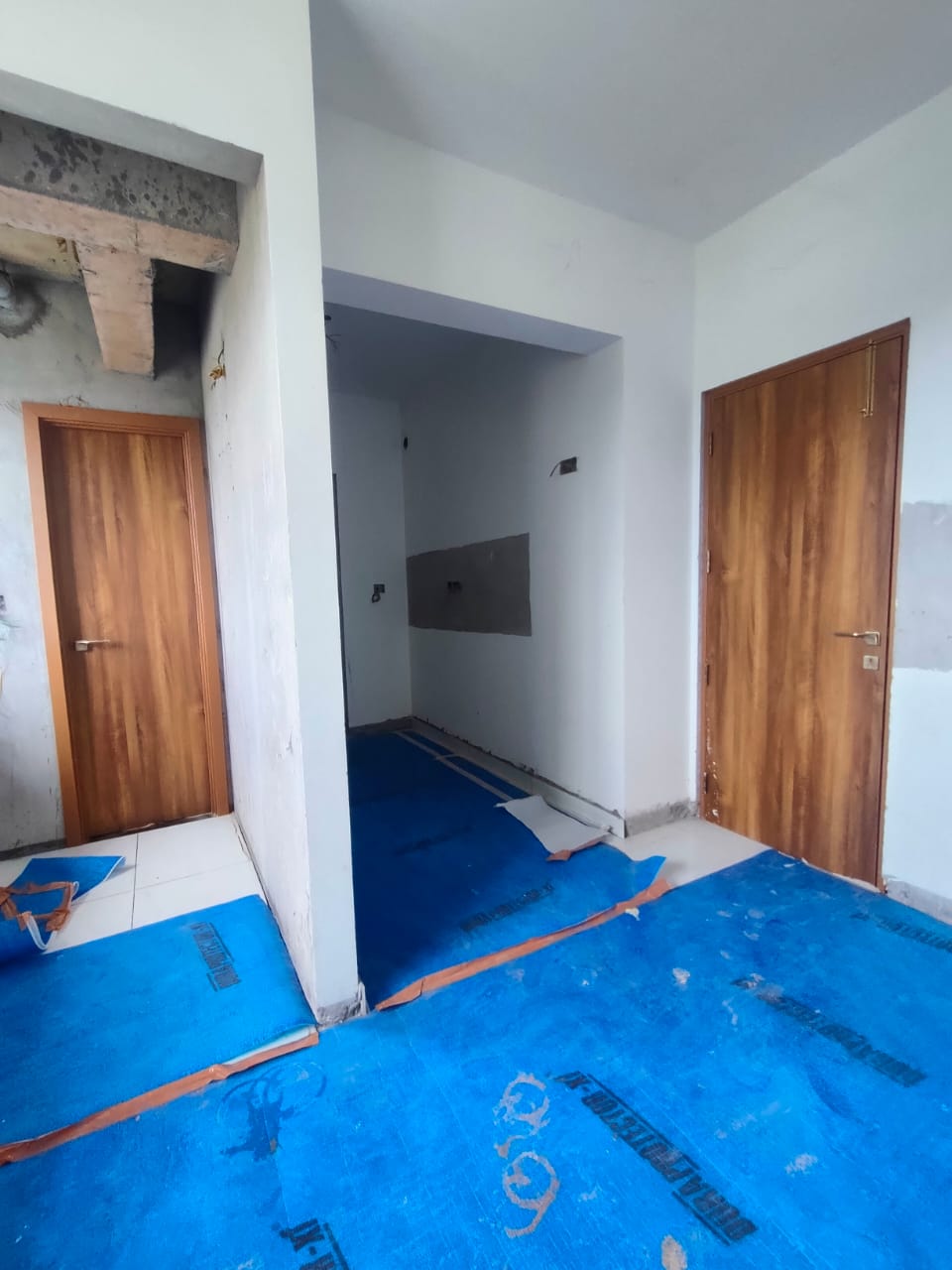

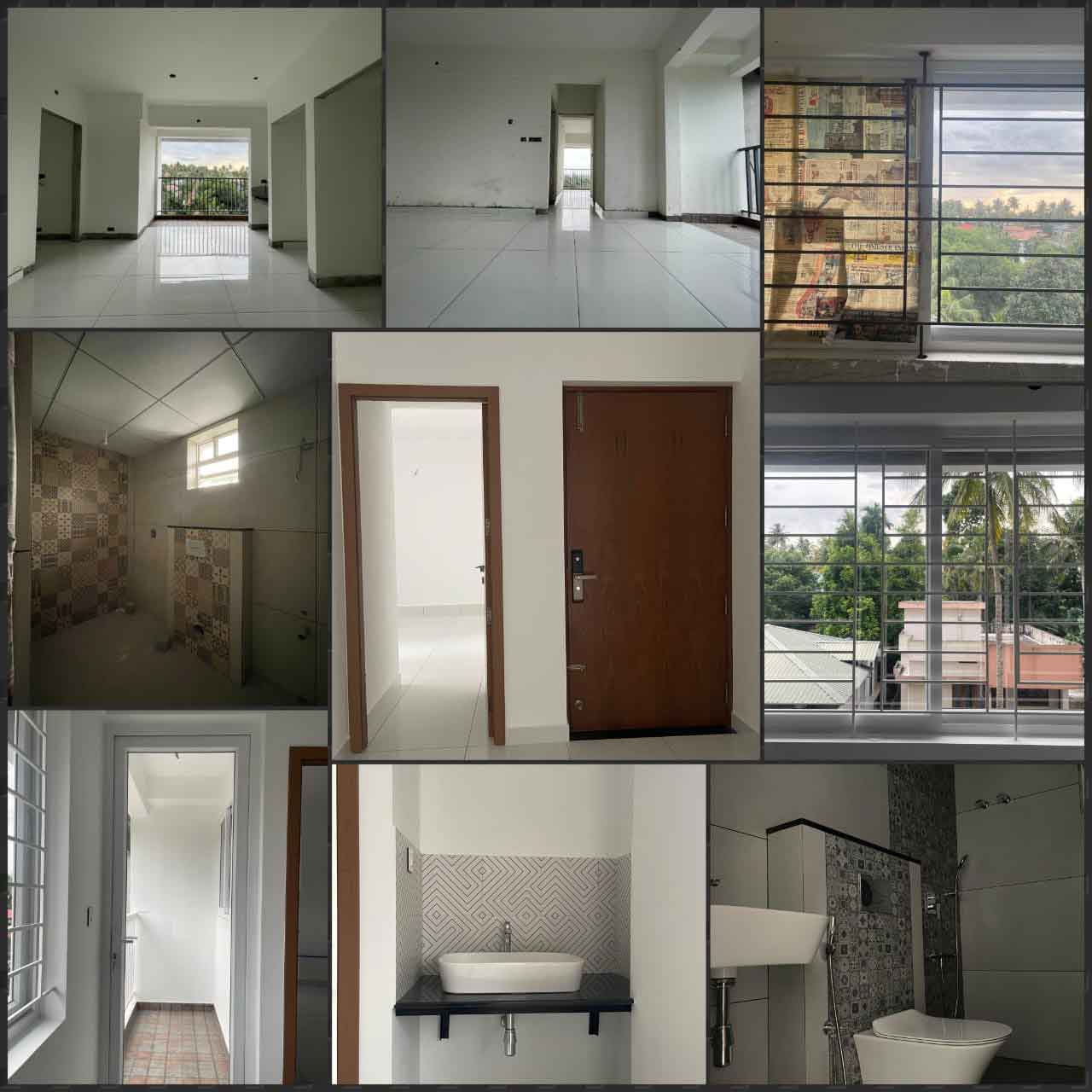

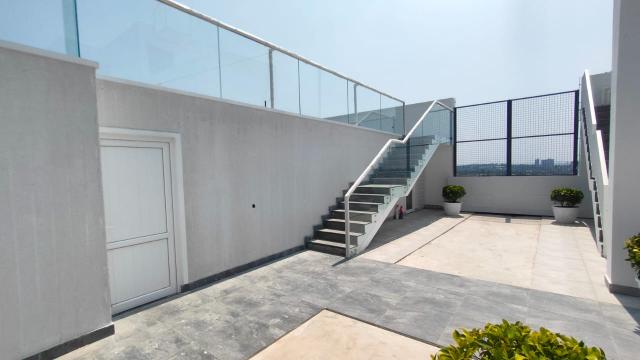

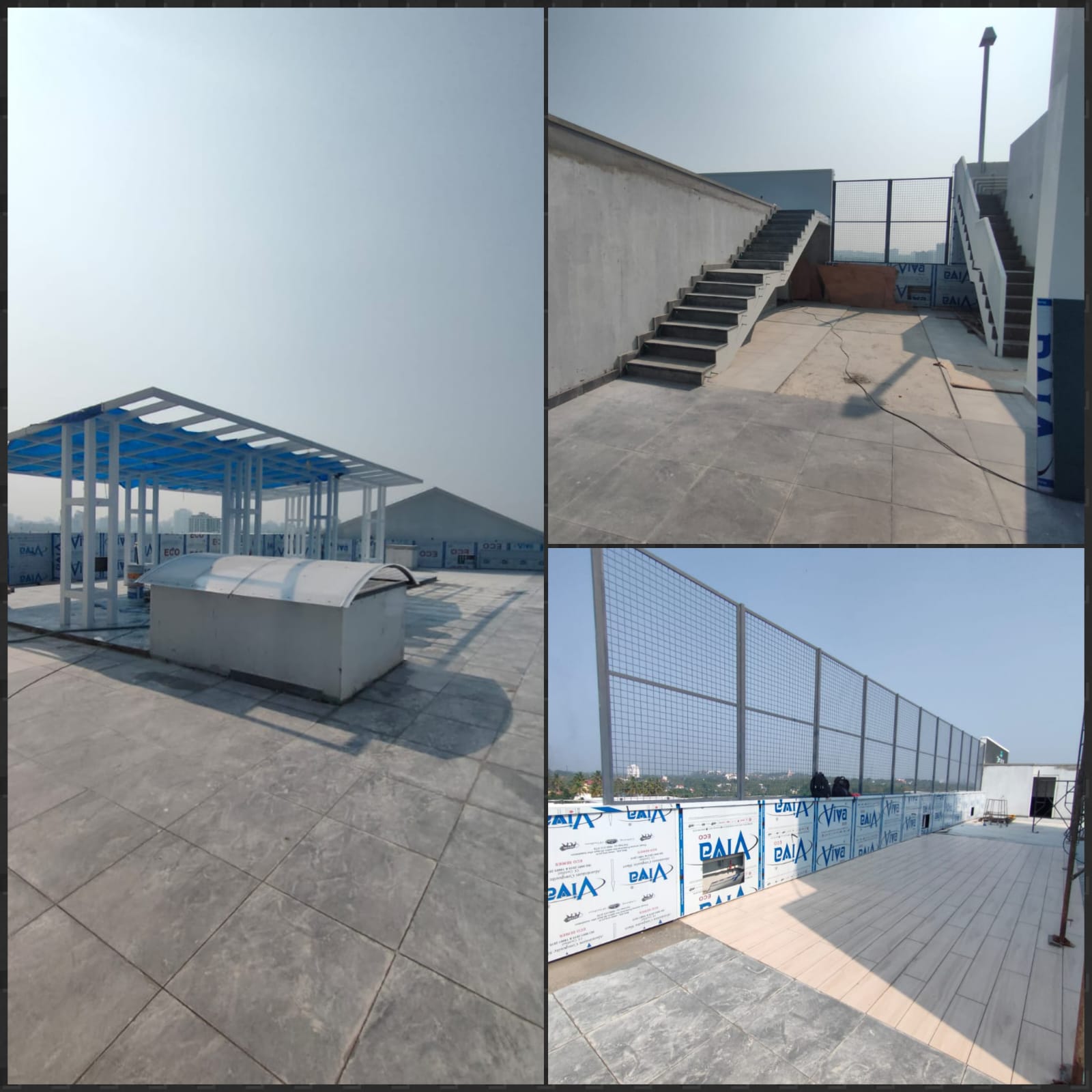

- MOCK UP APTS – 3D & 4B: READY FOR VISIT

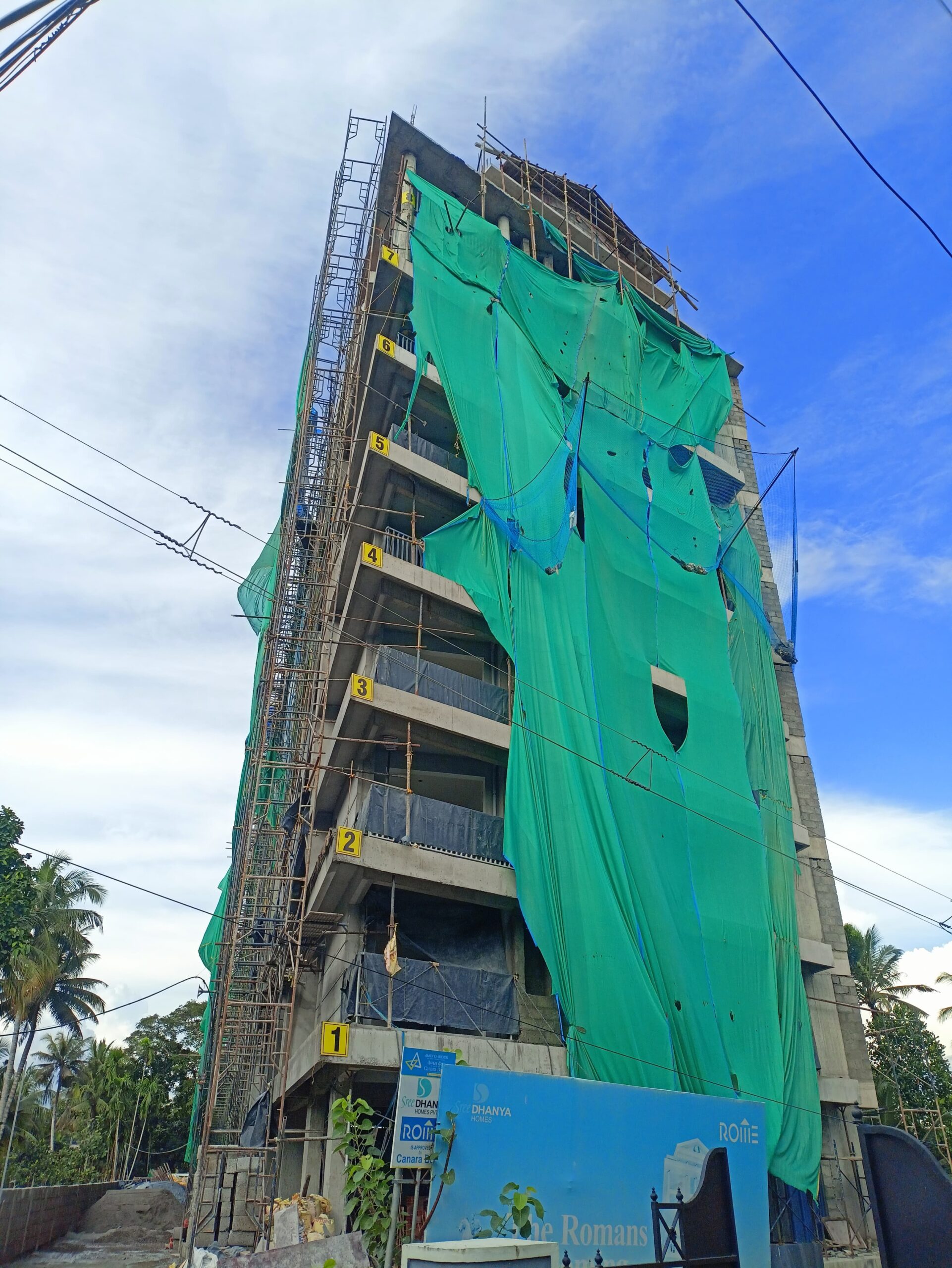

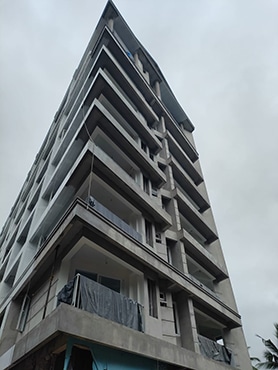

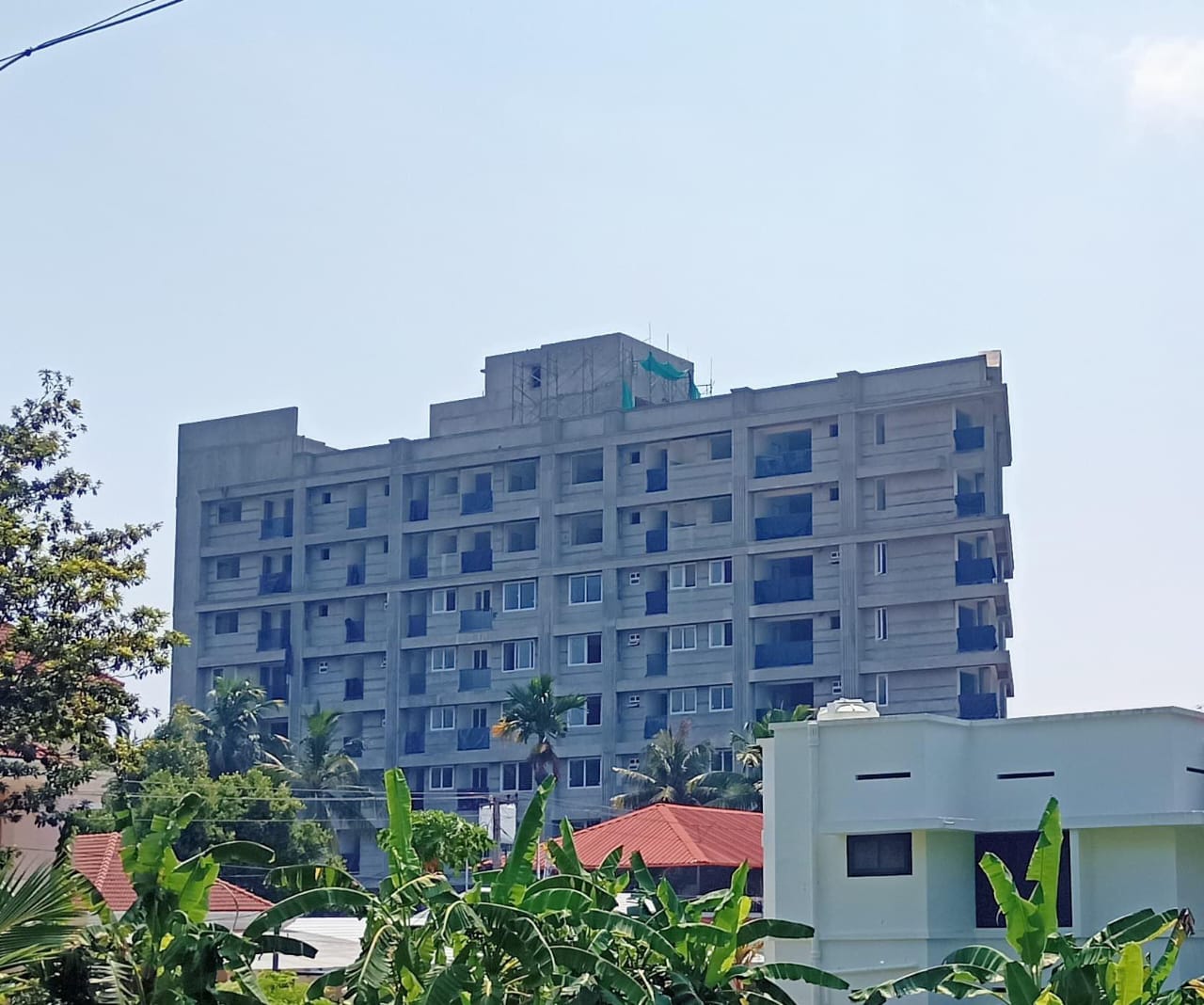

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 30.12.2023

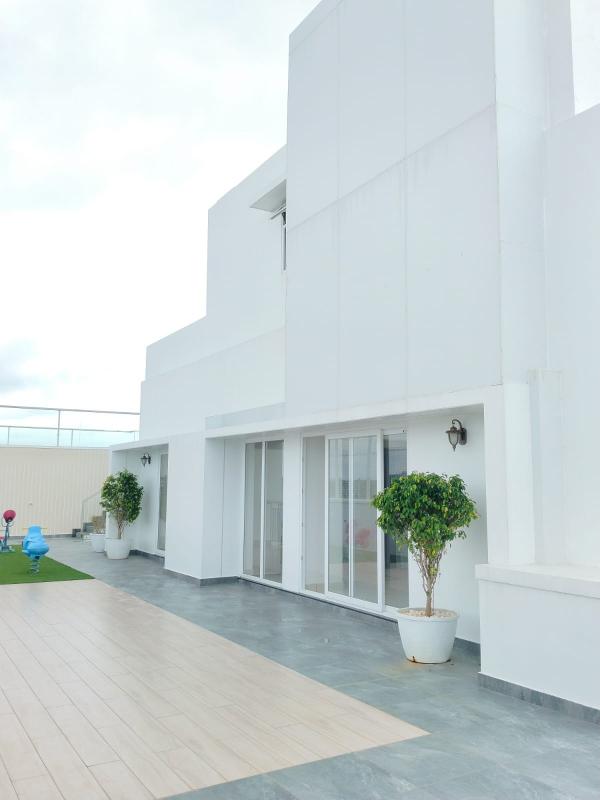

- RCC FOR TERRACE FLOOR – 100% COMPLETED

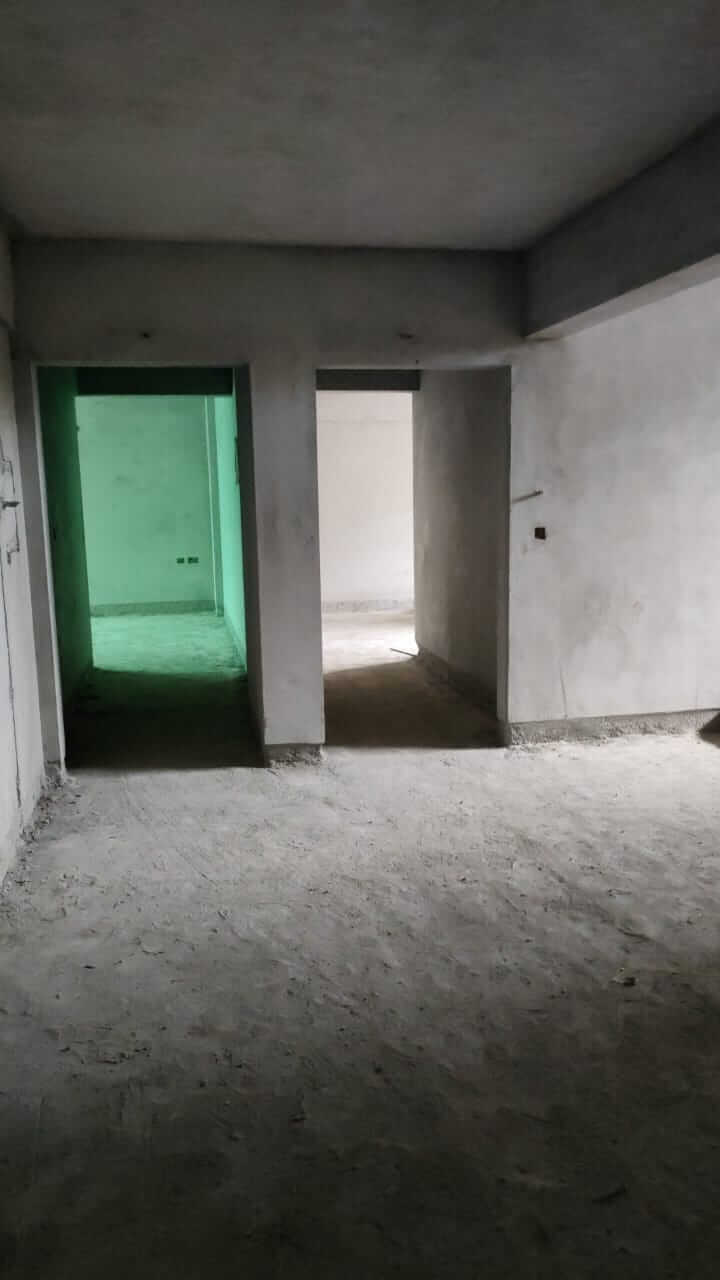

- CEILING PLASTERING – 39 APT OUT 39 COMPLETED
- BLOCK MASONRY – 39 APT OUT OF 39 COMPLETED
- INSIDE WALL PLASTERING – 37 APT OUT OF 39 COMPLETED

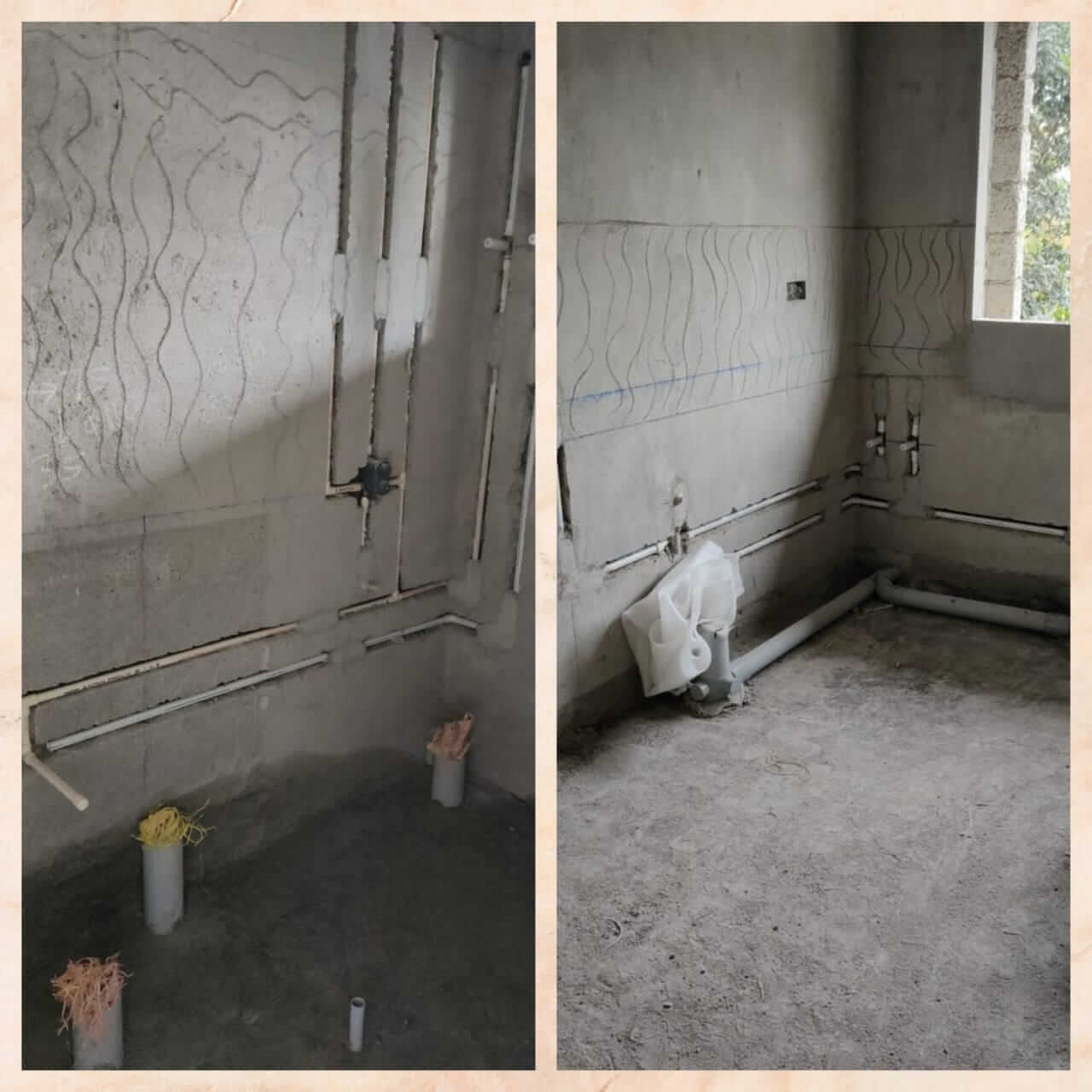

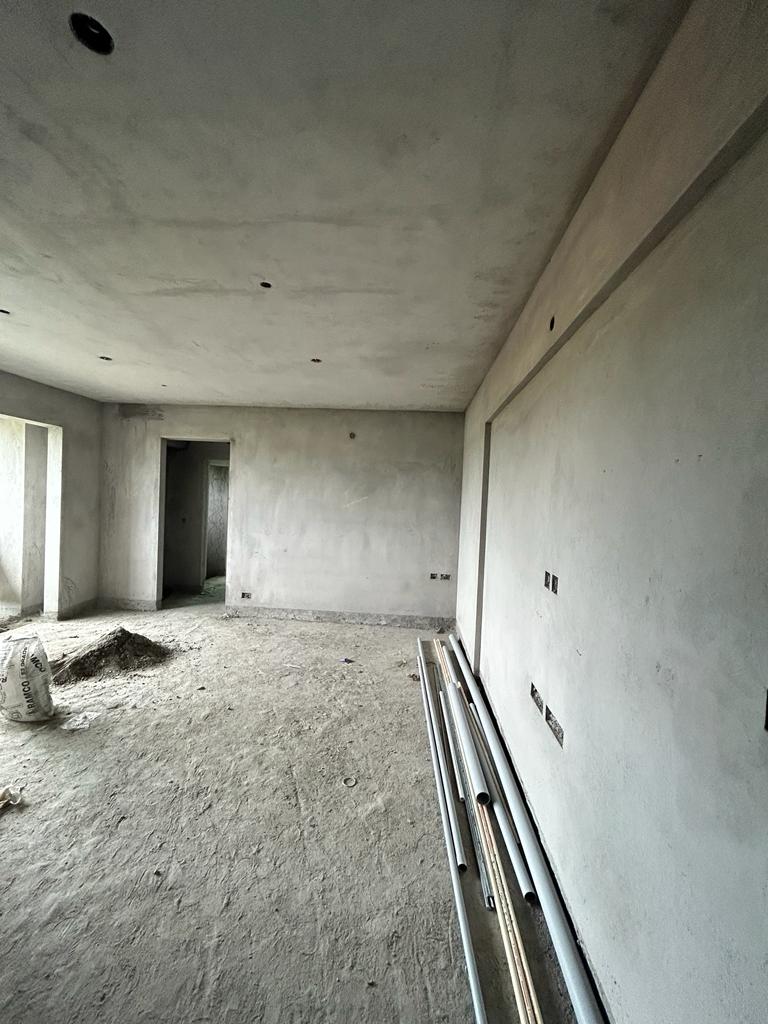

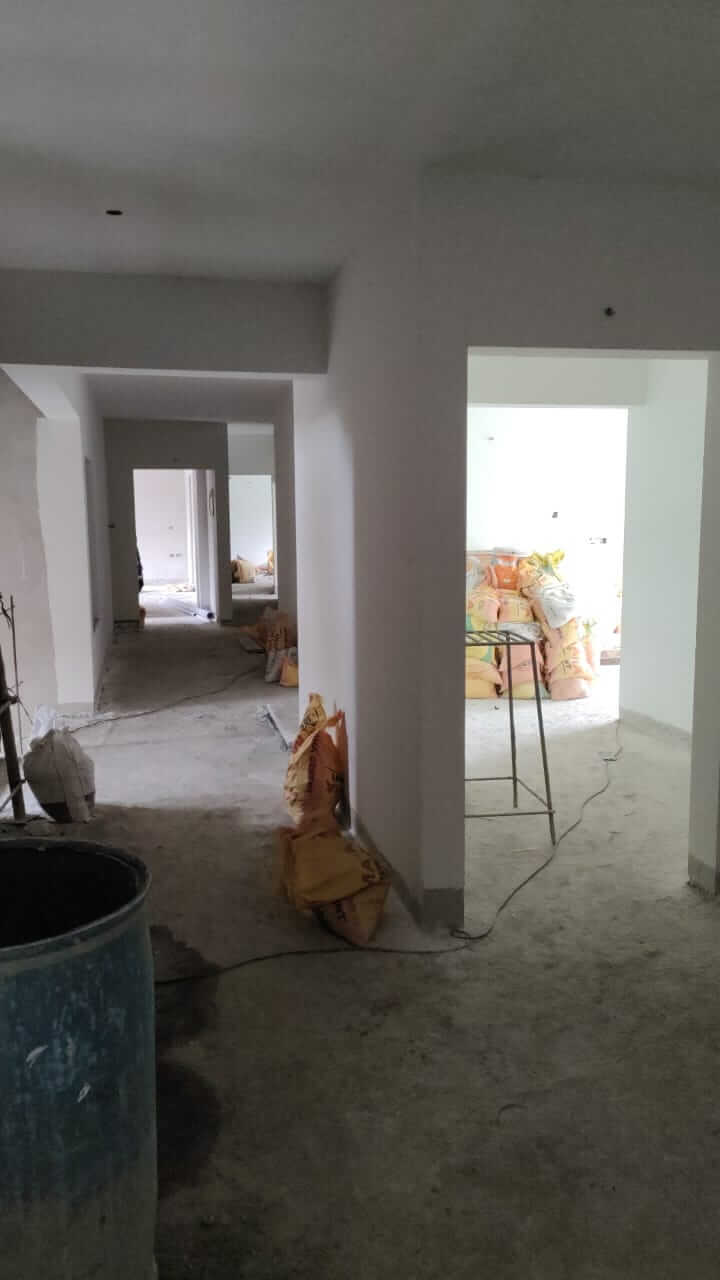

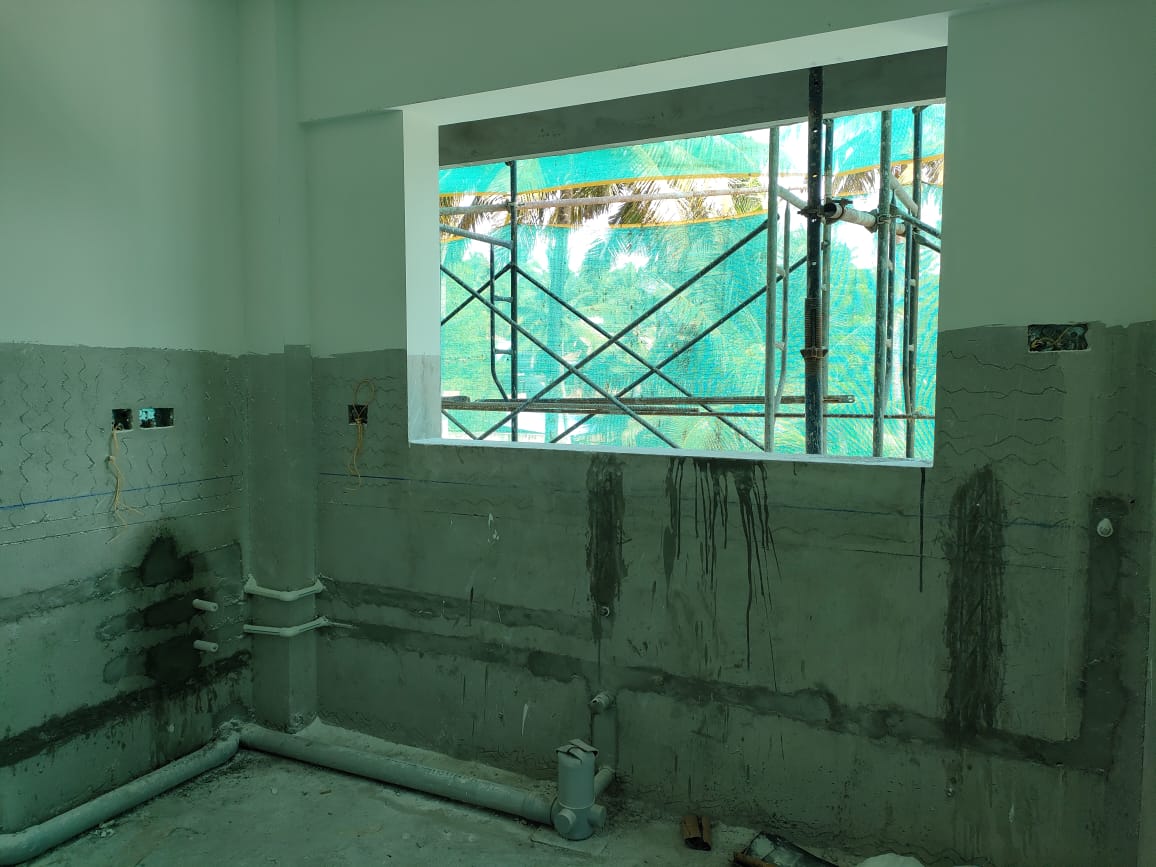

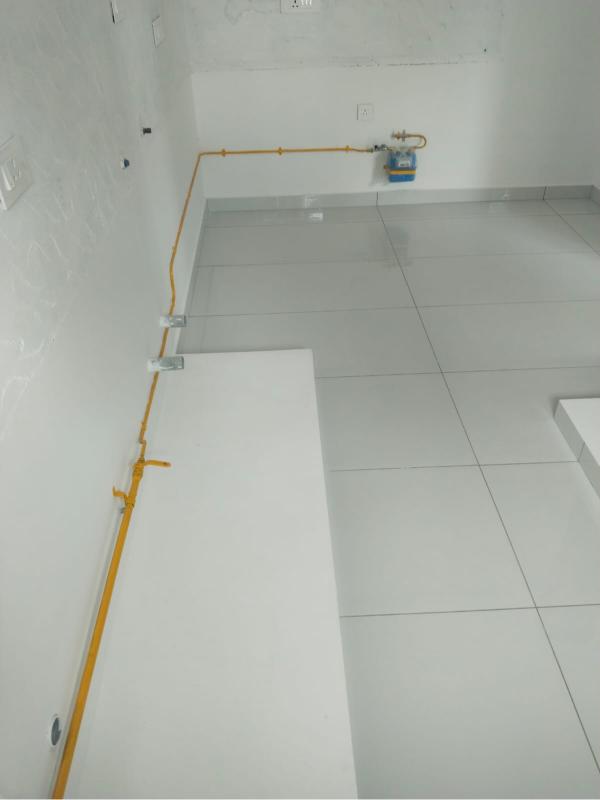

- INTERNAL PLUMBING WORK – 27 APT OUT OF 39 COMPLETED
- APT INTERNAL WATERPROOFING – 17 APT OUT OF 39 COMPLETED

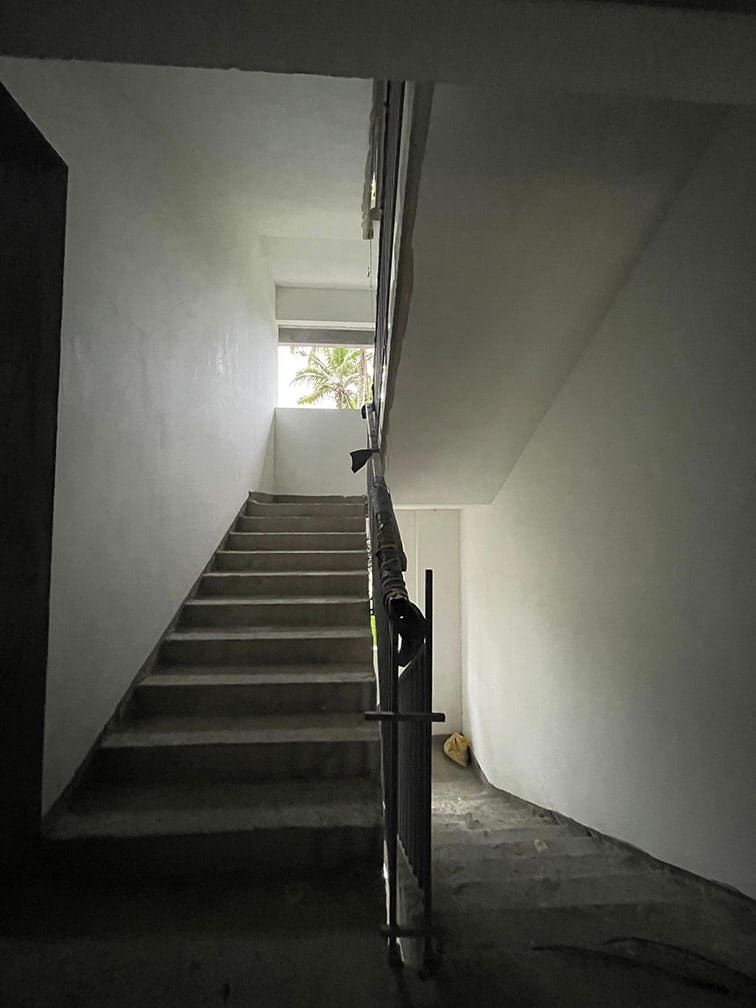

- BALCONY HANDRAIL FIXING – 39 APT OUT OF 39 COMPLETED

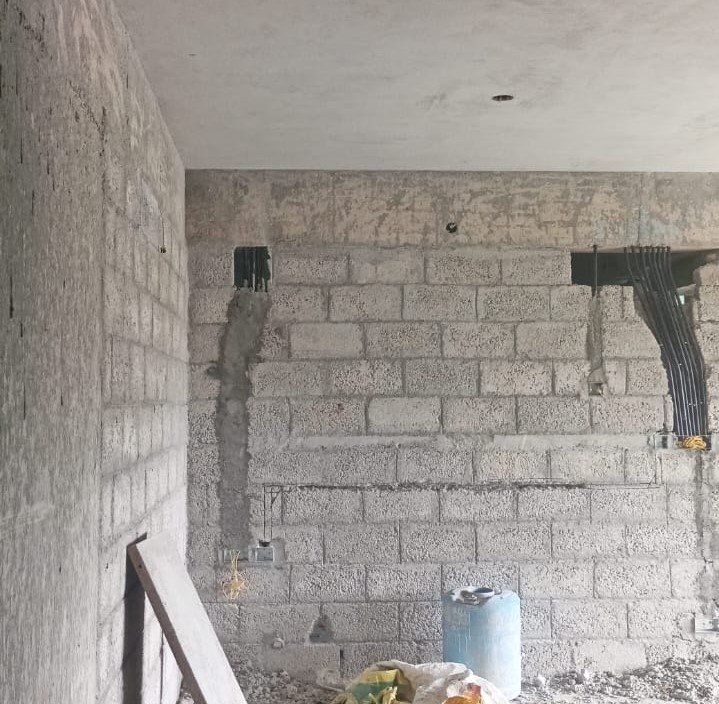

- ELECTRICAL WALL CHASING AND CONDUITING – 39 APT COMPLETED

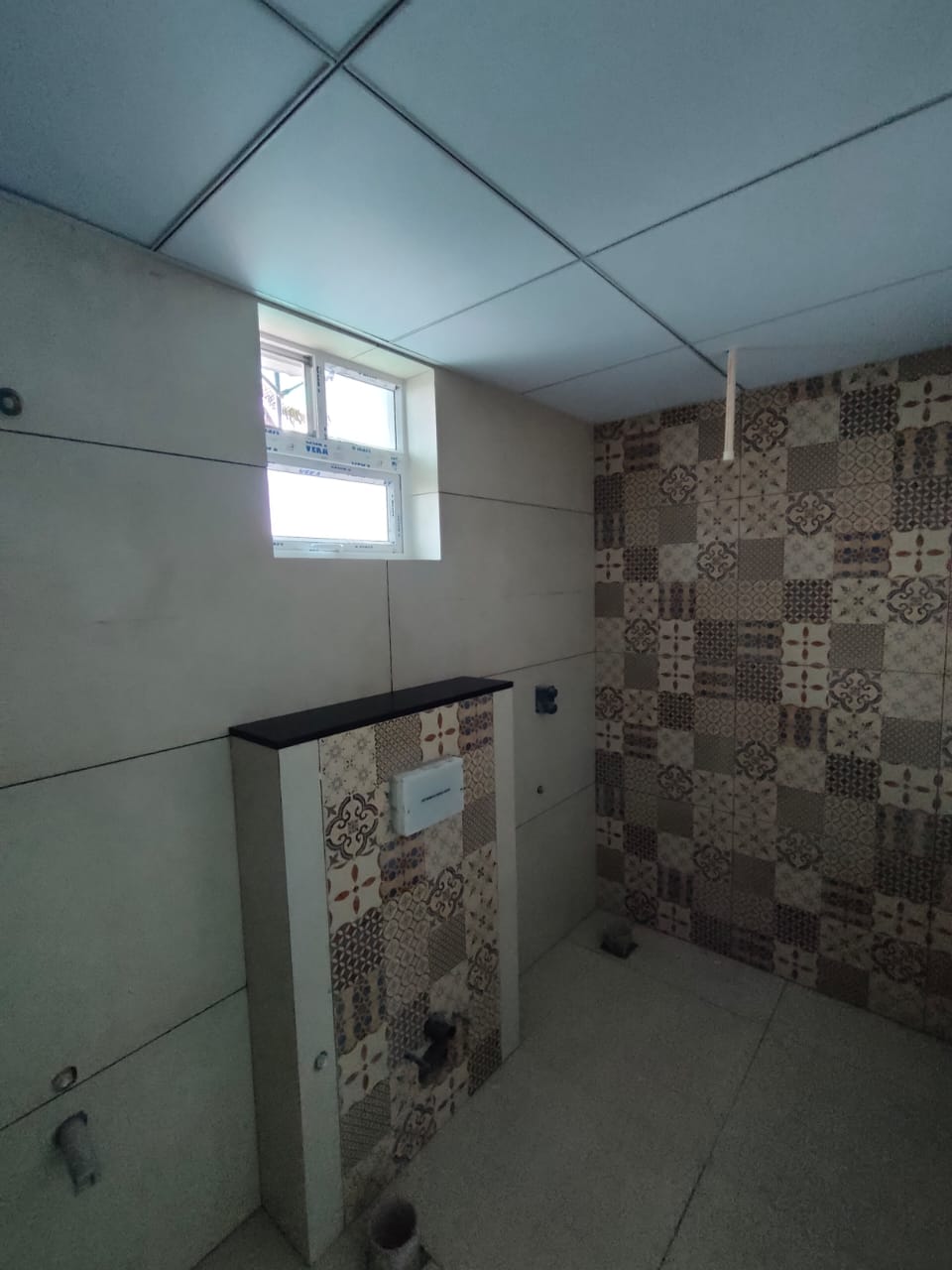

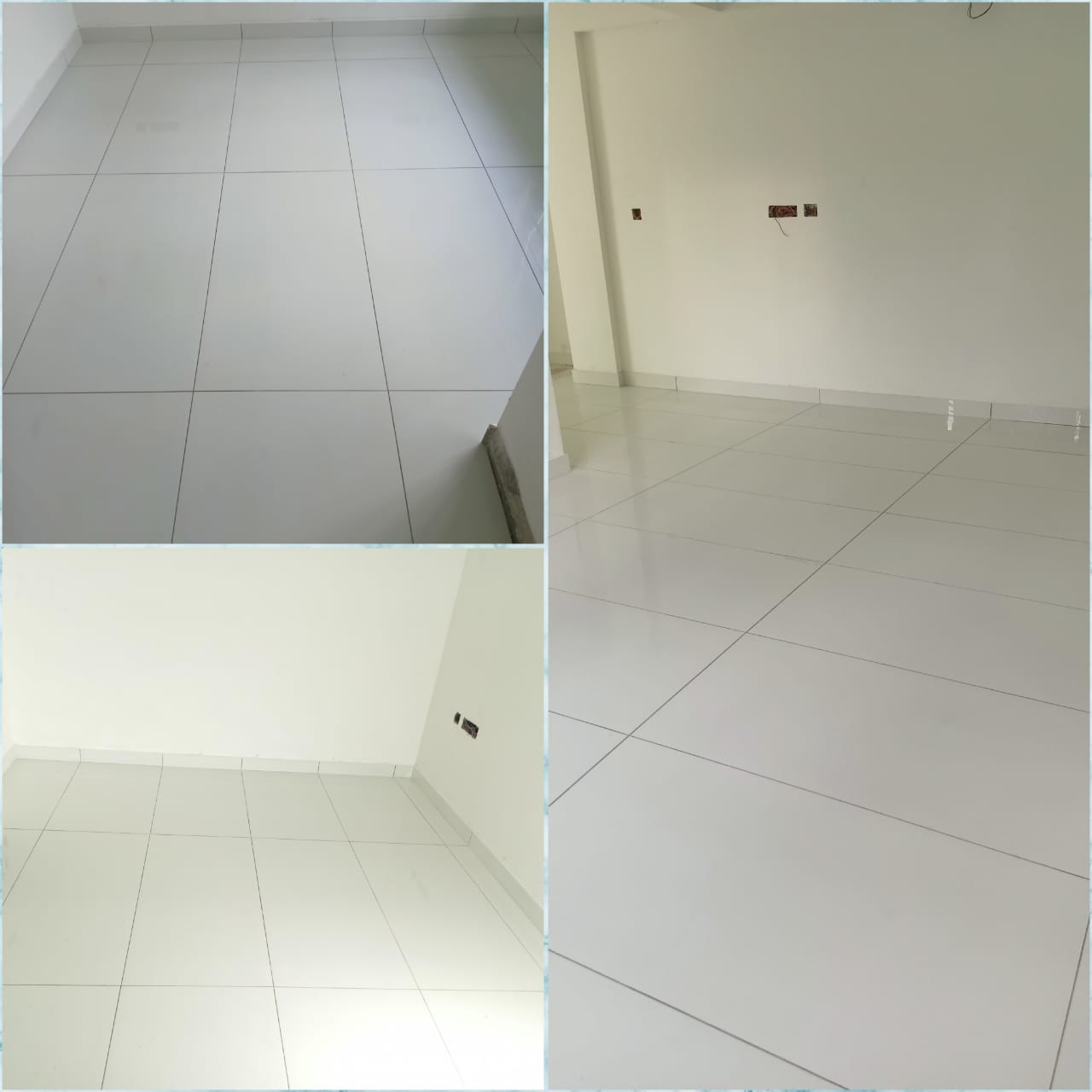

- WALL TILING WORK – 5 APT OUT OF 39 COMPLETED

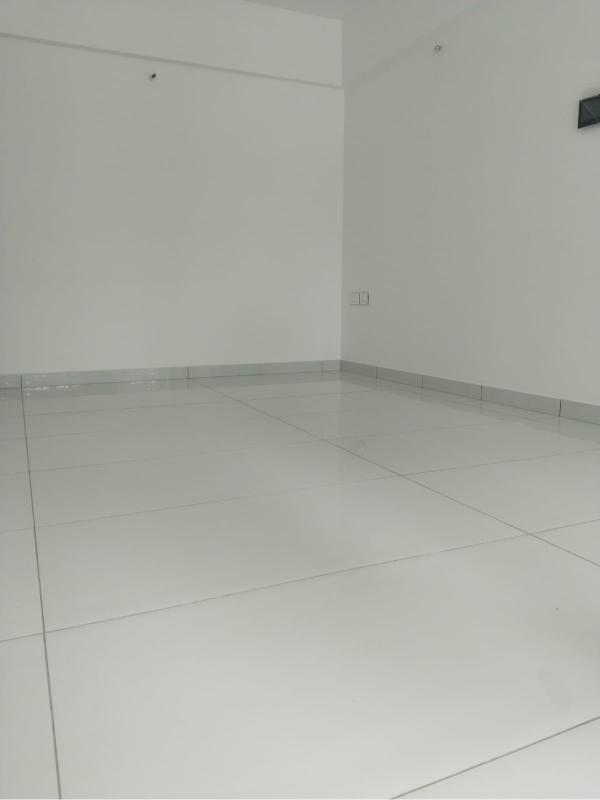

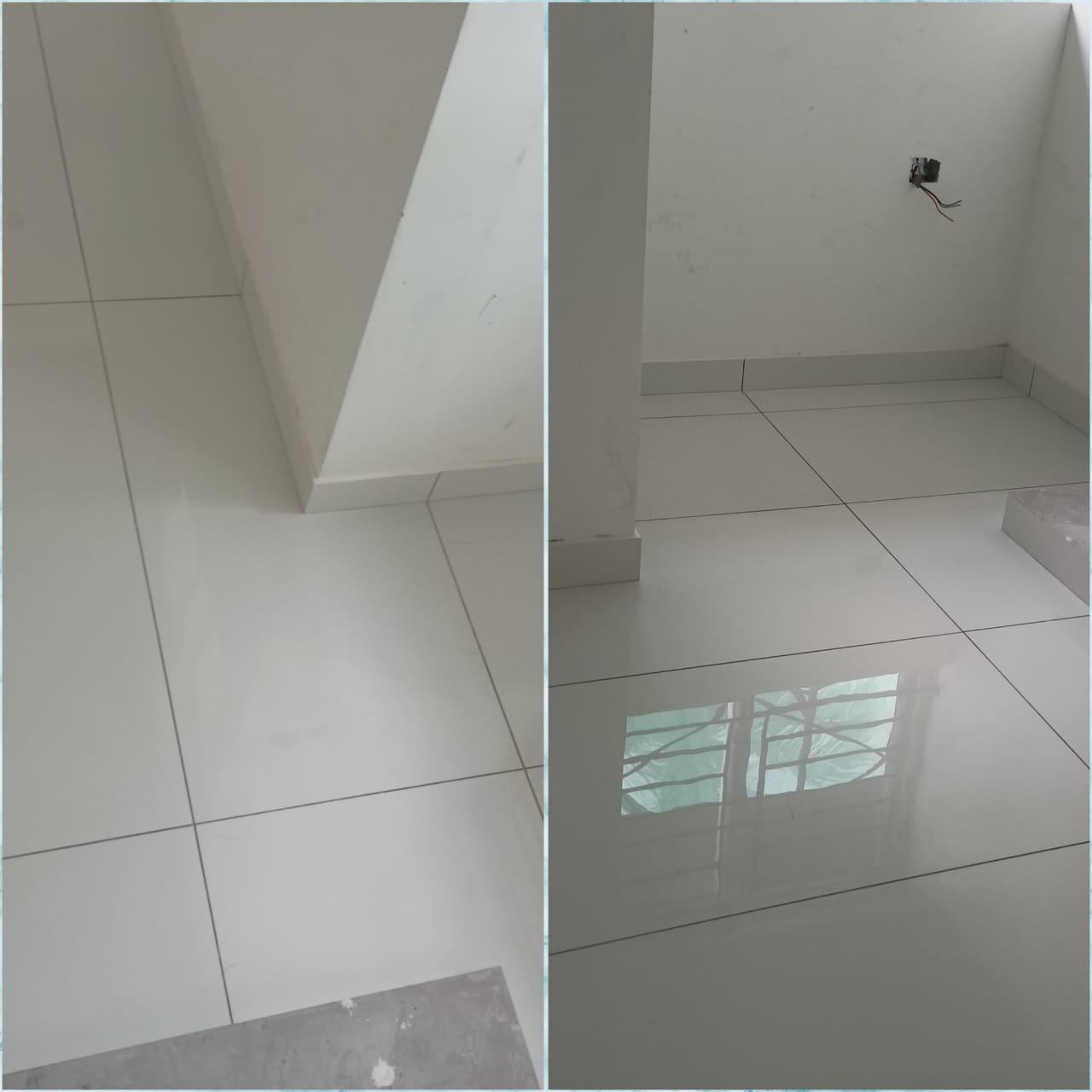

- FLOOR TILING WORK – 4 APT OUT OF 39 COMPLETED

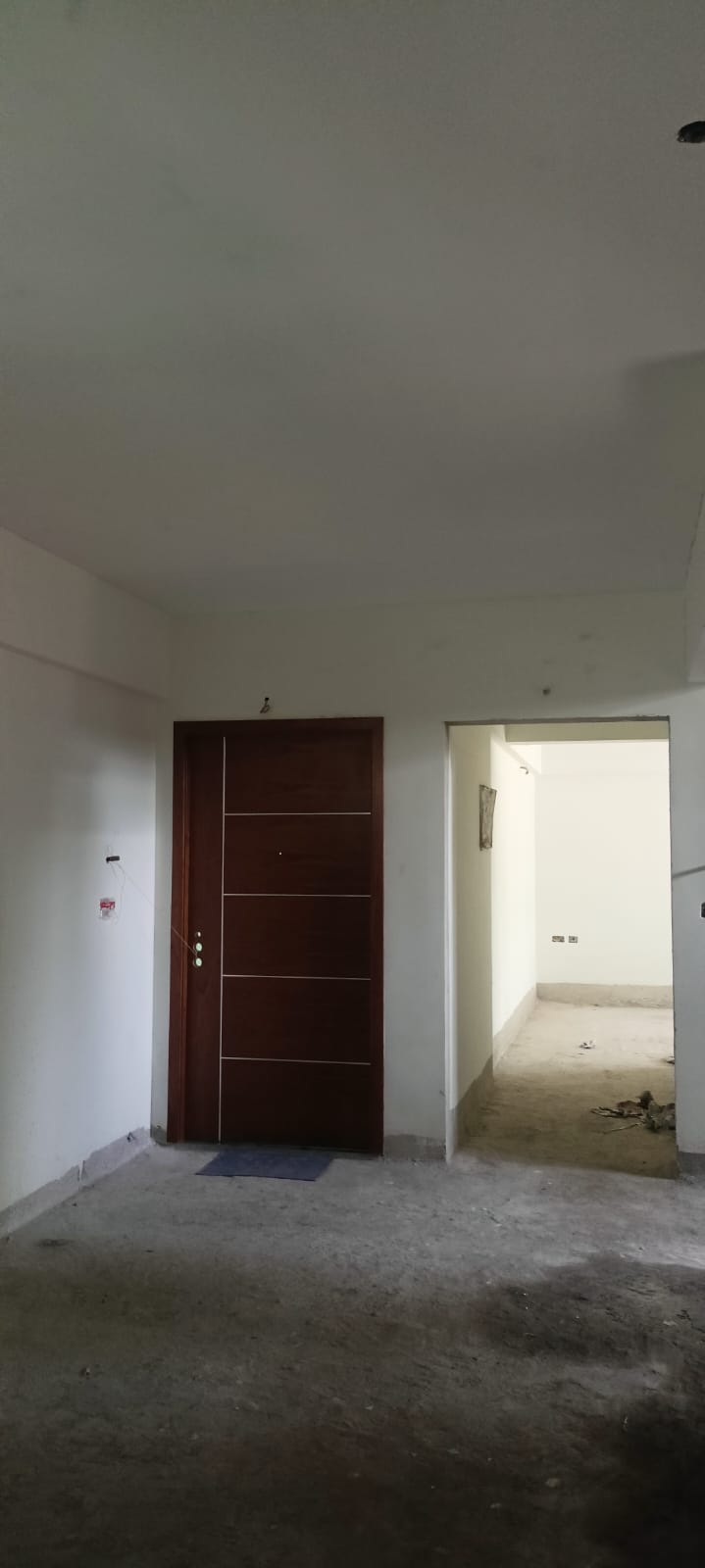

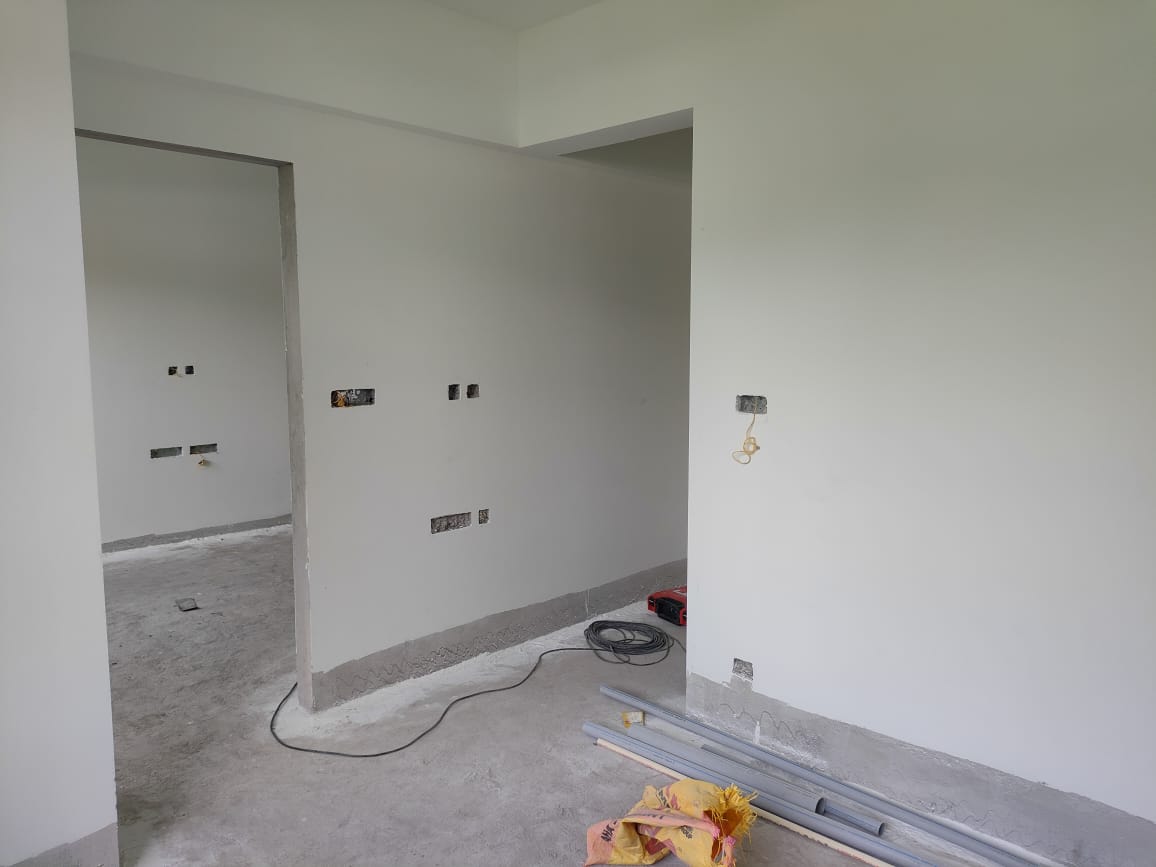

- WALL PUTTY WORK – 18 APT OUT OF 39 COMPLETED

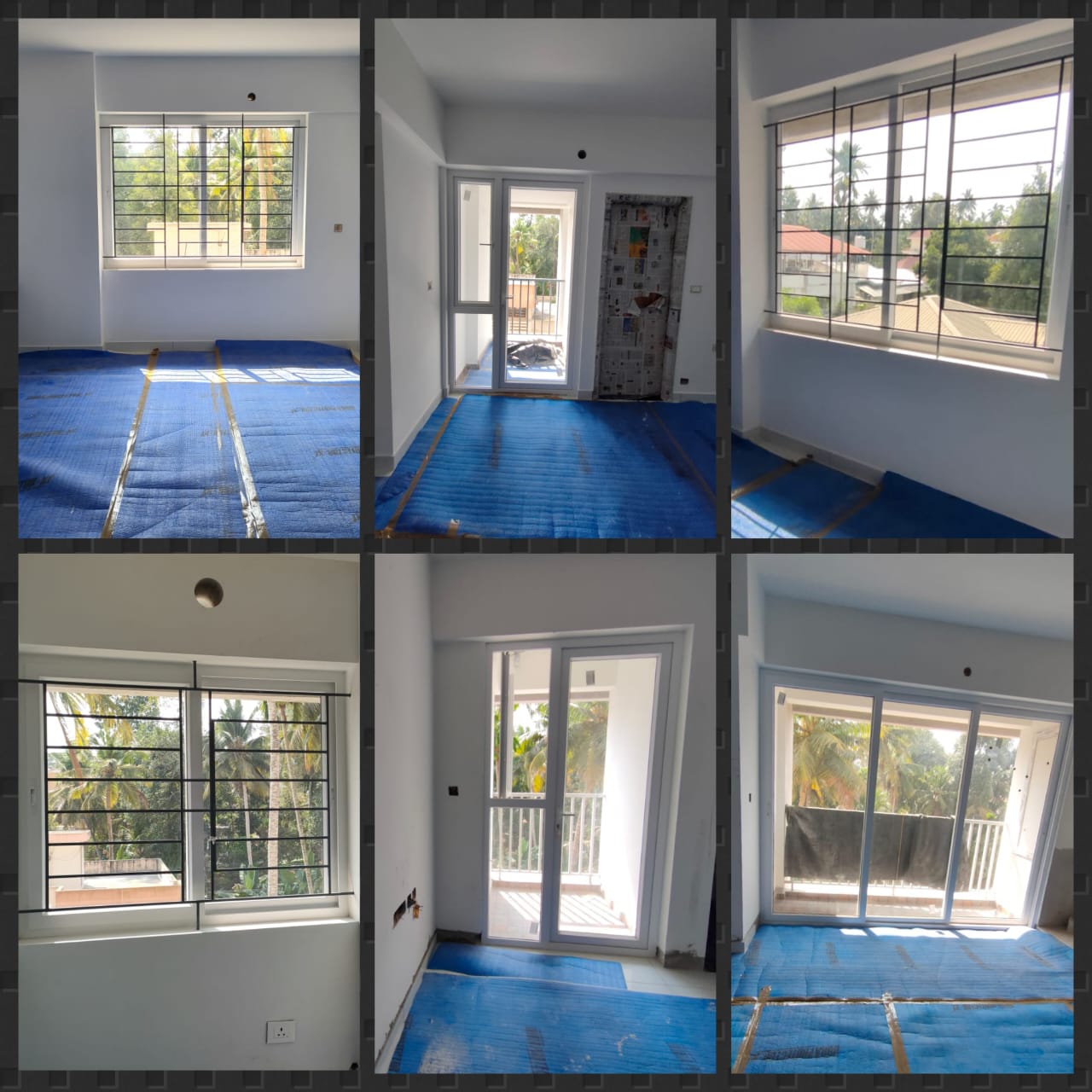

- UPVC WINDOW & DOOR FIXING – 3 APT OUT OF 39 COMPLETED
- ELECTRICAL WIRING – 4 APT OUT OF 39 COMPLETED
- PRIMER WORK – MOCK UP APT (1D & 1E) COMPLETED

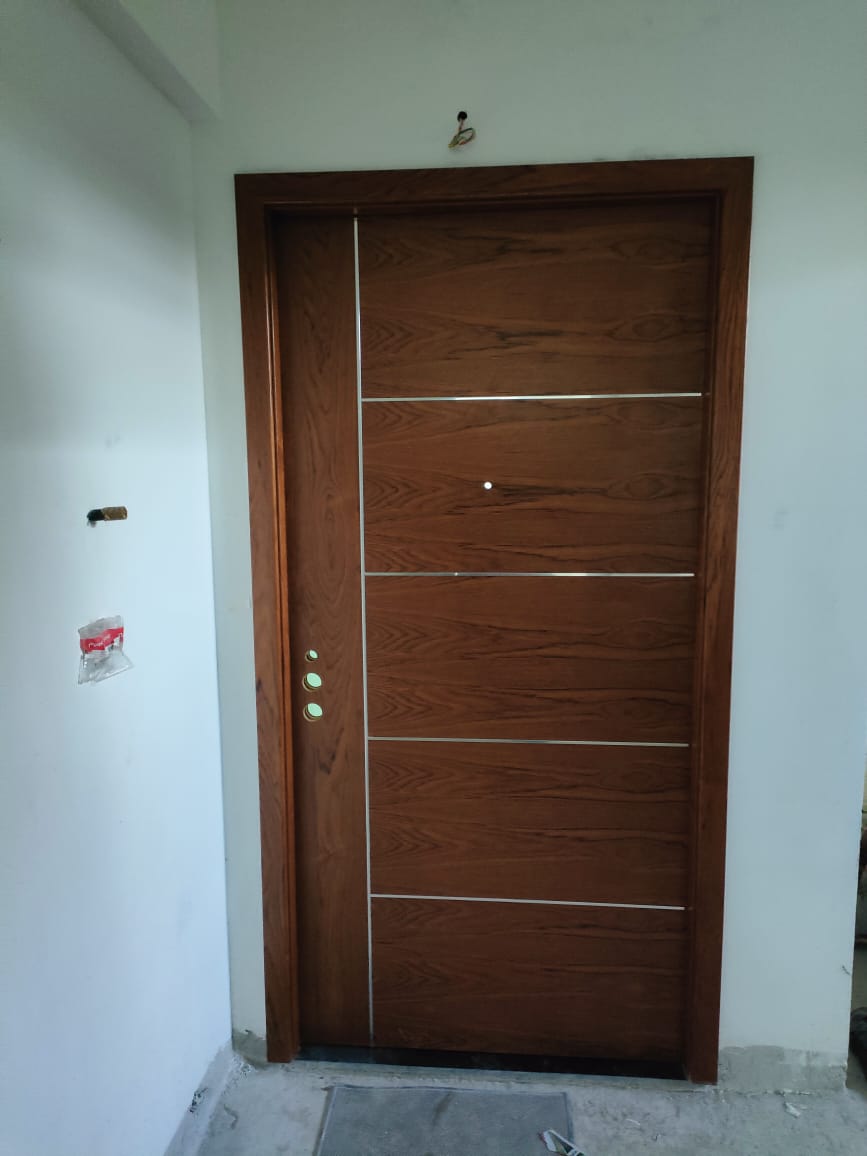

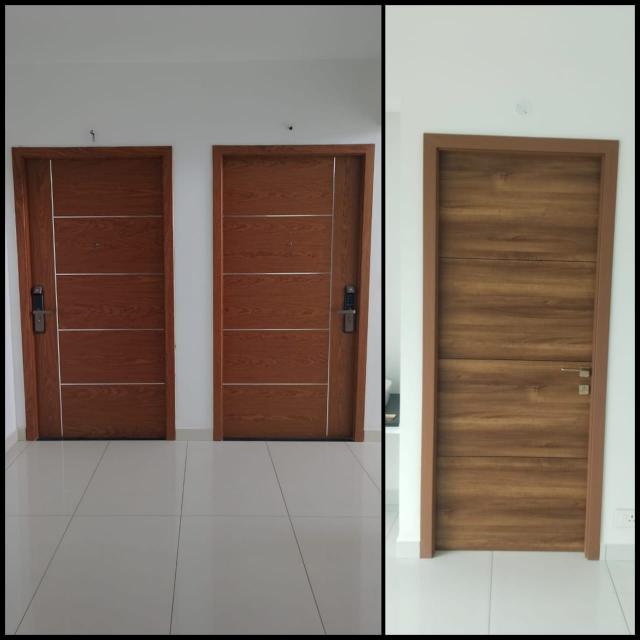

- PREHUNG DOOR FIXING – MOCKUP APT (1D & 1E) COMPLETED

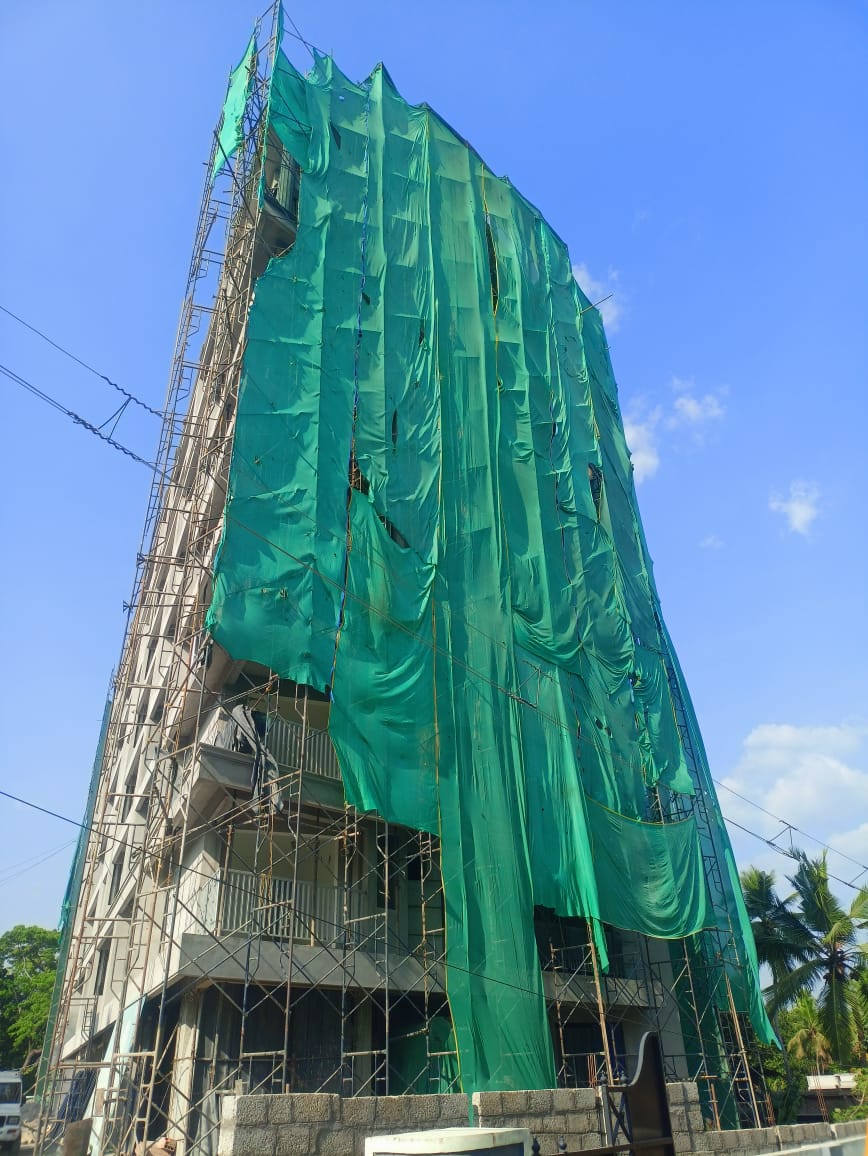

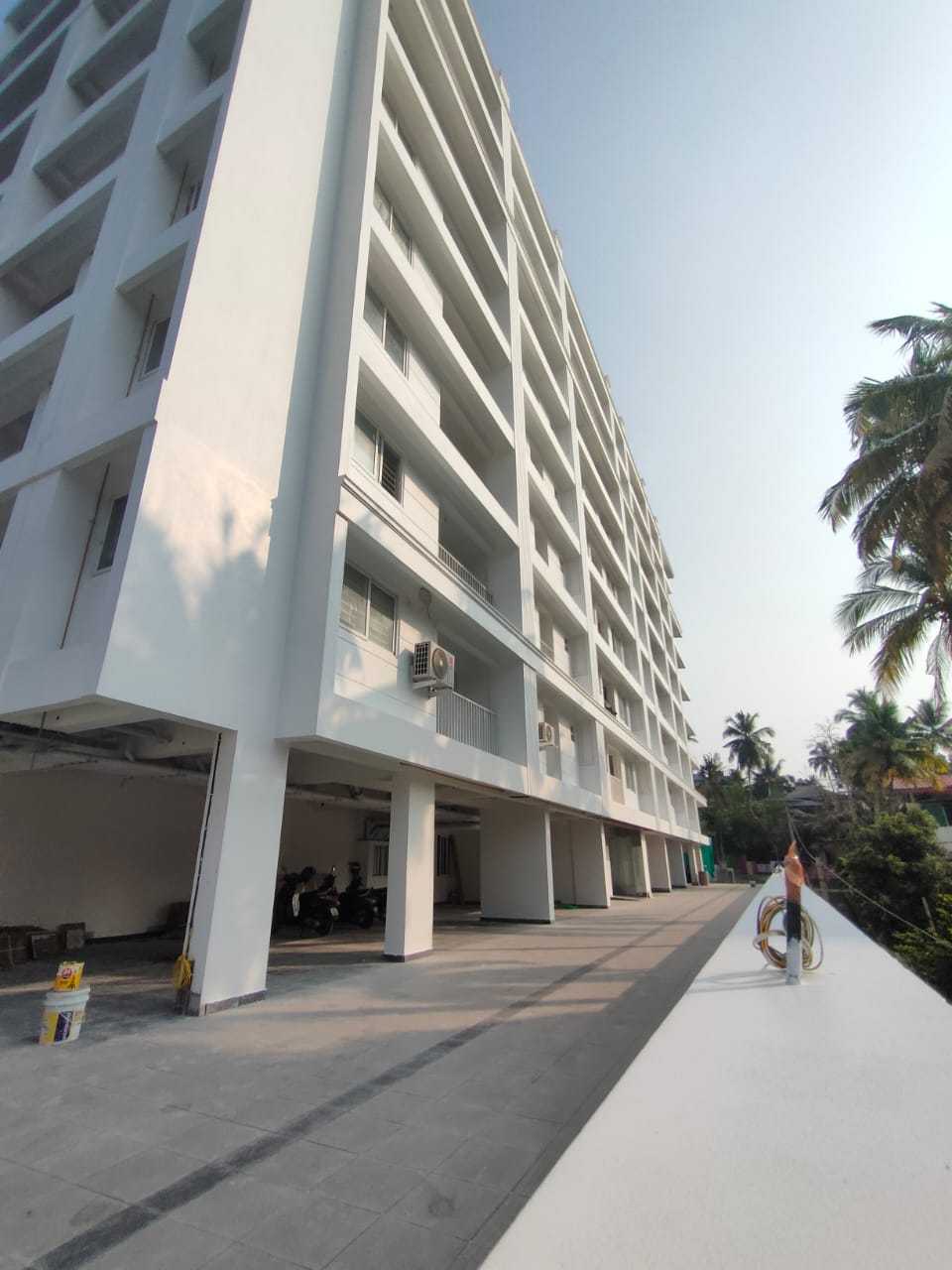

- EXTERNAL WALL PLASTERING – 60% COMPLETED

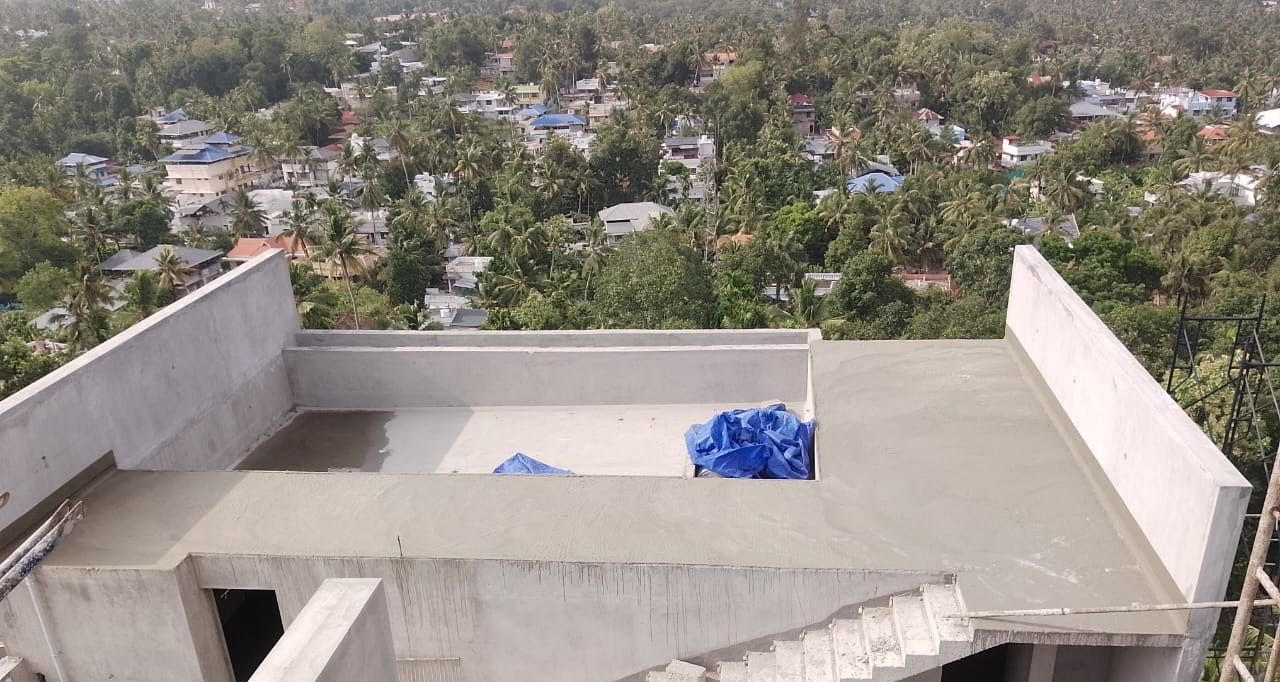

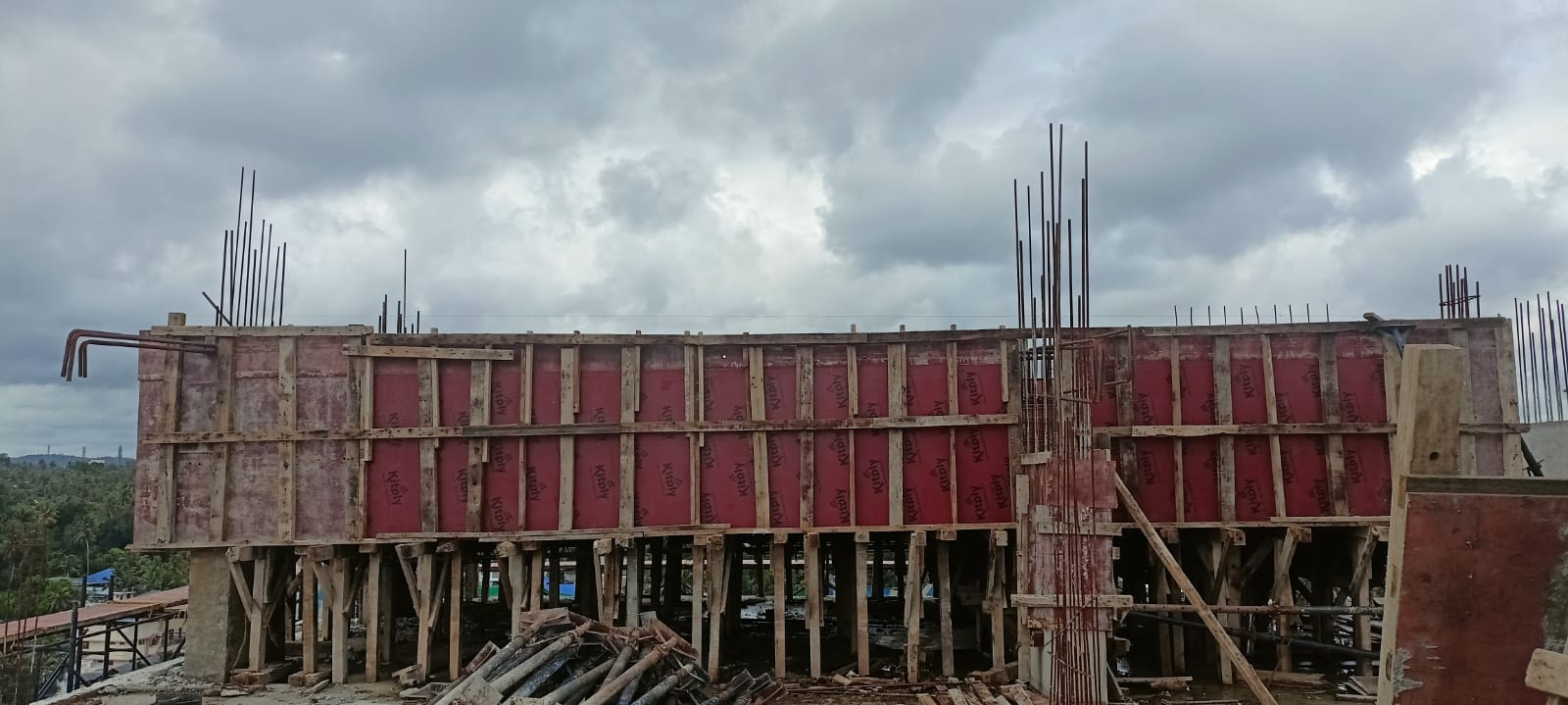

- SWIMMING POOL STRUCTURE – 100% COMPLETED
- OHT STRUCTURE WORK – 100% COMPLETED
- UG SUMP STRUCTURE WORK – 100% COMPLETED
PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 24.11.2023
- RCC FOR TERRACE FLOOR – 100% COMPLETED
- CEILING PLASTERING – 39 APT OUT 39 COMPLETED
- BLOCK MASONRY – 39 APT OUT OF 39 COMPLETED

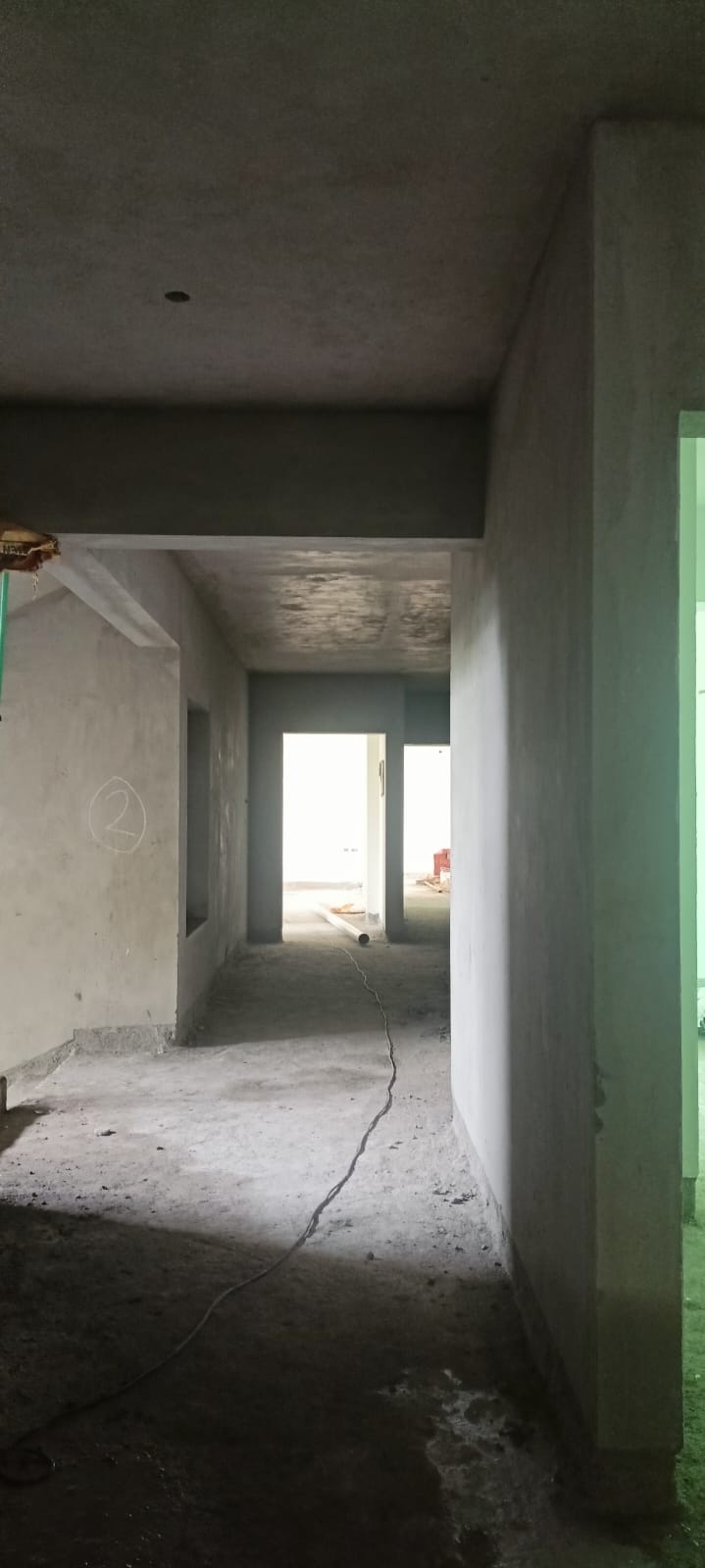

- INSIDE WALL PLASTERING – 34 APT OUT OF 39 COMPLETED
- INTERNAL PLUMBING WORK – 15 APT OUT OF 39 COMPLETED
- APT INTERNAL WATERPROOFING–15 APT OUT OF 39 COMPLETED
- BALCONY HANDRAIL FIXING – 33 APT OUT OF 39 COMPLETED
- ELECTRICAL WALL CHASING AND CONDUITING – 35 APT COMPLETED
- WALL TILING WORK – 3 APT OUT OF 39 COMPLETED
- FLOOR TILING WORK – 2 APT OUT OF 39 COMPLETED
- WALL PUTTY WORK – 9 APT OUT OF 39 COMPLETED
- WALL PRIMER -2 APT OUT OF 39 COMPLETED
- UPVC WINDOW & DOOR FIXING – 2 APT OUT OF 39 COMPLETED
- ELECTRICAL WIRING – 2 APT OUT OF 39 COMPLETED
- PREHUNG DOOR FIXING – MOCKUP APT (1D & 1E) COMPLETED
- EXTERNAL WALL PLASTERING –45% COMPLETED
- SWIMMING POOL STRUCTURE–100% COMPLETED
- OHT STRUCTURE-100% COMPLETED
- UG SUMP STRUCTURE-100% COMPLETED

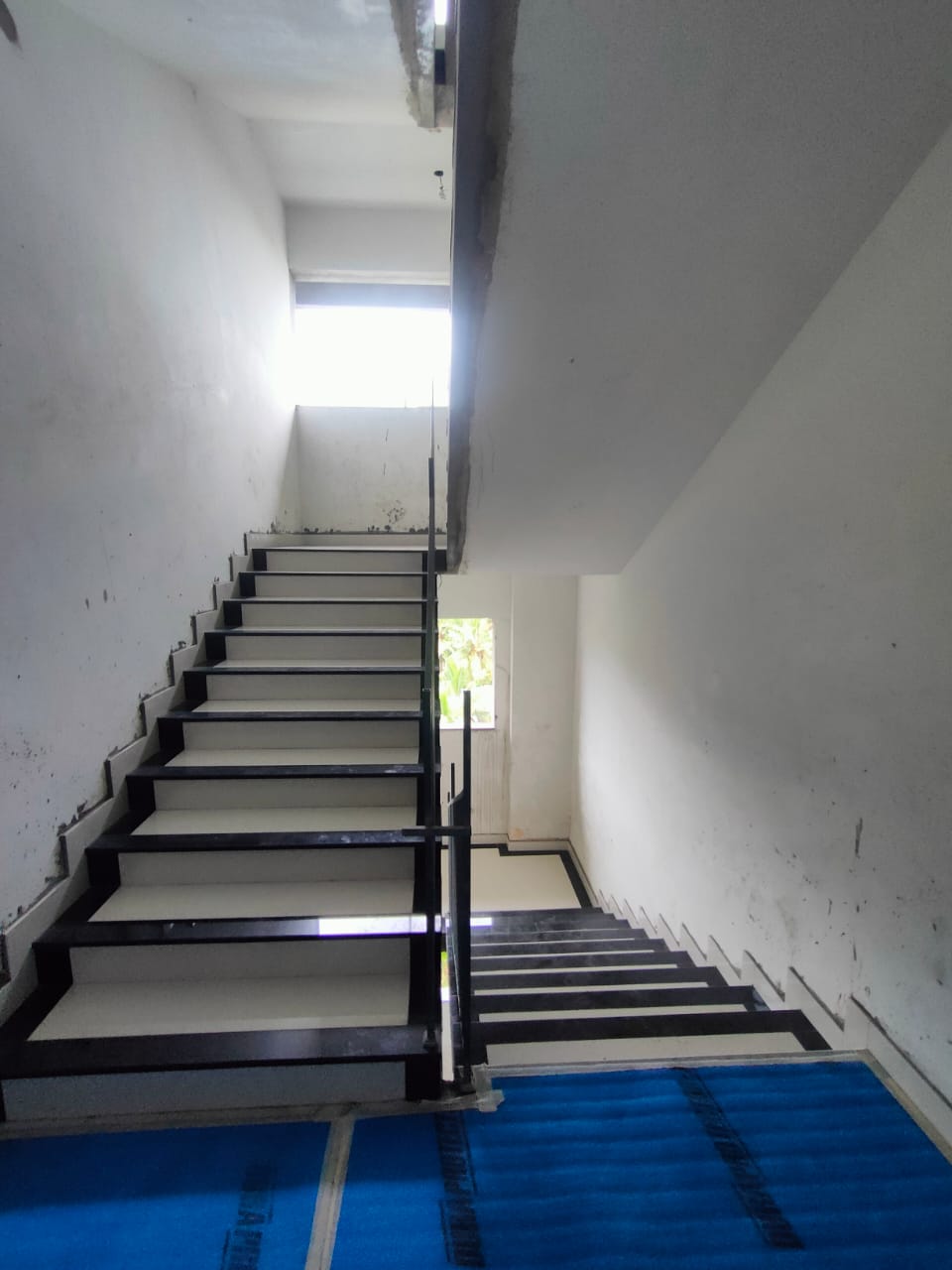

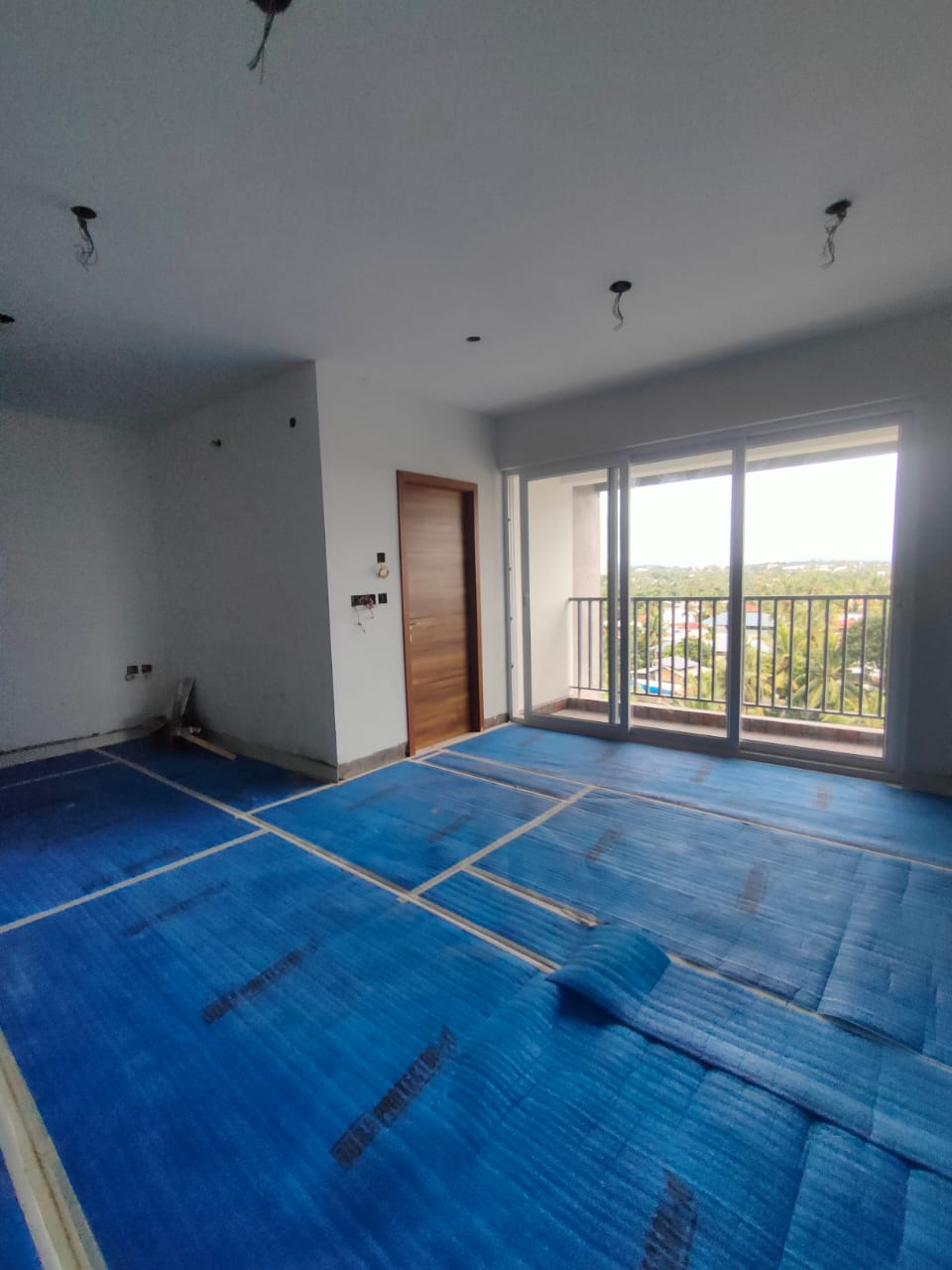

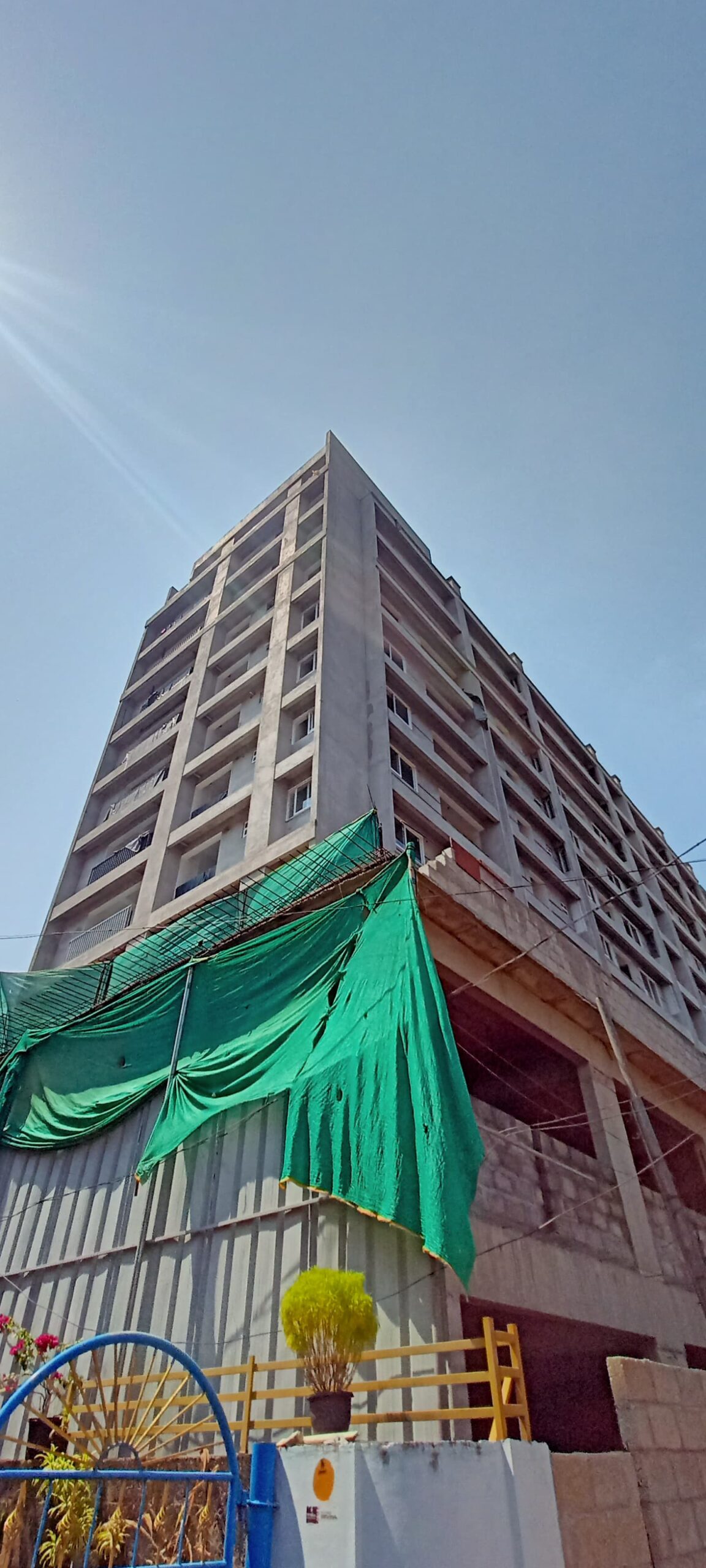

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 25.09.2023
- RCC FOR TERRACE FLOOR – 100% COMPLETED
- CEILING PLASTERING – 38 APT OUT 39 COMPLETED

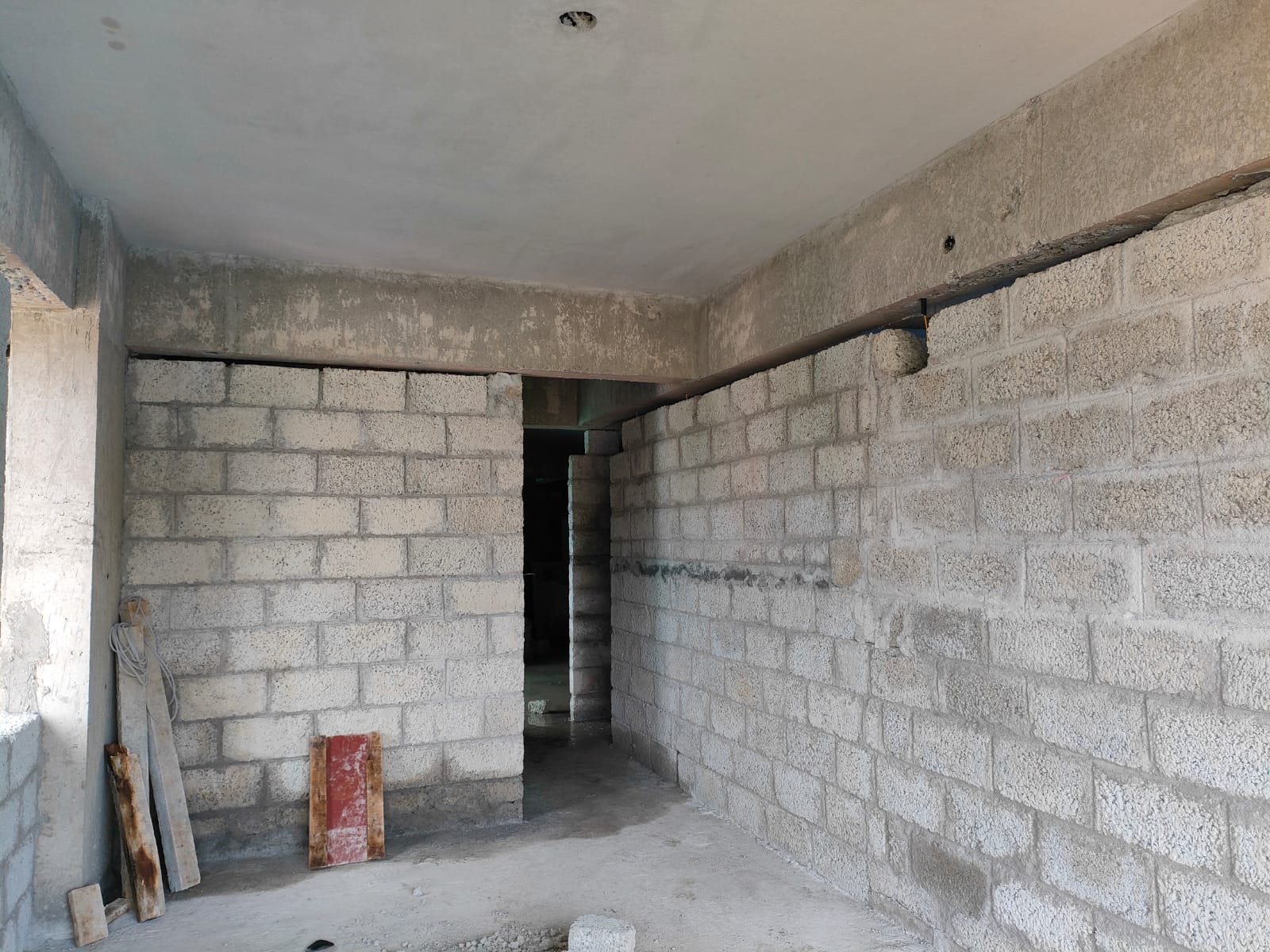

- FBLOCK MASONRY – 32 APT OUT OF 39 COMPLETED
- INSIDE WALL PLASTERING – 24 APT OUT OF 39 COMPLETED
- INTERNAL PLUMBING WORK – 10 APT OUT OF 39 COMPLETED
- BALCONY HANDRAIL FIXING – 20 APT OUT OF 39 COMPLETED
- ELECTRICAL WALL CHASING AND CONDUITING – 25 APT COMPLETED
- WALL TILING WORK – 2 APT OUT OF 39 COMPLETED
- FLOOR TILING WORK – 2 APT OUT OF 39 COMPLETED
- WALL PUTTY WORK – 2 APT OUT OF 39 COMPLETED
- UPVC WINDOW & DOOR FIXING – 2 APT OUT OF 39 COMPLETED
- ELECTRICAL WIRING – 2 APT OUT OF 39 COMPLETED
- PRIMER WORK – MOCK UP APT (1D) COMPETED
- PREHUNG DOOR FIXING – MOCKUP APT (1D) COMPLETED
- STANDARD FINISH APARTMENT (1E) – IN PROGRESS
- EXTERNAL WALL PLASTERING -10% COMPLETED
- SWIMMING POOL & OHT STRUCTURE WORK IN PROGRESS
- PREHUNG DOOR FIXING – MOCKUP APT (1D) COMPLETED
- STANDARD FINISH APARTMENT (1E) – IN PROGRESS

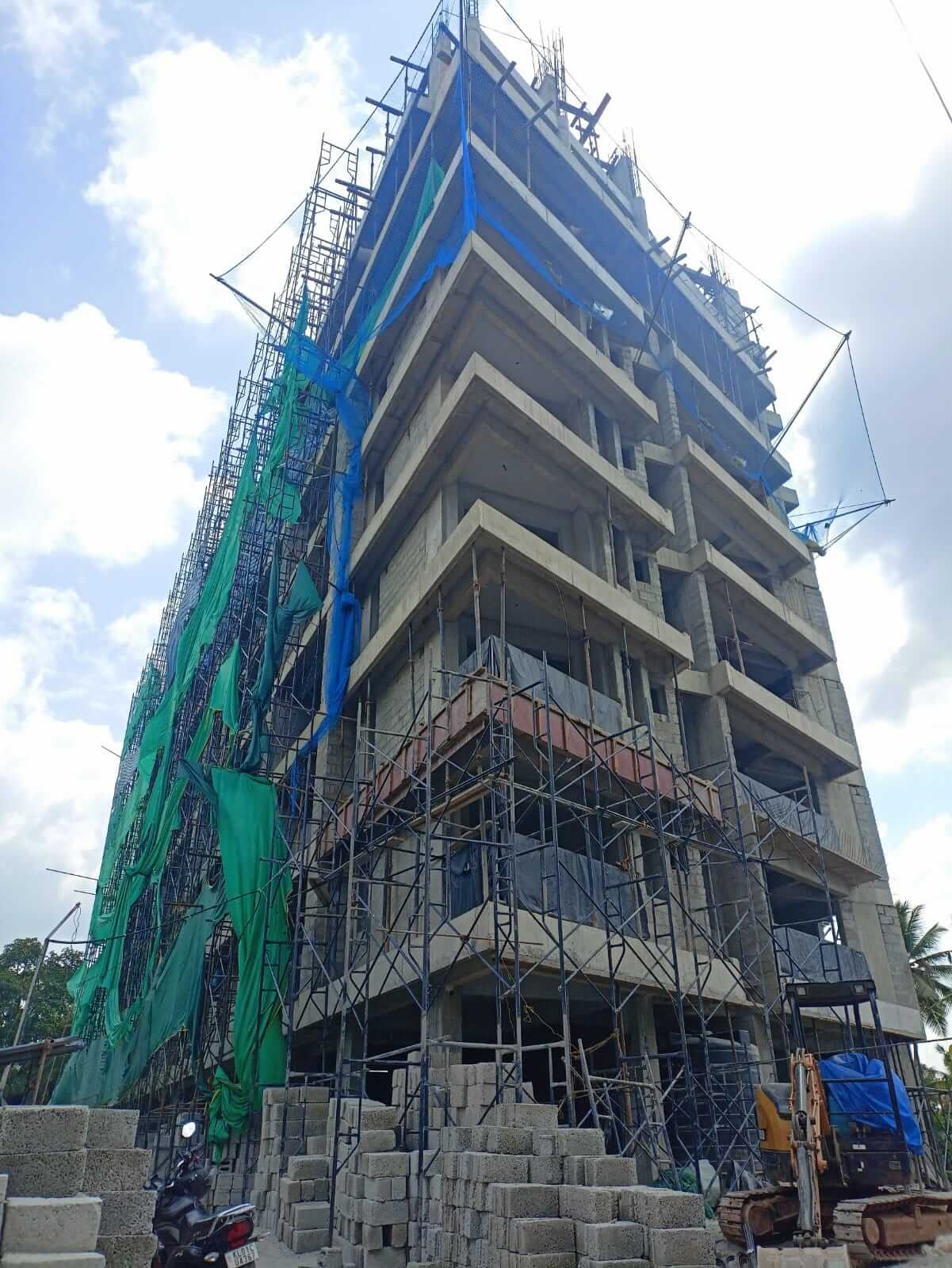

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 11.08.2023

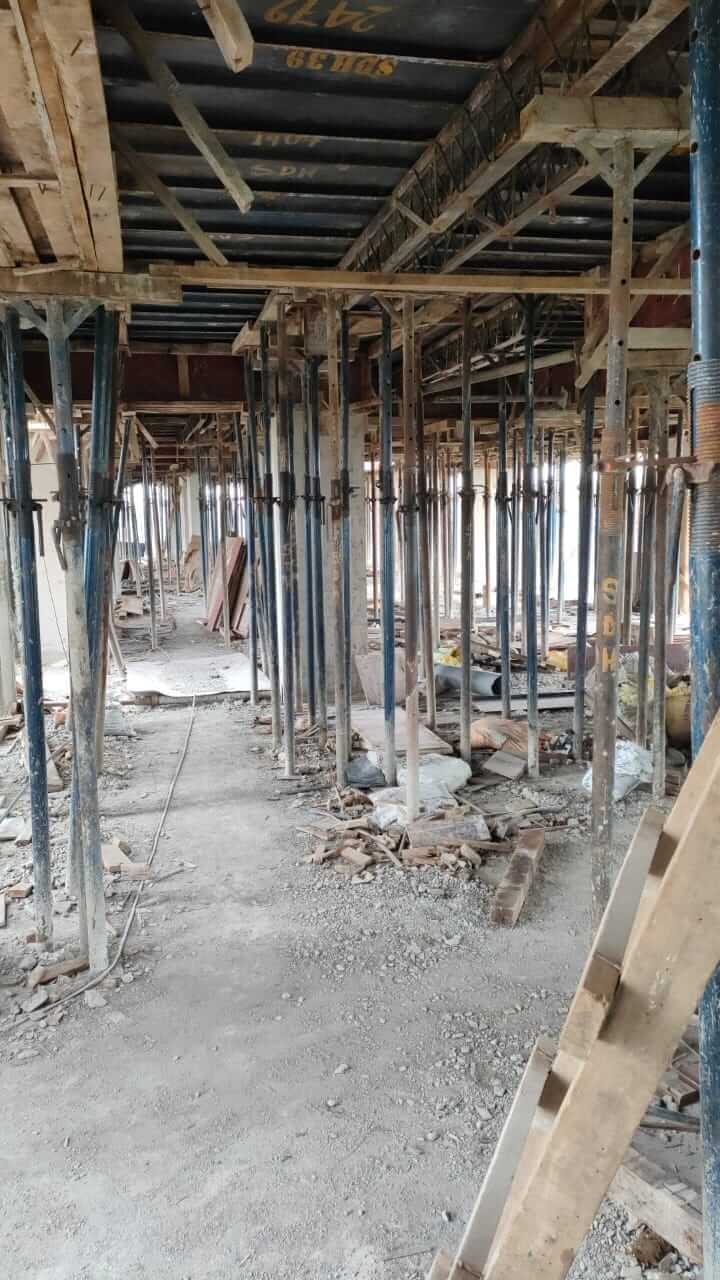

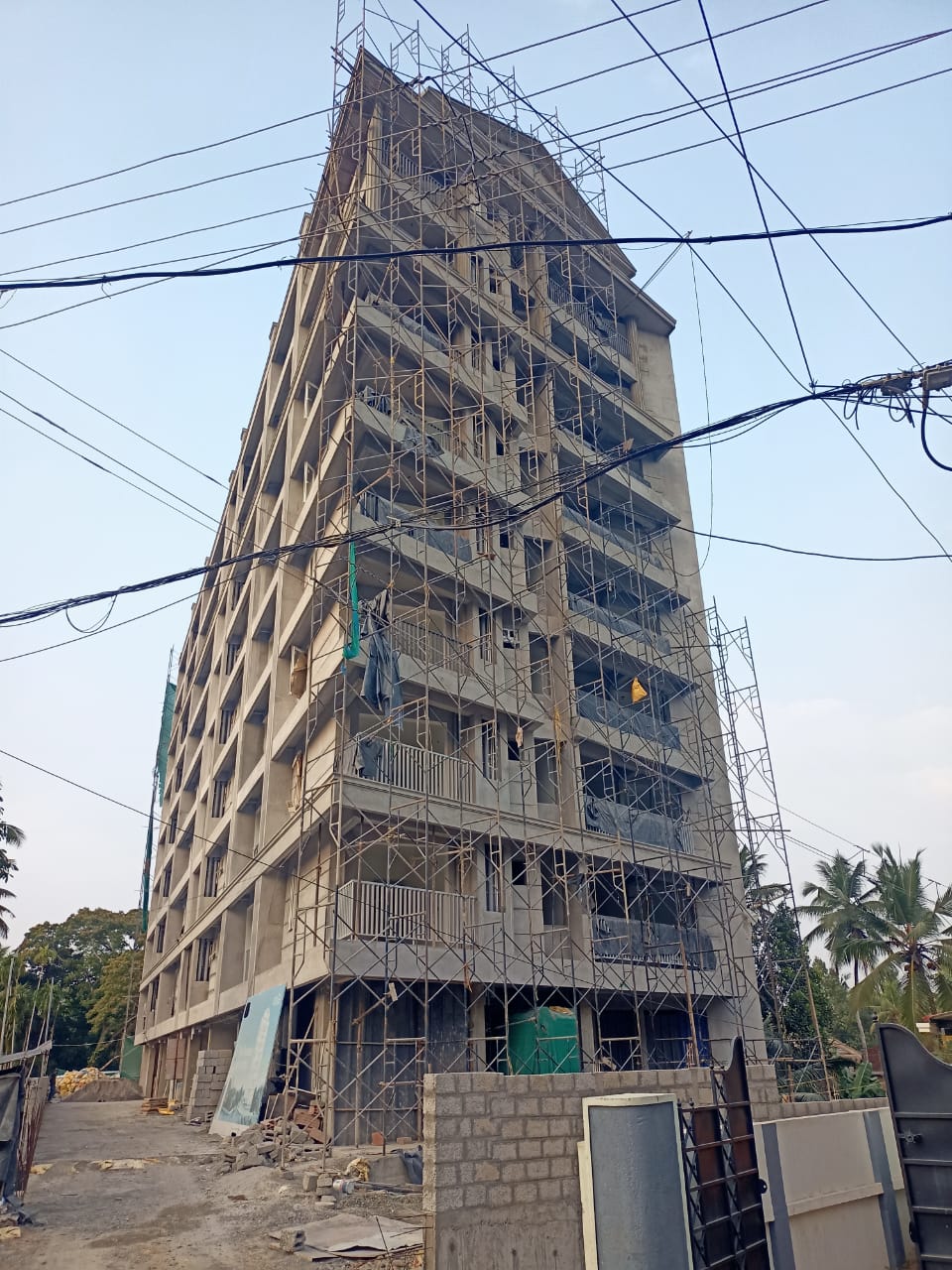

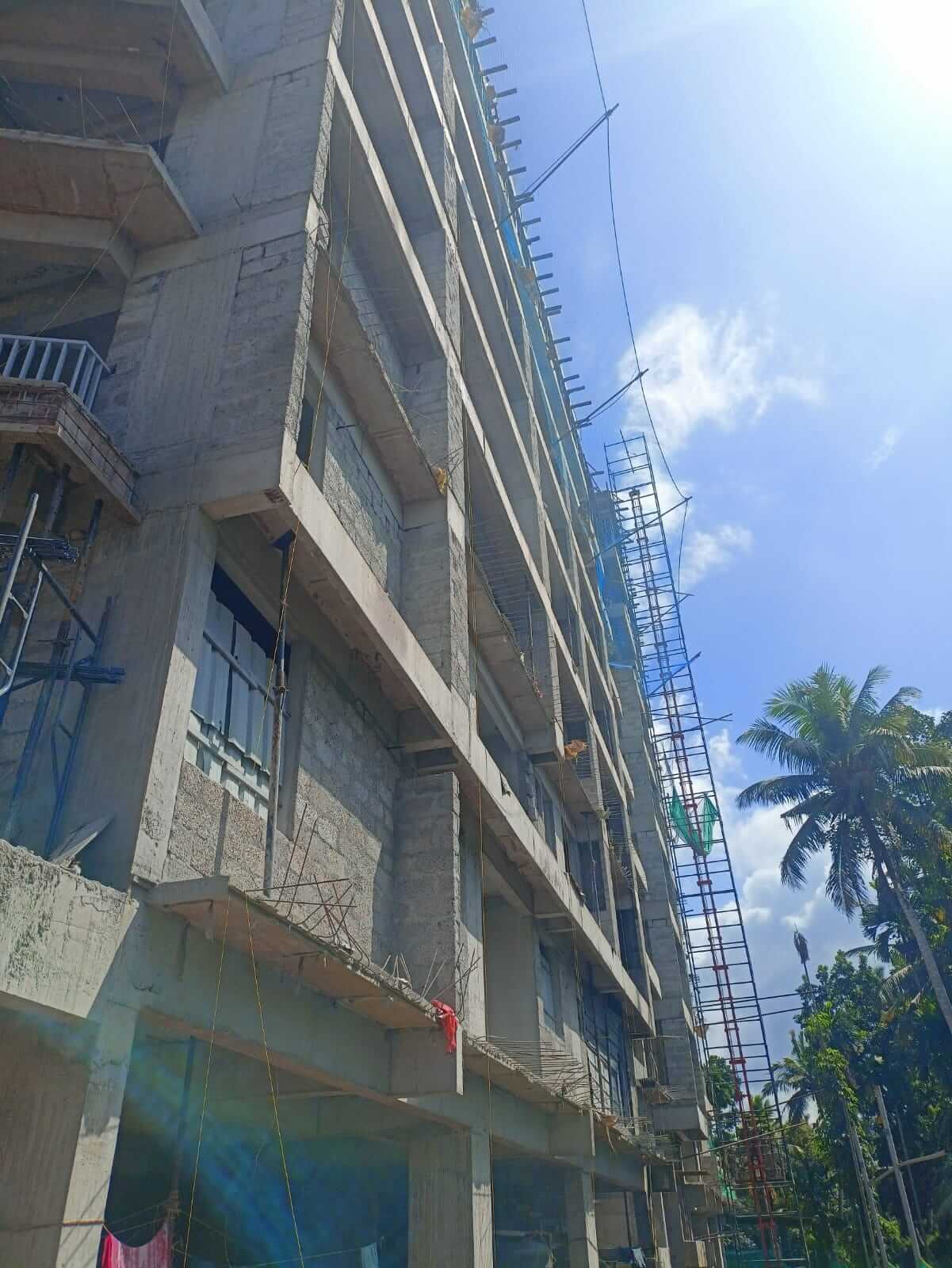

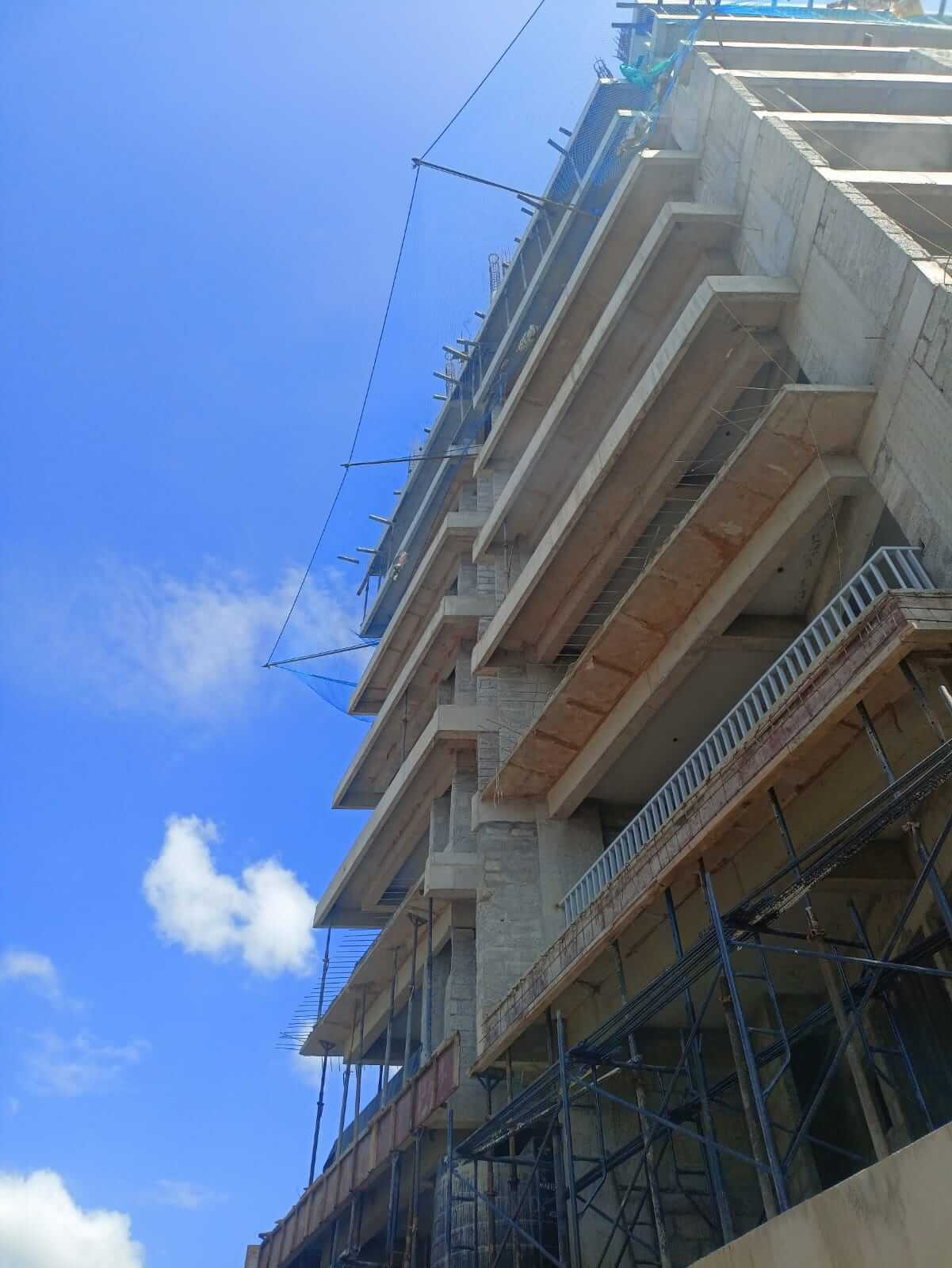

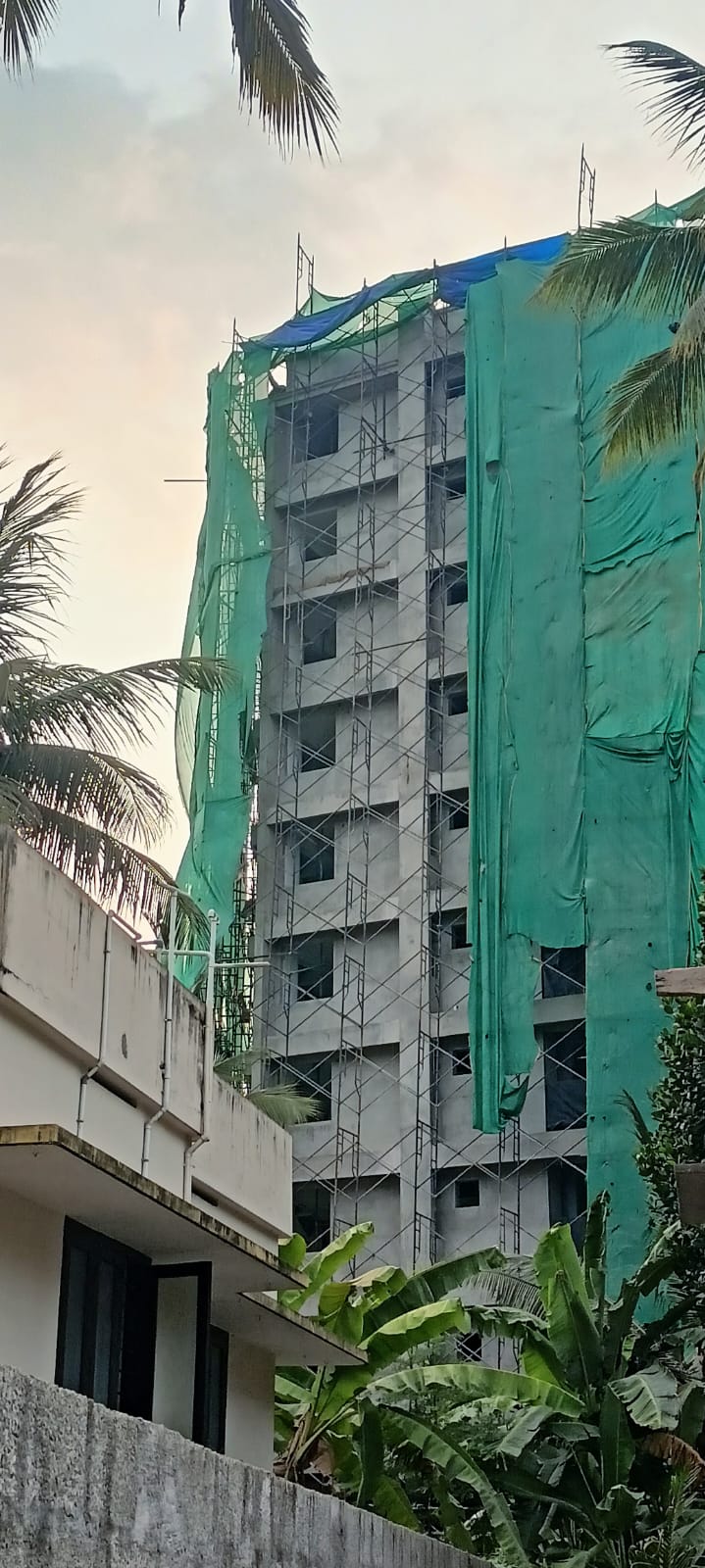

- RCC FOR 8TH FLOOR SLAB – 100% COMPLETED
- RCC FOR COLUMN (8TH TO TERRACE) – 100% COMPLETED

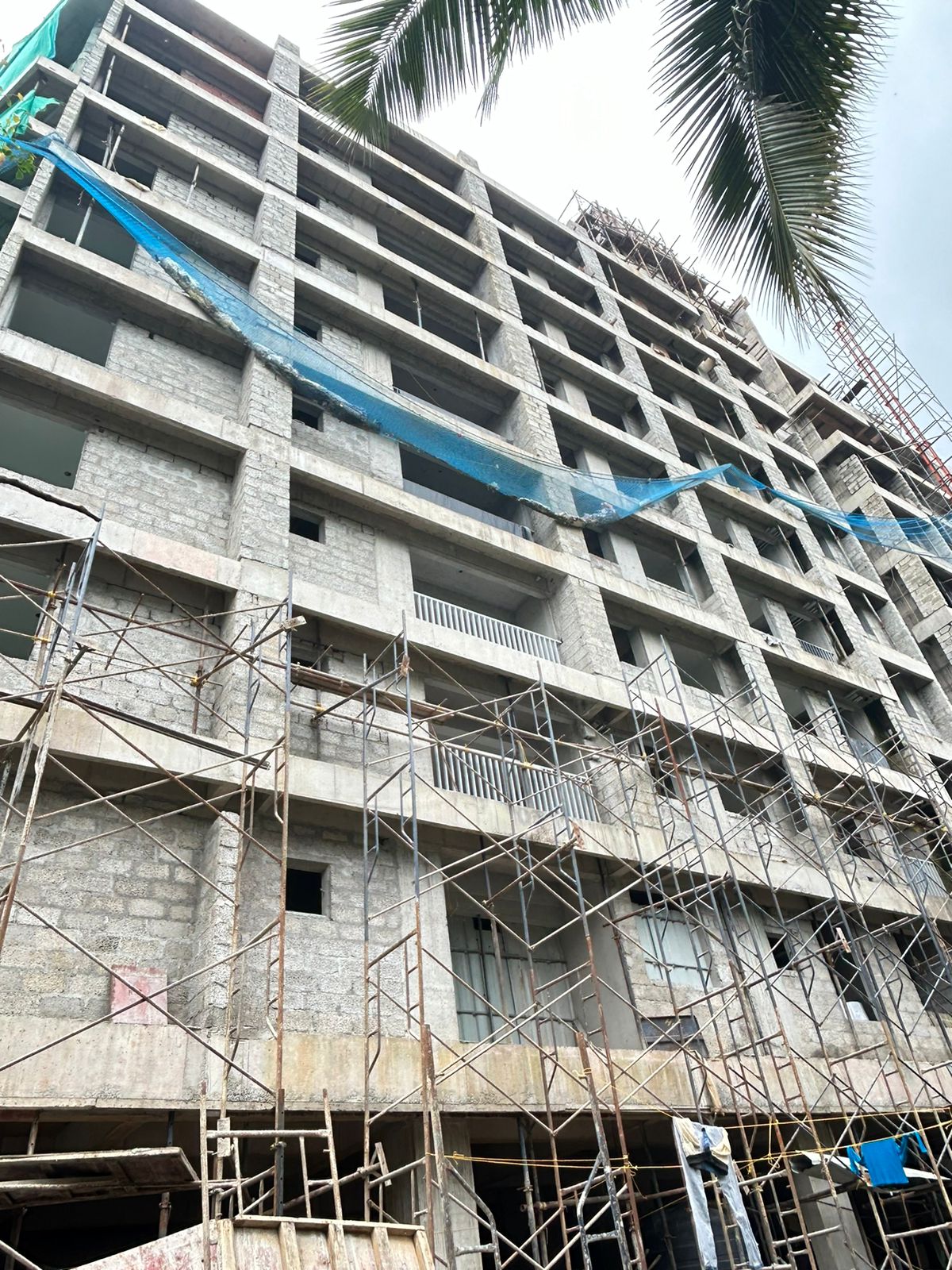

- FORMWORK FOR TERRACE – 95% COMPLETED

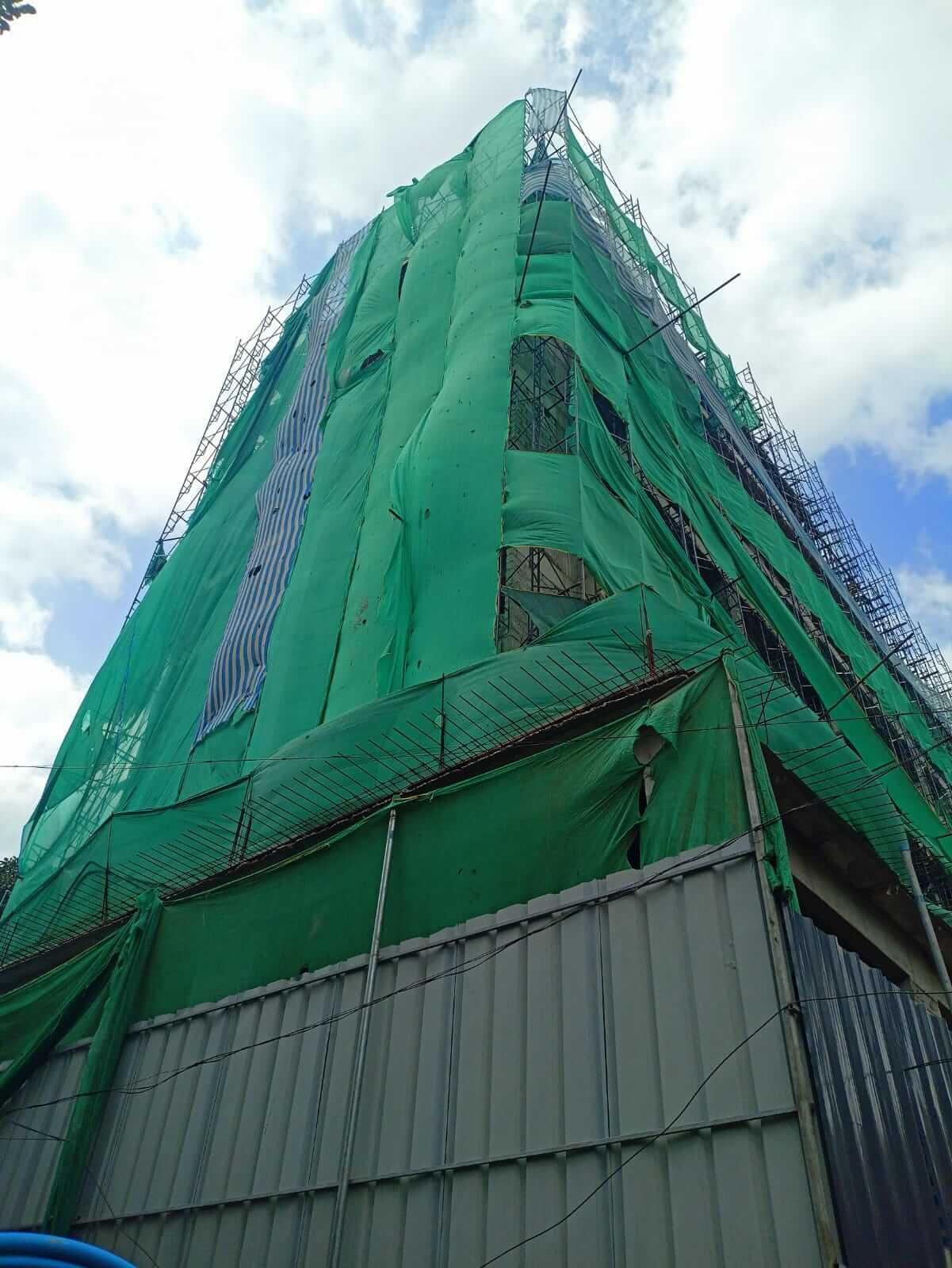

- STEELWORK FOR TERRACE FLOOR SLAB – 50% COMPLETED
- RCC FOR TERRACE FLOOR – 50% COMPLETED

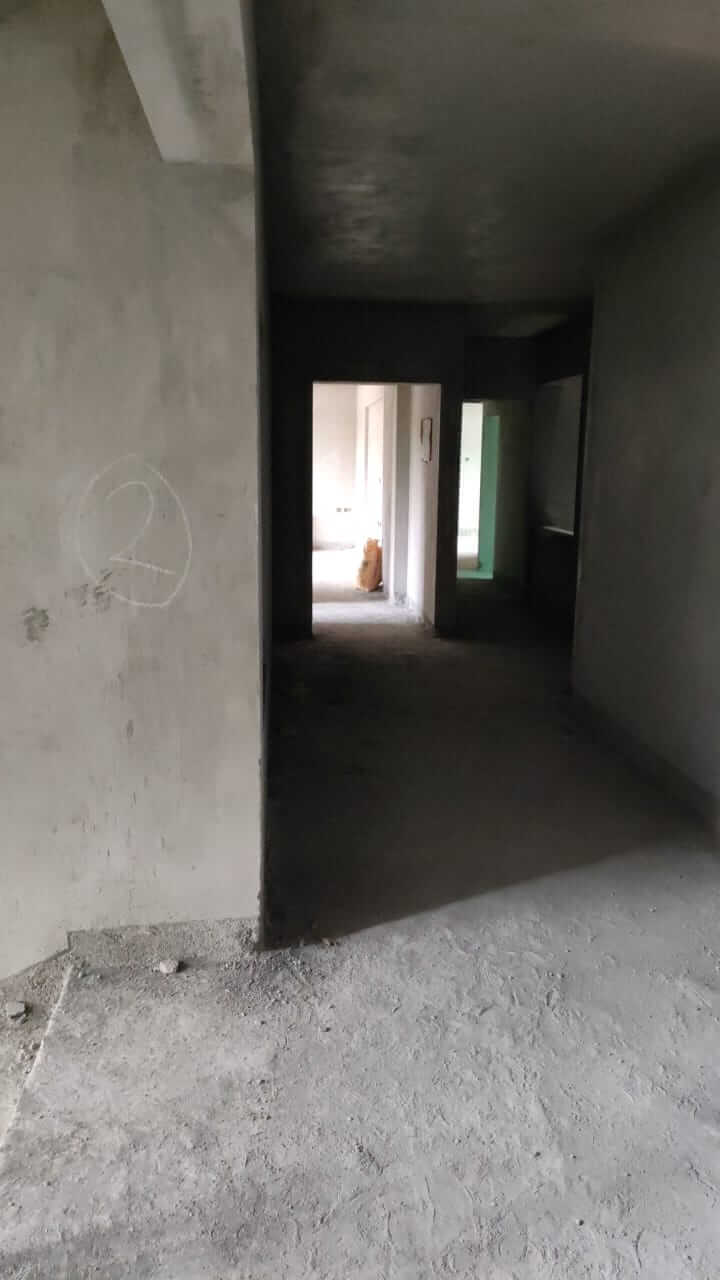

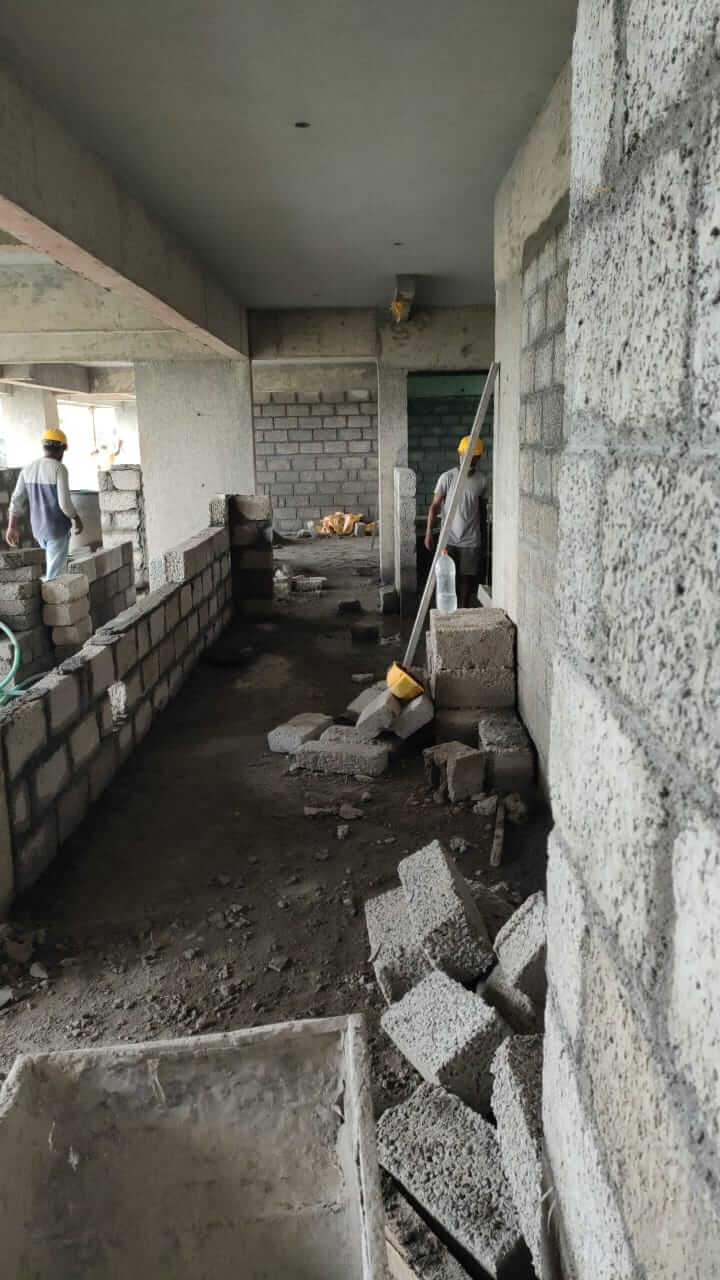

- CEILING PLASTERING – 32 APT OUT 39 COMPLETED
- BLOCK MASONRY – 27 APT OUT OF 39 COMPLETED
- INSIDE WALL PLASTERING – 13 APT OUT OF 39 COMPLETED
- INTERNAL PLUMBING WORK – 7 APT OUT OF 39 COMPLETED
- BALCONY HANDRAIL FIXING – 10 APT OUT OF 39 COMPLETED
- ELECTRICAL WALL CHASING AND CONDUITING – 6 APT COMPLETED
- WALL TILING WORK – 1 APT OUT OF 39 COMPLETED
- FLOOR TILING WORK – 1 APT OUT OF 39 COMPLETED
- WALL PUTTY WORK – 2 APT OUT OF 39 COMPLETED
- UPVC WINDOW & DOOR FIXING – 1 APT OUT OF 39 COMPLETED
- ELECTRICAL WIRING – 1 APT OUT OF 39 COMPLETED
- PRIMER WORK – MOCK UP APT (1D) COMPETED
- PREHUNG DOOR FIXING – MOCKUP APT (1D) COMPLETED
- STANDARD FINISH APARTMENT (1E) – IN PROGRESS

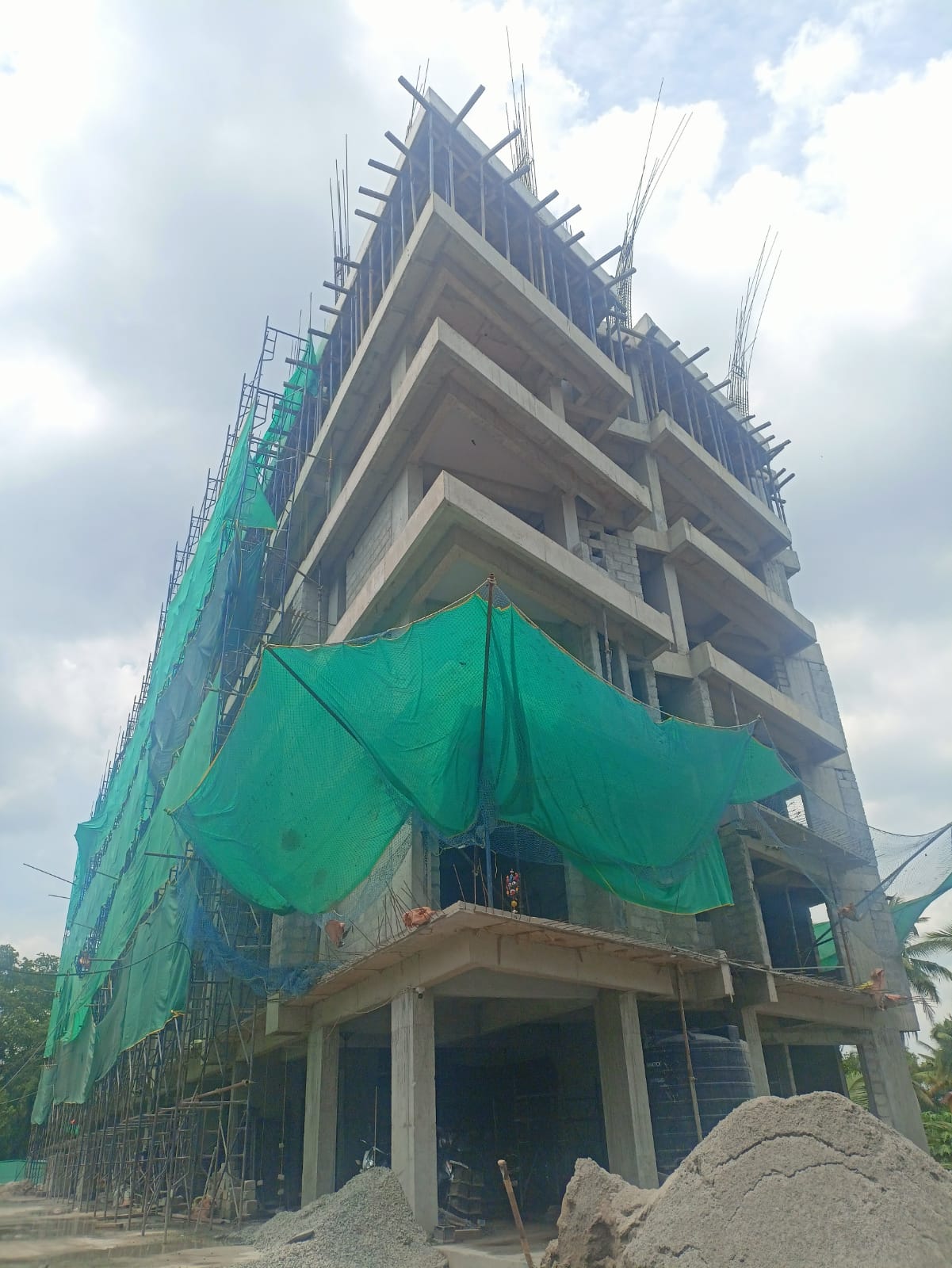

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 14.06.2023

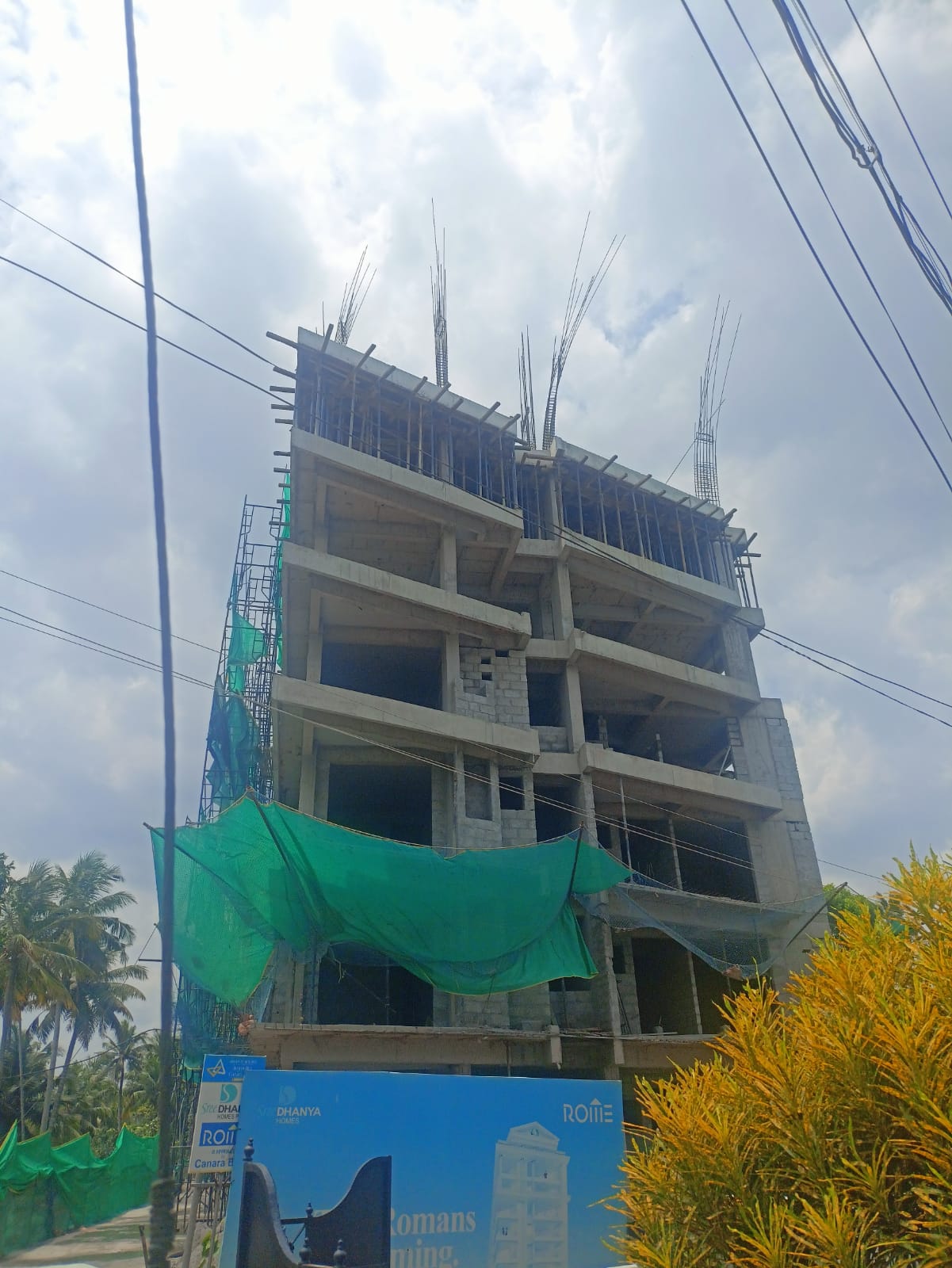

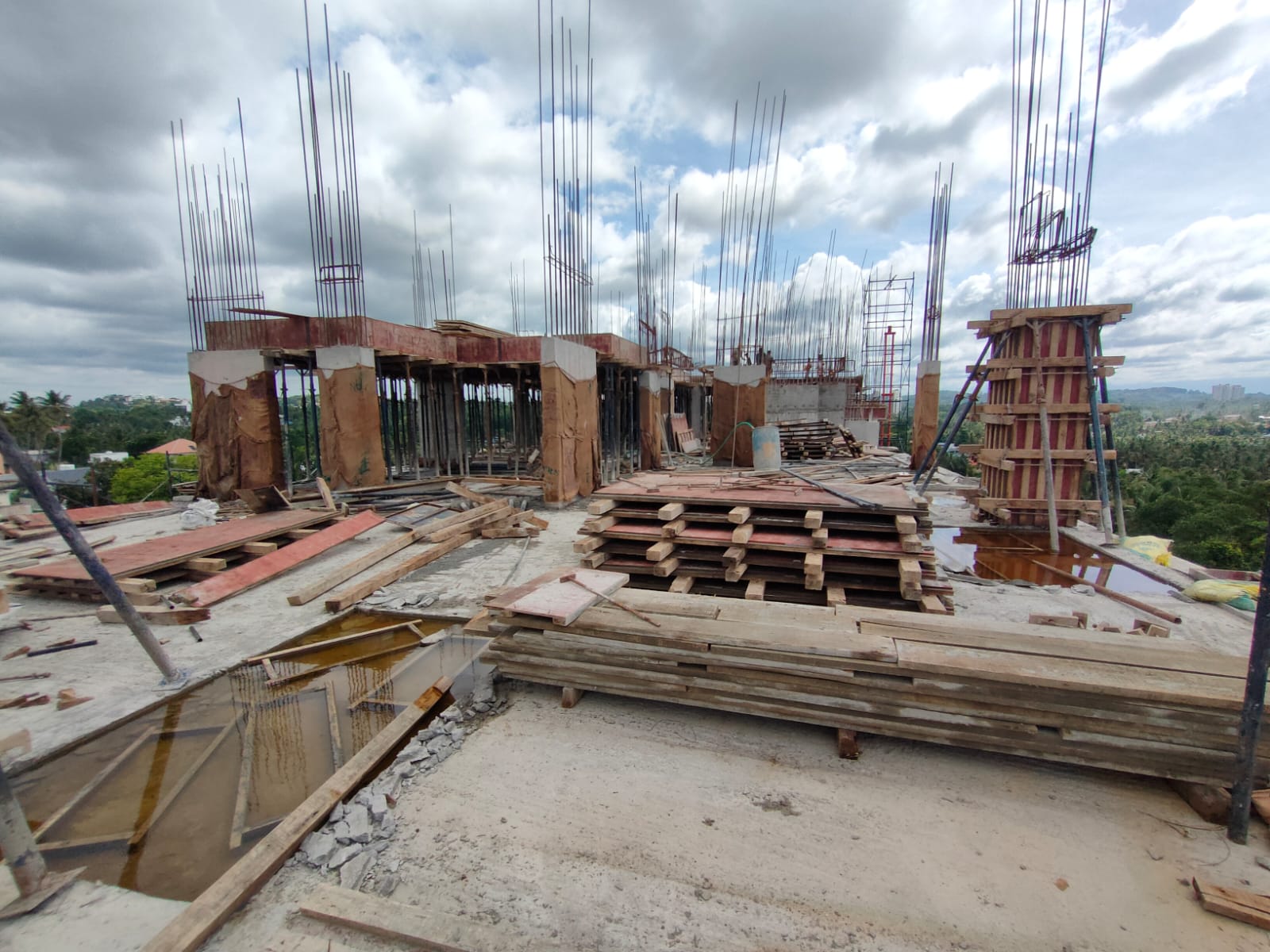

- RCC FOR 7TH FLOOR SLAB – 100% COMPLETED
- RCC FOR COLUMN (7TH TO 8TH) – 30 NOS OUT OF 35 NOS COMPLETED

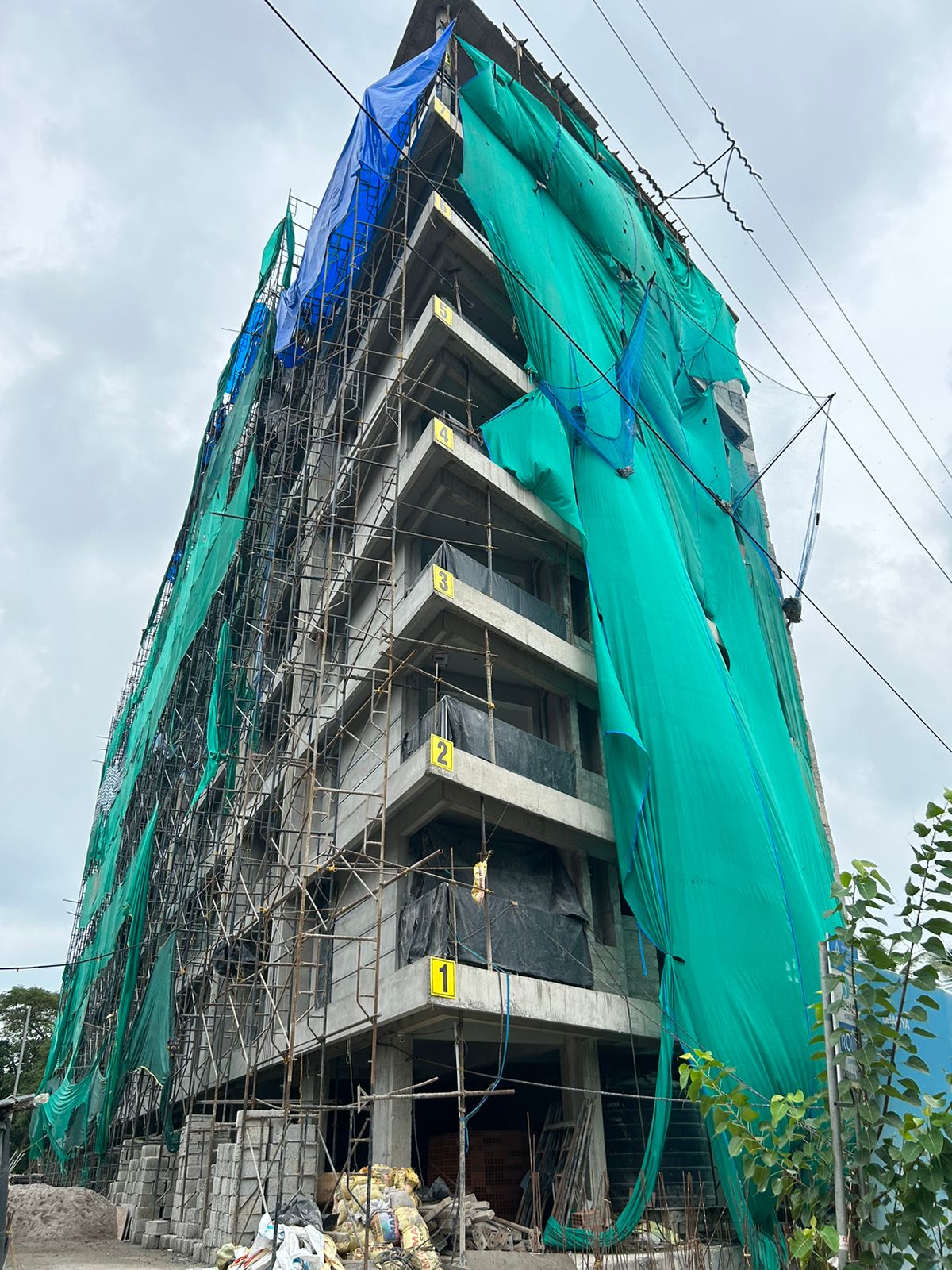

- FORMWORK FOR 8TH FLOOR SLAB – 45% COMPLETED
- STEEL WORK FOR 8TH FLOOR SLAB – 40% COMPLETED

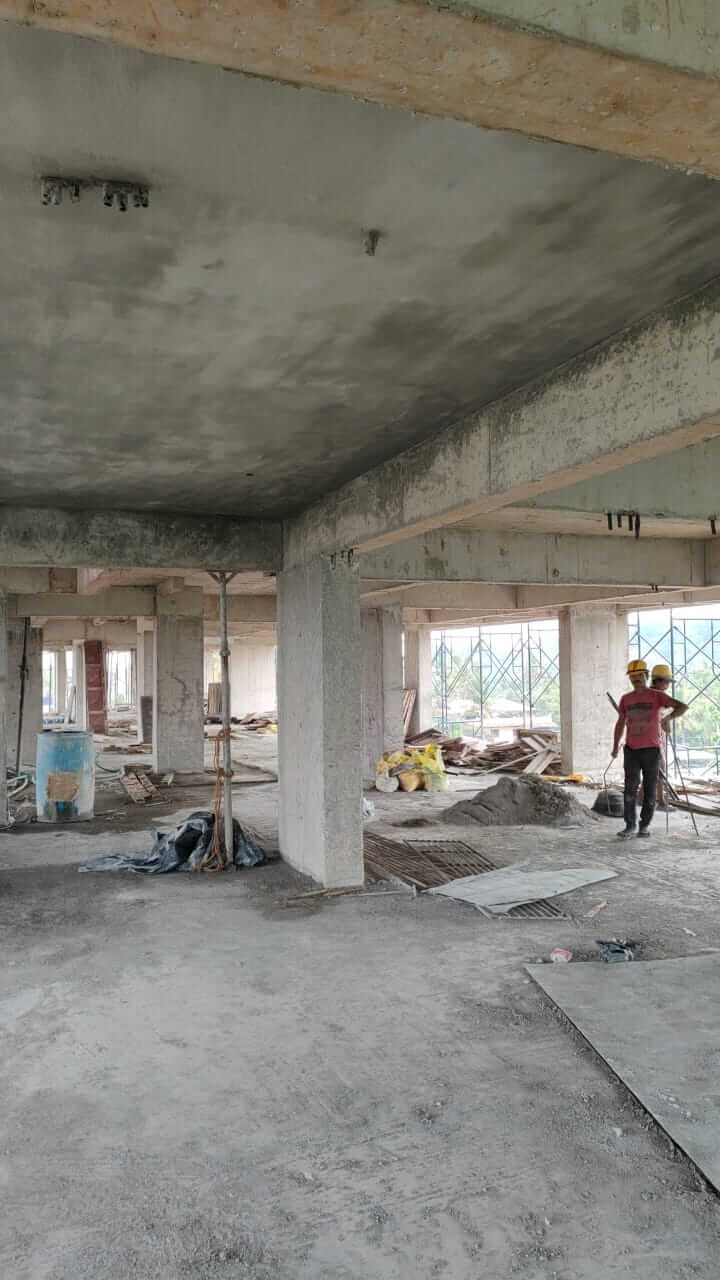

- CEILING PLASTERING – 25 APT OUT 39 COMPLETED
- BLOCK MASONRY – 20 APT OUT OF 39 COMPLETED
- INSIDE WALL PLASTERING – 6 APT OUT OF 39 COMPLETED
- INTERNAL PLUMBING WORK – 1 APT OUT OF 39 COMPLETED

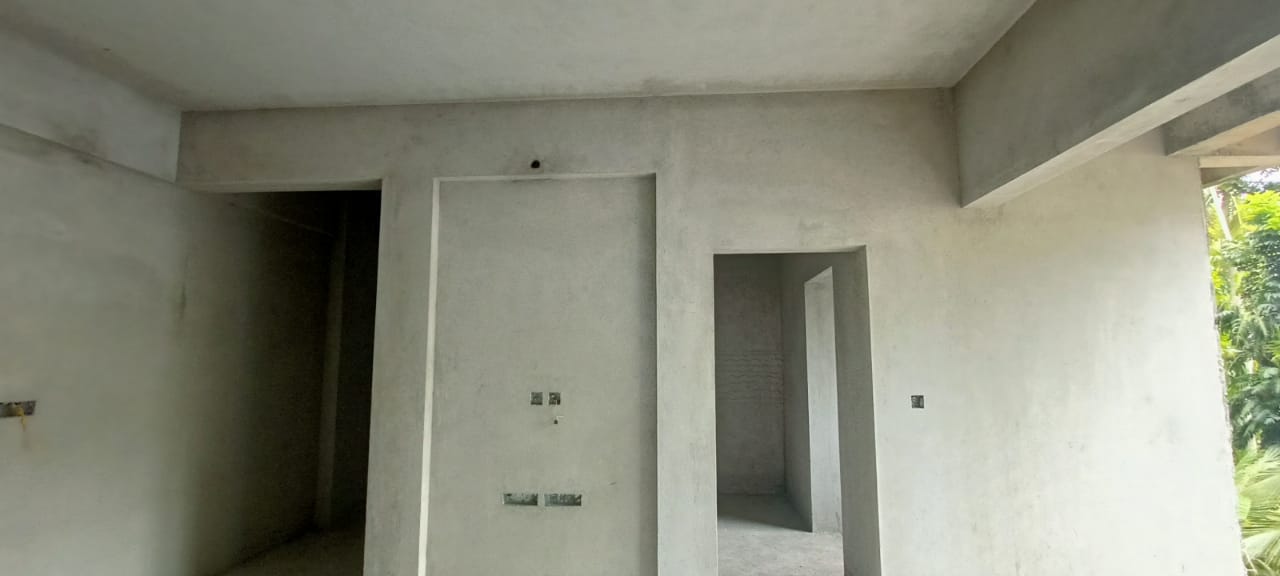

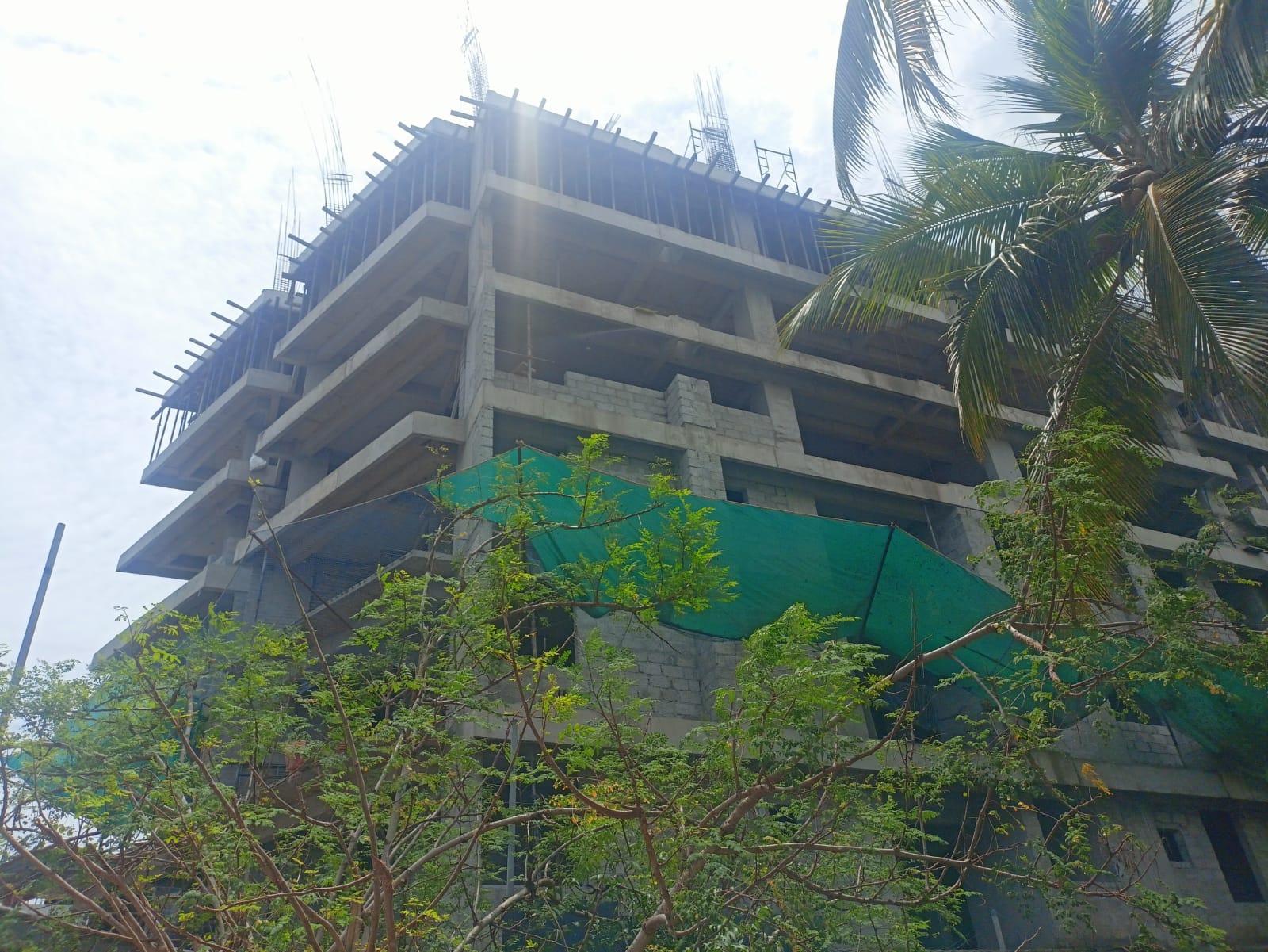

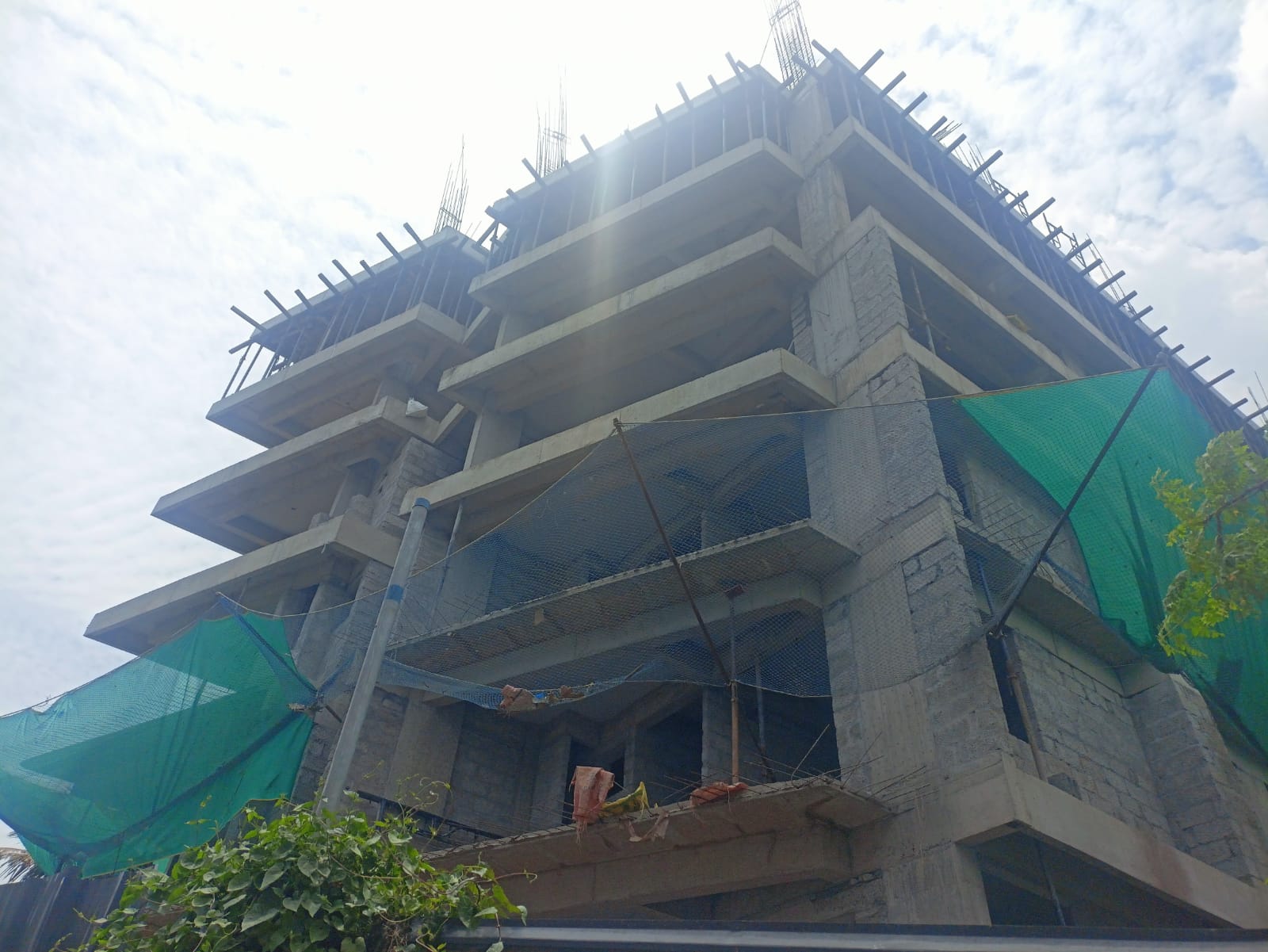

PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 06.05.2023
- RCC FOR 6TH FLOOR SLAB – 100% COMPLETED

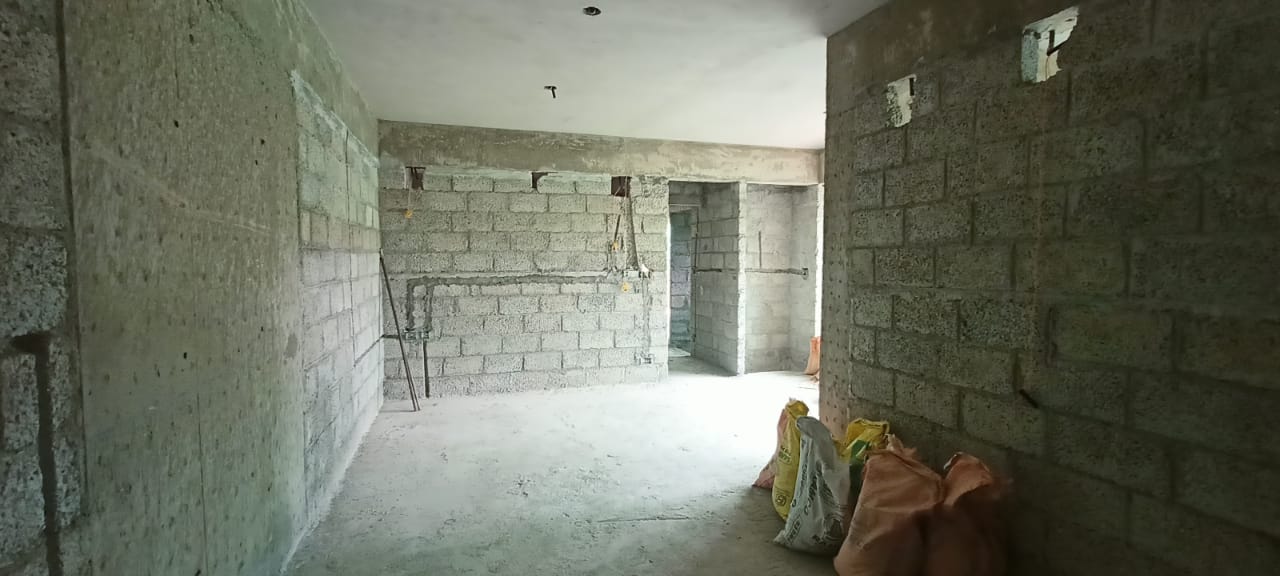

- RCC FOR COLUMN (6TH TO 7TH) – 12 OUT OF 35 APARTMENTS COMPLETED
- FORMWORK FOR 7TH FLOOR SLAB – 30% COMPLETED
- CEILING PLASTERING – 18 OUT 39 APARTMENTS COMPLETED
- BLOCK MASONRY – 12 OUT OF 39 APARTMENTS COMPLETED
- INSIDE WALL PLASTERING – 1 OUT OF 39 APARTMENTS COMPLETED
PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS OF 18.03.2023
- RCC FOR 3RD FLOOR ROOF – 100% COMPLETED
- RCC FOR COLUMN – 4TH TO 5TH – 32 OUT OF 35 NOS COMPLETED
- FORMWORK FOR 4TH FLOOR ROOF – 50% COMPLETED
- STEEL WORK FOR 2ND FLOOR ROOF – 40% COMPLETED
- CEILING PLASTERING (GROUND FLOOR) – 50% COMPLETED
- CEILING PLASTERING (FIRST FLOOR) – 100% COMPLETED
- BLOCK MASONRY (GROUND FLOOR APT) – 100% COMPLETED
- BLOCK MASONRY (FIRST FLOOR) – 40% COMPLETED
PROJECT STATUS REPORT OF ROME BY SREEDHANYA AS ON 02.02.2023
- RCC FOR FIRST FLOOR ROOF – 100% COMPLETED
- RCC FOR COLUMN (FIRST FLOOR TO SECOND FLOOR) – 35 OUT OF 35 NOS COMPLETED
- FORM WORK FOR 2ND FLOOR ROOF – 90% COMPLETED
- STEEL WORK FOR 2ND FLOOR ROOF – 60% COMPLETED
- RCC FOR 2ND FLOOR ROOF – 50% COMPLETED
PROJECT STATUS REPORT OF ROME BY SREEDHANYA, AS ON 20.12.2022
- RCC FOR COLUMN (BASEMENT – 2) – 48 NOS OUT OF 48 NOS COMPLETED
- RCC FOR BASEMENT – 2 ROOF -100% COMPLETED
- RCC FOR BASEMENT 1 ROOF – 100% COMPLETED
- RCC FOR GROUND FLOOR ROOF -100% COMPLETED
- RCC FOR COLUMN (FF TO SF) – 33NOS OUT OF 35 NOS COMPLETED
- FORMWORK FOR FIRST FLOOR ROOF – 50% COMPLETED
- STEEL WORK FOR FIRST FLOOR ROOF -10% COMPLETED
