PINK

Pink

BY SREEDHANYA HOMES

ESSENCE OF WOMEN EMPOWERMENT

2,3&4 BHK APARTMENTS – NH BYPASS NEAR LULU MALL

Pink – Thiruvananthapuram’s first ever exclusive 2, 3 & 4 BHK premium apartment, stands tall as a monument of women empowerment and their creative contributions in almost every strategic area of its construction. A class apart in living space, ushering in superior amenities including open space with greenery, outdoor sports zone and area for private farm in each apartment, Pink is conceived in 12 floors being built in 88 cents of land, allowing easy access to airport, railway station, malls, IT Park, prominent hospitals and other everyday facilities.

Being conceived with women participation in every vital area, including security, The Pink imbues the essence of women empowerment.

HIGHLIGHTS

LOCATION

Close to the city and yet away from its din, PINK is being built at Venpalavattom. Just a few minutes drive accords access to the city centre, international airport, railway station, prominent hospitals, malls, IT Park and business establishments for everyday purchases.

UNITS

12 floors of 2,3&4 BHK

AREA

88 cents

RERA CERTIFICATEQUICK ENQUIRY

  • Multi-purpose recreation hall with indoor games
  • AC gym
  • Women’s club
  • Creche

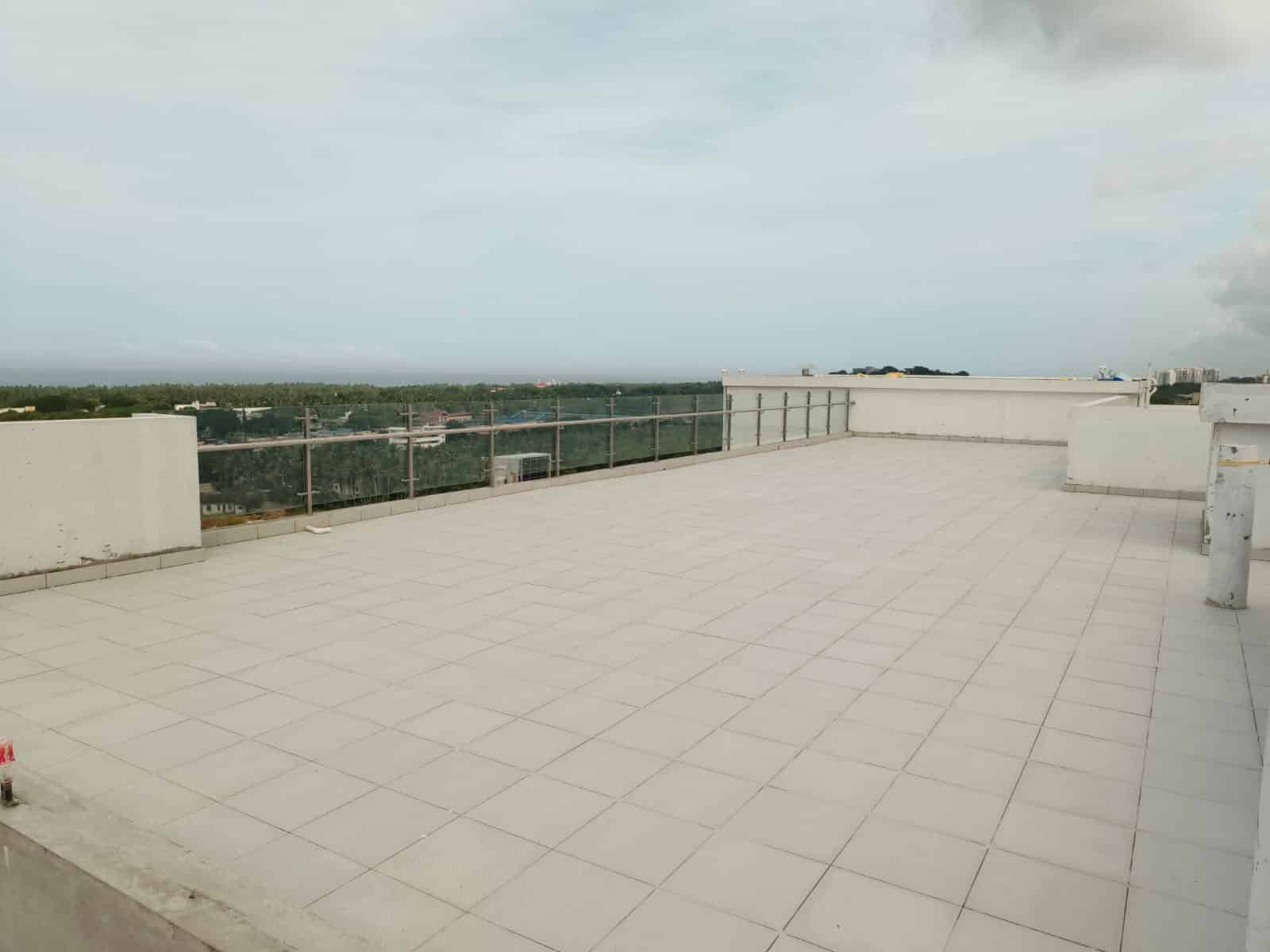

  • Yoga area

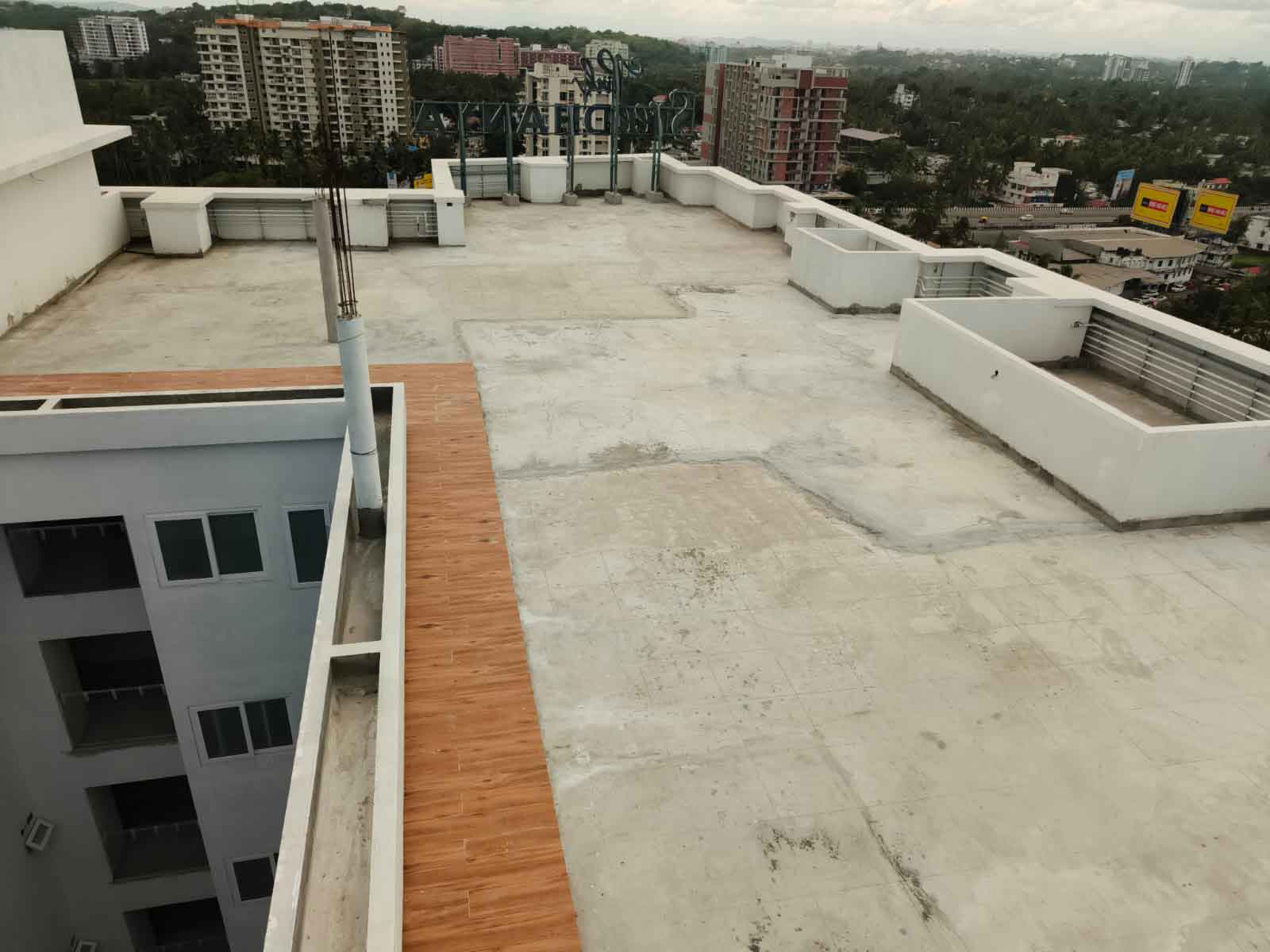

  • Open party area
  • Common toilet and maids changing room on every floor
  • Driver’s room
  • Caretaker’s room
  • 24 Hours generator backup
  • Plush double heighted lobby
  • Badminton court
  • Tennis court
  • Net cricket with bowling machine
  • Amphitheatre
  • Kid’s play area
  • Swimming pool
  • Kid’s pool
  • Waste management system
  • Sanitary pad disposer
SECURITY FEATURES
  • Round the clock security
  • CCTV surveillance
  • Access controlled Movement
  • Video door phone
  • Keyless entry main door
  • Automated gate
ECO FEATURES
  • Landscaped greenary
  • Rainwater harvesting
  • Solar panels
  • Electric car charging provision
Structure

Deep pile foundation complying with seismic zone 3. RCC frame structure with brickwork or concrete block partitions. Concrete grade and Steel grade as per structural consultant’s advice.

Flooring, Tiling & Railings

Main entrance lobby, Lift lobby and Lift fascia (wall & floor) using Granite/ Vitrified Tile.

Staircases using Granite / Vitrified Tile flooring with hand railing using SS / MS as per architect’s design.

Car Park Area: Grano flooring with grooves.

Living Dining 80X80 cm Premium verified tiles

Make:  Make: Johnson/Kajaria/ Keramica/ Equivalent

Kitchen: 60cm X 60cm premium Vitrified Tiles for the flooring and  Black Granite for kitchen top.

All Bed Rooms: verified tiles 80×80 cm

Make: Johnson/Kajaria/ Keramica/ Equivalent

All Bed room Toilets: Designer ceramic tile concepts 30cm X 30cm for floor and 60cm X 30cm for walls up to false ceiling height.

Make: Johnson/Kajaria/ Keramica/ Equivalent

Balconies / Open Terraces / Decks : Rustic / antiskid / ceramic tiles 30cm X 30cm

Sanitary & Plumbing

Sanitary fittings will be Duravit/ Kholer/ AmericanStandard /Vitra/ Equivalent.

EWC wall-hung model Vitra/ Kholer/ AmericanStandard / Equivalent

All Sanitary wares shall be of white colour.

Sanitary wares for servants if provided, toilet shall be using CERA/ Hindware/ Equivalent.

Concealed flushing system of GEBERIT / GROHE for Bed room toilets.

Faucets: For all the bed room toilets will be single lever concealed diverters CP fittings, heavy body metal fittings

Make: Vitra/American Standard / Kholer or Equivalent.

Counter mounted/Wall mounted single lever faucet will be provided for wash Basins in Kitchen and utility area sink

Make: Vitra/American Standard / Kholer/Equivalent

Plumbing: All water supply lines shall be in ISI marked CPVC/ASTM

Make: Supreme/equivalent.

Drainage lines and storm water drain pipes shall be in PVC/ASTM.

In Kitchen Stainless Steel Sink double bowl with drain board

Utility Area: Stainless steel sink without drain board

Make: Franke/ Reginox/ Equivalent

Doors & Windows

Main Door shall be pre-hung engineered wood with veneer finish

Window shutters will be of UPVC/Aluminum/equivalent

All internal doors expect bathroom doors shall be pre-hung with laminate/mica finish.

Bathroom Doors shall be pre-hung with WPC frames and laminate shutter with lipping

Hardware: All hardware shall be in S.S.finish.

Locks of mortise style

Make:Doorset/ Yale /Godrej /Equivalent.

Entrance door shall have hardware such as, Magic Eye, Safety Chain, Door Stopper.

Main door is digital lock with access card

Make: Yale/Godrej/Doorset/Equivalent.

Electrical

Concealed copper wiring with modular plate switches, centralized cabling system for all electrical and communication requirements

Make: FINOLEX / V-GUARD / HAVELLS/RR CABLE/BONTON /Equivalent

Switches: All switches shall be MK /Schneider/Legrand/Equivalent.

Generator: Automatic Changeover to Generator supply for common Lights and Lifts. Power backup for designated points inside of each flat

Make:Cummins/Kirloskar/ Equivalent.

Light fixtures for the Common areas shall be provided.

Adequate ELCB and MCB shall be provided in each apartment

Make: SIEMENS / HAVELLS/ Equivalent.

Provision for telephone and Internet shall be provided in the Living room and Master Bed room. Provision for Cable TV / DTH shall be provided in the Living and Master Bed room.

Air Conditioning provision shall be given in all bedrooms and Living area.

Gas Supply

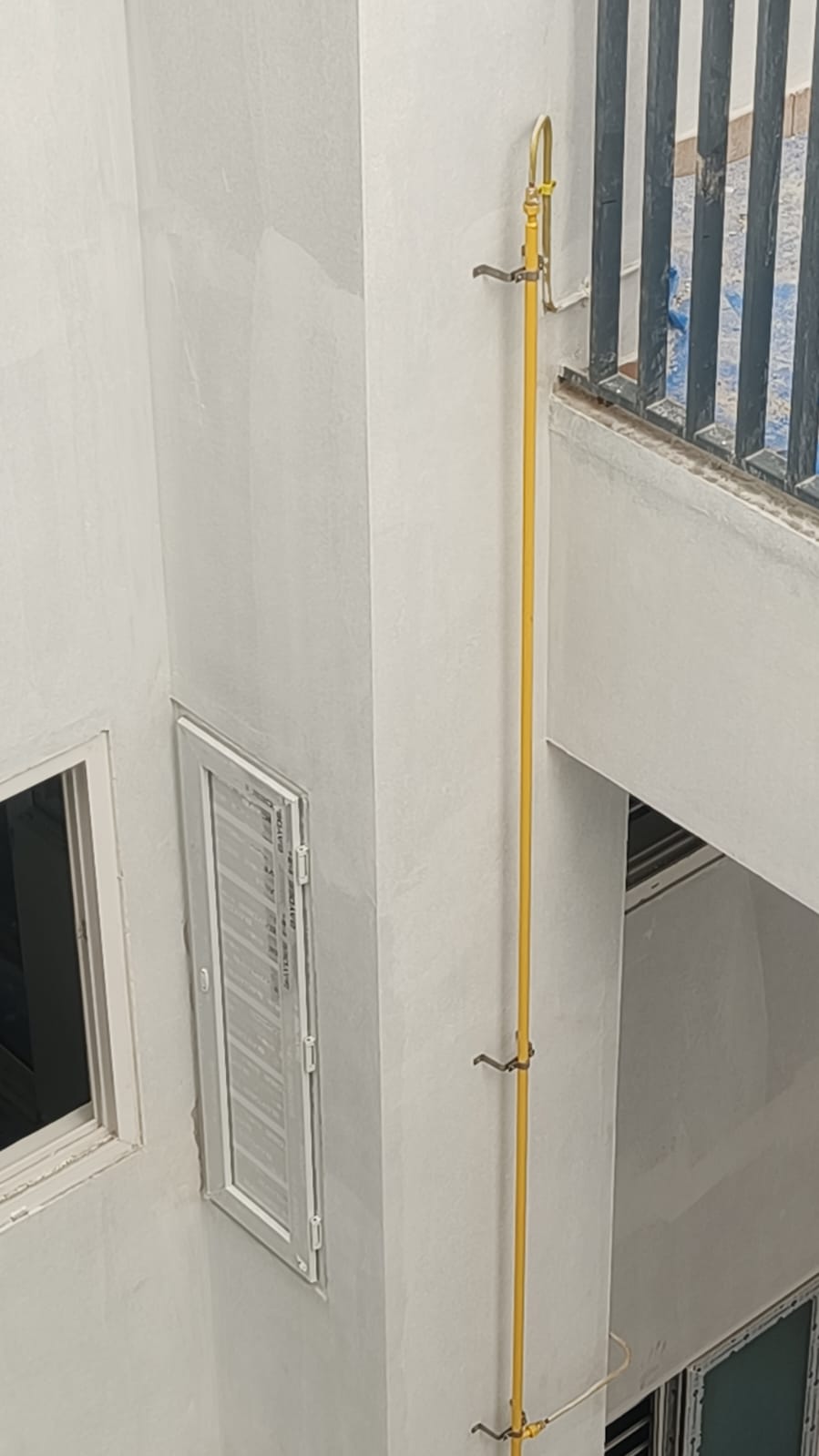

Reticulated gas supply with individual meters will be provided.

Paint Finishes

Premium emulsion paint shall be applied for the ceiling and interior walls of the apartments excluding Utility and Services.

Make: Asian/Jotun/Dulux/Equivalent

Internal Walls: Acrylic / cement based Putty with Premium emulsion paint.

Make: Asian/Berger/Jotun/Equivalent

External Walls: Exterior emulsion paint

Make: Asian/Jotun/Dulux/Equivalent

Elevators

Elevators: High Speed lift shall be provided as per the Govt. norms in each core with automatic doors

Make:KONE /Mitsubishi/ SCHINDLER or Equivalent.

ARD (Automatic Rescue Device) and Access Control Device shall be installed in the passenger lift as a premium feature.

Waste Management: Incinerator/Biobin /Equivalent

Car Wash Bay: Designated Bay with water supply.

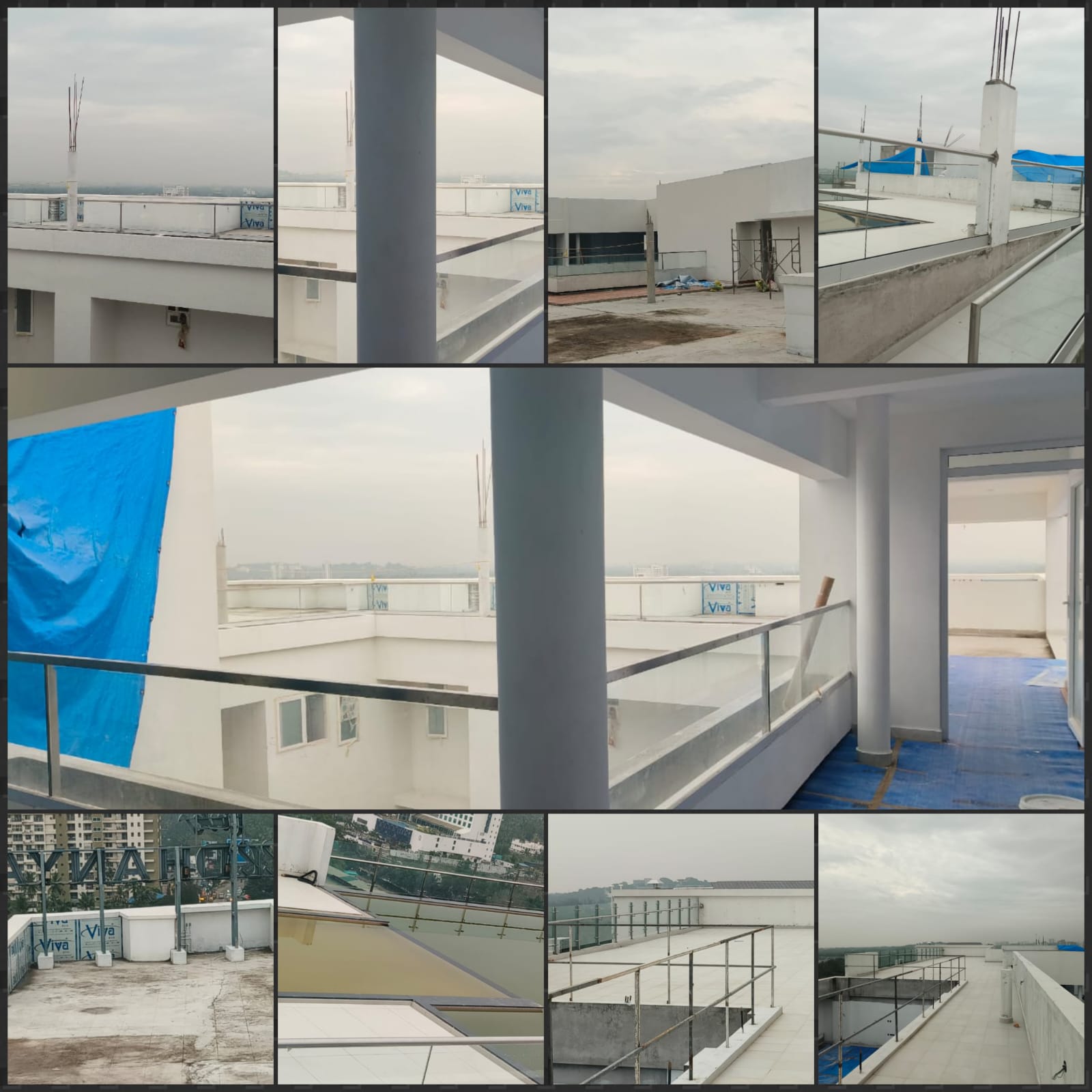

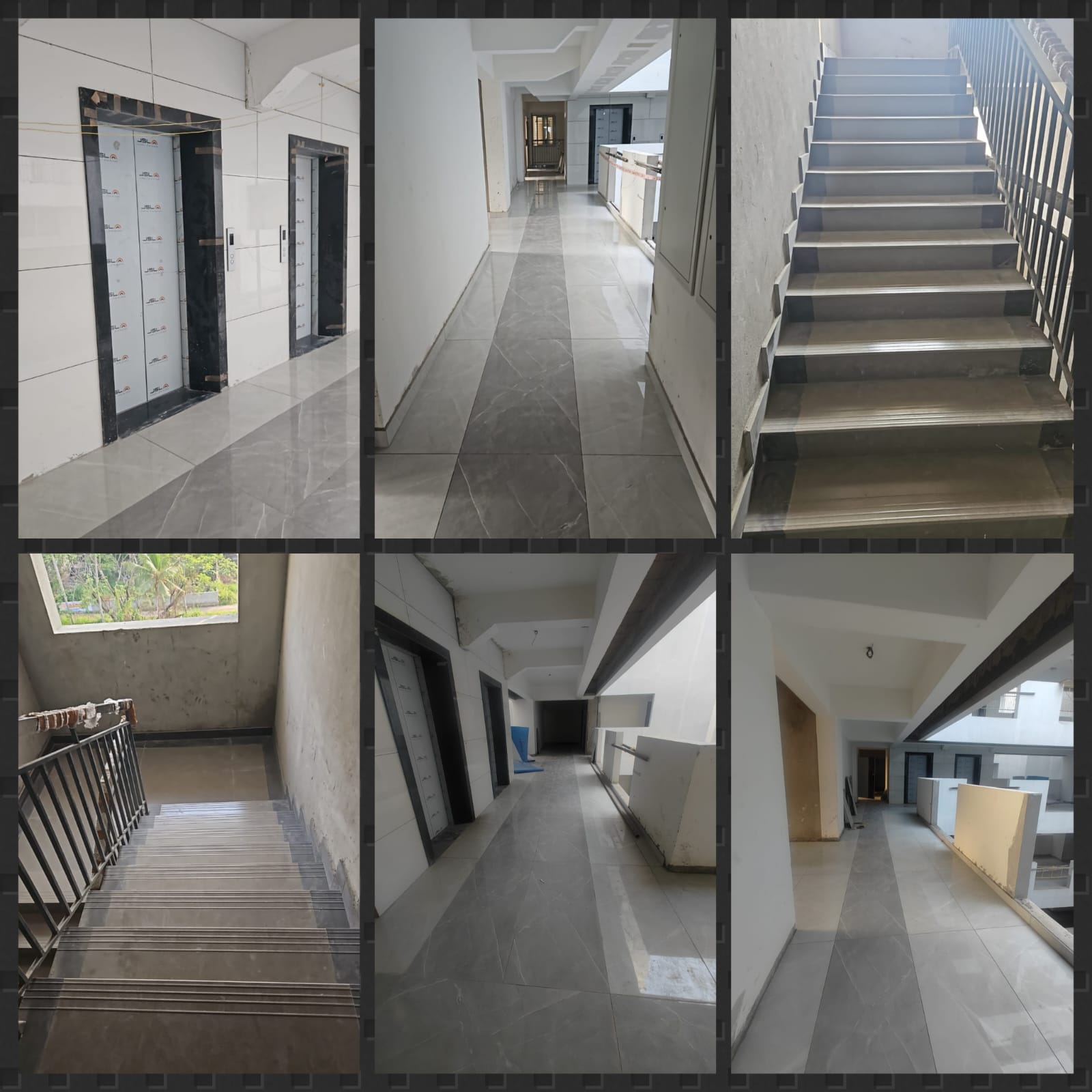

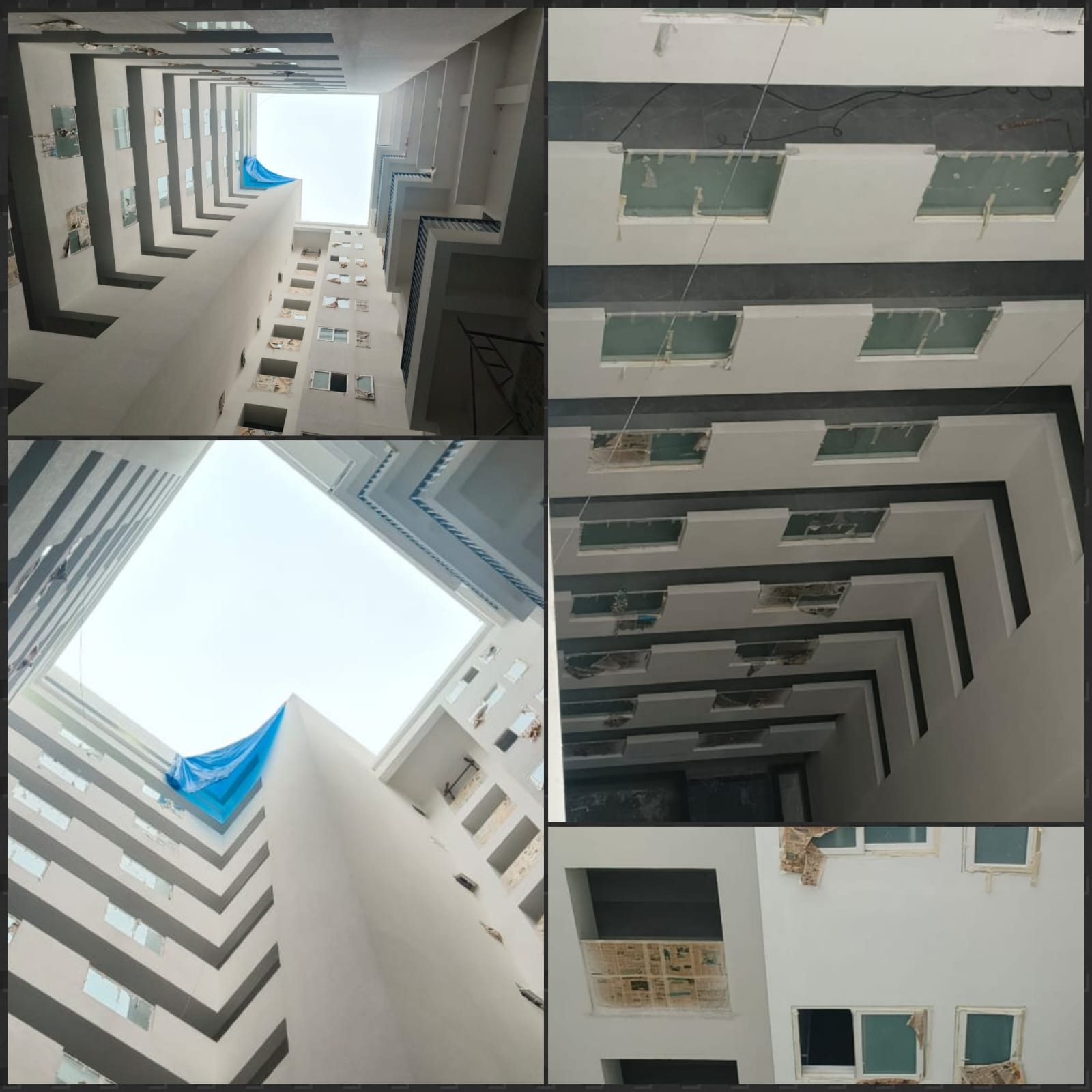

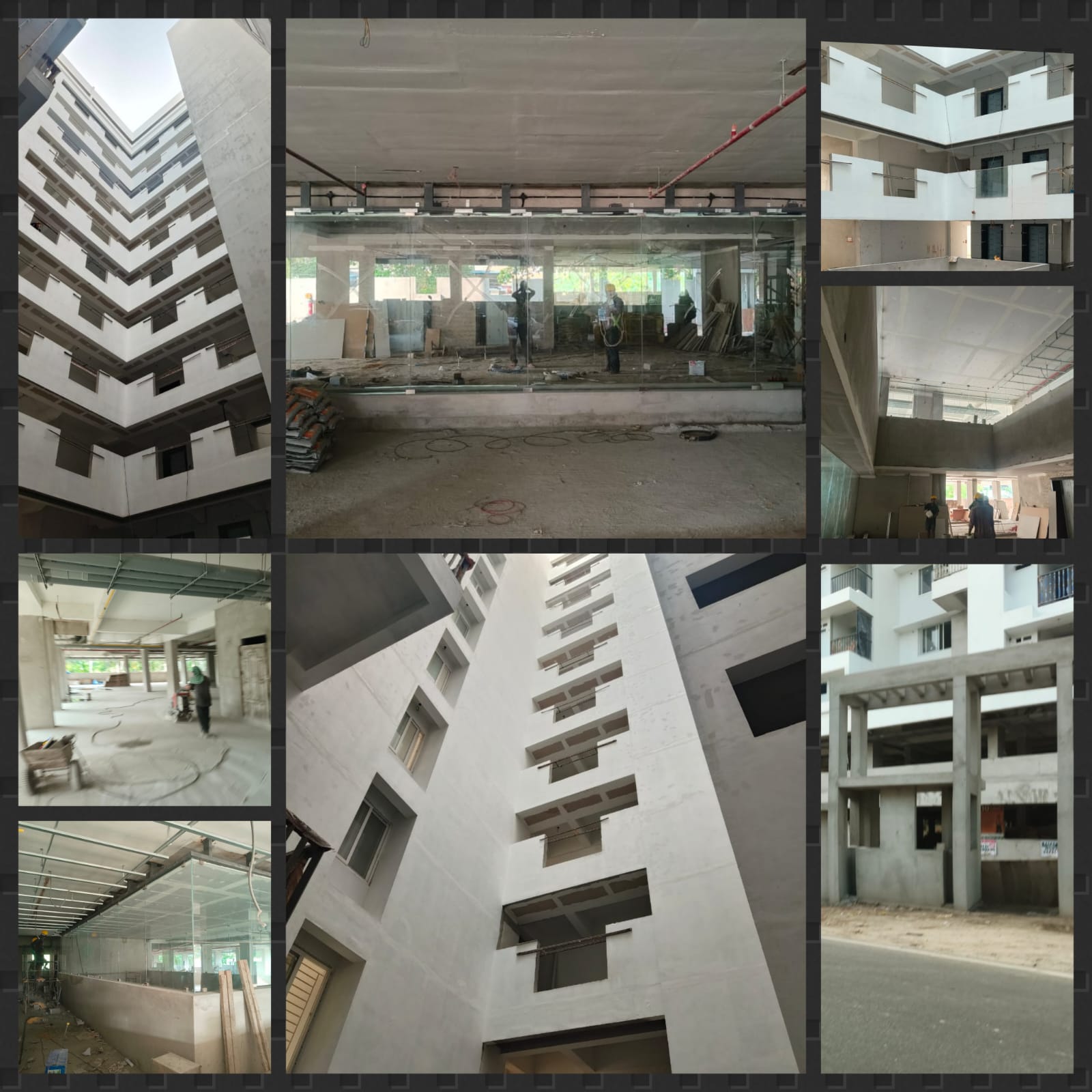

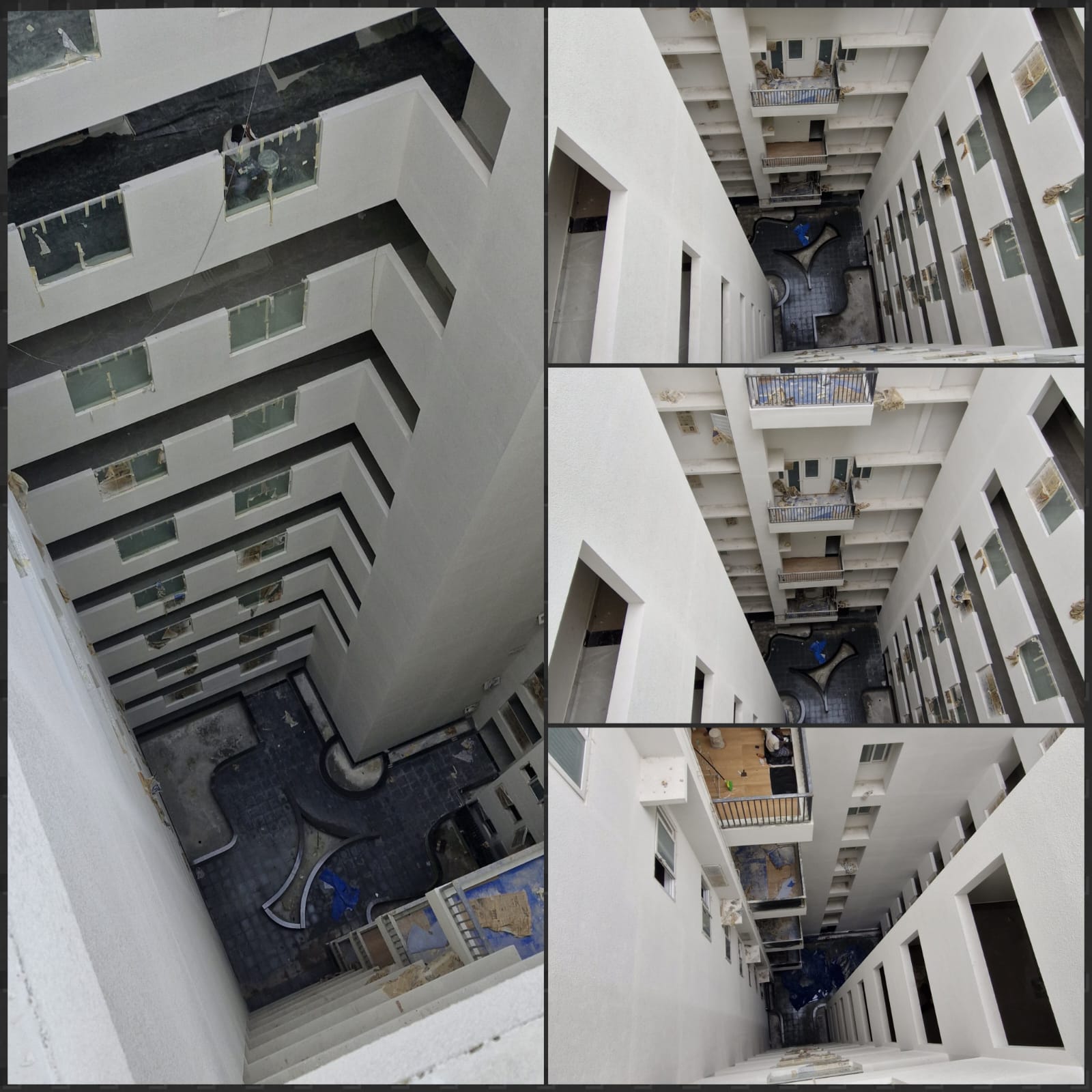

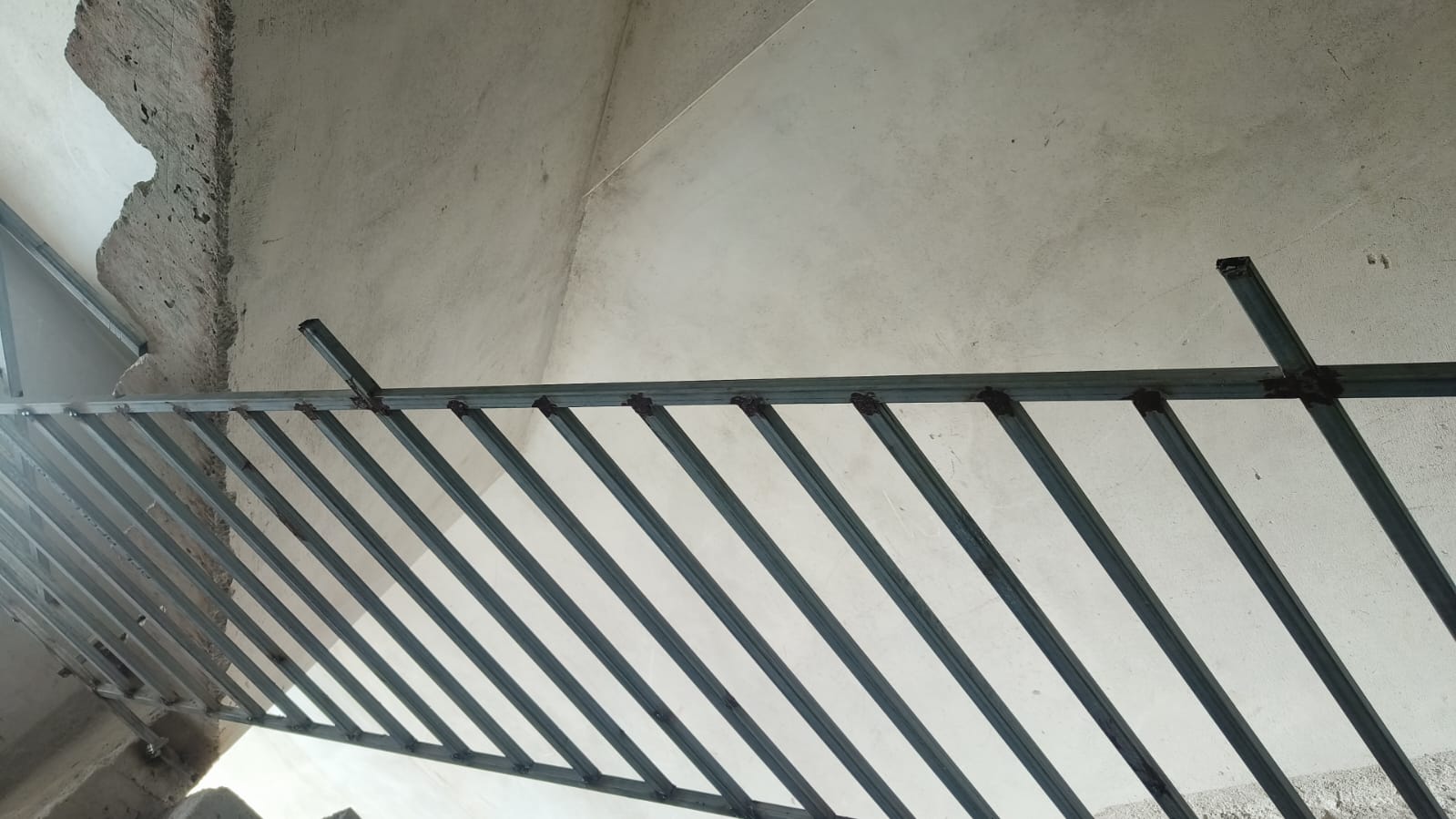

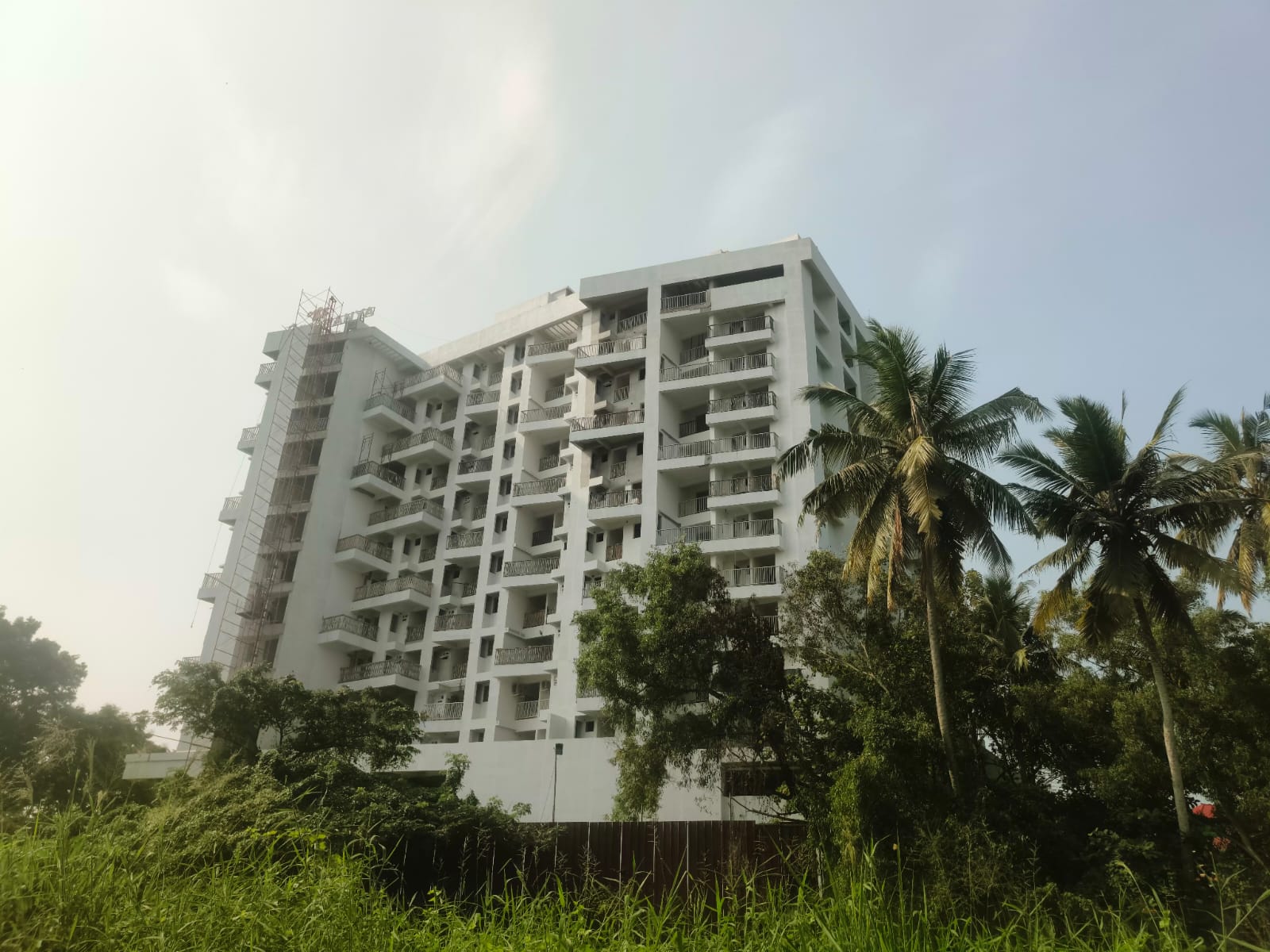

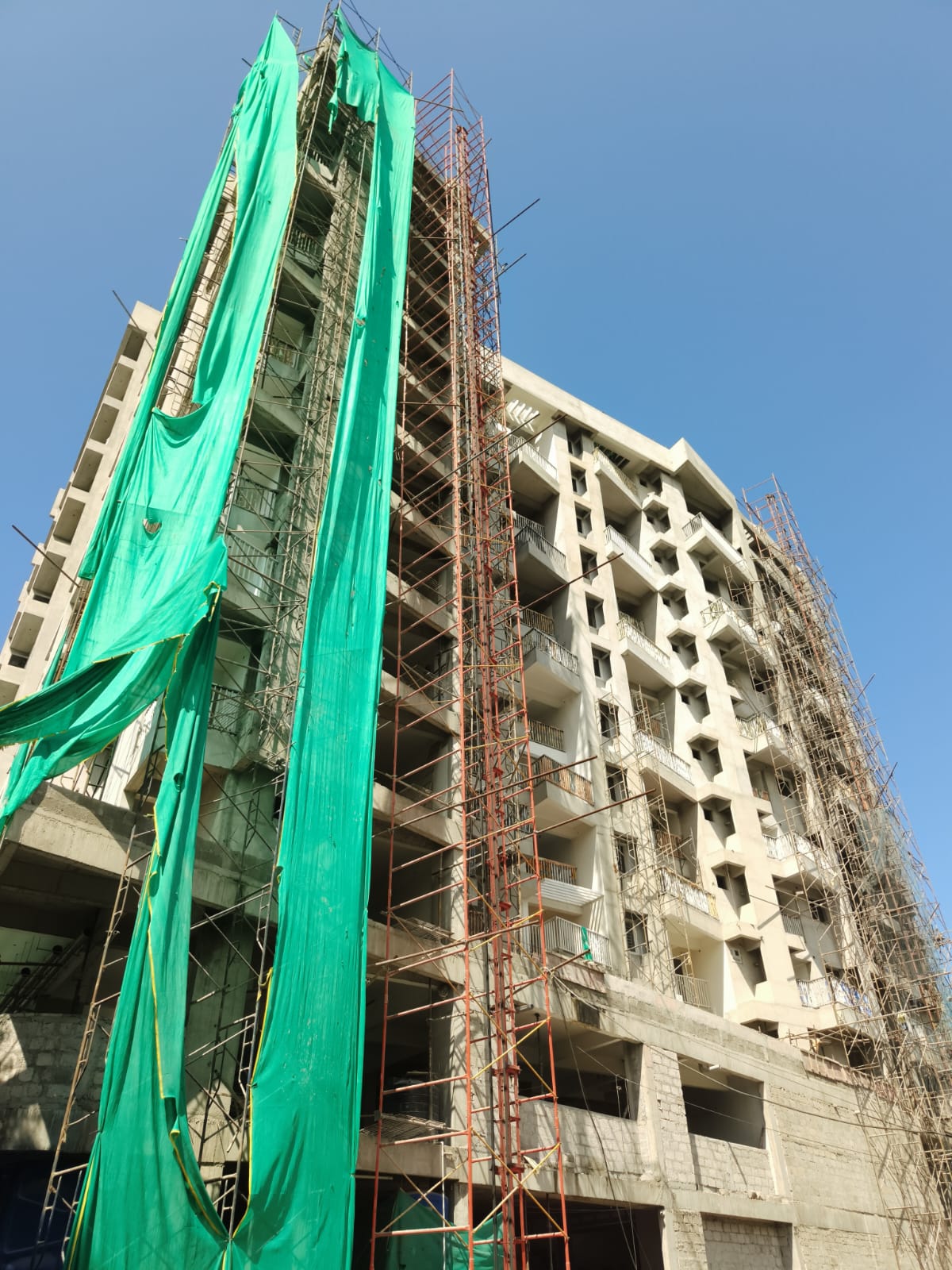

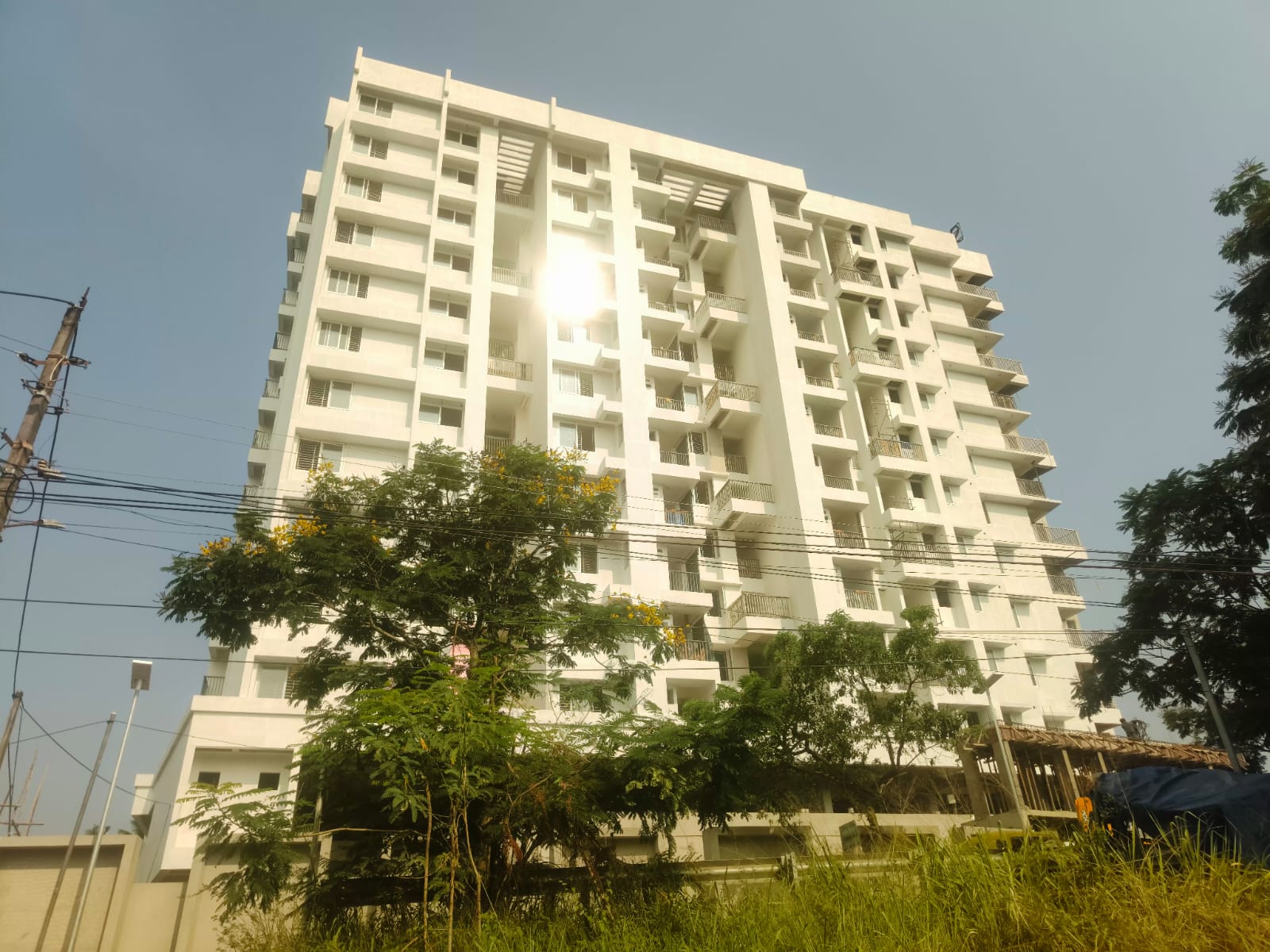

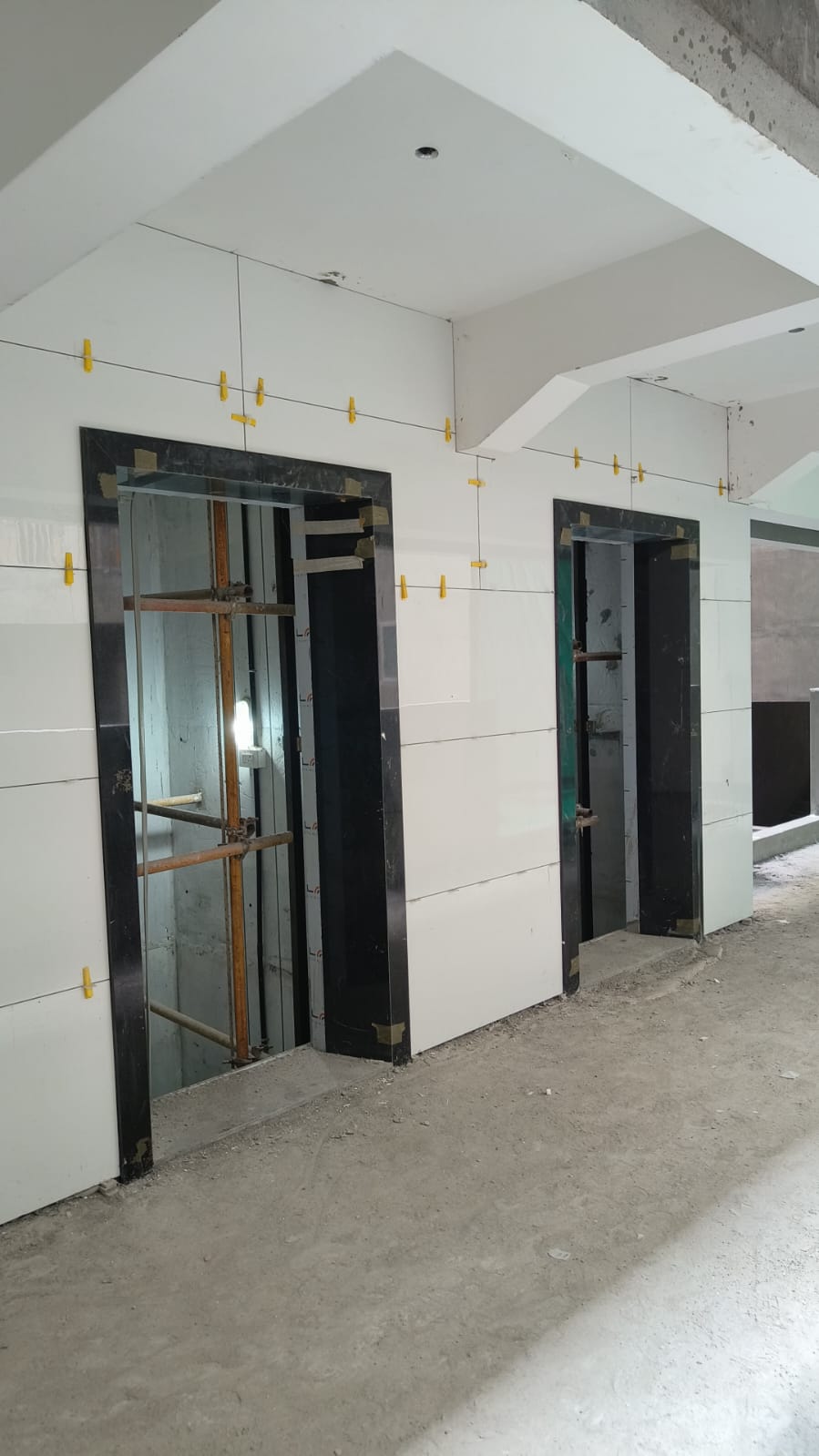

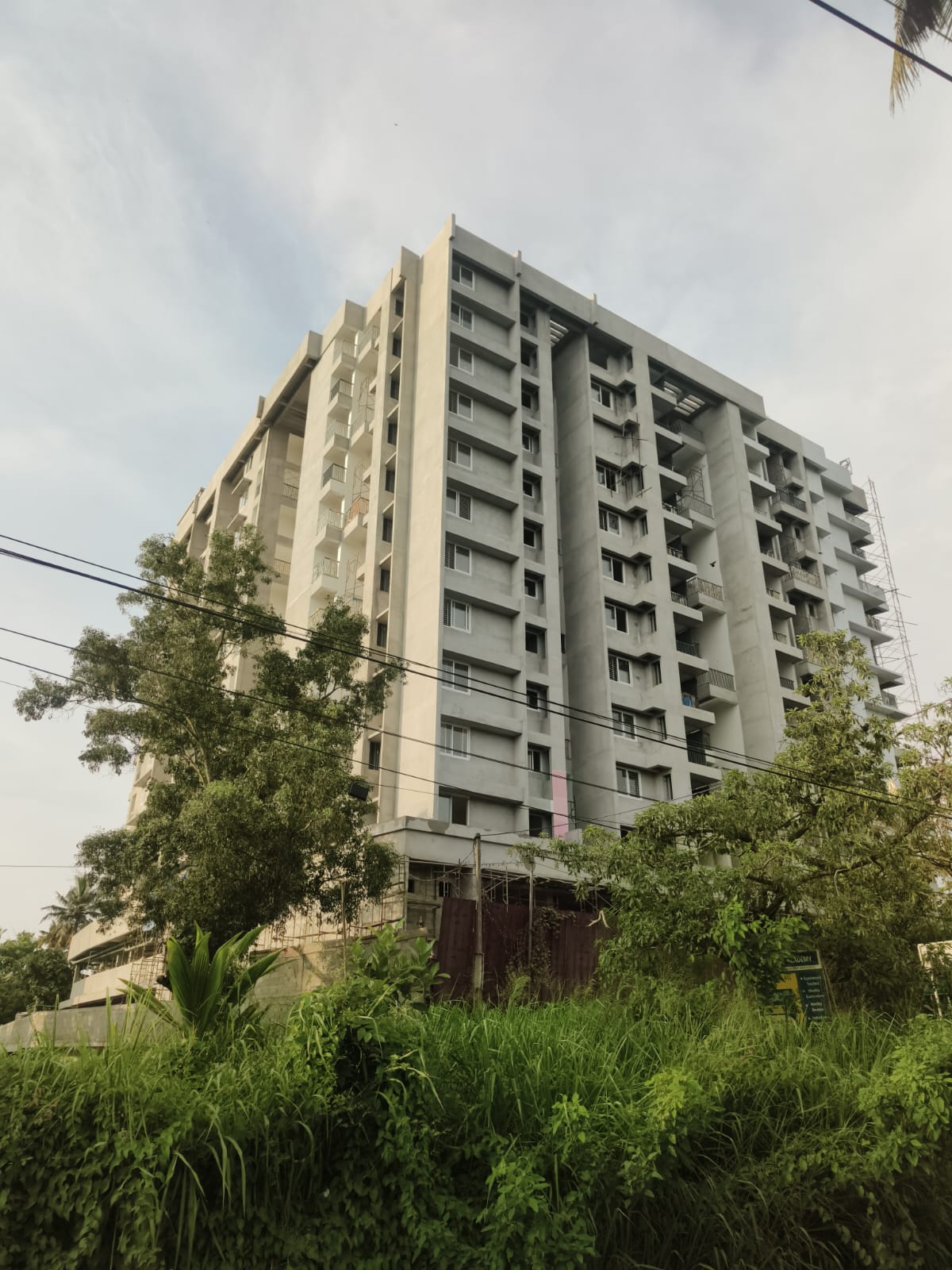

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 14th December 2024

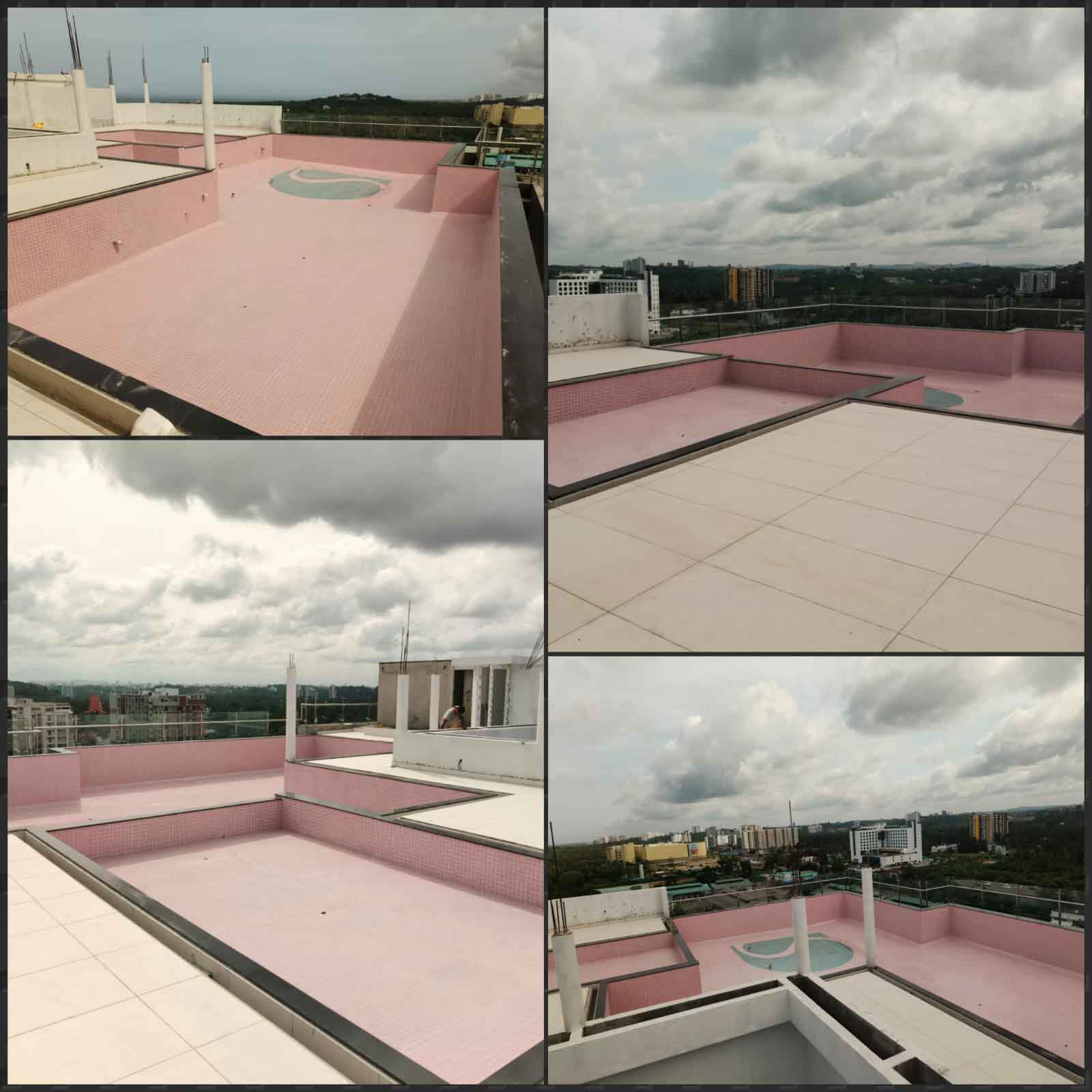

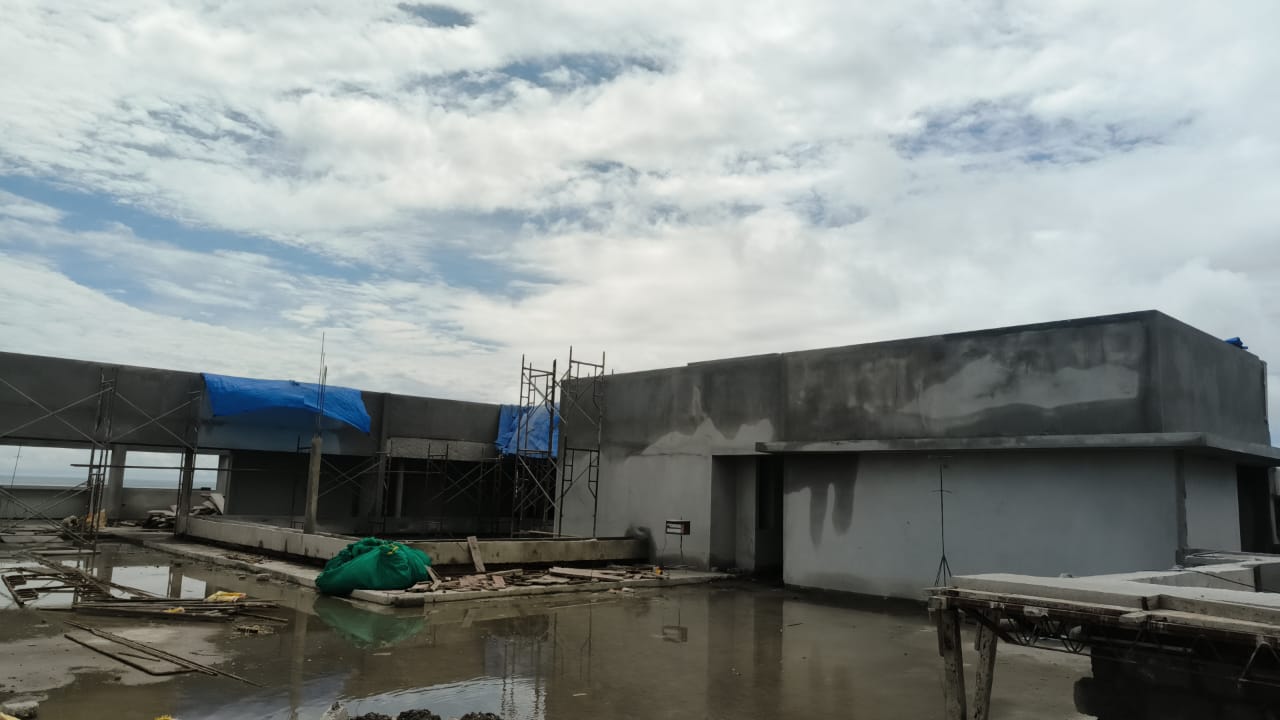

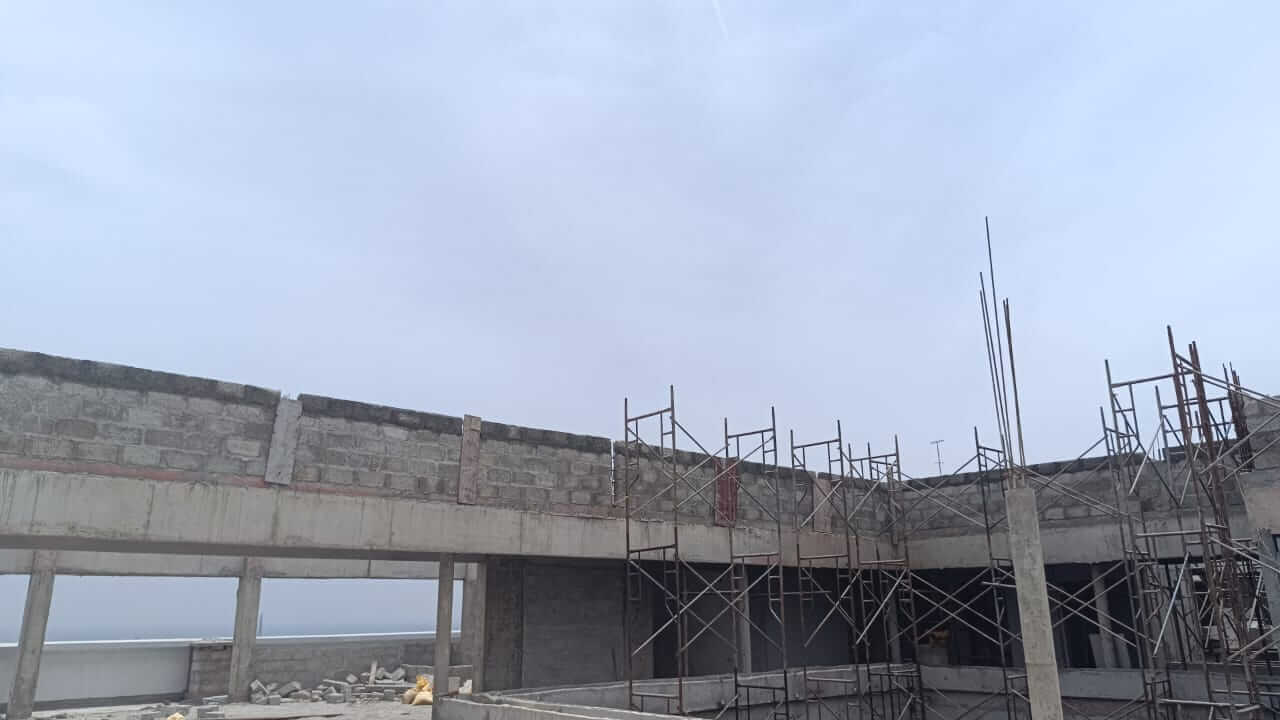

  • RCC for Roof Terrace Slab – 100% Completed
  • RCC for Water Tank, Swimming Pool, Lift Head Room – 100% Completed

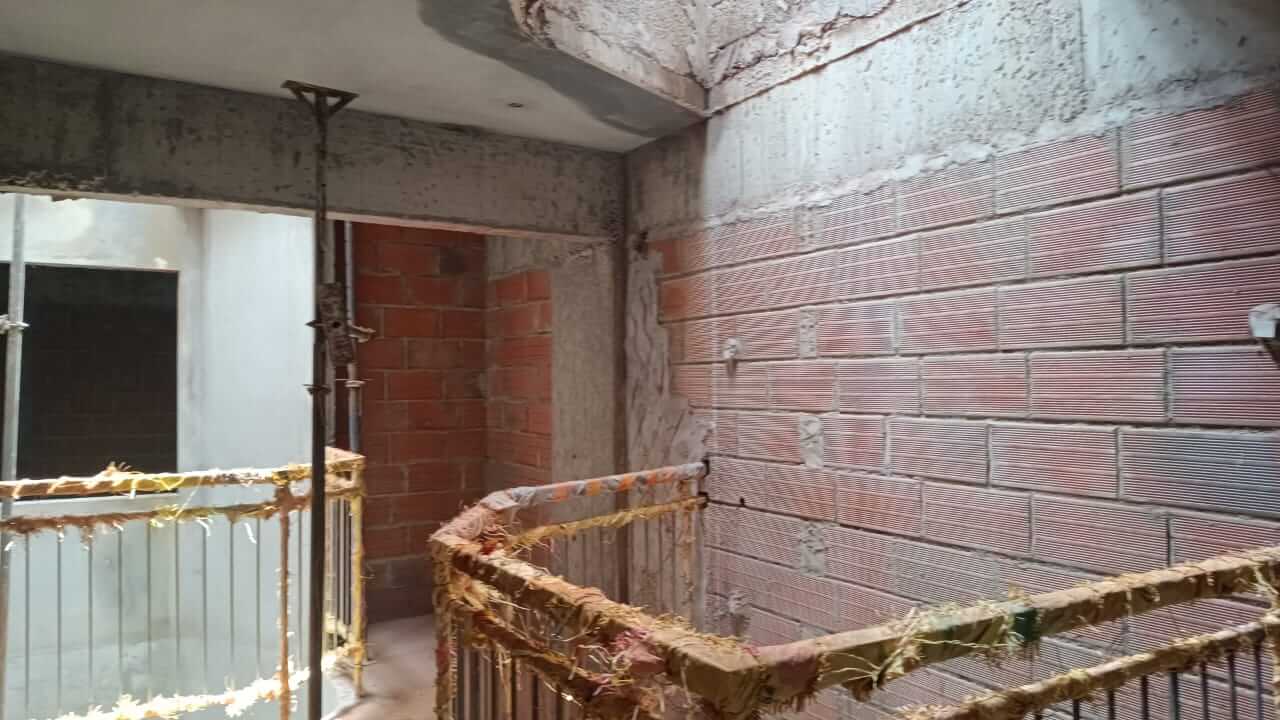

  • Block Work – 100% Completed

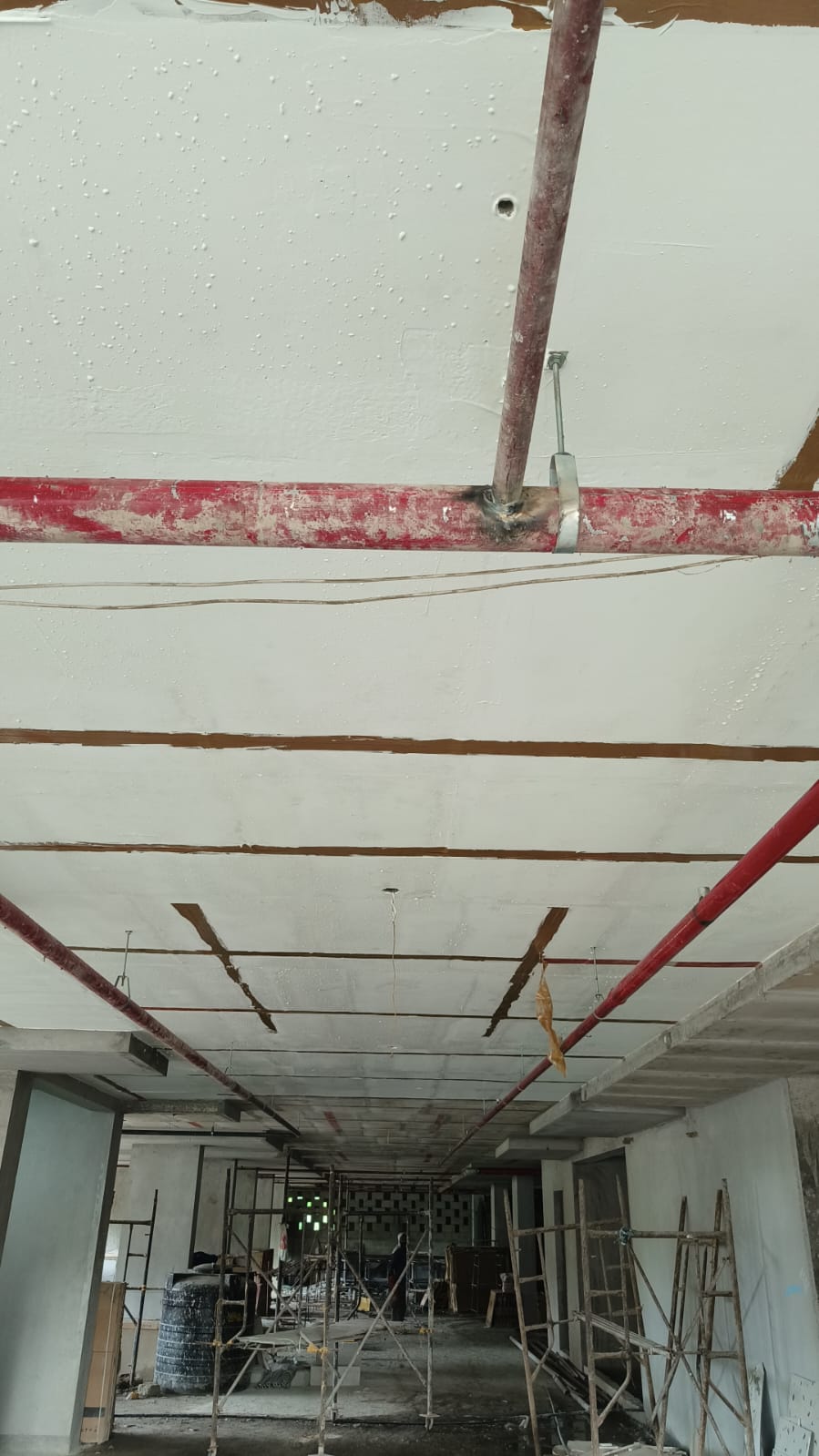

  • Ceiling Plastering – 100% Completed

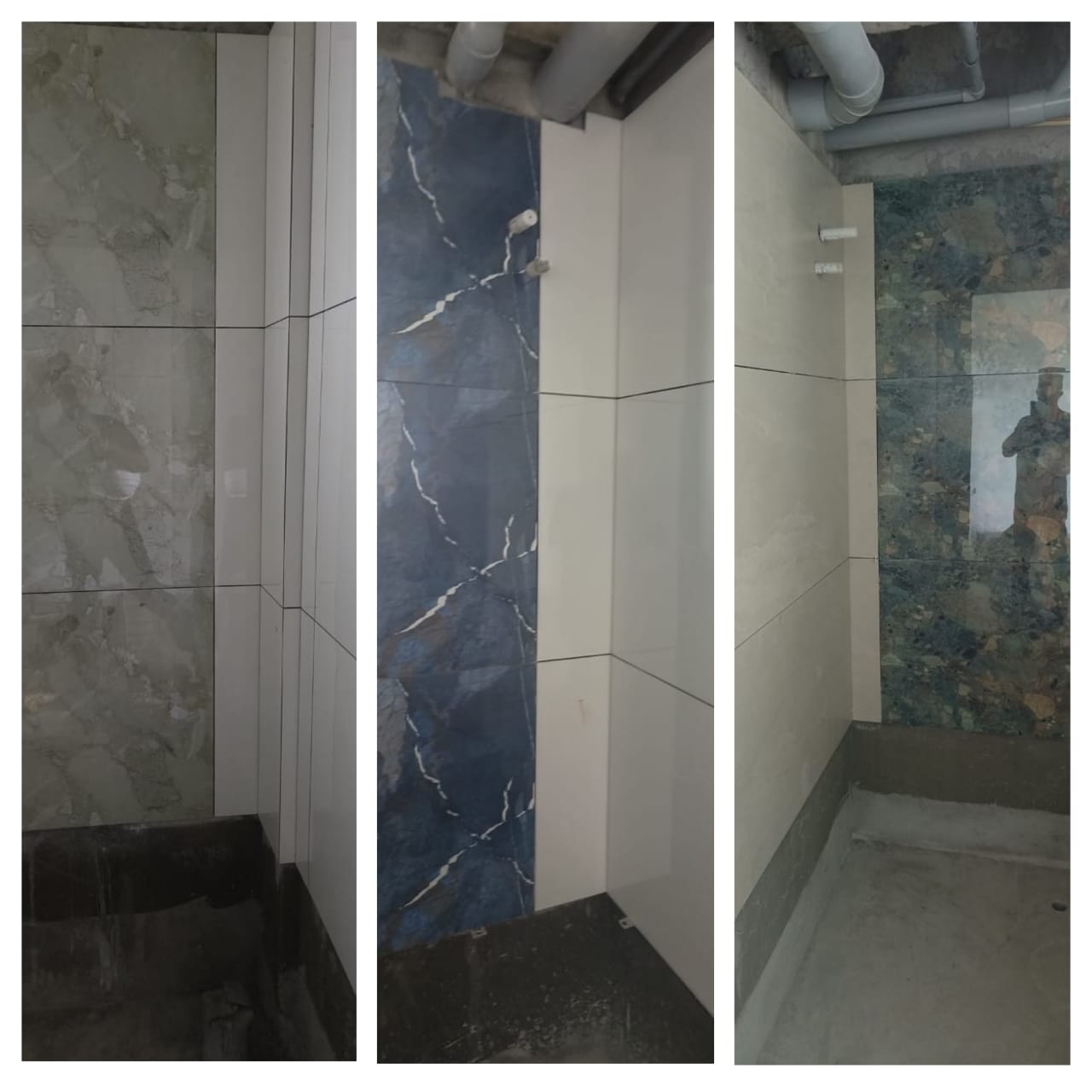

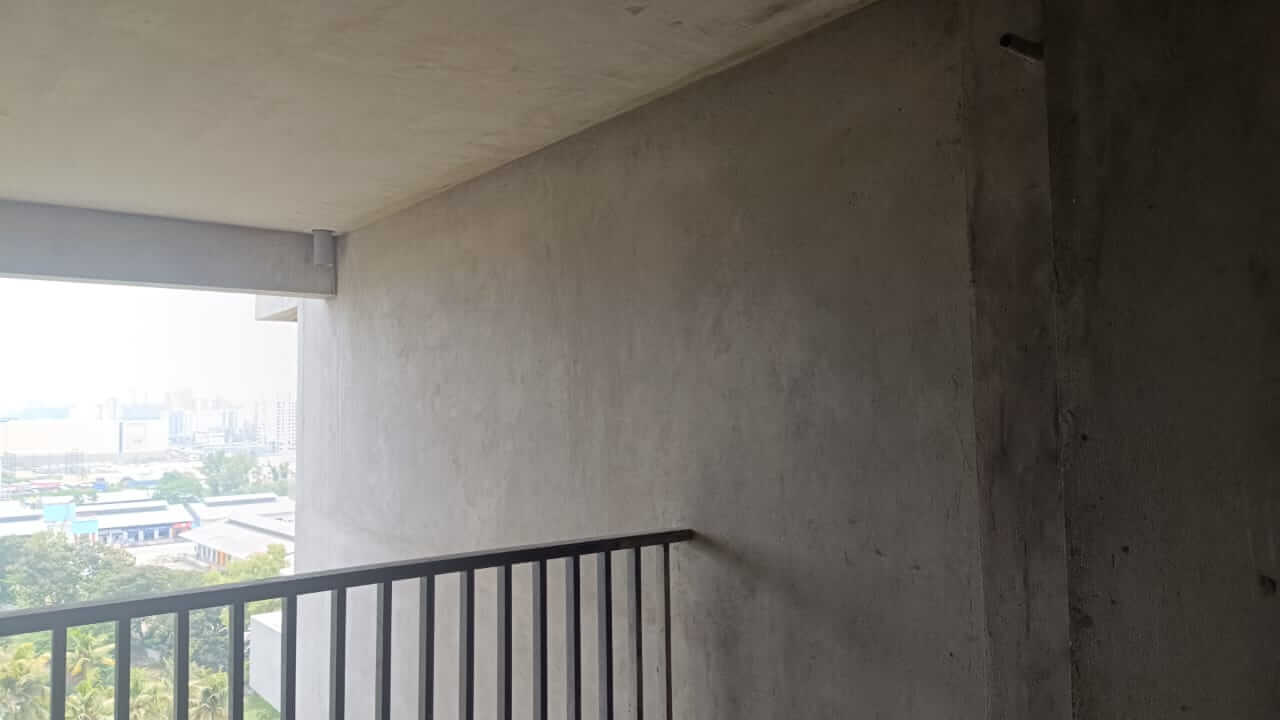

  • Inside Wall Plastering – 92/92 Apartments Completed
  • External Wall Plastering – 100% Completed
  • Wall Tiling – 91/92 Apartments Completed

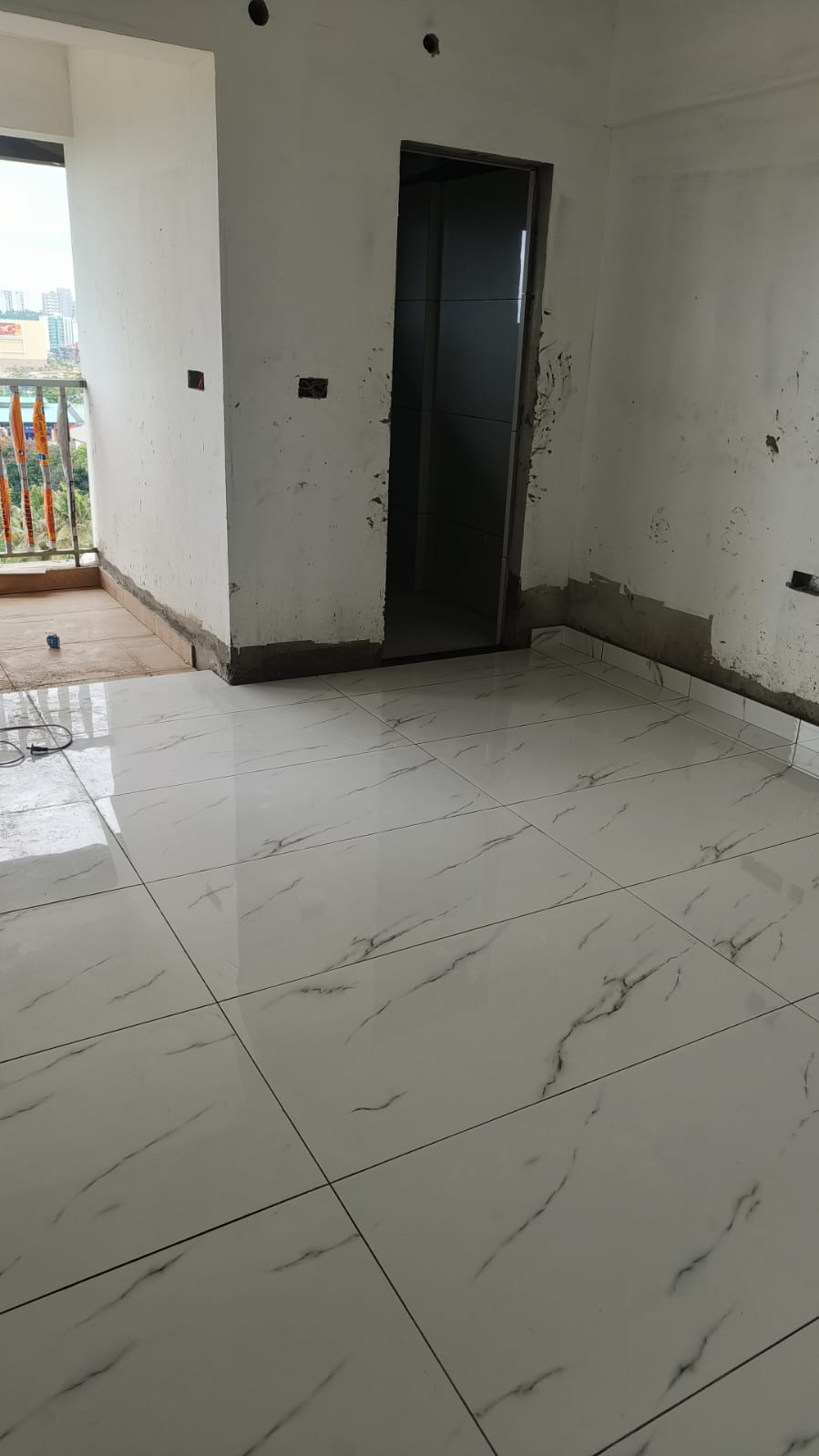

  • Floor Tiling – 91/92 Apartments Completed
  • Lift Architrave Work – 15/15 Floors Completed
  • Passage Flooring – 15/15 Floors Completed
  • Main Stair Step Tile Laying – 15/15 Floors Completed
  • Fire Stair Step Tile Laying – 15/15 Floors Completed

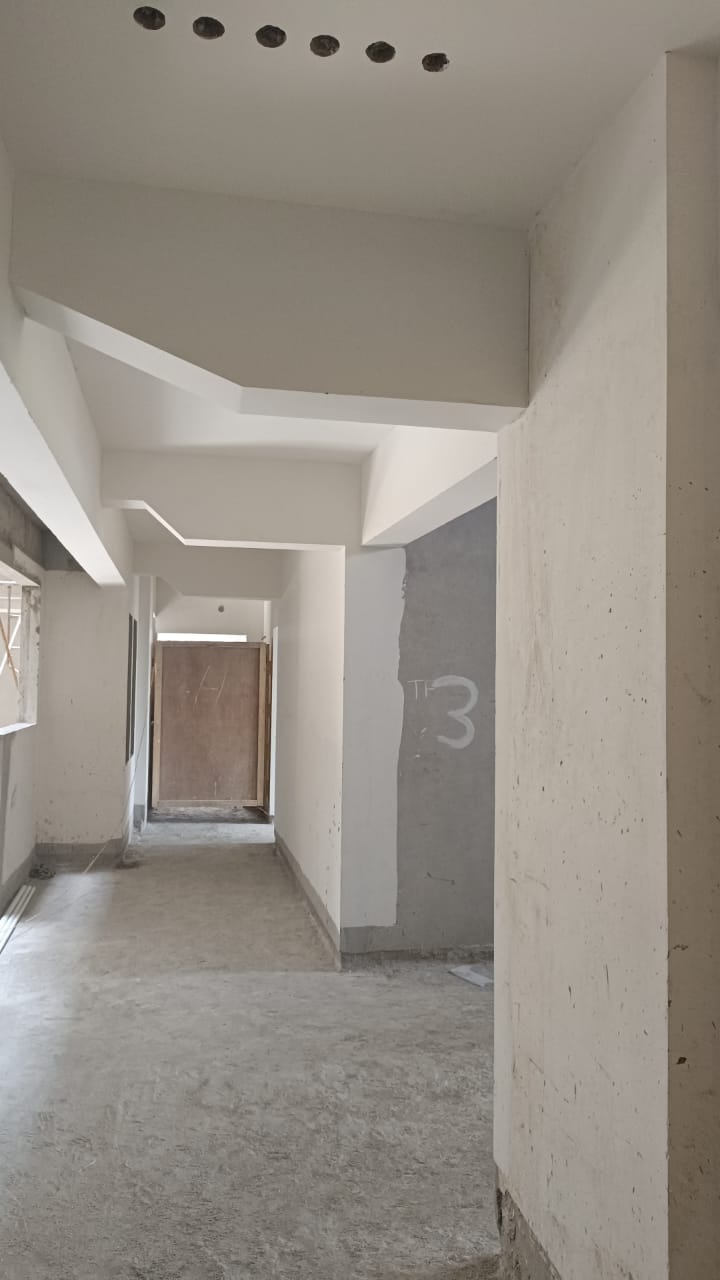

  • Wall Putty Work – 91/92 Apartments Completed
  • Waterproofing of Toilets – 92/92 Apartments Completed
  • Wiring Completion – 91/92 Apartments Completed

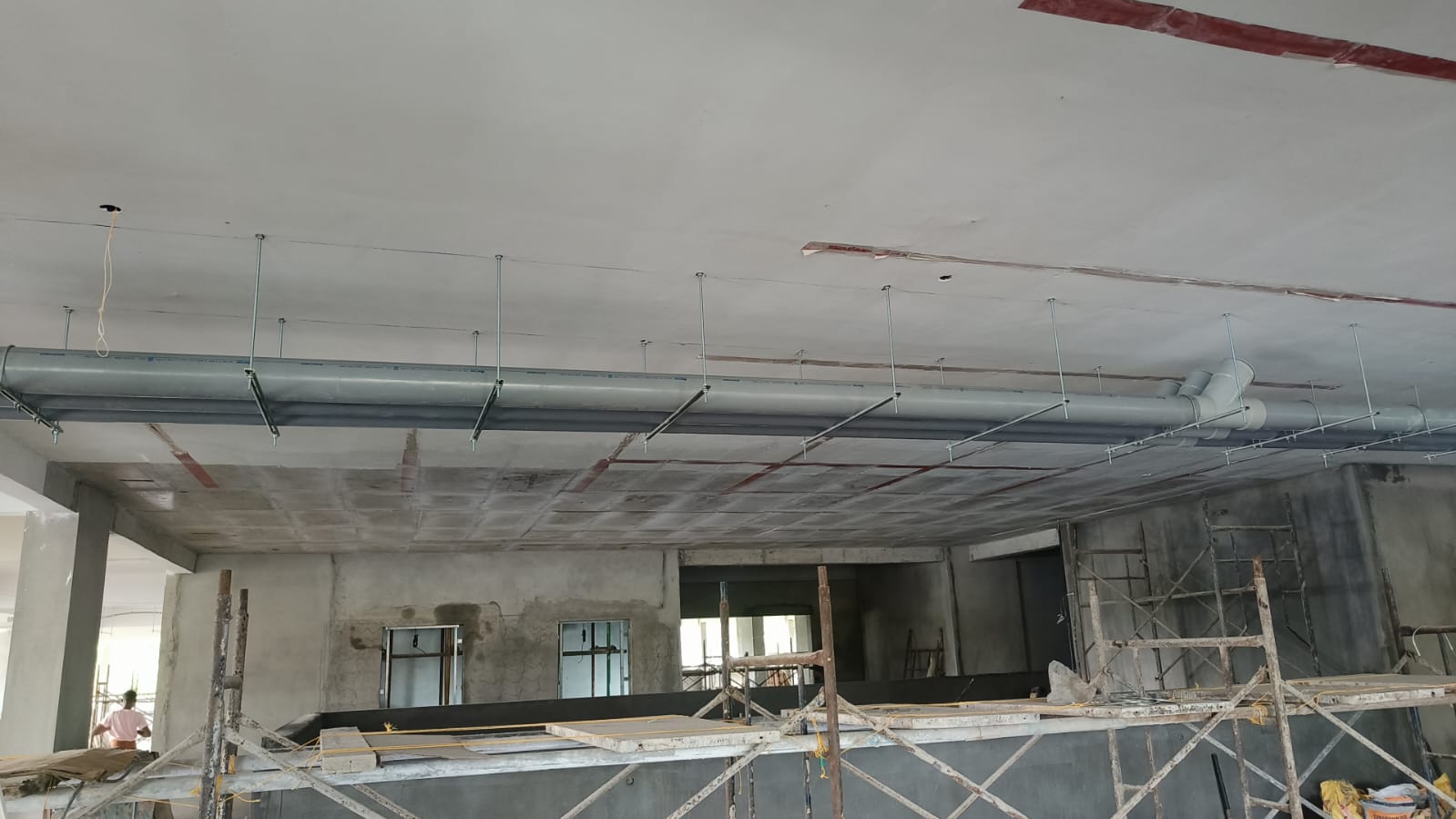

  • Internal Plumbing – 92/92 Apartments Completed

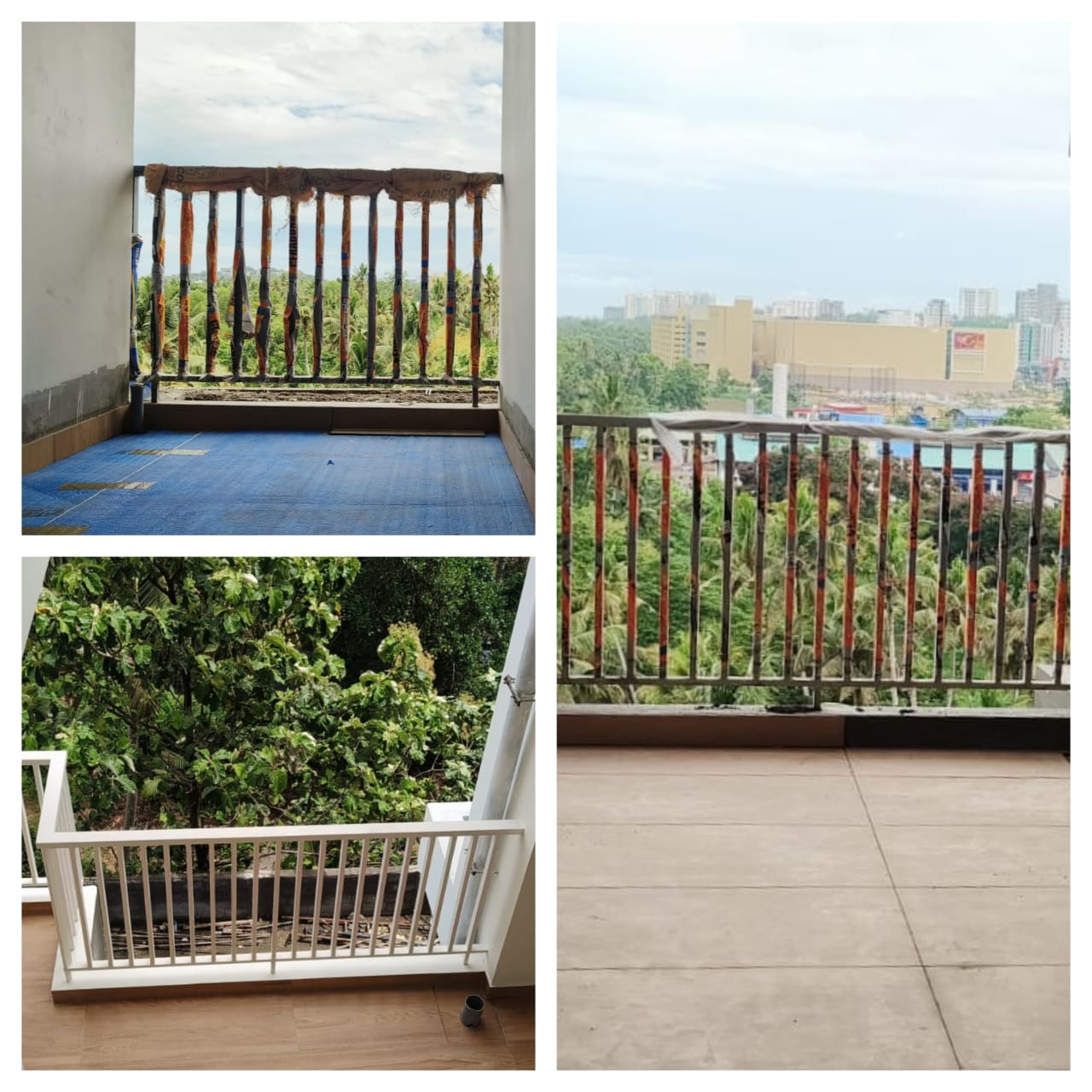

  • Balcony Handrail Fixing – 92/92 Apartments Completed
  • Door Shutter Fixing – 89/92 Apartments Completed
  • UPVC Doors Fixing – 87/92 Apartments Completed
  • UPVC Windows Fixing – 91/92 Apartments Completed

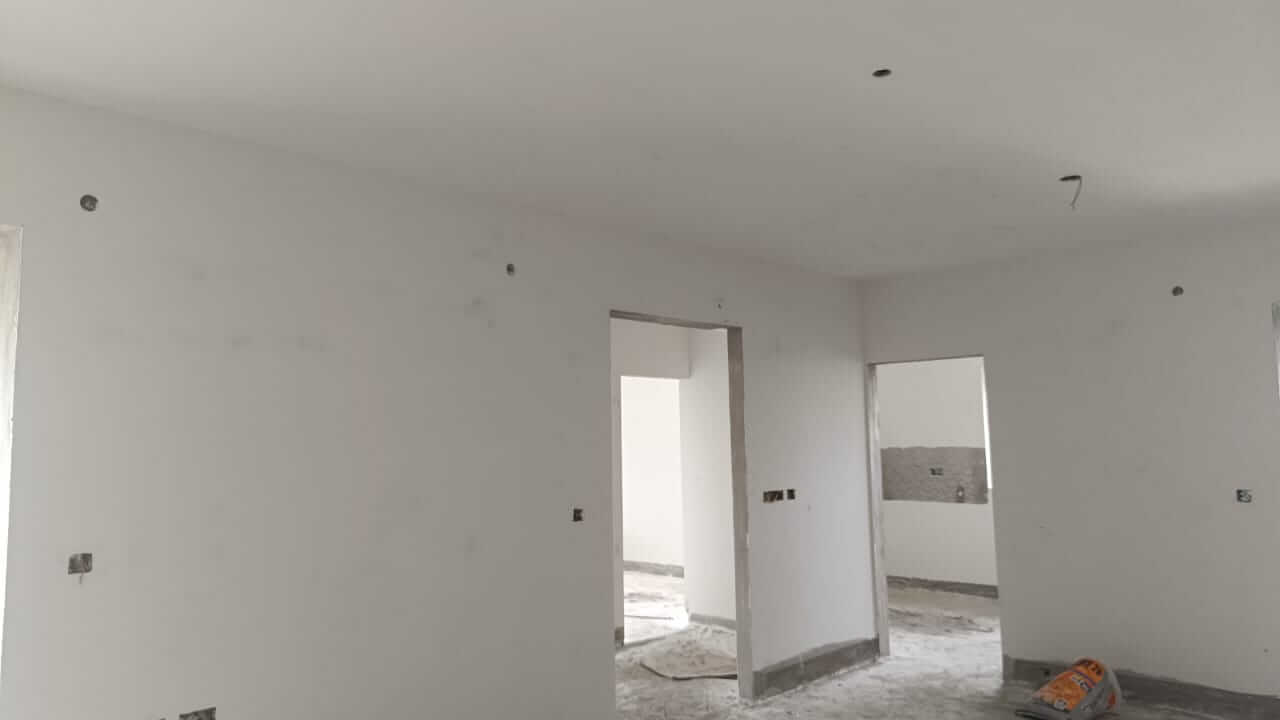

  • 1st Coat Inside Wall Painting – 80/92 Apartments Completed
  • 2nd Coat Inside Wall Painting – 6/92 Apartments Completed
  • External Wall Primer Painting (1st Coat & 2nd Coat) – 100% Completed
  • External Wall Emulsion Painting (1st Coat) – In Progress
  • Plumbing Work in Ducts – 36/36 Completed
  • Window Grill Fixing – 92/92 Completed
  • Electrical HT Work – 100% Completed

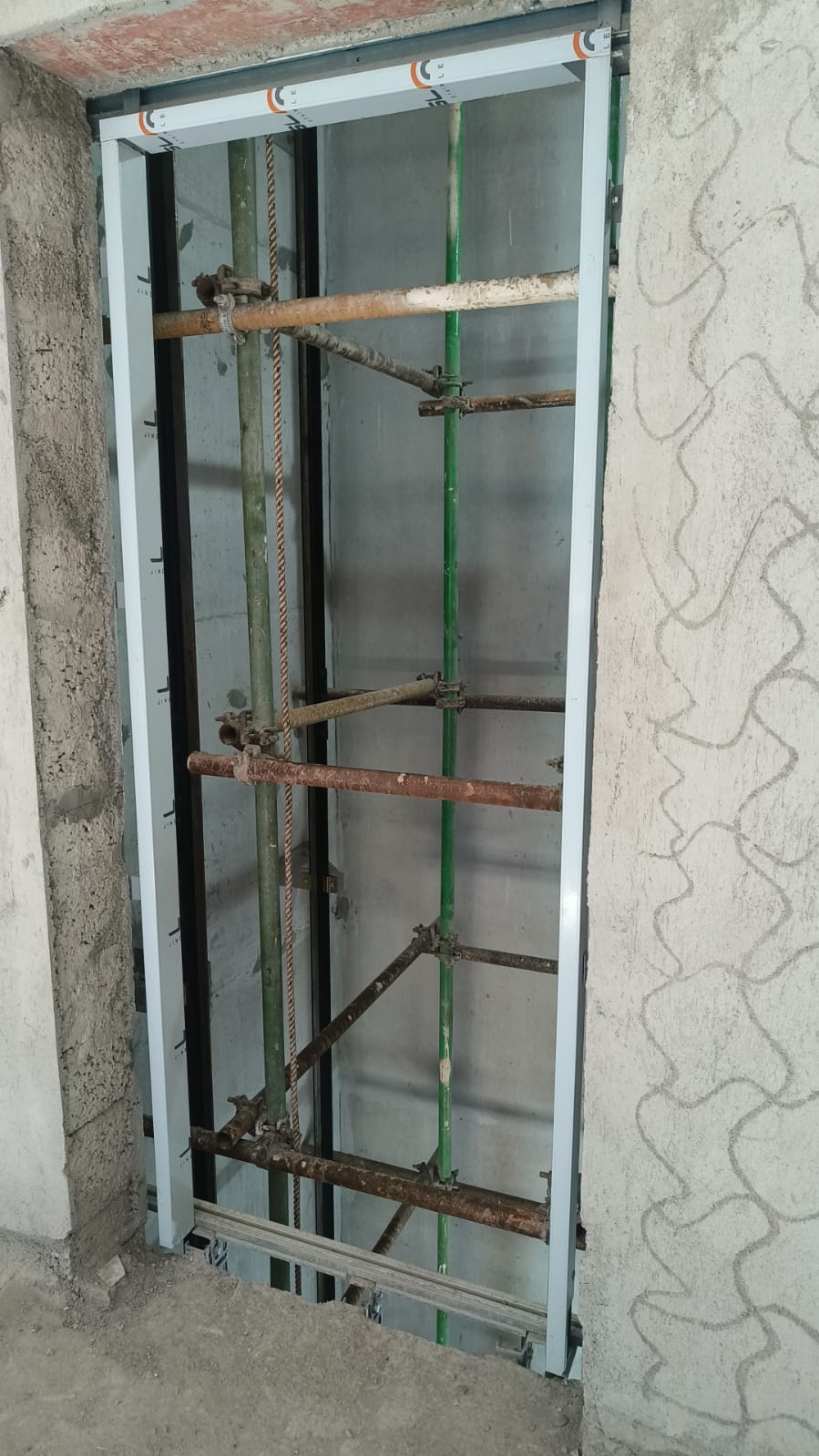

  • Lift Erection – 100% Completed

  • RCC for UG Sump – 100% Completed
  • RCC for STP – 100% Completed

  • Fire Fighting Work – 100% Completed

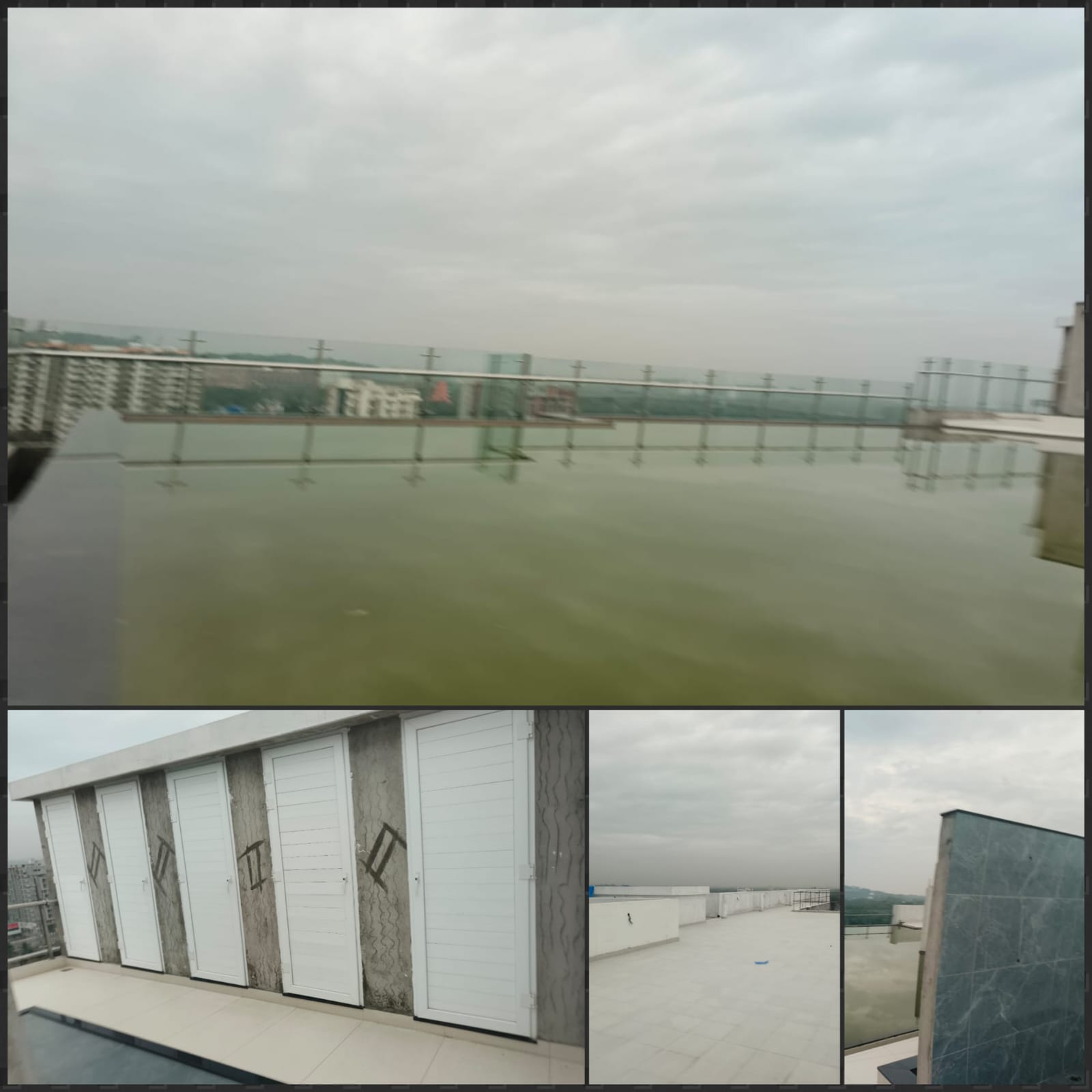

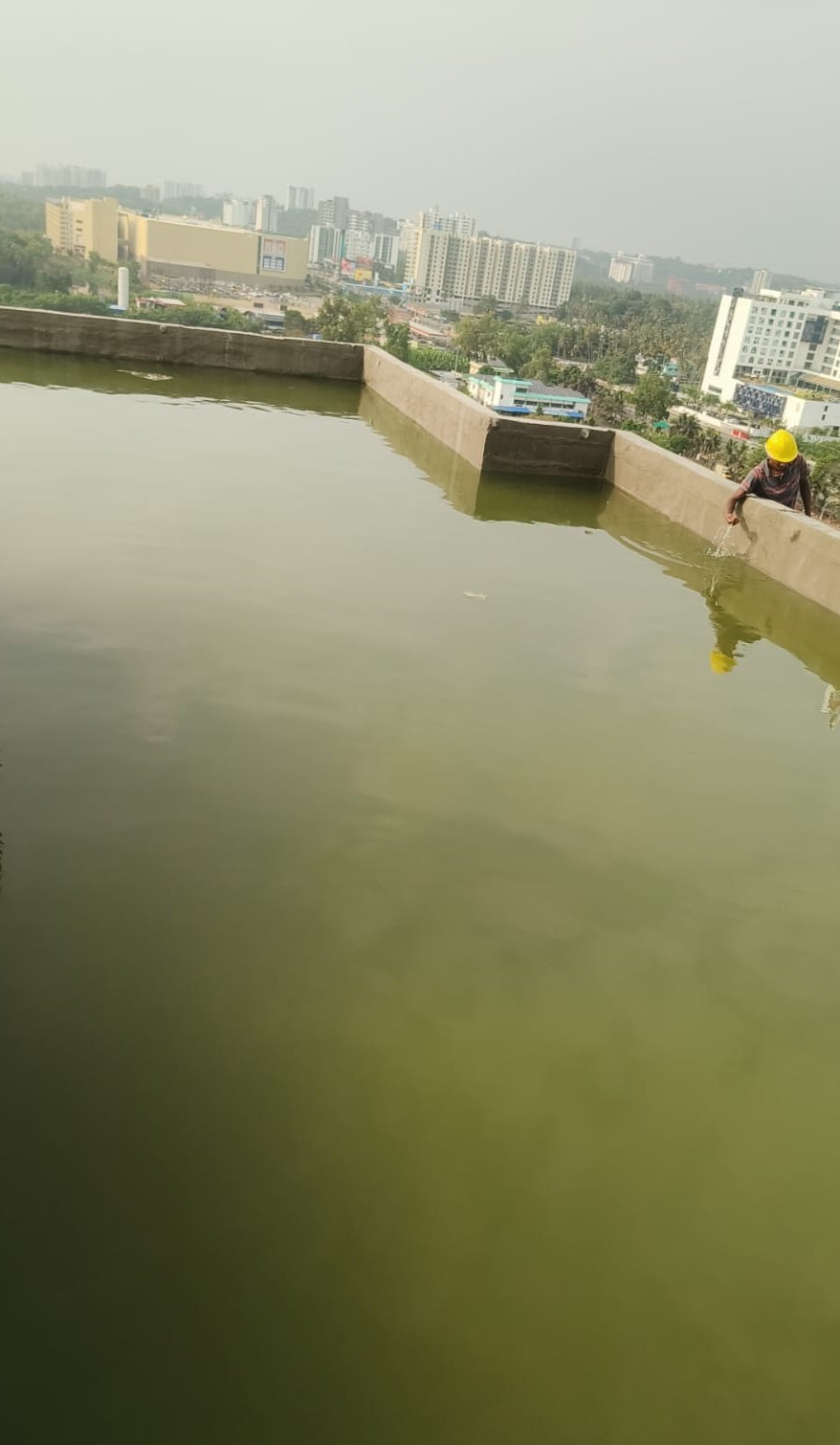

  • Common Area Waterproofing (WT, UG Sump, STP, Swimming Pool, & Terrace) – 100% Completed
  • Main Lobby Flooring Work – 98% Completed
  • Reticulated Gas Pipeline Work – 100% Completed
  • Sanitary Ware & CP Fittings Fixing – 81/92 Apartments Completed
  • Switches Fixing – 88/92 Apartments Completed
  • Gym, Women’s Club, Recreation Area – 1st Coat Painting Completed
  • Tennis Court, Badminton Court, Amphitheatre Work – 70% Completed
  • Gym, Women’s Club, Recreation Area – 1st Coat Painting Completed
  • Yard & Inside Road Paver Block Laying Work – 100% Completed
  • Mock-Ups (3D – 2BHK & 4B – 3BHK) – Ready to Visit

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 29.07.2024

  • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
  • RCC FOR WATER TANK, SWIMMING POOL, LIFT HEAD ROOM-100% COMPLETED
  • BLOCK WORK – 100% COMPLETED
  • CEILING PLASTERING- – 100% COMPLETED
  • INSIDE WALL PLASTERING – 93 APT OUT OF 93 APT COMPLETED
  • EXTERNAL WALL PLASTERING – 100% COMPLETED
  • WALL TILING – 92 APT OUT OF 93 APT COMPLETED
  • FLOOR TILING – 92 APT OUT OF 93 COMPLETED
  • LIFT ARCHITRAVE WORK – 15 FLOOR OUT OF 15 COMPLETED
  • PASSAGE FLOORING – 15 FLOOR OUT OF 15 COMPLETED
  • MAIN STAIR STEP TILE LAYING – 15FLOOR OUT OF 15 COMPLETED
  • FIRE STAIR STEP TILE LAYING – 15 FLOOR OUT OF 15 COMPLETED
  • WALL PUTTY WORK – 92 APT OUT 93 APT COMPLETED
  • WATERPROOFING OF TOILETS – 92 APT OUT OF 93 APT COMPLETED
  • WIRING COMPLETION – 92 OUT OF 93 COMPLETED
  • INTERNAL PLUMBING – 92 OUT OF 93 COMPLETED
  • BALCONY HANDRAIL FIXING – 93 OUT OF 93 COMPLETED
  • DOOR SHUTTER FIXING – 88 OUT OF 93 COMPLETED
  • UPVC DOORS FIXING – 75 OUT OF 93 COMPLETED
  • UPVC WINDOWS FIXING – 92 OUT OF 93 COMPLETED
  • 1ST COAT INSIDE WALL PAINTING – 34 OUT OF 93 COMPLETED
  • EXTERNAL WALL PRIMER PAINTING 1ST COAT – 100% COMPLETED, PRIMER PAINTING 2ND COAT – 100% COMPLETED
  • PLUMBING WORK IN DUCTS – 36 OUT OF 36 COMPLETED
  • WINDOW GRILL FIXING – 92 OUT OF 93 COMPLETED
  • ELECTRICAL HT WORK – 98% COMPLETED
  • LIFT ERECTION – 100% COMPLETED
  • RCC FOR UG SUMP – 100% COMPLETED
  • RCC FOR STP – 100% COMPLETED
  • FIRE FIGHTING WORK – 100% COMPLETED
  • COMMON AREA WATER PROOF IN WT, UG SUMP,STP, S.POOL & TERRACE-100% COMPLETED
  • MAIN LOBBY FLOORING WORK – 95% COMPLETED
  • RETICULATED GAS PIPE LINE WORK – 100 % COMPLETED

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 25.03.2024

  • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
  • RCC FOR WATER TANK, SWIMMING POOL, LIFT HEAD ROOM-100% COMPLETED
  • BLOCK WORK – 100% COMPLETED
  • CEILING PLASTERING – 100% COMPLETED
  • INSIDE WALL PLASTERING – 93 APT OUT OF 93 APT COMPLETED
  • EXTERNAL WALL PLASTERING – 99% COMPLETED
  • WALL TILING – 92 APT OUT OF 93 APT COMPLETED
  • FLOOR TILING – 91 APT OUT OF 93 COMPLETED
  • LIFT ARCHITRAVE WORK – 12 FLOOR OUT OF 15 COMPLETED
  • PASSAGE FLOORING – 12 FLOOR OUT OF 15 COMPLETED
  • MAIN STAIR STEP TILE LAYING – 10 FLOOR OUT OF 15 COMPLETED
  • FIRE STAIR STEP TILE LAYING – 10 FLOOR OUT OF 15 COMPLETED
  • WALL PUTTY WORK – 92 APT OUT 93 APT COMPLETED
  • WATERPROOFING OF TOILETS – 92 APT OUT OF 93 APT COMPLETED
  • WIRING COMPLETION – 92 OUT OF 93 COMPLETED
  • INTERNAL PLUMBING – 92 OUT OF 93 COMPLETED
  • BALCONY HANDRAIL FIXING – 93 OUT OF 93 COMPLETED
  • DOOR SHUTTER FIXING – 62 OUT OF 93 COMPLETED
  • UPVC DOORS FIXING- 75 OUT OF 93 COMPLETED
  • UPVC WINDOWS FIXING – 92OUT OF 93 COMPLETED
  • 1ST COAT INSIDE WALL PAINTING – 4 OUT OF 93 COMPLETED
  • EXTERNAL WALL PRIMER PAINTING 1ST COAT – 100% COMPLETED, PRIMER PAINTING 2ND COAT – 100% COMPLETED
  • PLUMBING WORK IN DUCTS – 36 OUT OF 36 COMPLETED
  • WINDOW GRILL FIXING – 91 OUT OF 93 COMPLETED.
  • ELECTRICAL HT WORK – 90% COMPLETED
  • LIFT ERECTION – (2 LIFTS – 100% & OTHER 2 LIFTS- 95% COMPLETED
  • RCC FOR UG SUMP – 100% COMPLETED
  • RCC FOR STP – 100% COMPLETED
  • FIRE FIGHTING WORK – 90% COMPLETED
  • COMMON AREA WATER PROOF IN WT, UG SUMP, STP, SWIMMING POOL & TERRACE – 100% COMPLETED

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 12.02.2024

      • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
      • RCC FOR WATER TANK, SWIMMING POOL, LIFT HEADROOM – 100% COMPLETED
      • BLOCK WORK – 100% COMPLETED
      • CEILING PLASTERING – 100% COMPLETED
      • INSIDE WALL PLASTERING – 93 APT OUT OF 93 APT COMPLETED
      • EXTERNAL WALL PLASTERING – 99% COMPLETED
      • WALL TILING – 88 APT OUT OF 93 APT COMPLETED
      • FLOOR TILING – 80 APT OUT OF 93 COMPLETED
      • LIFT ARCHITRAVE WORK – 8 FLOOR OUT OF 15 COMPLETED
      • PASSAGE FLOORING – 9 FLOOR OUT OF 15 COMPLETED
      • MAIN STAIR STEP TILE LAYING – 6 FLOOR OUT OF 15 COMPLETED
      • FIRE STAIR STEP TILE LAYING – 7 FLOOR OUT OF 15 COMPLETED
      • WALL PUTTY WORK – 92 APT OUT 93 APT COMPLETED
      • WATERPROOFING OF TOILETS – 92 APT OUT OF 93 APT COMPLETED
      • WIRING COMPLETION – 92 OUT OF 93 COMPLETED
      • INTERNAL PLUMBING – 92 OUT OF 93 COMPLETED
      • BALCONY HANDRAIL FIXING – 93 OUT OF 93 COMPLETED
      • DOOR SHUTTER FIXING – 33 OUT OF 93 COMPLETED
      • UPVC DOORS FIXING – 60 OUT OF 93 COMPLETED
      • UPVC WINDOWS FIXING – 92 OUT OF 93 COMPLETED
      • 1ST COAT INSIDE WALL PAINTING – 4 OUT OF 93 COMPLETED
      • EXTERNAL WALL PRIMER PAINTING 1ST COAT – 100% COMPLETED, PRIMER PAINTING 2ND COAT – 30% COMPLETED
      • PLUMBING WORK IN DUCTS – 36 OUT OF 36 COMPLETED
      • WINDOW GRILL FIXING – 88 OUT OF 93 COMPLETED.

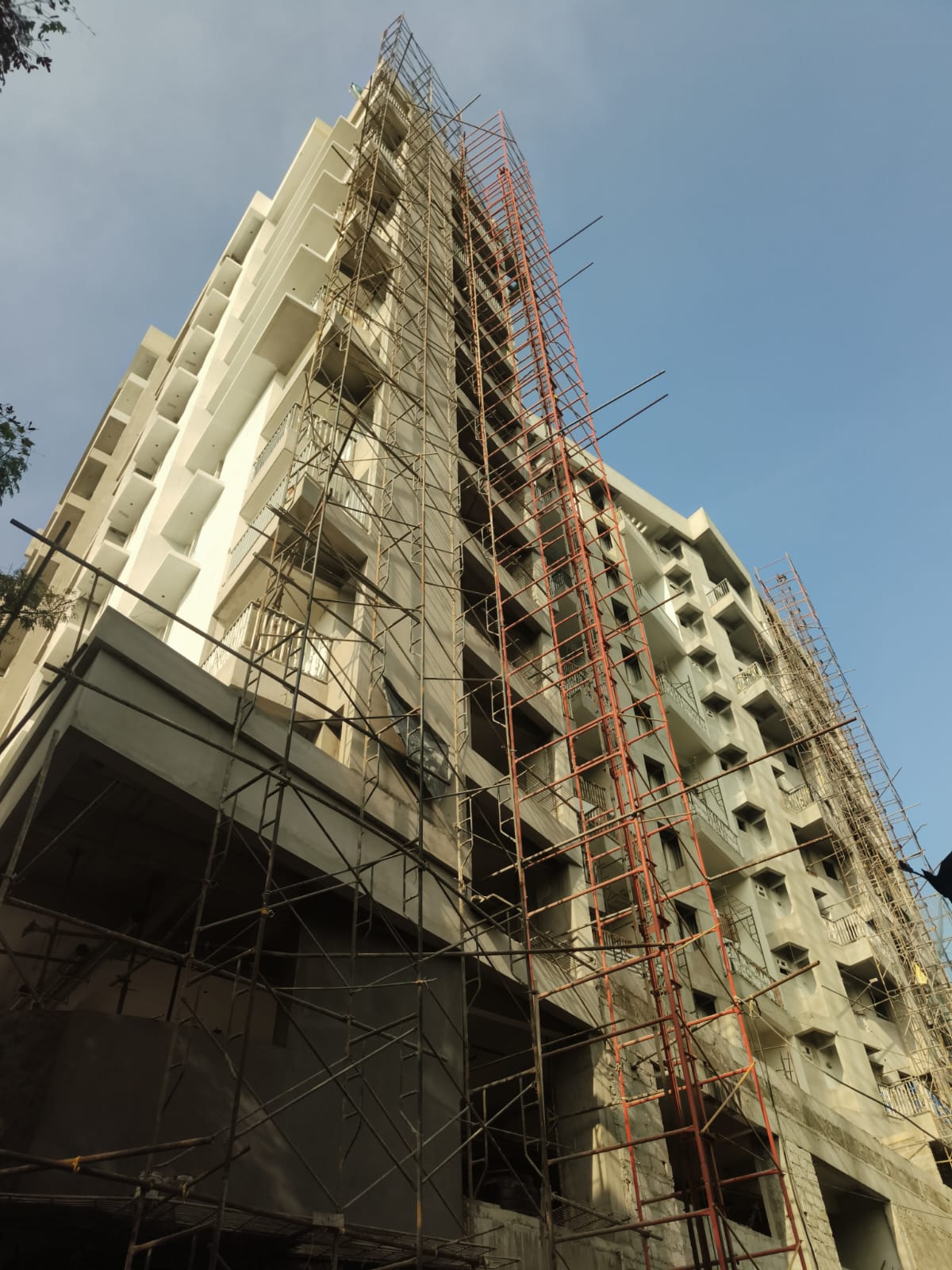

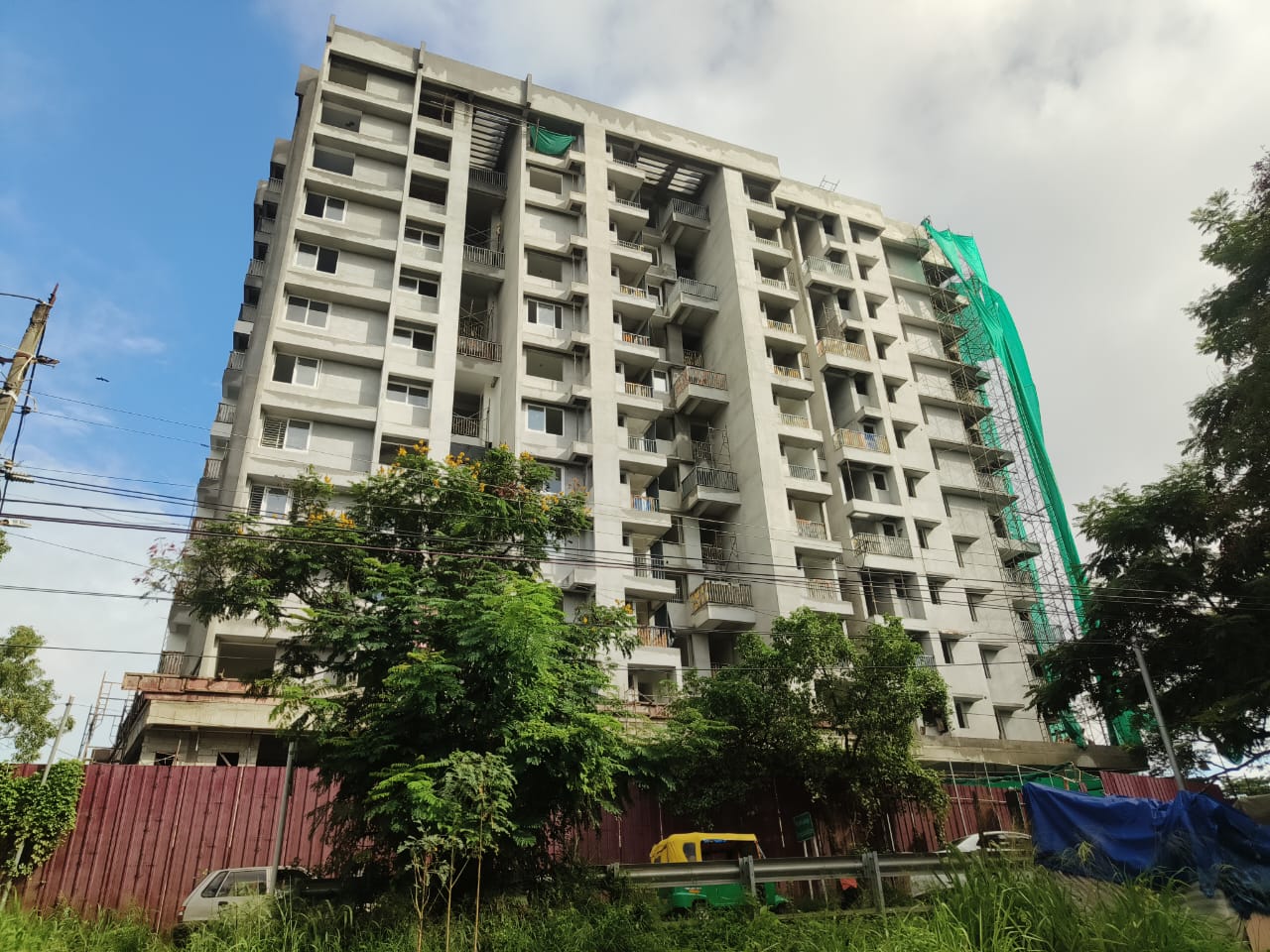

      • ELECTRICAL HT WORK – 90% COMPLETED

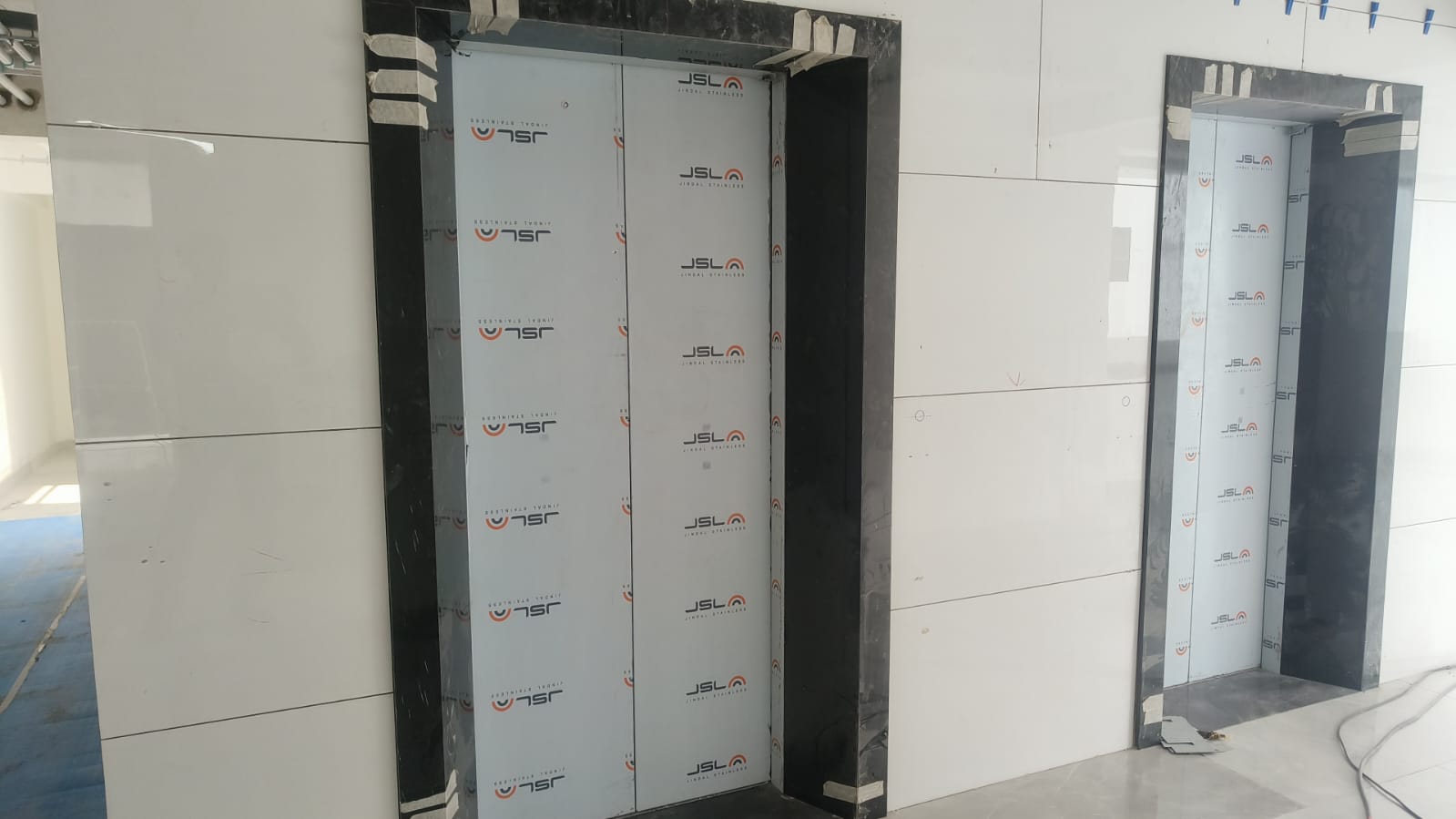

      • LIFT ERECTION – (2 LIFTS – 100% & OTHER 2 LIFTS – 80% COMPLETED
      • RCC FOR UG SUMP – 100% COMPLETED
      • RCC FOR STP – 100% COMPLETED
      • FIRE FIGHTING WORK – 90% COMPLETED
      • COMMON AREA WATER PROOF IN WT, UG SUMP, STP, SWIMMING POOL & TERRACE – 90% COMPLETED

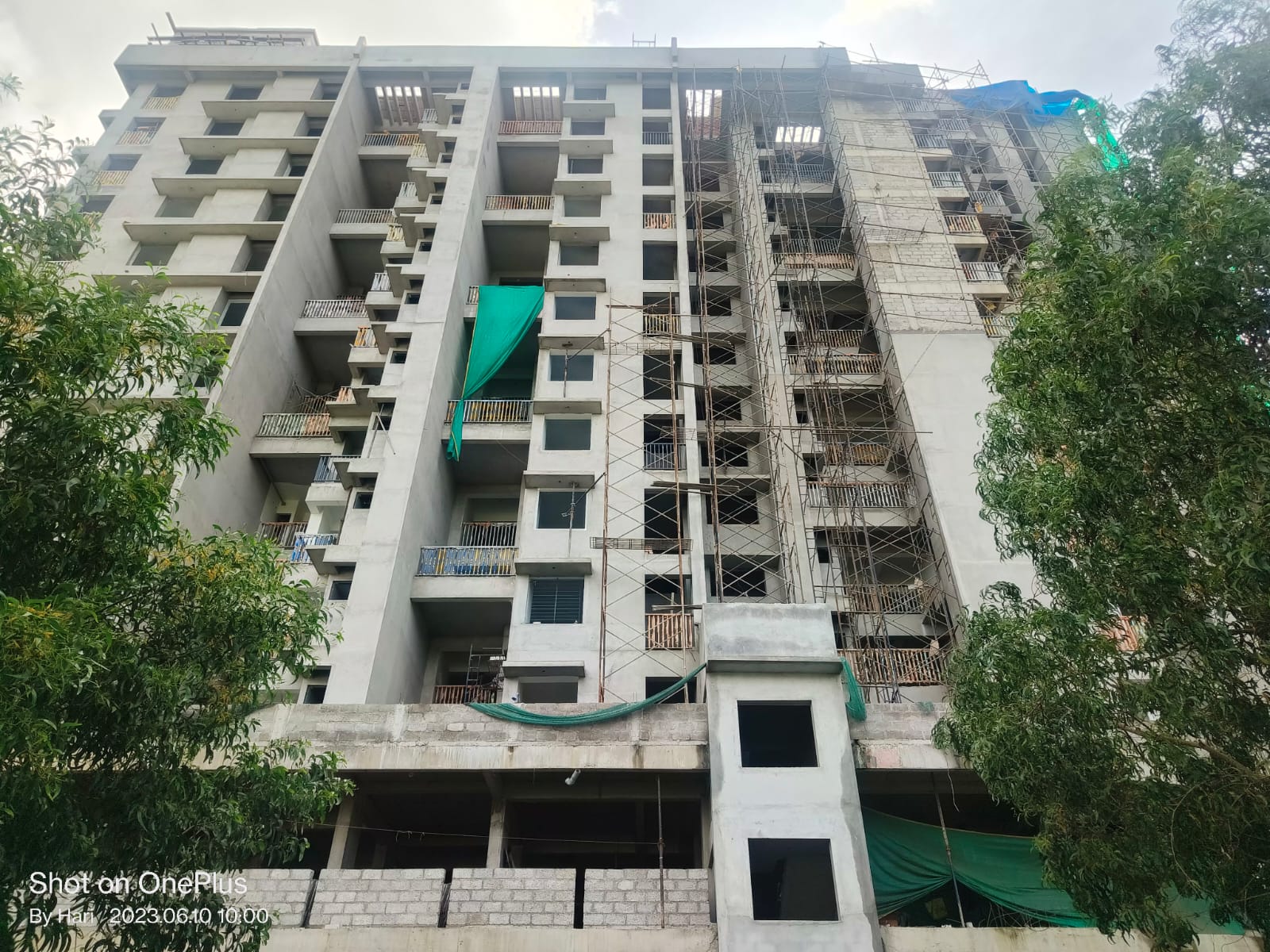

      • MOCK UP APTS – 3D & 4B: READY FOR VISIT

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 30.12.2023

      • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED

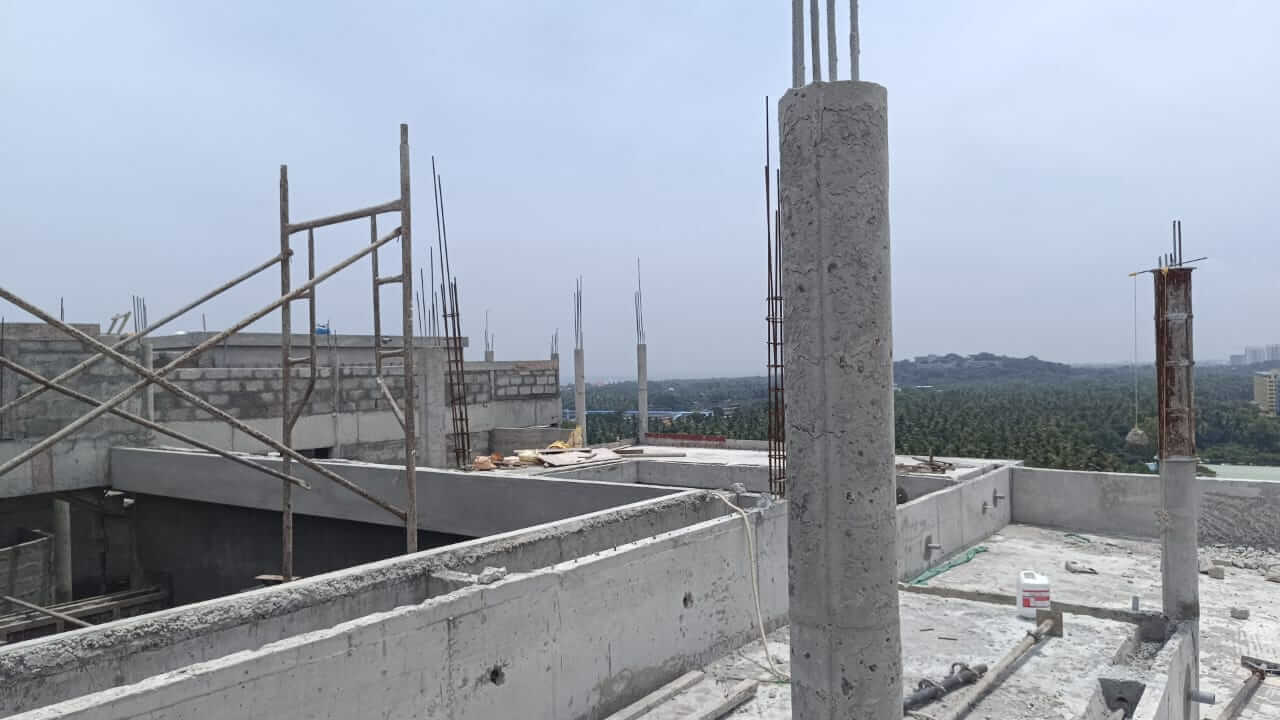

      • RCC FOR WATER TANK, SWIMMING POOL, LIFT HEAD ROOM – 100% COMPLETED
      • BLOCK WORK GROUND, 1ST, 2ND, 3RD, 4TH, 5TH, 6TH, 7TH, 8TH, 9TH, 10TH, ,11TH, & 12TH FLOOR – 100% COMPLETED
      • CEILING PLASTERING – 2ND, 3RD, 4TH, 5TH, 6TH, 7TH, 8TH, 9TH, 10TH, 11TH & 12TH FLOOR – 100% COMPLETED
      • INSIDE WALL PLASTERING – 93 OUT OF 93 APTS COMPLETED
      • EXTERNAL WALL PLASTERING – 99% COMPLETED
      • WALL TILING – 87 APT OUT OF 93 APT COMPLETED
      • FLOOR TILING – 70 APT OUT OF 93 COMPLETED
      • LIFT ARCHITRAVE WORK – 5 FLOOR OUT OF 15 COMPLETED

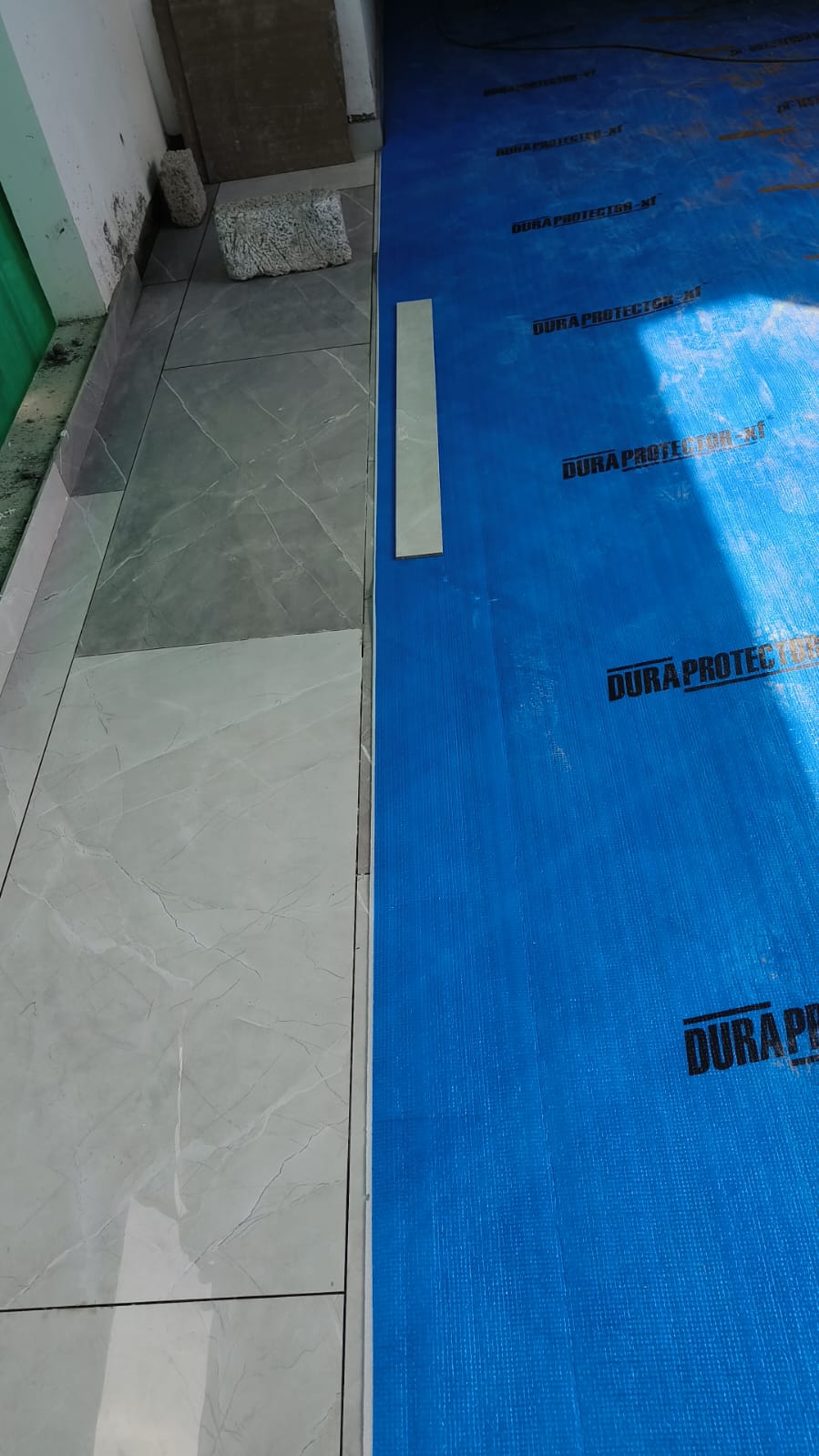

      • PASSAGE FLOORING – 8 FLOOR OUT OF 15 COMPLETED
      • WALL PUTTY WORK – 92 APT OUT 93 APT COMPLETED
      • WATERPROOFING OF TOILETS – 92 APT OUT OF 93 APT COMPLETED
      • WIRING COMPLETION – 92 OUT OF 93 COMPLETED
      • INTERNAL PLUMBING – 92 OUT OF 93 COMPLETED
      • BALCONY HANDRAIL FIXING – 93 OUT OF 93 COMPLETED
      • DOOR SHUTTER FIXING – 15 OUT OF 93 COMPLETED
      • UPVC DOORS FIXING – 57 OUT OF 93 COMPLETED
      • UPVC WINDOWS FIXING – 87 OUT OF 93 COMPLETED
      • WINDOW GRILL FIXING – 77 OUT OF 93 COMPLETED
      • 1ST COAT INSIDE WALL PAINTING – 2 OUT OF 93 COMPLETED
      • PLUMBING WORK IN DUCTS – 34 OUT OF 37 COMPLETED
      • WINDOW GRILL FIXING – 32 OUT OF 93 COMPLETED.

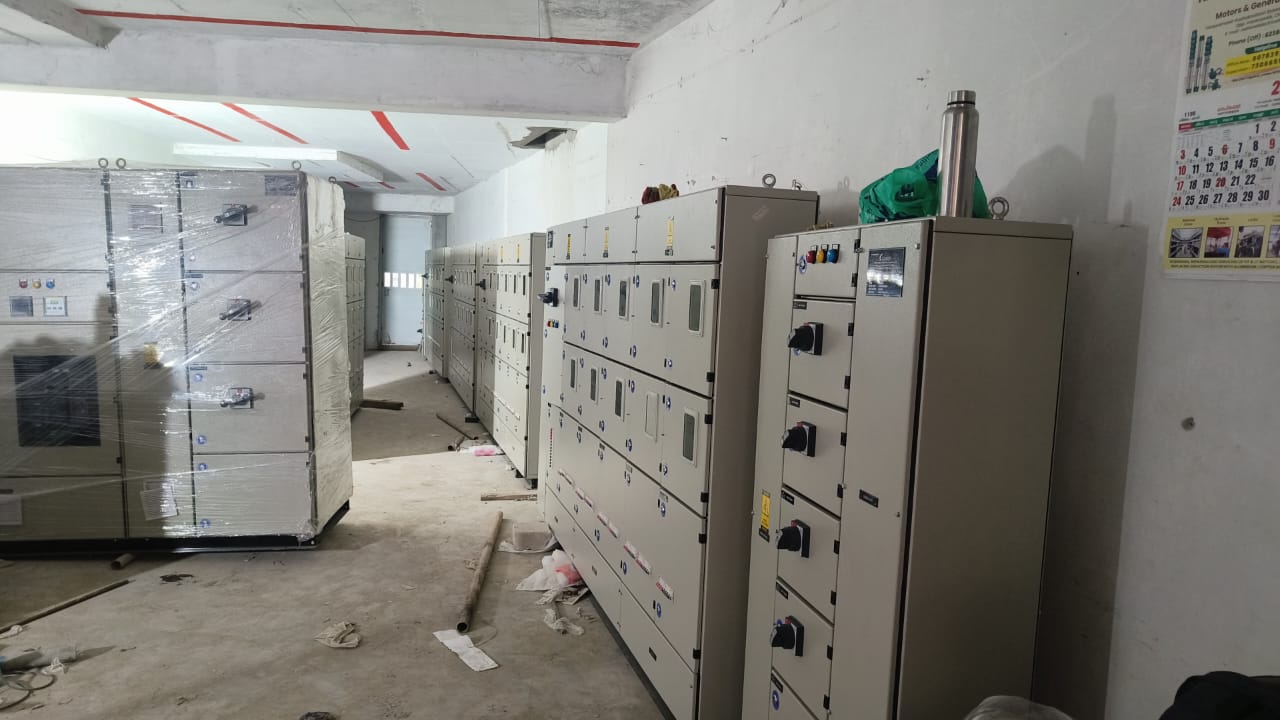

      • ELECTRICAL HT WORK – 75% COMPLETED
      • LIFT ERECTION – MATERIAL DELIVERED – 100%, ERECTION – 75% COMPLETED
      • RCC FOR UG SUMP – 100% COMPLETED
      • RCC FOR STP – 100% COMPLETED
      • FIRE FIGHTING WORK – 50% COMPLETED

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 24.11.2023

      • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
      • RCC FOR WATER TANK, SWIMMING POOL, LIFT HEAD ROOM – 100% COMPLETED
      • BLOCK WORK GROUND FLOOR – 1ST,2ND ,3RD, 4TH, 5TH 6TH 7TH 8TH 9TH 10TH ,11TH & 12 TH FLOOR – 100% COMPLETED
      • CEILING PLASTERING – 2ND,3RD,4TH 5TH 6TH, 7TH,8TH 9TH,10TH, 11TH & 12TH FLOOR – 100% COMPLETED
      • INSIDE WALL PLASTERING – 93 OUT OF 93 APT COMPLETED
      • EXTERNAL WALL PLASTERING – 99% COMPLETED
      • WALL TILING – 87 OUT OF 93 APT COMPLETED
      • FLOOR TILING – 64 OUT OF 93 COMPLETED
      • LIFT ARCHITRAVE WORK – 1 FLOOR OUT OF 15 COMPLETED
      • PASSAGE FLOORING – 1 FLOOR OUT OF 15 COMPLETED
      • WALL PUTTY WORK – 92 OUT 93 APT COMPLETED
      • WATERPROOFING OF TOILETS – 92 OUT OF 93 APT COMPLETED
      • WIRING COMPLETION – 92 OUT OF 93 COMPLETED
      • INTERNAL PLUMBING – 92 OUT OF 93 COMPLETED

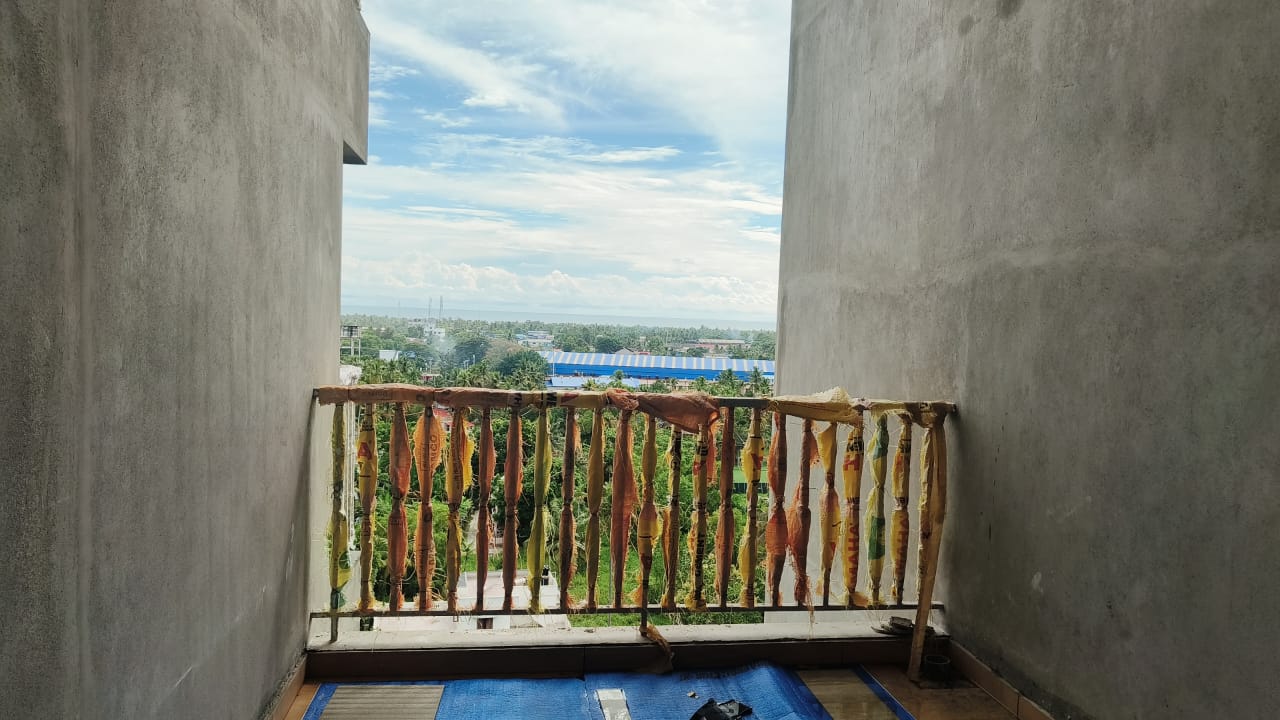

      • BALCONY HANDRAIL FIXING – 92 OUT OF 93 COMPLETED
      • DOOR SHUTTER FIXING – 2 OUT OF 93 COMPLETED
      • UPVC DOORS FIXING – 42 OUT OF 93 COMPLETED
      • UPVC WINDOWS FIXING – 83 OUT OF 93 COMPLETED
      • 1ST COAT INSIDE WALL PAINTING – 2 OUT OF 93 COMPLETED
      • PLUMBING WORK IN DUCTS – 32 OUT OF 37 COMPLETED
      • WINDOW GRILL FIXING – 56 OUT OF 93 COMPLETED.
      • ELECTRICAL HT WORK – 70% COMPLETED
      • LIFT ERECTION; MATERIAL DELIVERED – 100%, ERECTION –50% COMPLETED
      • RCC FOR UG SUMP – 100% COMPLETED
      • RCC FOR STP – 100% COMPLETED
      • FIRE FIGHTING WORK – 60% COMPLETED
      • MOCK UP – APARTMENT 3D – READY FOR VISITAdd content – use ENTER key for new LI line.

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 25.09.2023

      • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
      • RCC FOR WATER TANK, SWIMMING POOL, LIFT HEAD ROOM-100% COMPLETED
      • BLOCK WORK GF, 1ST, 2ND ,3RD, 4TH, 5TH 6TH 7TH 8TH 9TH 10TH ,11TH & 12 TH FLOOR – 100% COMPLETED
      • CEILING PLASTERING- 2ND,3RD,4TH 5TH 6TH, 7TH,8TH 9TH,10TH, 11TH & 12TH FLOOR – 100% COMPLETED
      • INSIDE WALL PLASTERING – 92 APT OUT OF 93 APT COMPLETED
      • EXTERNAL WALL PLASTERING – 95% COMPLETED
      • WALL TILING – 85 APT OUT OF 93 APT COMPLETED
      • FLOOR TILING – 51 APT OUT OF 93 COMPLETED
      • WALL PUTTY WORK – 92 APT OUT 93 APT COMPLETED
      • WATERPROOFING OF TOILETS – 92 APT OUT OF 93 APT COMPLETED
      • WIRING COMPLETION -72 OUT OF 93 COMPLETED
      • INTERNAL PLUMBING – 92 OUT OF 93 COMPLETED
      • BALCONY HANDRAIL FIXING – 100% COMPLETED
      • DOOR SHUTTER FIXING – 2 OUT OF 93 COMPLETED
      • UPVC DOORS FIXING – 24 OUT OF 93 COMPLETED
      • UPVC WINDOWS FIXING – 40 OUT OF 93 COMPLETED
      • 1ST COAT INSIDE WALL PAINTING – 2 OUT OF 93 COMPLETED
      • PLUMBING WORK IN DUCTS – 11 OUT OF 37 COMPLETED
      • WINDOW GRILL FIXING – 17 OUT OF 93 COMPLETED.
      • ELECTRICAL HT WORK – 40% COMPLETED
      • LIFT ERECTION – MATERIAL DELIVERED -100%, ERECTION -30% COMPLETED
      • RCC FOR UG SUMP – 100% COMPLETED
      • RCC FOR STP – 100% COMPLETED

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 11.08.2023

      • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
      • RCC FOR WATER TANK, SWIMMING POOL, LIFT HEAD ROOM-100% COMPLETED
      • BLOCK WORK 2ND ,3RD, 4TH, 5TH 6TH 7TH 8TH 9TH 10TH &11TH FLOOR – 100% COMPLETED
      • BLOCK WORK 12TH FLOOR – 100% COMPLETED
      • CEILING PLASTERING- 2ND,3RD,4TH 5TH 6TH, 7TH,8TH 9TH,10TH, 11TH & 12TH FLOOR – 100% COMPLETED
      • INSIDE WALL PLASTERING – 92 APT OUT OF 93 APT COMPLETED
      • EXTERNAL WALL PLASTERING – 73% COMPLETED
      • WALL TILING – 79 APT OUT OF 93 APT COMPLETED
      • FLOOR TILING – 31 APT OUT OF 93 COMPLETED
      • WALL PUTTY WORK – 84 APT OUT 93 APT COMPLETED
      • WATERPROOFING OF TOILETS – 91 APT OUT OF 93 APT COMPLETED
      • WIRING COMPLETION – 66 OUT OF 93 COMPLETED
      • INTERNAL PLUMBING – 91 OUT OF 93 COMPLETED
      • BALCONY HANDRAIL FIXING – 84 OUT OF 93 COMPLETED
      • DOOR SHUTTER FIXING – 2 OUT OF 93 COMPLETED
      • UPVC DOORS & WINDOWS FIXING – 18 OUT OF 93 COMPLETED
      • 1ST COAT INSIDE WALL PAINTING – 2 OUT OF 93 COMPLETED
      • PLUMBING WORK IN DUCTS – 9 OUT OF 37 COMPLETED
      • WINDOW GRILL FIXING – 4 OUT OF 93 COMPLETED.
      • ELECTRICAL HT WORK – STARTED
      • LIFT ERECTION – MATERIAL DELIVERED, ELECTION STARTED
      • RCC FOR UG SUMP – 100% COMPLETED
      • RCC FOR STP – 60% COMPLETED

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 14.06.2023

      • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
      • RCC FOR WATER TANK, SWIMMING POOL, LIFT HEAD ROOM – 100% COMPLETED
      • BLOCK WORK 2ND, 3RD, 4TH, 5TH, 6TH, 7TH, 8TH, 9TH, 10TH, &11TH, FLOOR – 100% COMPLETED
      • BLOCK WORK 12TH FLOOR – 100% COMPLETED
      • CEILING PLASTERING – 2ND,3RD,4TH 5TH, 6TH, 7TH,8TH 9TH,10TH, 11TH & 12TH FLOOR – 100% COMPLETED
      • INSIDE WALL PLASTERING – 91 APT OUT OF 93 APT COMPLETED
      • EXTERNAL WALL PLASTERING – 60% COMPLETED
      • WALL TILING – 59 OUT OF 93 APT COMPLETED
      • FLOOR TILING – 20 OUT OF 93 COMPLETED
      • WALL PUTTY WORK – 47 OUT 93 APT COMPLETED
      • WATERPROOFING OF TOILETS – 78 OUT OF 93 APT COMPLETED
      • WALL PUTTY WORK – 42 OUT 95 APARTMENTS COMPLETED
      • WIRING COMPLETION – 39 OF 93 COMPLETED
      • INTERNAL PLUMBING – 86 OUT OF 93 COMPLETED
      • BALCONY HANDRAIL FIXING – 90 OUT OF 93 COMPLETED
      • DOOR SHUTTER FIXING – 2 OUT OF 93 COMPLETED

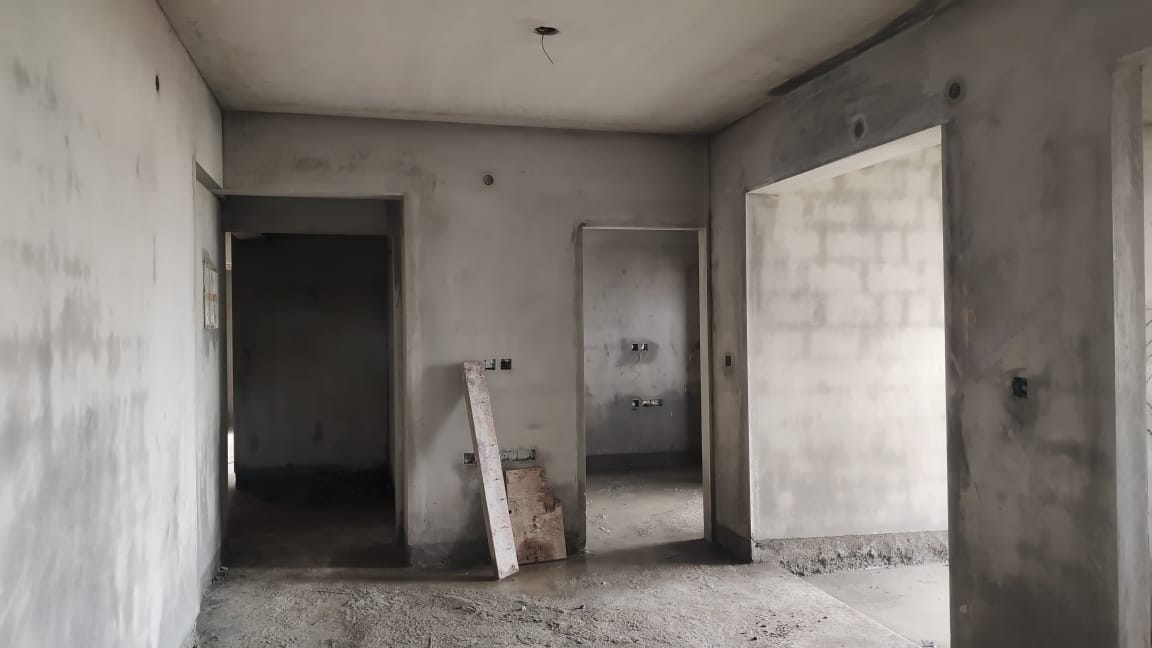

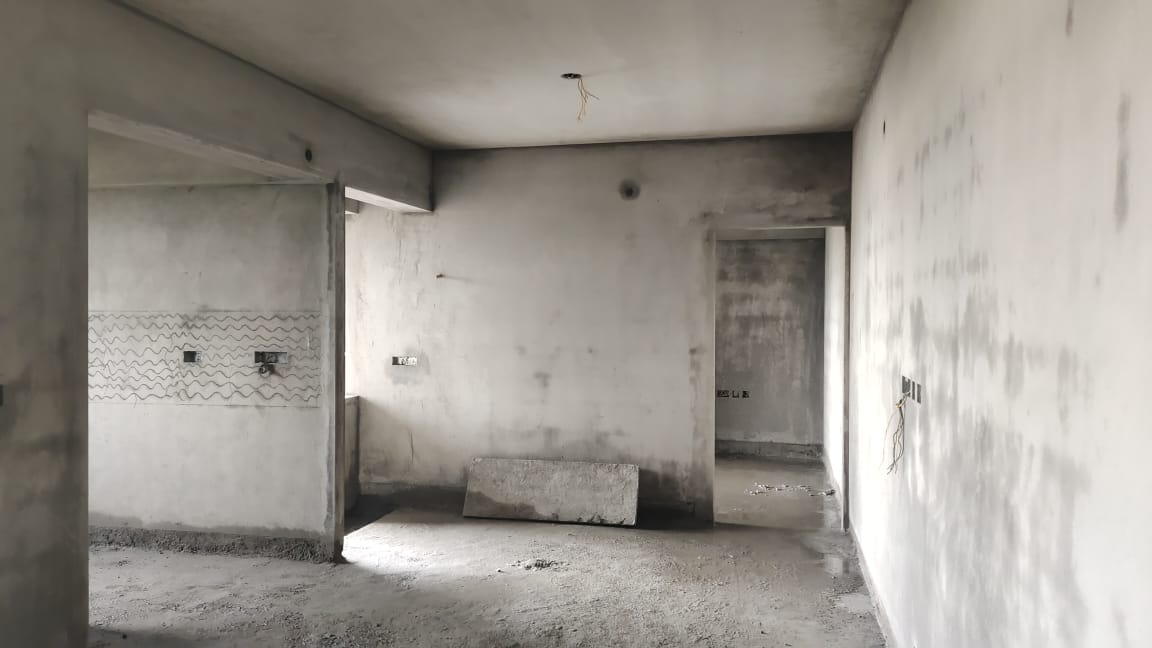

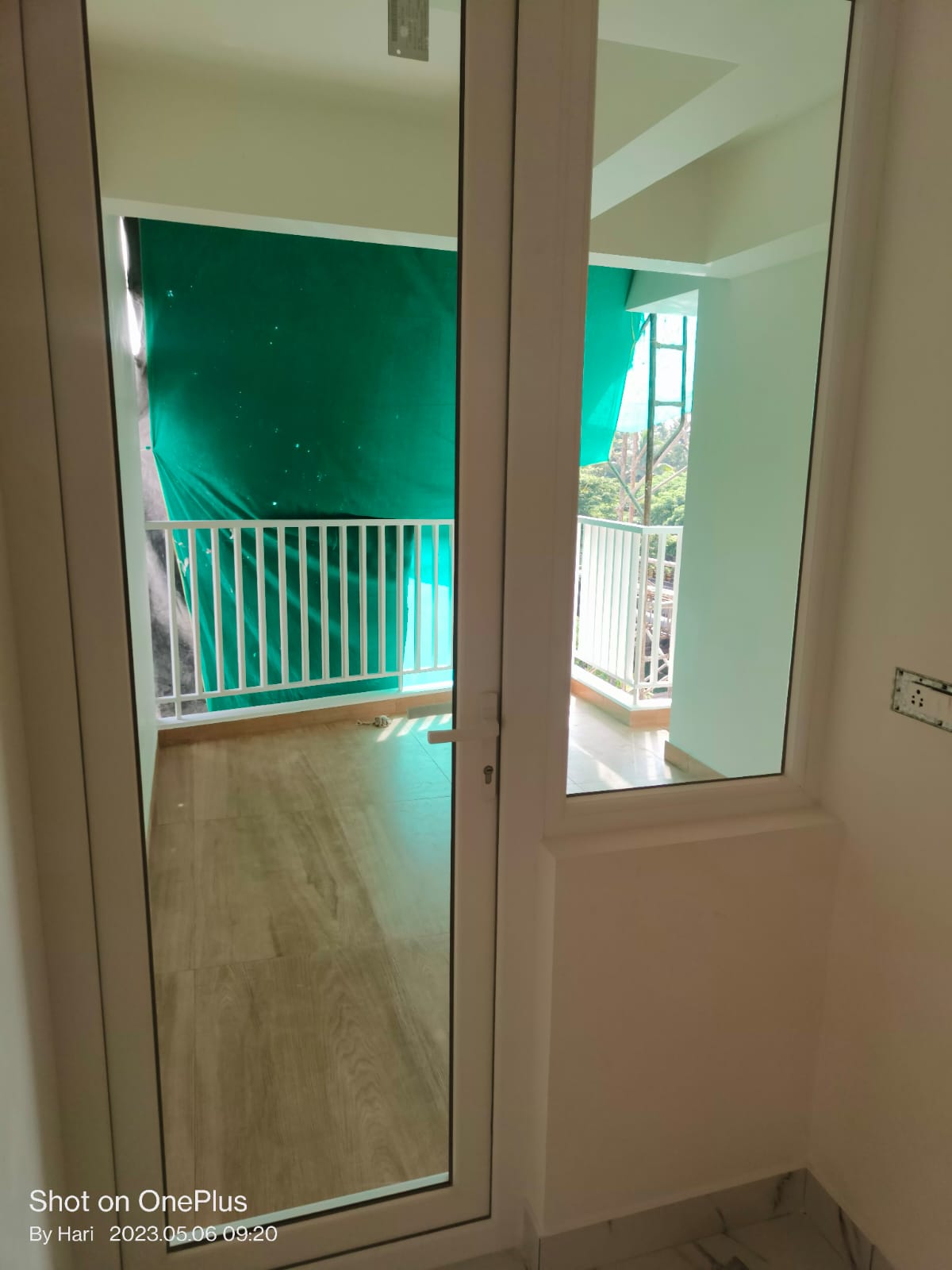

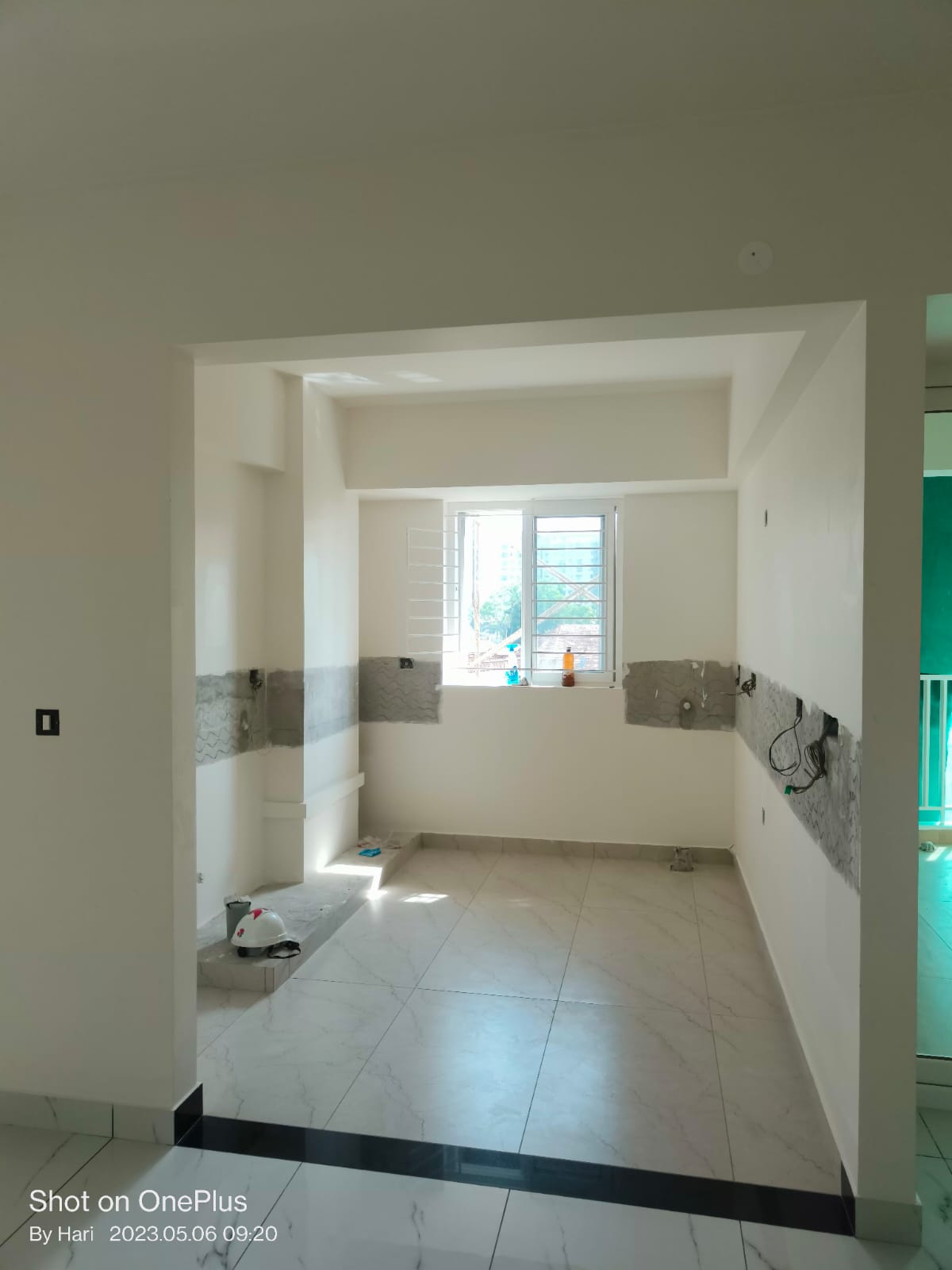

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 06.05.2023

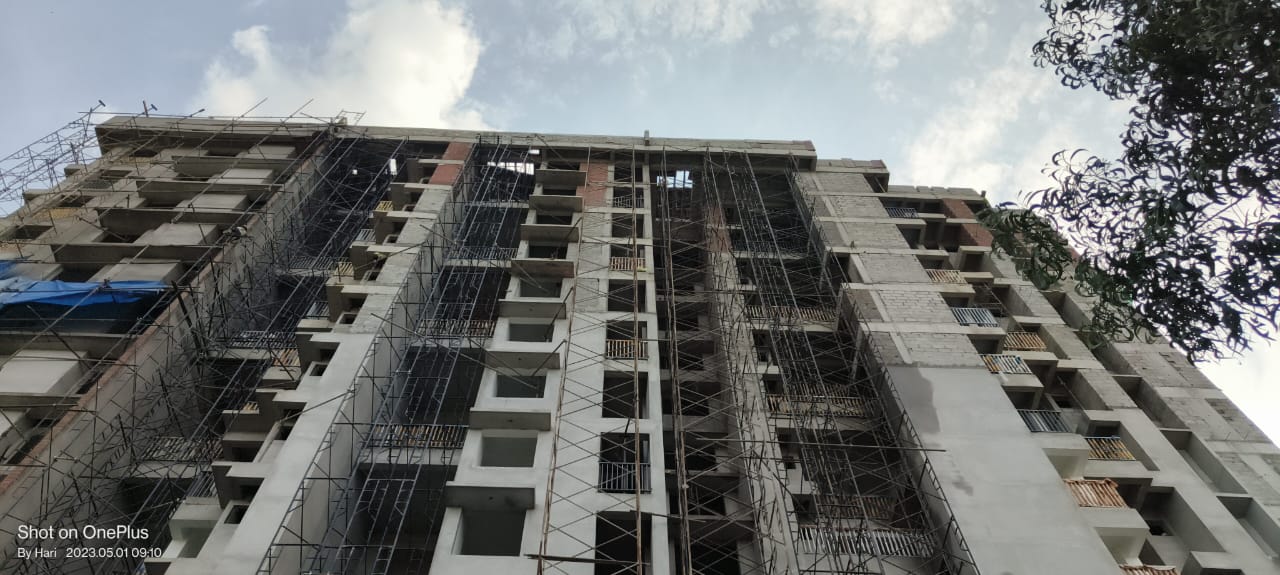

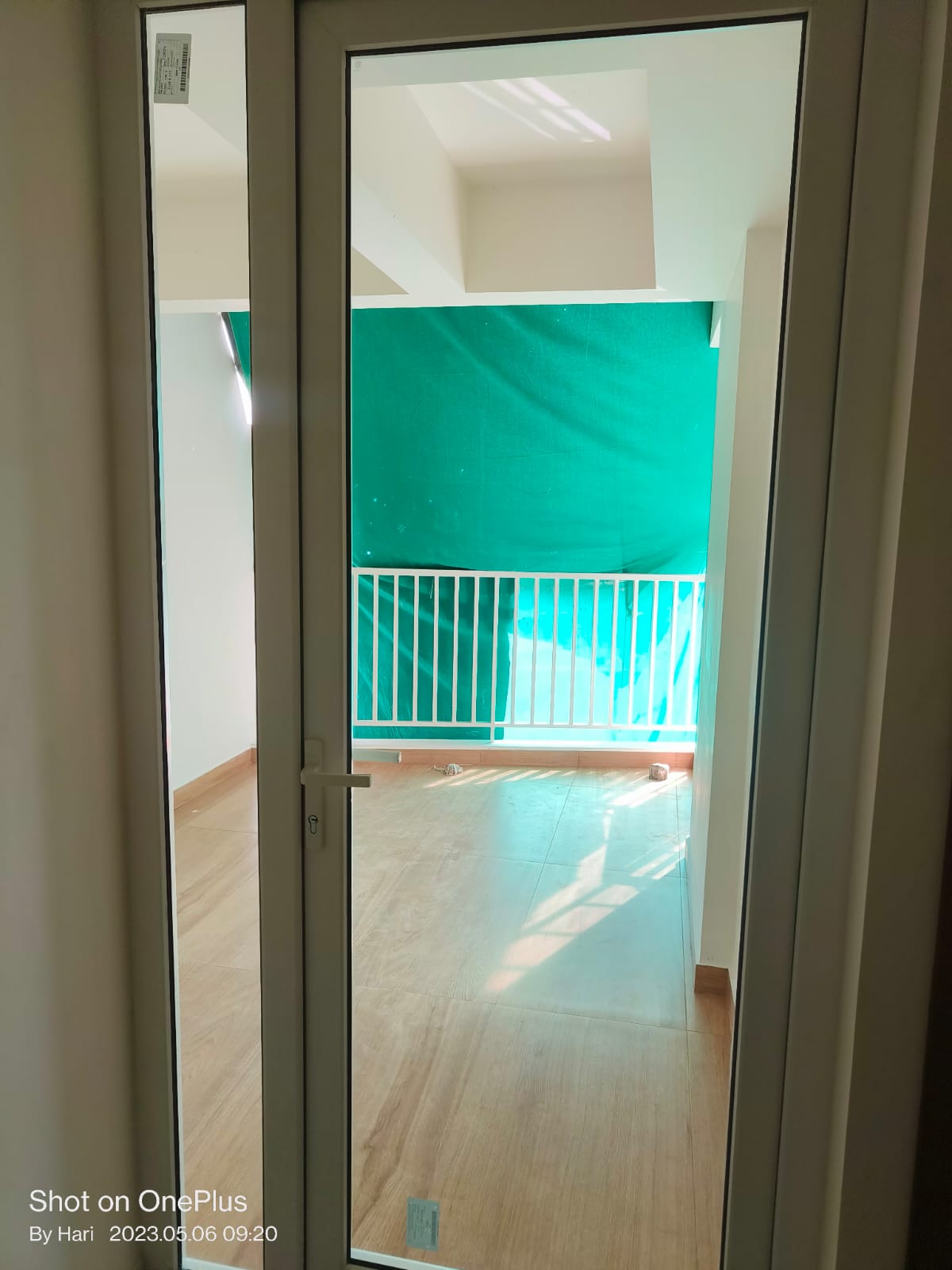

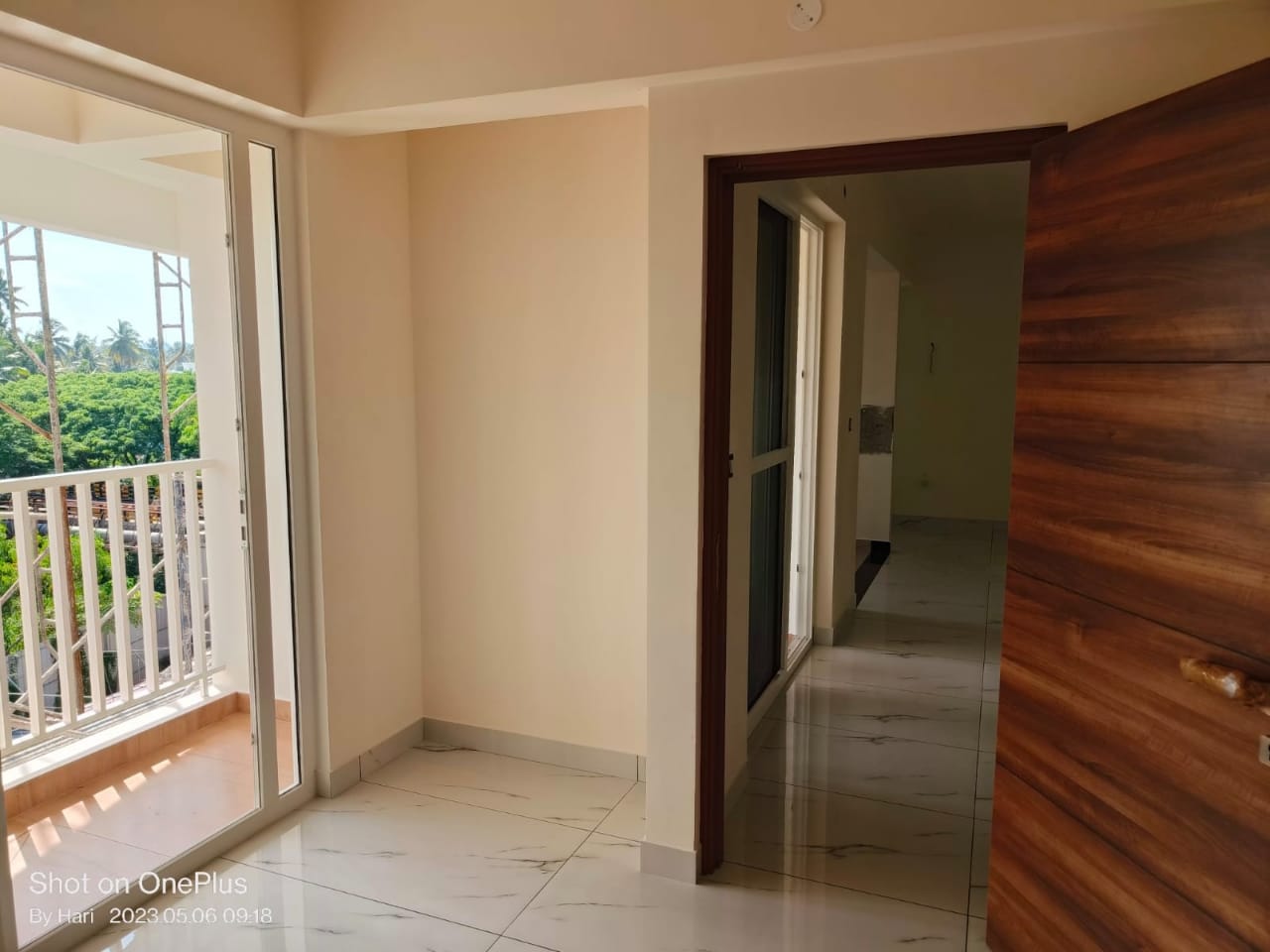

      • RCC FOR ROOF TERRACE SLAB – 100% COMPLETED
      • RCC COLUMN TERRACE FLOOR TO WATER TANK BASE SLAB-100% COMPLETED
      • FORM WORK FOR WATER TANK FLOOR/ASSOCIATION HALL ROOF SLAB -100% COMPLETED
      • STEEL WORK FOR WATER TANK FLOOR/ASSOCIATION HALL ROOF SLAB-100% COMPLETED
      • BLOCK WORK 2ND ,3RD, 4TH, 5TH 6TH 7TH 8TH 9TH 10TH &11TH FLOOR – 100% COMPLETED

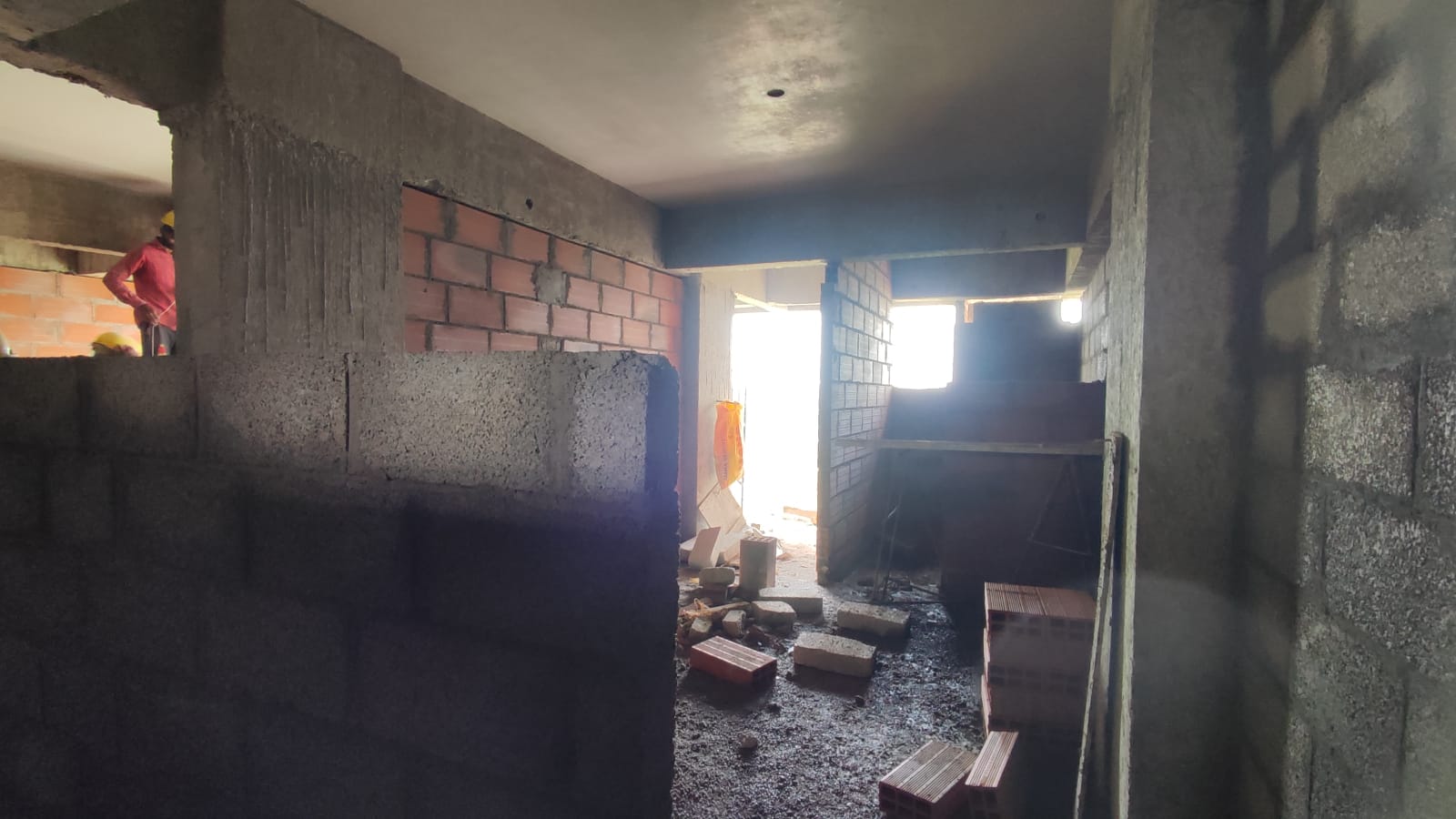

      • BLOCK WORK 12TH FLOOR – 70% COMPLETED
      • CEILING PLASTERING – 2ND,3RD,4TH, 5TH 6TH, 7TH,8TH 9TH,10TH, 11TH & 12TH FLOOR – 100% COMPLETED
      • INSIDE WALL PLASTERING – 84 OUT OF 95 APARTMENTS COMPLETED
      • EXTERNAL WALL PLASTERING – 50% COMPLETED
      • WALL TILING – 44 OUT OF 95 APARTMENTS COMPLETED
      • FLOOR TILING – 7 OUT OF 95 APARTMENTS COMPLETED
      • WALL PUTTY WORK – 42 OUT 95 APARTMENTS COMPLETED
      • WATERPROOFING OF TOILETS – 61 OUT OF 95 APARTMENTS COMPLETED
      • WIRING COMPLETION – 24 OUT OF 95 APARTMENTS COMPLETED
      • INTERNAL PLUMBING – 79 OUT OF 95 APARTMENTS COMPLETED
      • BALCONY HANDRAIL FIXING – 80 OUT OF 95 APARTMENTS COMPLETED

PROJECT STATUS REPORT OF PINK BY SREEDHANYA AS OF 18.03.2023

      • RCC FOR 11TH FLOOR ROOF SLAB – 100% COMPLETED
      • RCC COLUMN 12TH TO TERRACE FLOOR-100% COMPLETED
      • FORM WORK FOR 12TH FLOOR ROOF SLAB -90% COMPLETED
      • STEEL WORK FOR 12TH FLOOR ROOF SLAB-70% COMPLETED
      • RCC FOR 12TH FLOOR ROOF SLAB-60% COMPLETED
      • 2ND ,3RD, 4TH, 5TH 6TH 7TH 8TH 9TH 10TH &11TH FLOOR BLOCK WORK- 100% COMPLETED
      • CEILING PLASTERING- 2ND,3RD,4TH 5TH  6TH, 7TH,8TH 9TH,10TH & 11TH FLOOR-100% COMPLETED

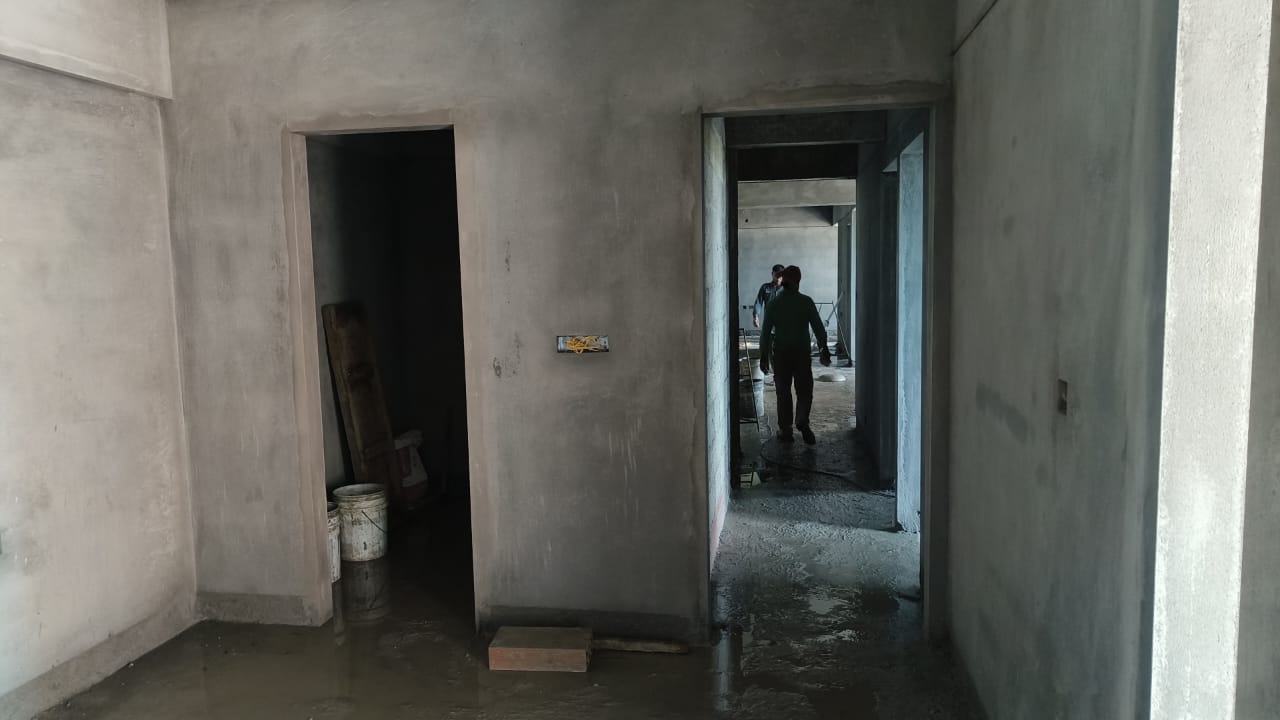

      • CEILING PLASTERING-12TH FLOOR- 30%COMPLETED
      • INSIDE WALL PLASTERING- 72 APT OUT OF 95 APT COMPLETED
      • EXTERNAL WALL PLASTERING -25% COMPLETED
      • WALL TILING – 32APT OUT OF 95 APT COMPLETED
      • FLOOR TILING- 5 APT OUT OF 95 COMPLETED
      • WALL PUTTY WORK – 29APT OUT 95 APT COMPLETED
      • WATERPROOFING OF TOILETS-42 APT OUT OF 95 APT COMPLETED

PROJECT STATUS REPORT OF PINK BY SREEDHANYA  AS ON 02.02.2023

      • RCC FOR 11H FLOOR ROOF SLAB – 100% COMPLETED
      • RCC COLUMN 12TH TO TERRACE FLOOR – 60% COMPLETED
      • FORM WORK FOR 12TH FLOOR ROOF SLAB – 30% COMPLETED
      • STEEL WORK FOR 12TH FLOOR ROOF SLAB – 10% COMPLETED
      • 2ND ,3RD, 4TH, 5TH 6TH 7TH 8TH &9TH FLOOR BLOCK WORK – 100% COMPLETED
      • CEILING PLASTERING – 2ND, 3RD, 4TH, 5TH, 6TH, 7TH, 8TH & 9TH FLOOR – 100% COMPLETED
      • CEILING PLASTERING -10TH FLOOR – 60% COMPLETED
      • INSIDE WALL PLASTERING – 55 APTs OUT OF 95 APTs COMPLETED
      • INSIDE WALL PLASTERING – 55 APTs OUT OF 95 APTs COMPLETED
      • WALL TILING – 7 APTs OUT OF 95 APTs COMPLETED
      • FLOOR TILING- 2 APTs OUT OF 95s COMPLETED
      • WALL PUTTY WORK – 18APTs OUT OF 95 APTs COMPLETED

PROJECT STATUS REPORT OF PINK BY SREEDHANYA  AS ON 20.12.2022

      • RCC FOR 10H FLOOR ROOF SLAB – 100% COMPLETED
      • RCC COLUMN 11TH TO 12TH FLOOR-60% COMPLETED
      • FORM WORK FOR 11TH FLOOR ROOF SLAB -50% COMPLETED
      • STEEL WORK FOR 11TH FLOOR ROOF SLAB-20% COMPLETED
      • 2ND ,3RD , 4TH, 5TH 6TH &7TH FLOOR BLOCK WORK- 100% COMPLETED
      • CEILING PLASTERING- 2ND,3RD,4TH 5TH  6TH, 7TH &8TH FLOOR-100% COMPLETED
      • CEILING PLASTERING-9TH FLOOR- 56 %COMPLETED
      • INSIDE WALL PLASTERING- 38 APT / OUT OF 95 APT COMPLETED
      • EXTERNAL WALL PLASTERING -15% COMPLETED
      • WALL TILING STARTED IN SAMPLE FLAT
      • WALL PUTTY WORK – 8 APT/ OUT 95 APT COMPLETED

    Contact Us

    Our Other Projects

    Sree DhanyaAnklets
    Kudappanakunnu, Trivandrum
    Sree DhanyaGreece Gardens
    NEW LAUNCH- NEAR TECHNOPARK
    Sree Dhanya Planet X - Luxury Apartments in Trivandrum
    Sree DhanyaPlanet X
    Sreekariyam
    Sree Dhanya Apex - Luxury Flats in Trivandrum
    Sree DhanyaApex
    Vellayambalam
    Sree DhanyaA.I.
    KURAVANKONAM
    Sree DhanyaROME
    MUTTADA
    Sree Dhanya Vantage Point - Apartments in Trivandrum
    Sree DhanyaVantage Point
    Bakery Junction
    Sree DhanyaGRAFFITI
    NH BYPASS VENPALAVATTOM
    Sree Dhanya Homes La Maison - Apartments in Vazhuthacaud, Trivandrum
    Sree DhanyaLA MAISON
    VAZHUTHACAUD
    Sree DhanyaARC
    SASTHAMANGALAM
    Sree DhanyaPINK
    NH BYPASS NEAR LULU MALL
    Sree Dhanya La Poshe - Luxury Apartments in Vazhuthacaud, Trivandrum
    Sree DhanyaLa Poshe
    Vazhuthacaud
    Sree Dhanya Planet X - Luxury Apartments in Sreekariyam,Trivandrum
    Sree DhanyaHaven
    Ambalamukku
