Anklets
Anklets
BY SREEDHANYA HOMES
Anklets is a residential development located in the neighbourhood of Kudappanakunnu in the city of Trivandrum, India. The project developed by Sree Dhanya Builders offers a range of apartment options for potential residents, including 2 and 3 BHK units. These apartments come equipped with all of the necessary amenities and features to ensure that residents have a comfortable and convenient living experience. In addition to the individual units, Sree Dhanya Anklets also offers a variety of common amenities for the use of all residents. The development is designed to provide a sense of community and cater to the needs of all of its residents.
HIGHLIGHTS
LOCATION
Sree Dhanya Anklets is a high-quality residential development that offers comfortable and convenient living options for individuals and families in the Kudappanakunnu area in Trivandrum city. With its range of apartment options and common amenities, it is an attractive choice for those looking to relocate or invest in the real estate market in the region.
UNITS
2&3 BHK Apartments
Amenities
- Floating Lounge
- Air-conditioned Fitness centre
- Swimming pool with wading pool
- Recreation area with Indoor Games
- Rooftop party area
- Garbage disposal management system
- Sewage treatment plant
- Round-the-clock security
- Biometric entry for main lobby
- Surveillance camera
- Reticulated gas system
- 24 Hours Generator backup
- Care Taker rooms
- Rainwater harvesting
- Car parking with provision for Electric car charging point
- Kids play Area

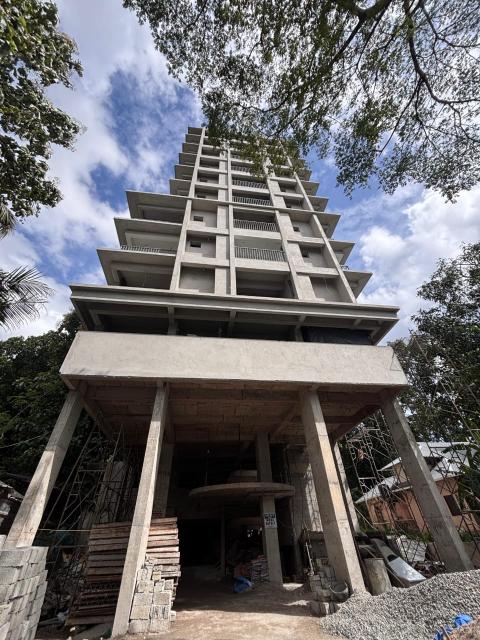

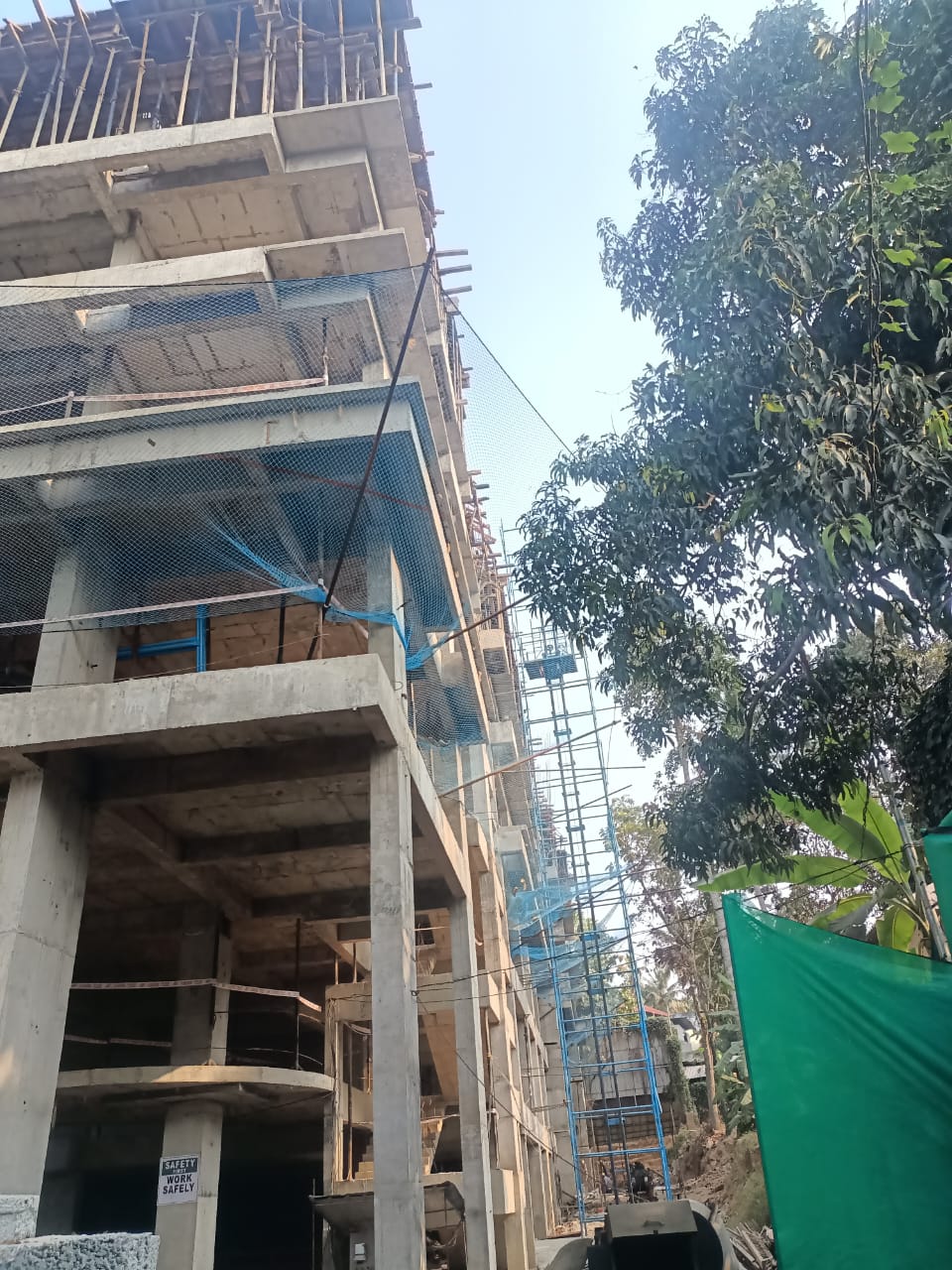

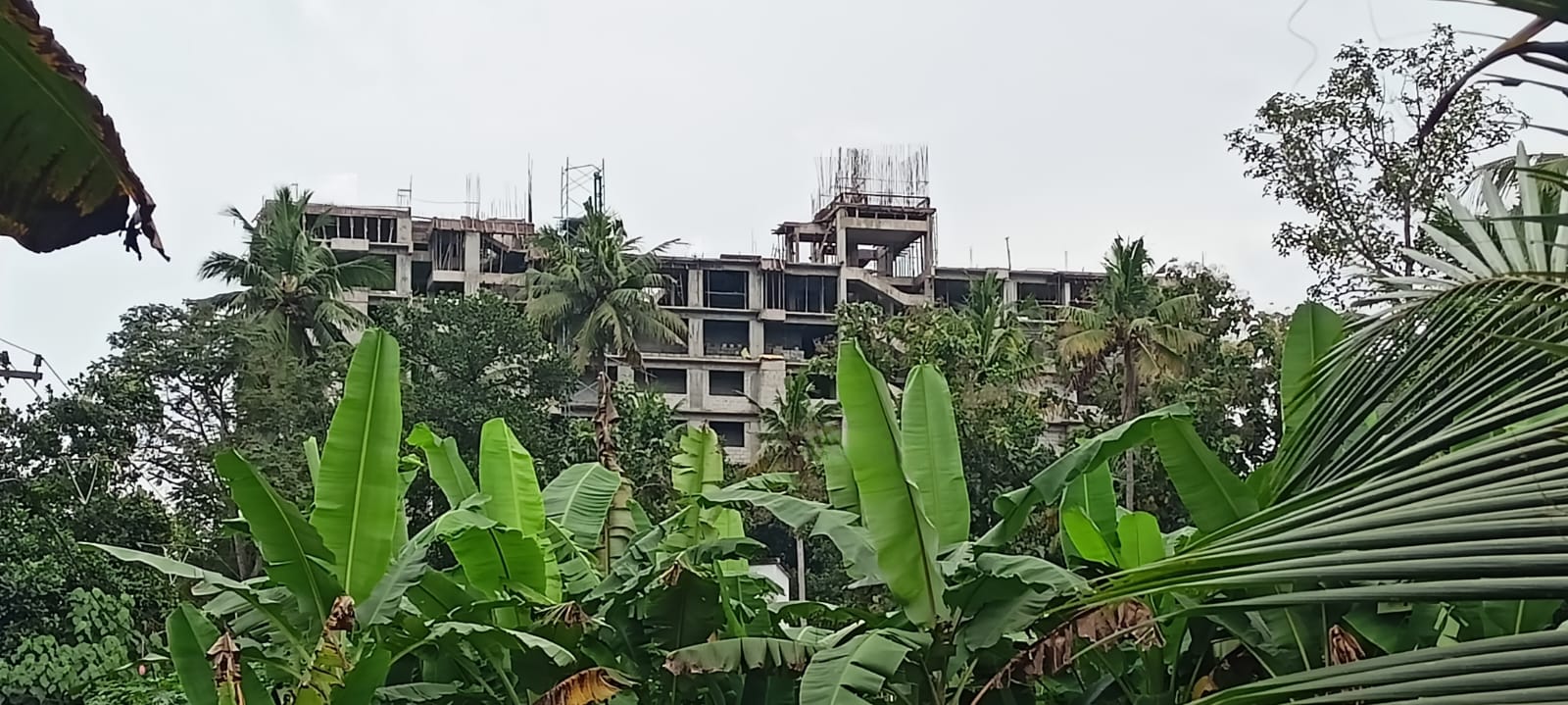

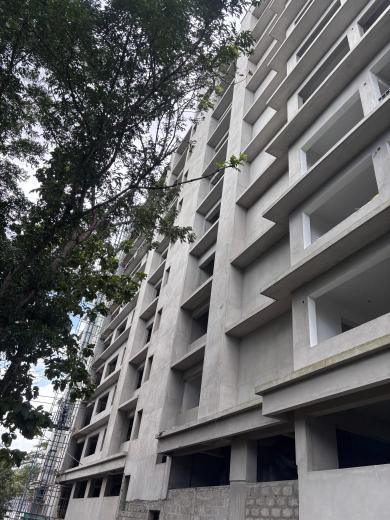

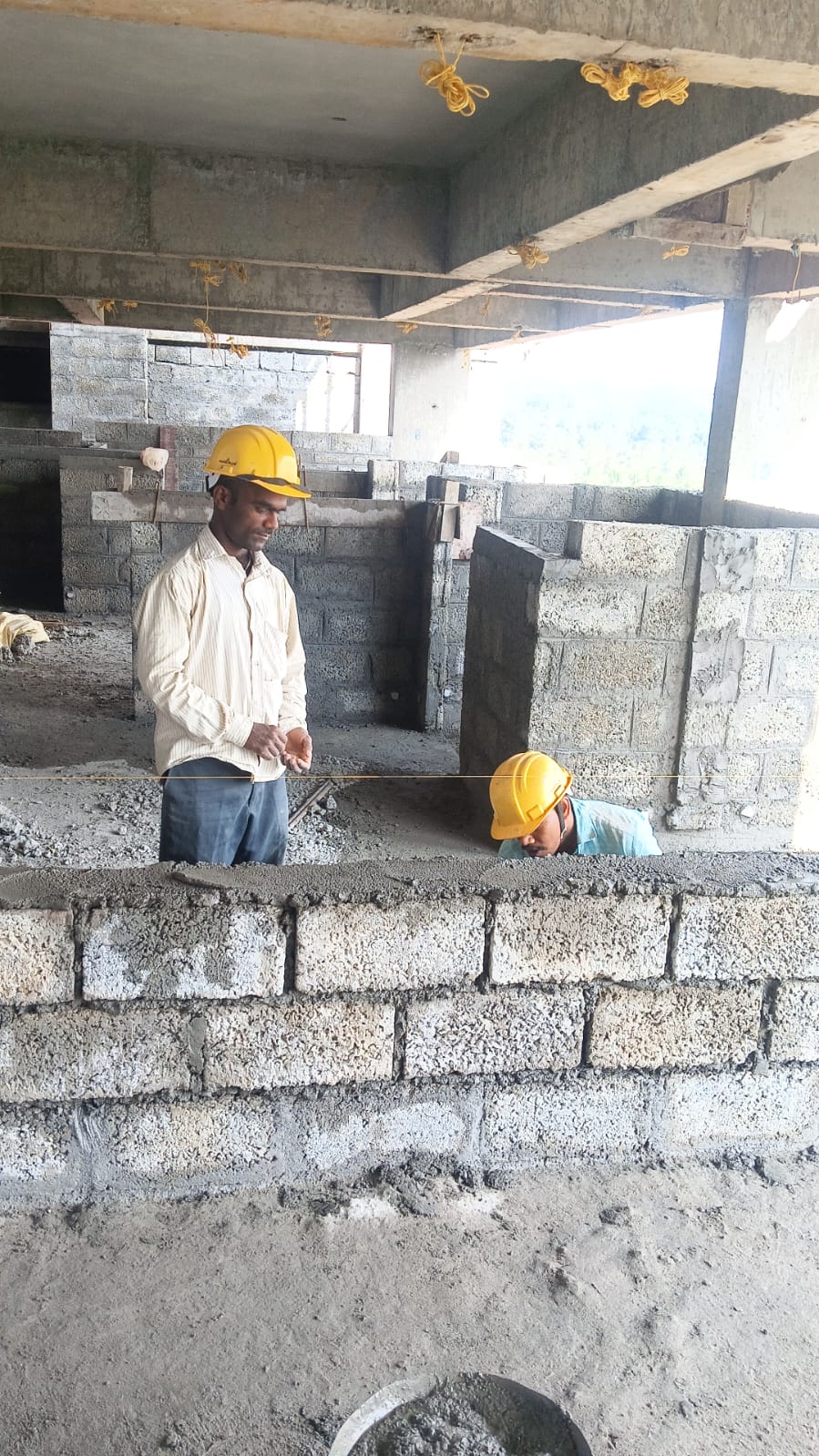

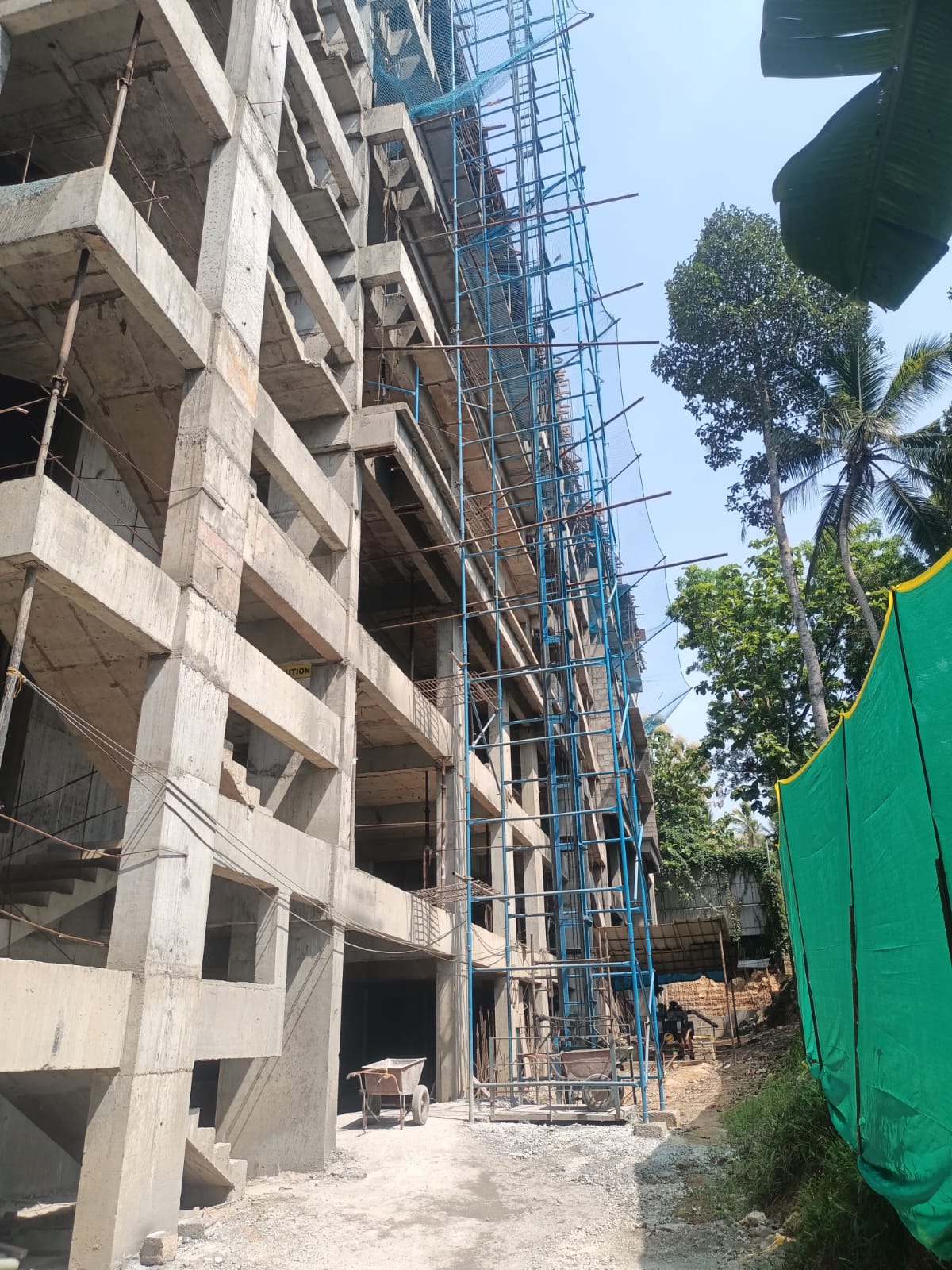

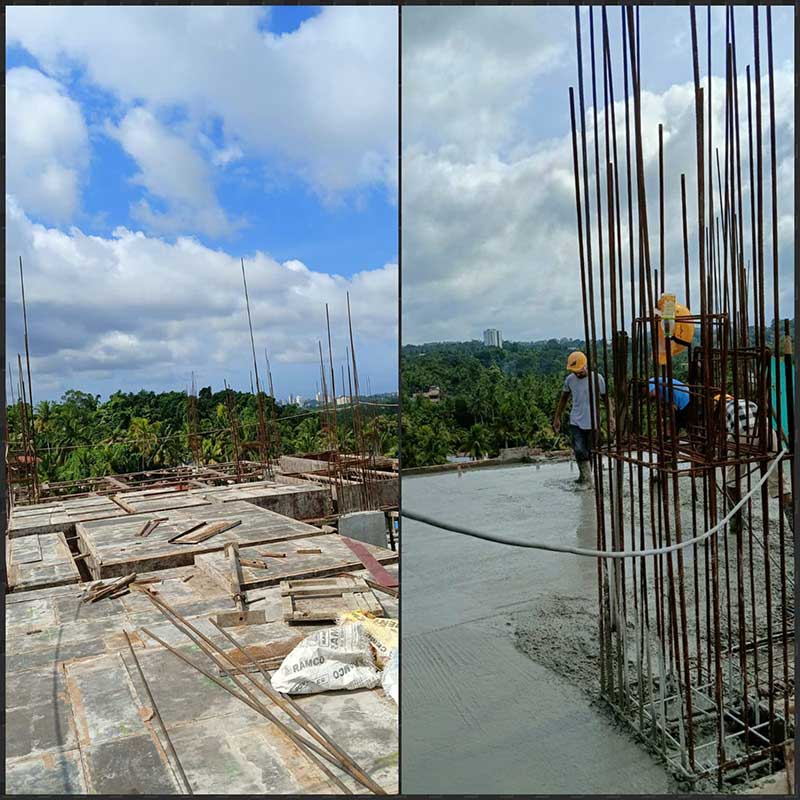

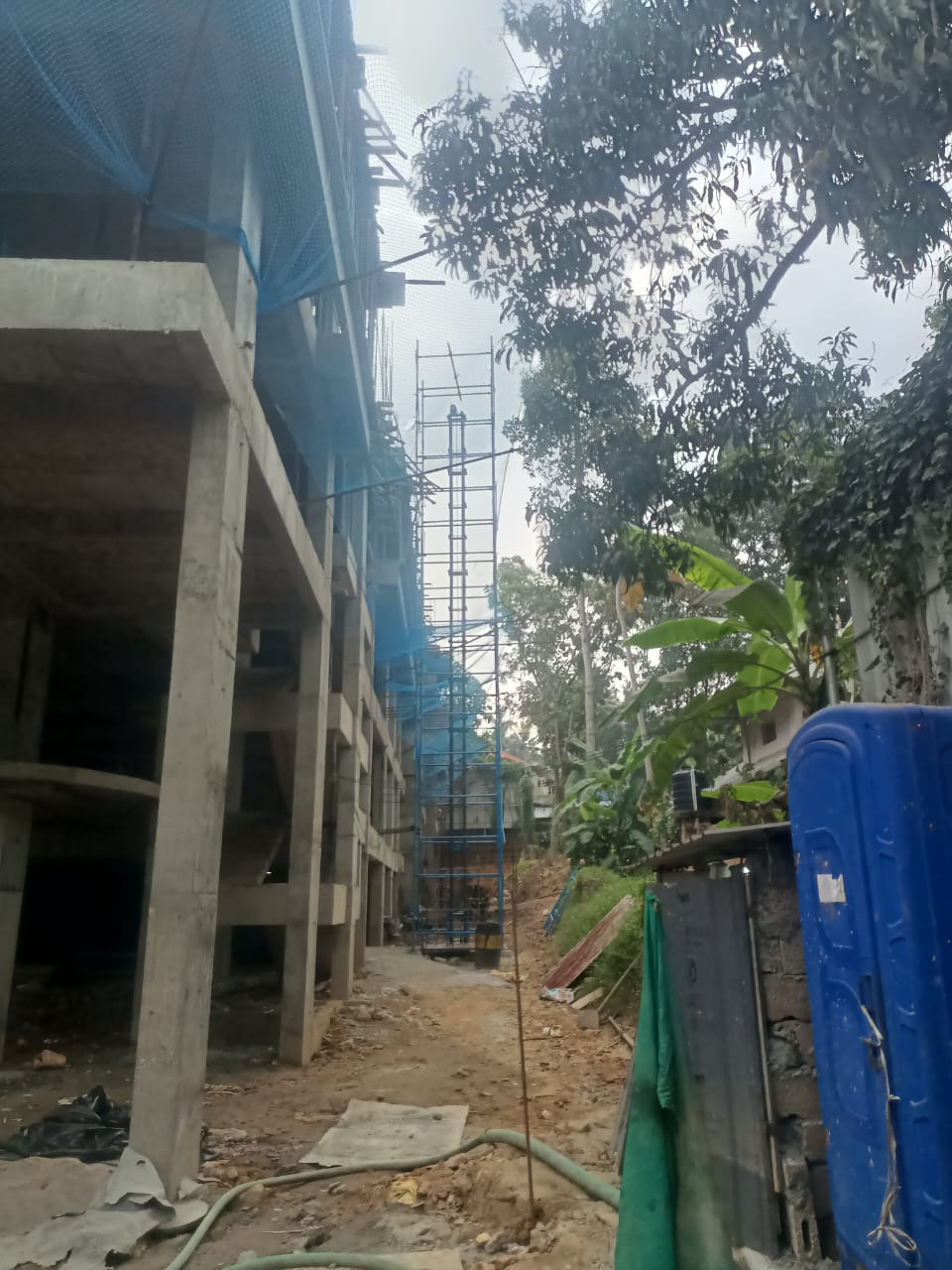

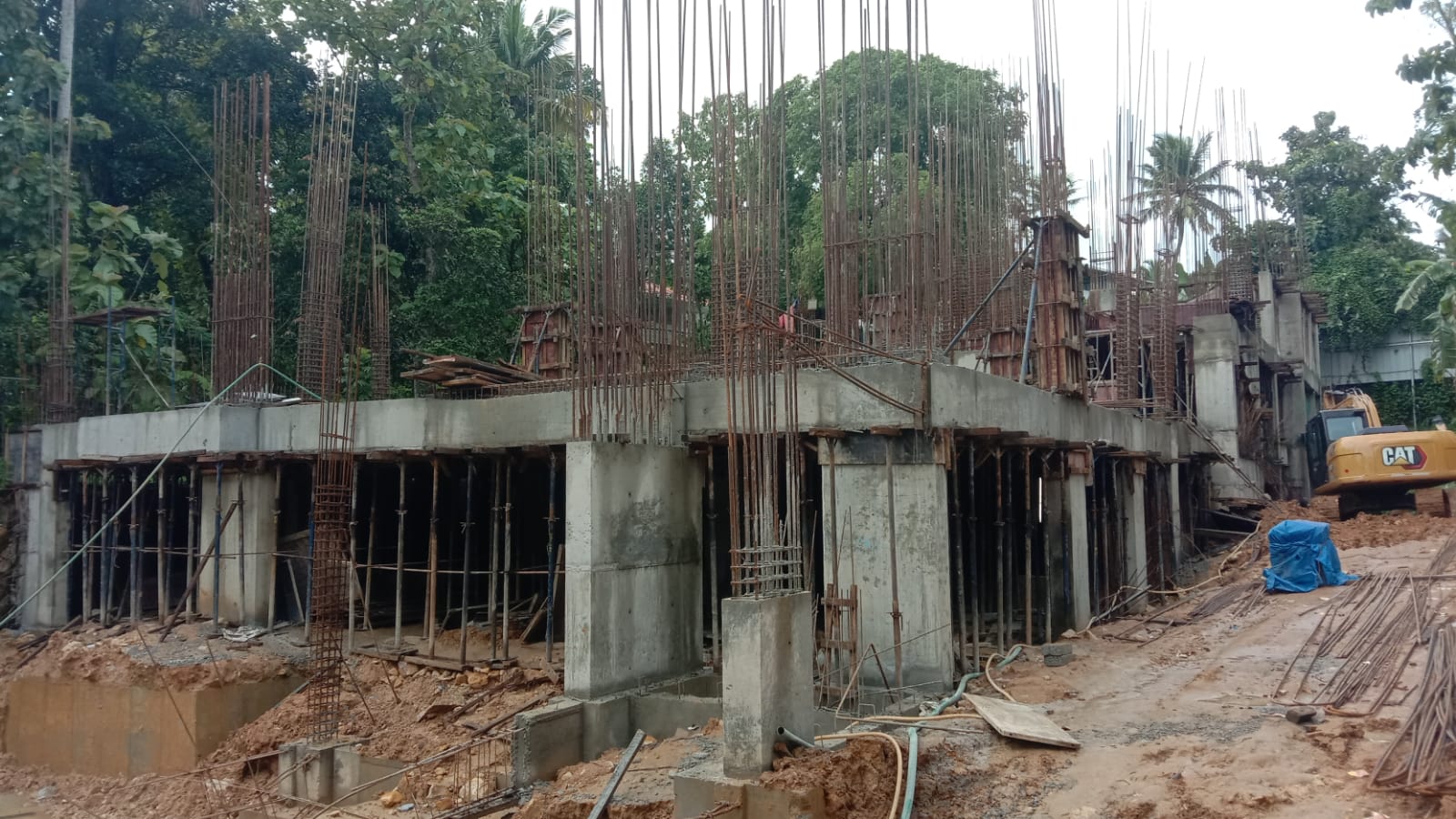

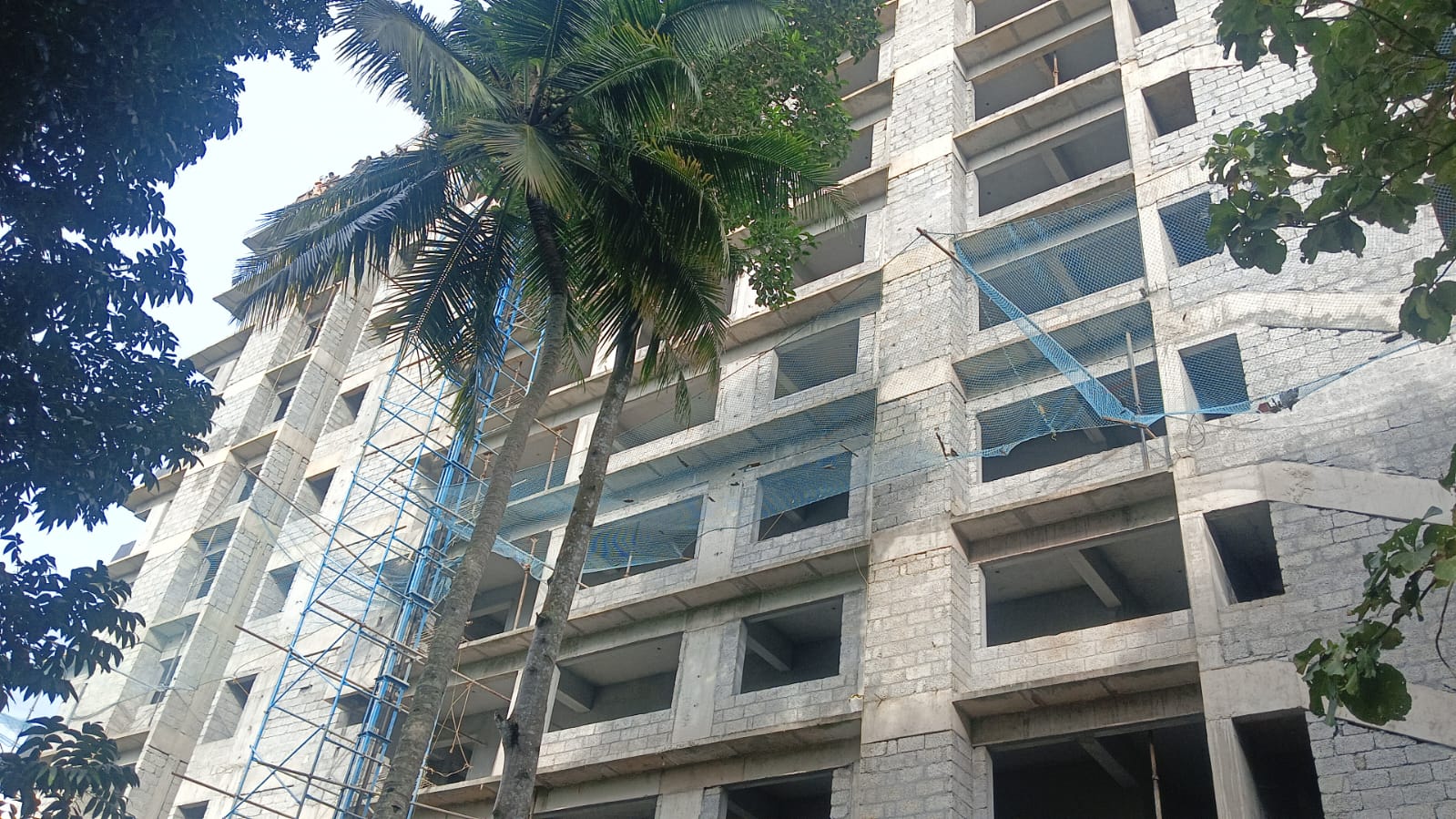

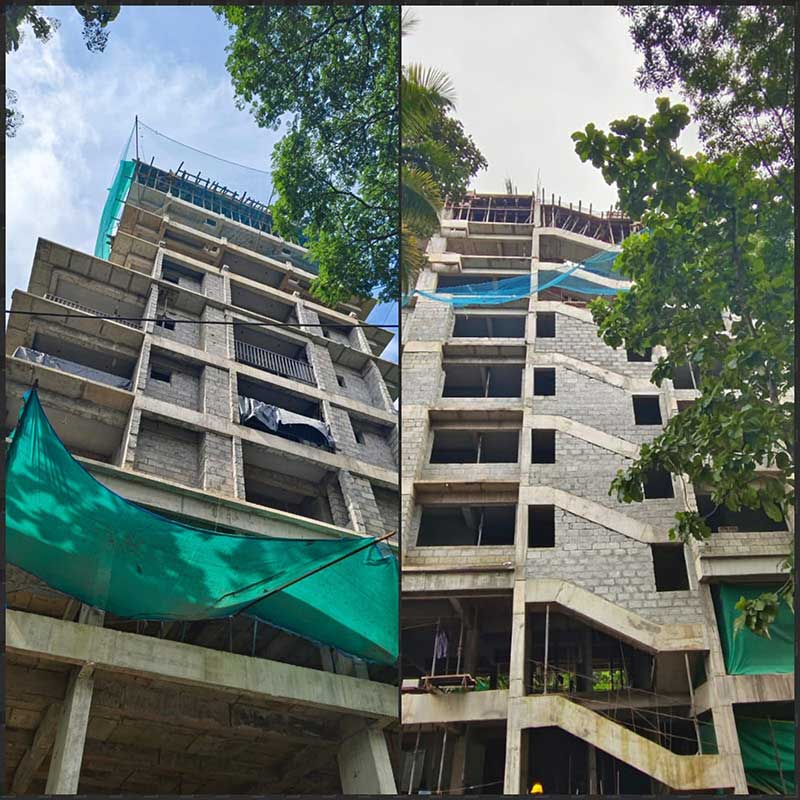

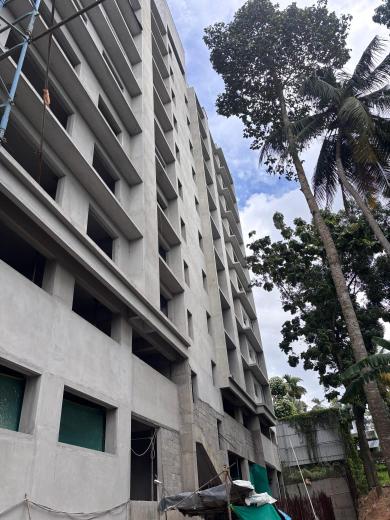

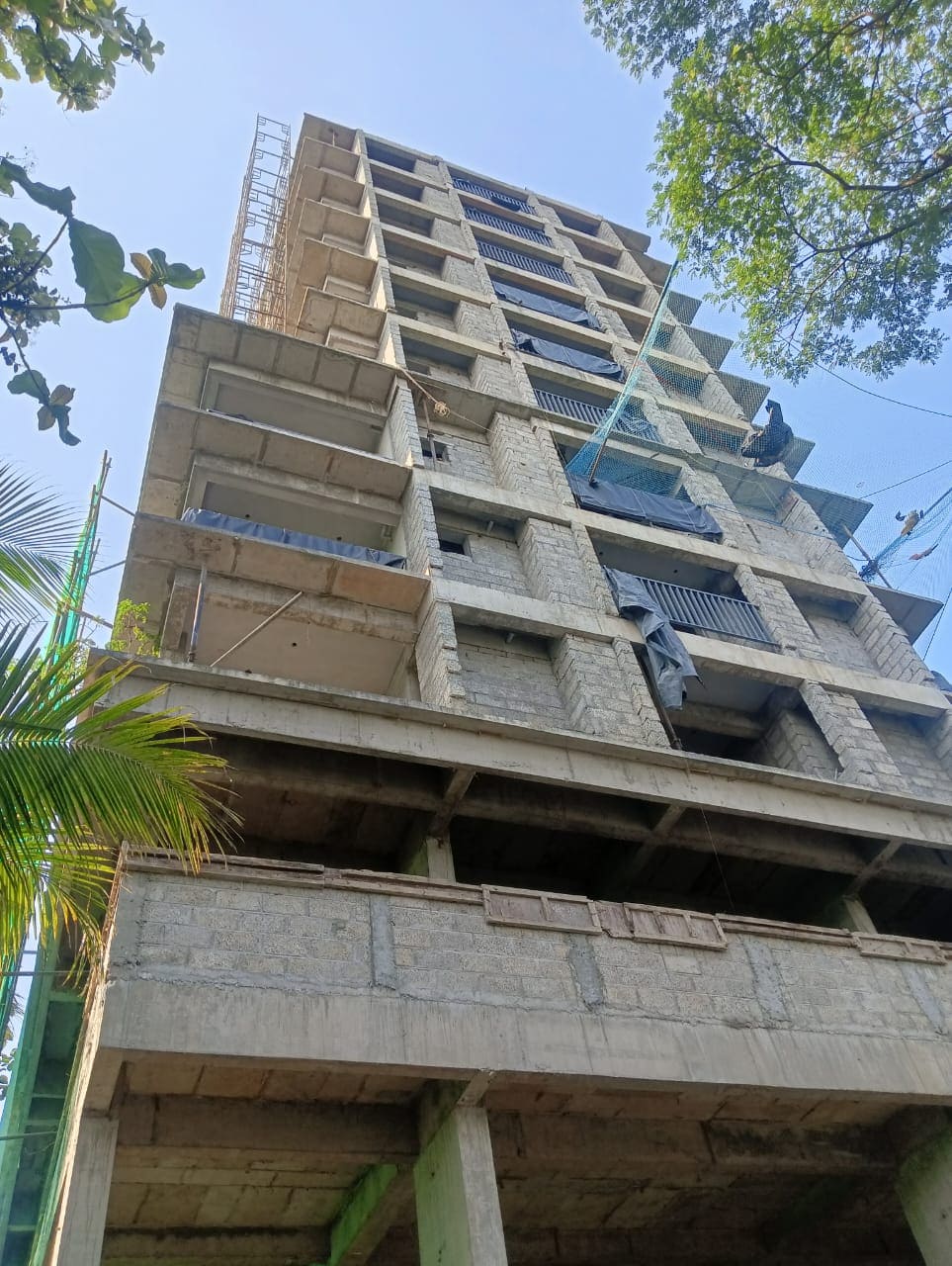

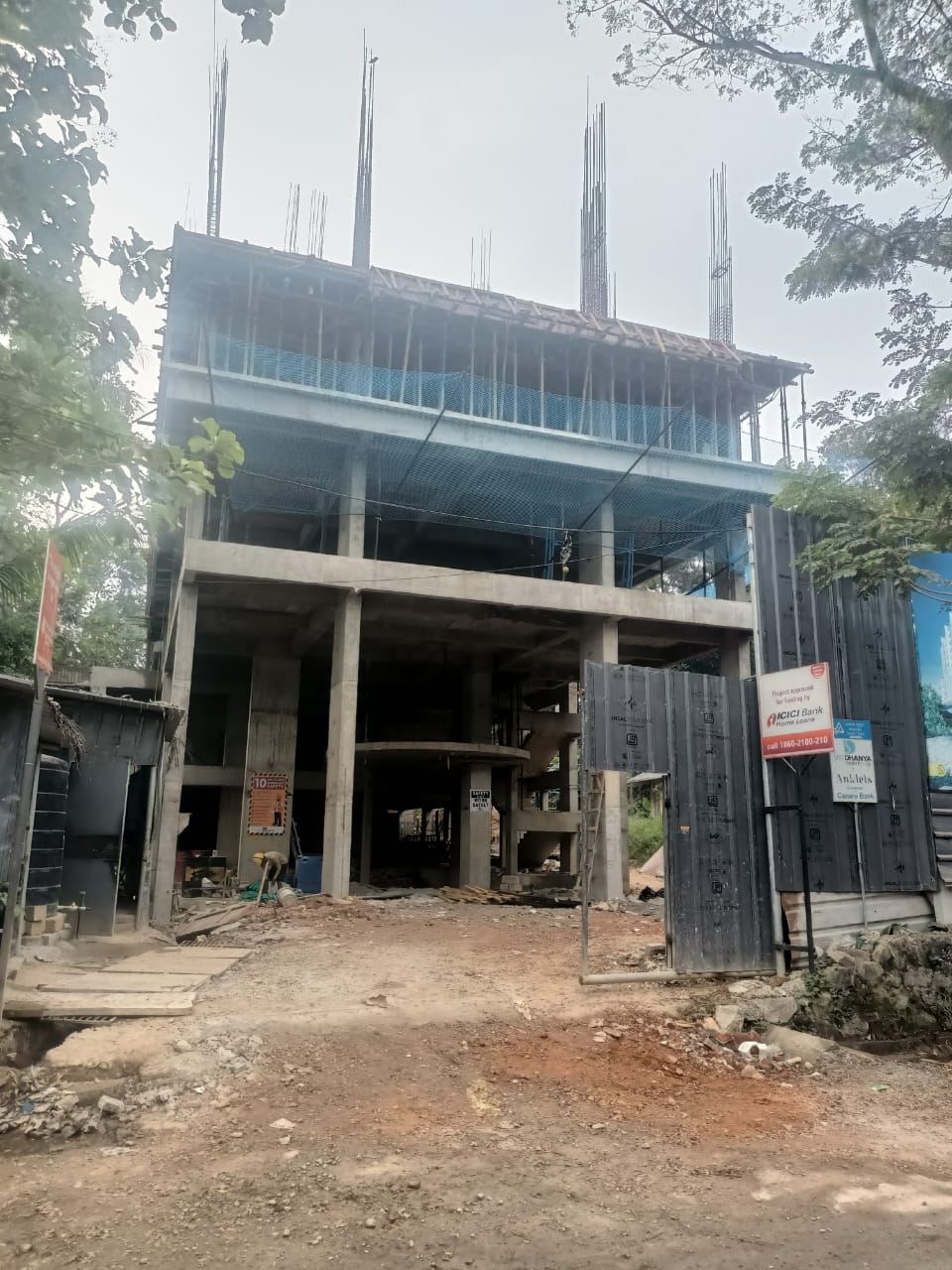

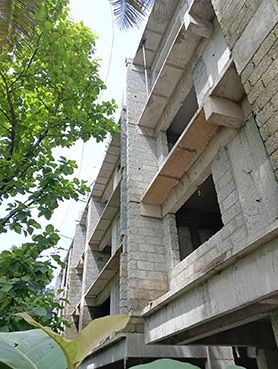

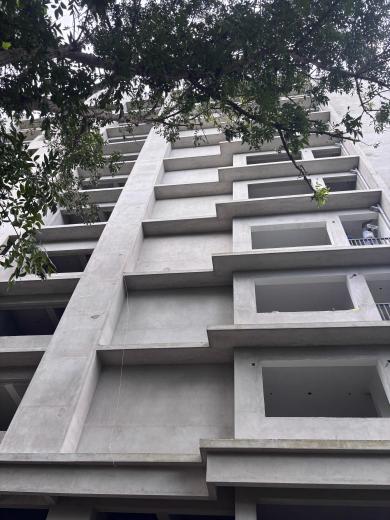

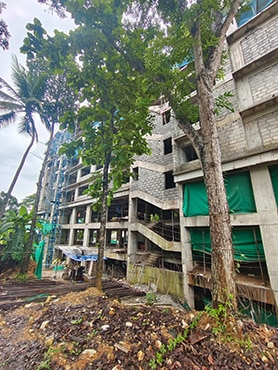

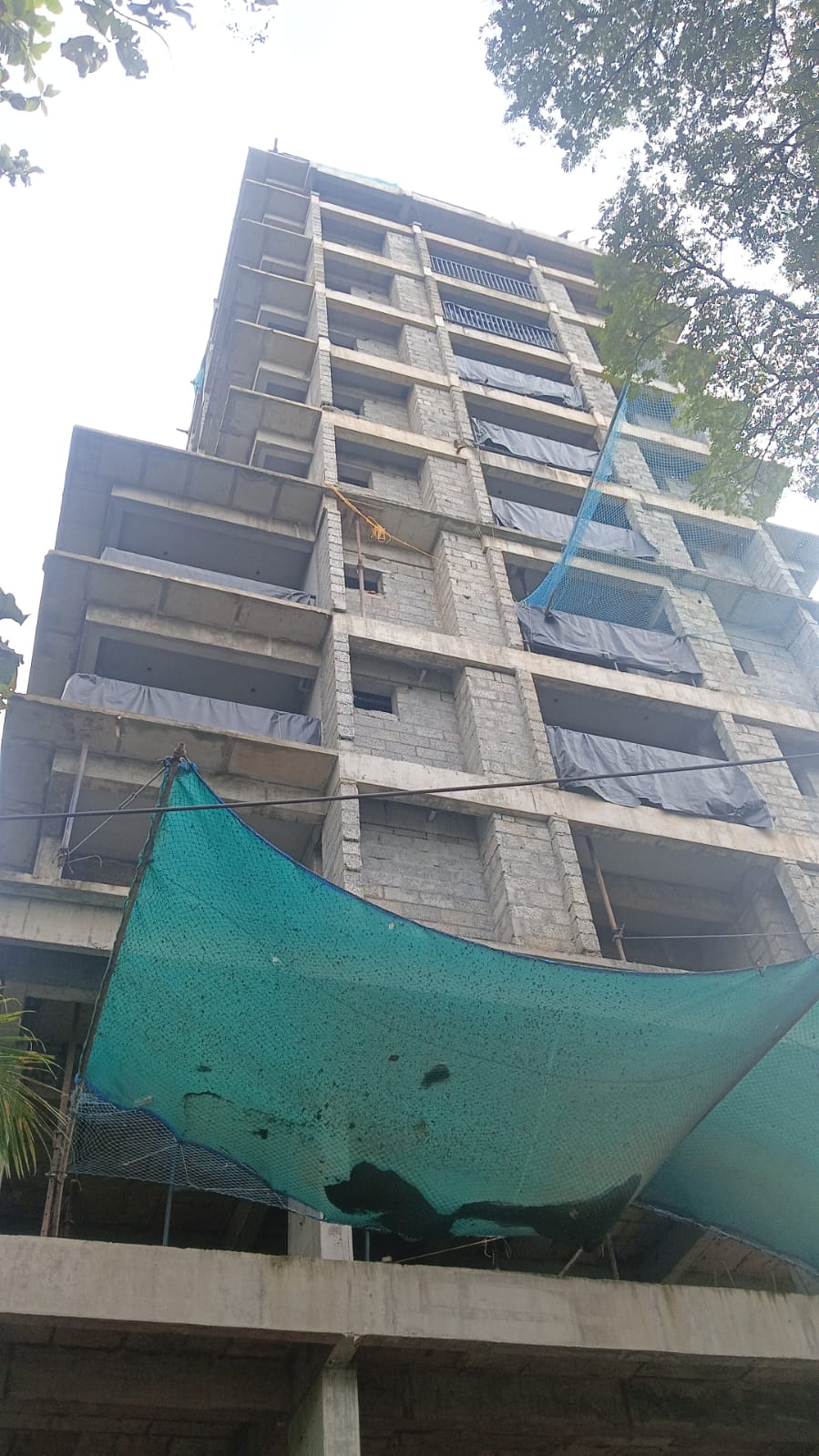

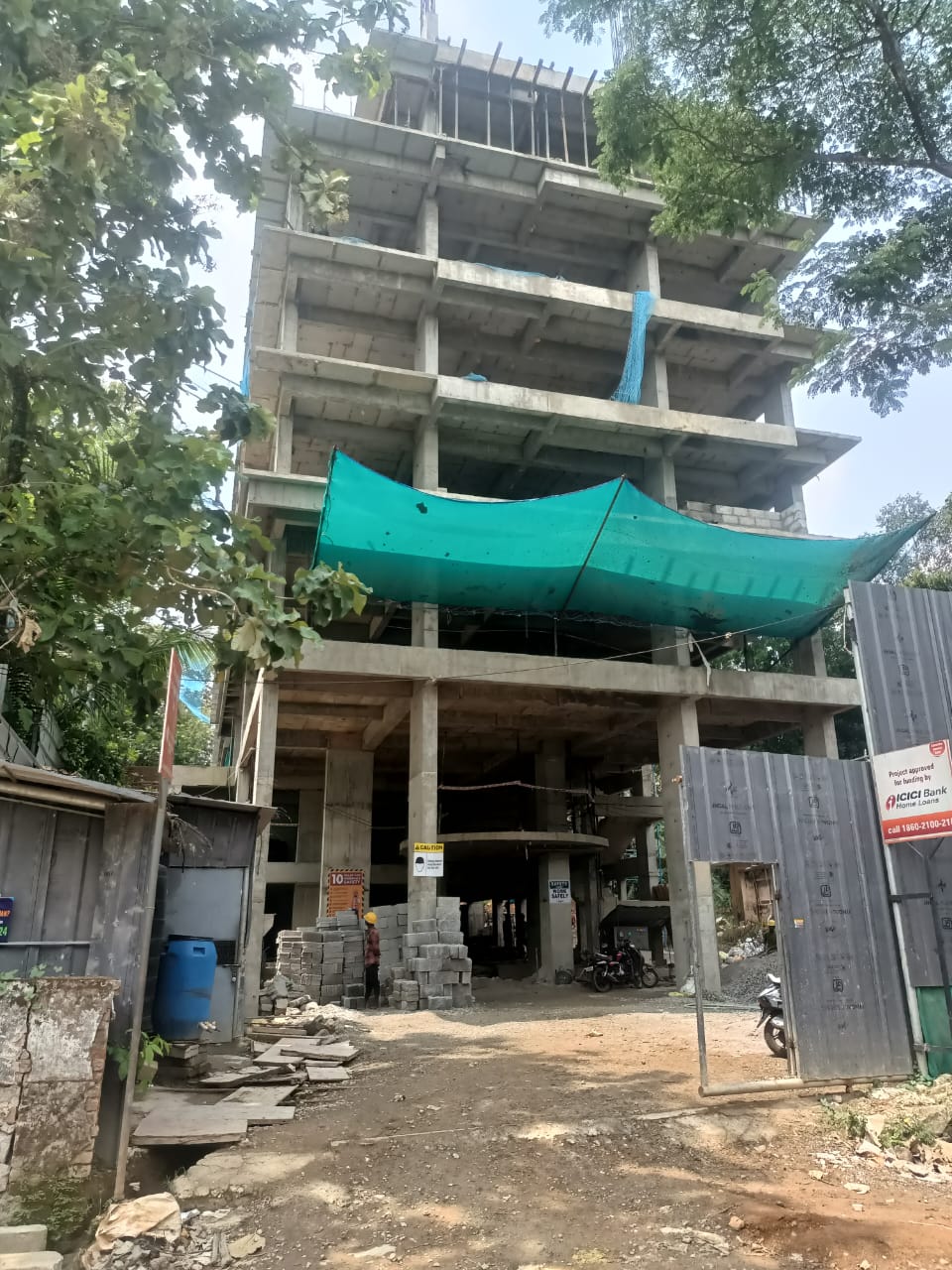

PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 30.07.2024

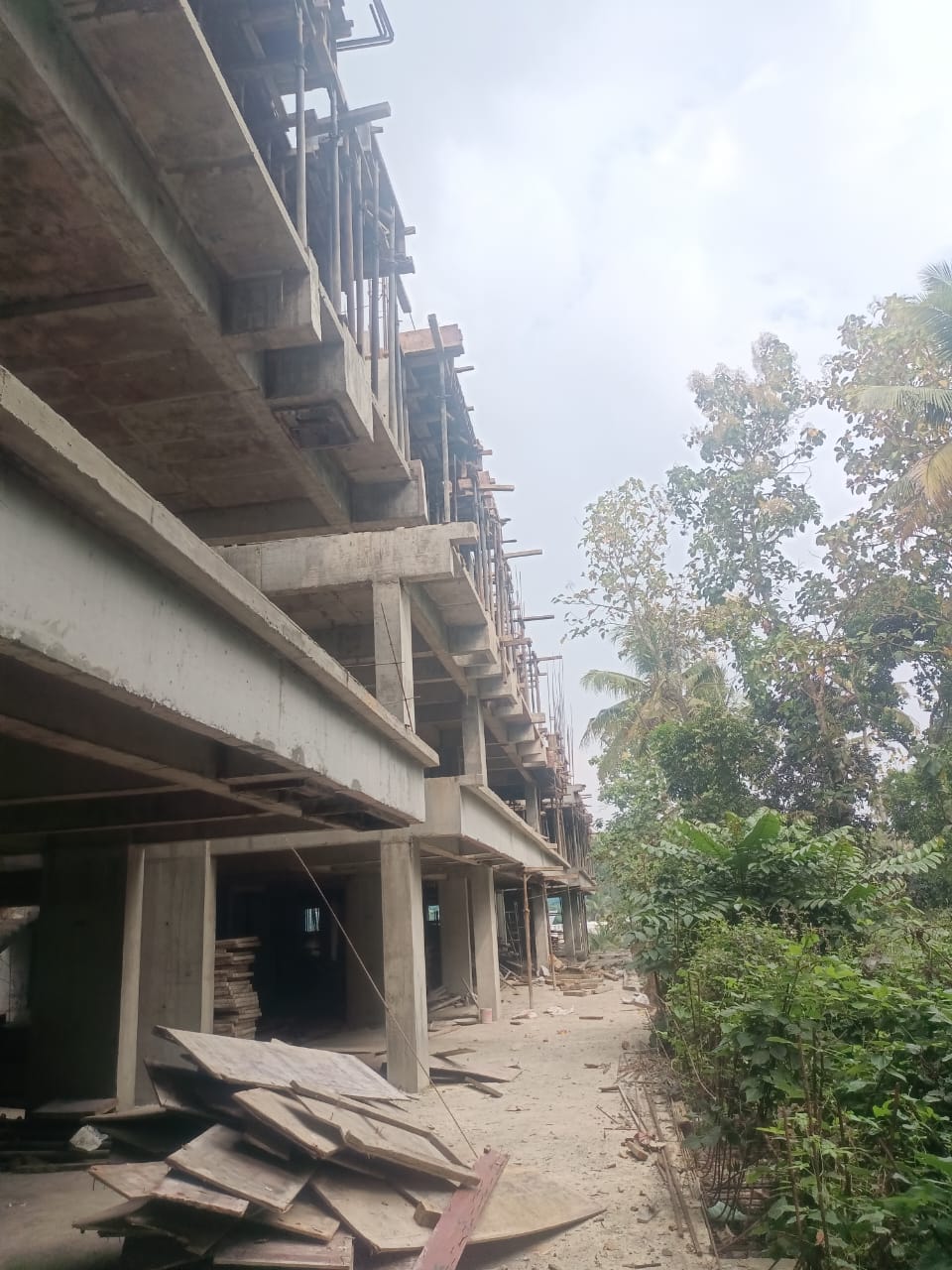

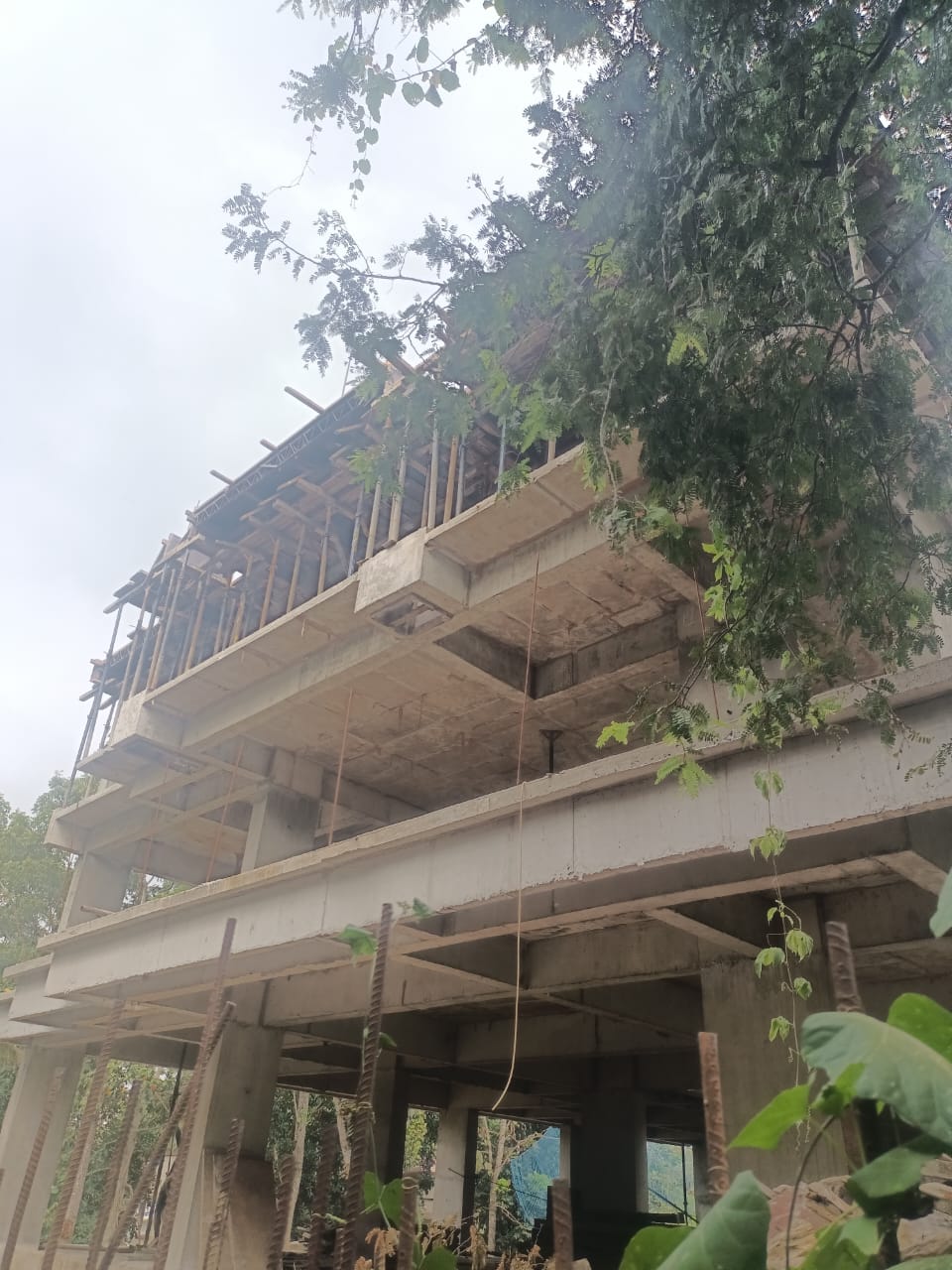

- RCC FOR 7 TH FLOOR SLAB – 100% COMPLETED
- RCC FOR COLUMN – 7TH TO 8TH FLOOR – 100 % COMPLETED
- FORM WORK FOR 8TH FLOOR SLAB – 70% COMPLETED
- STEEL WORK FOR 8TH FLOOR SLAB – 20% COMPLETED

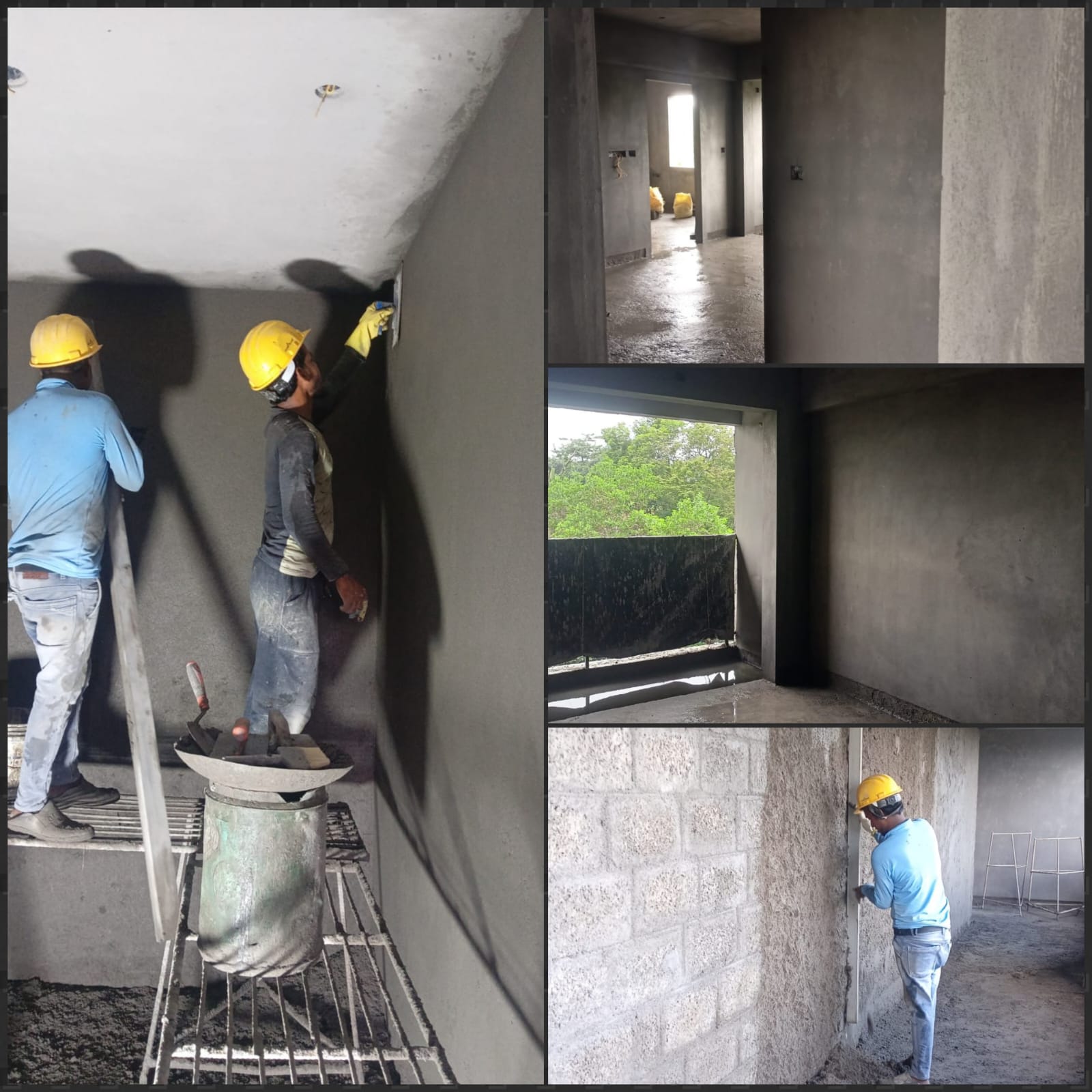

- CEILING PLASTERING – 19 APT OUT OF 49 COMPLETED

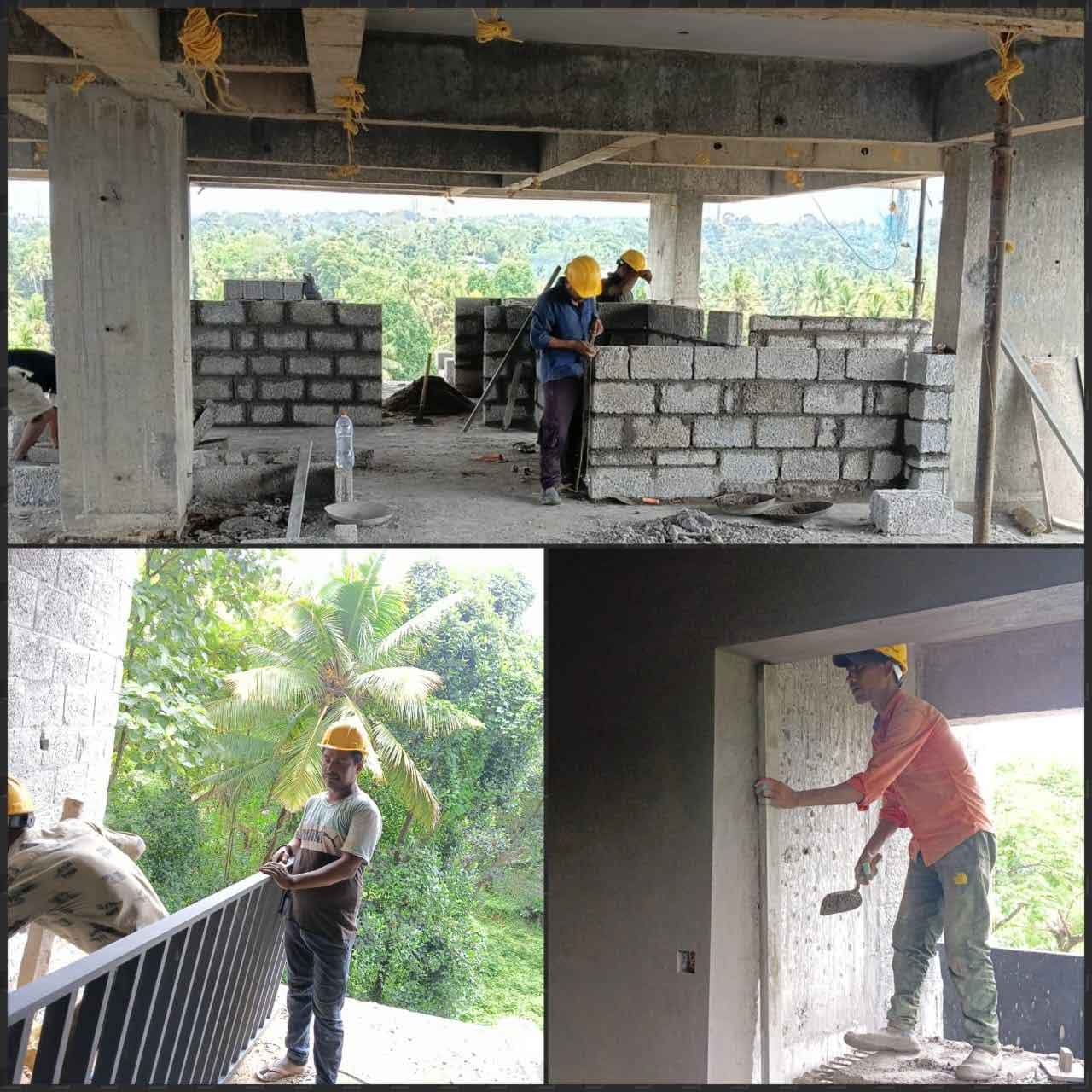

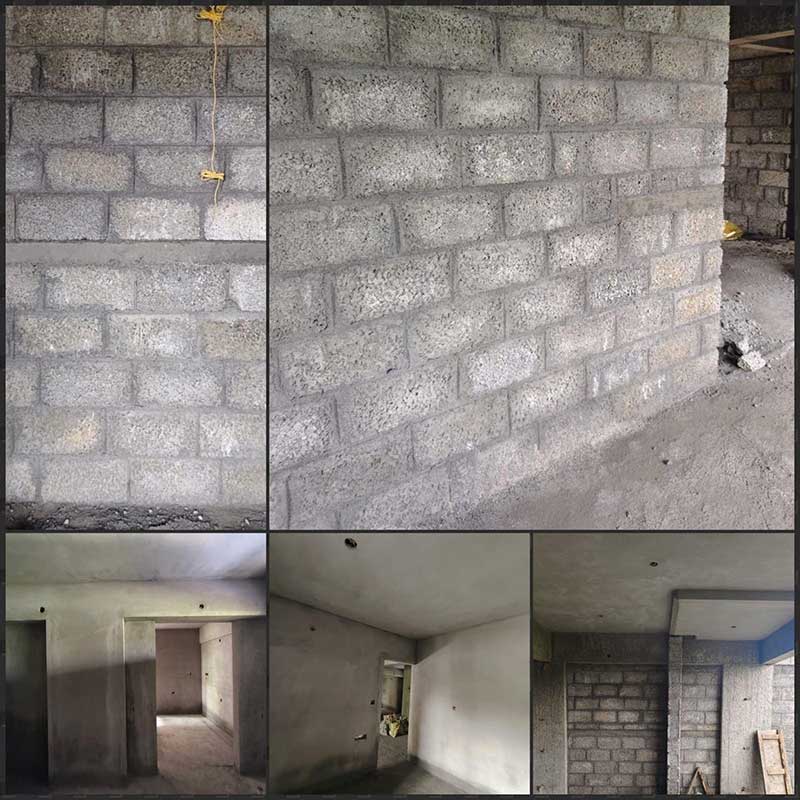

- MASONRY WORK – 18 APT OUT OF 49 COMPLETED

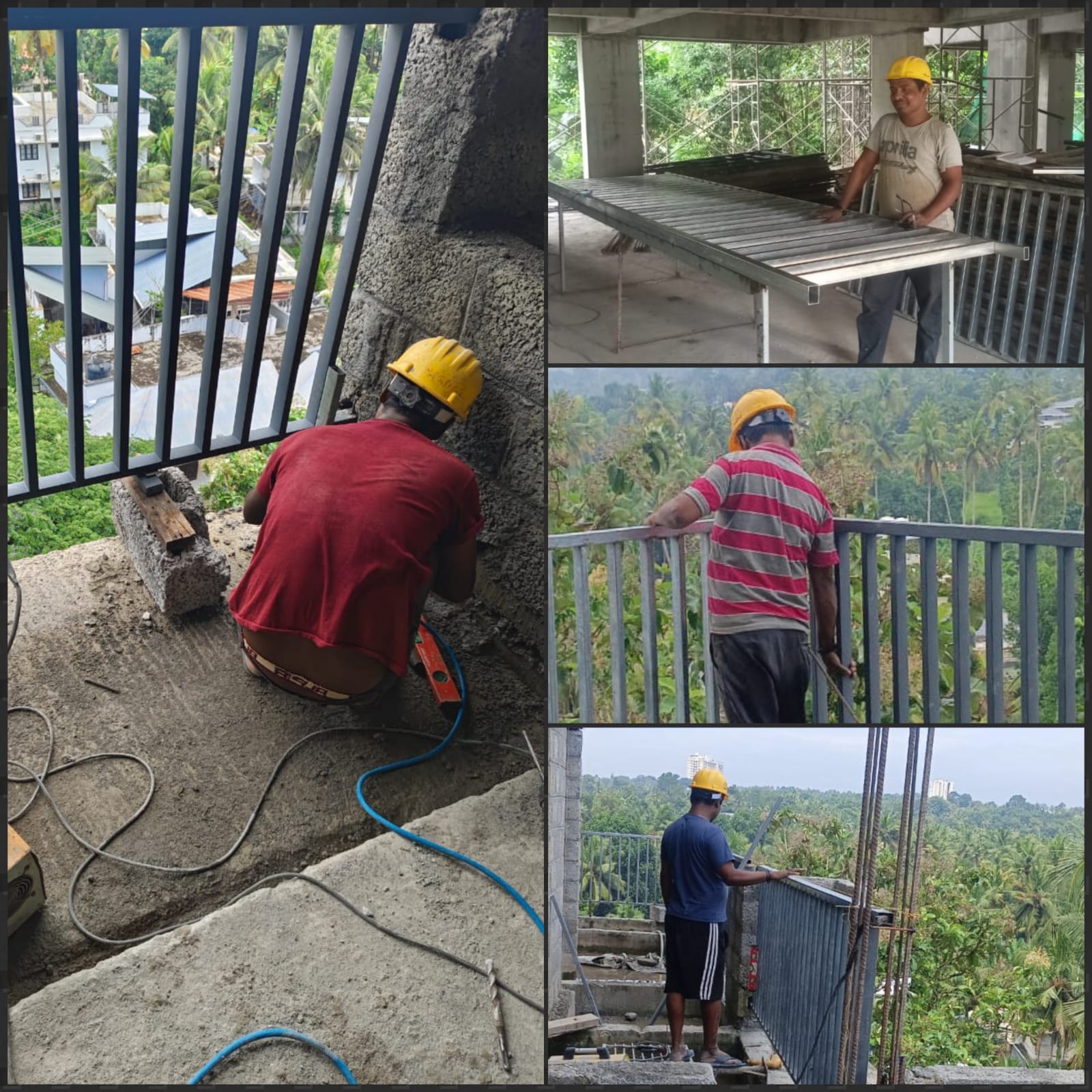

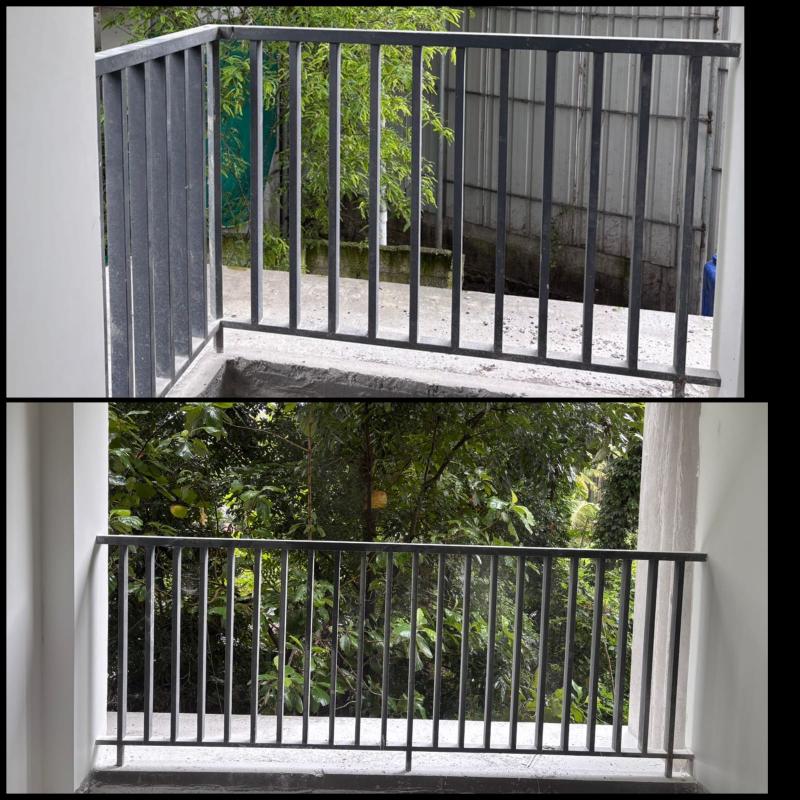

- BALCONY HANDRAIL FIXING – 10 APT OUT OF 49 COMPLETED

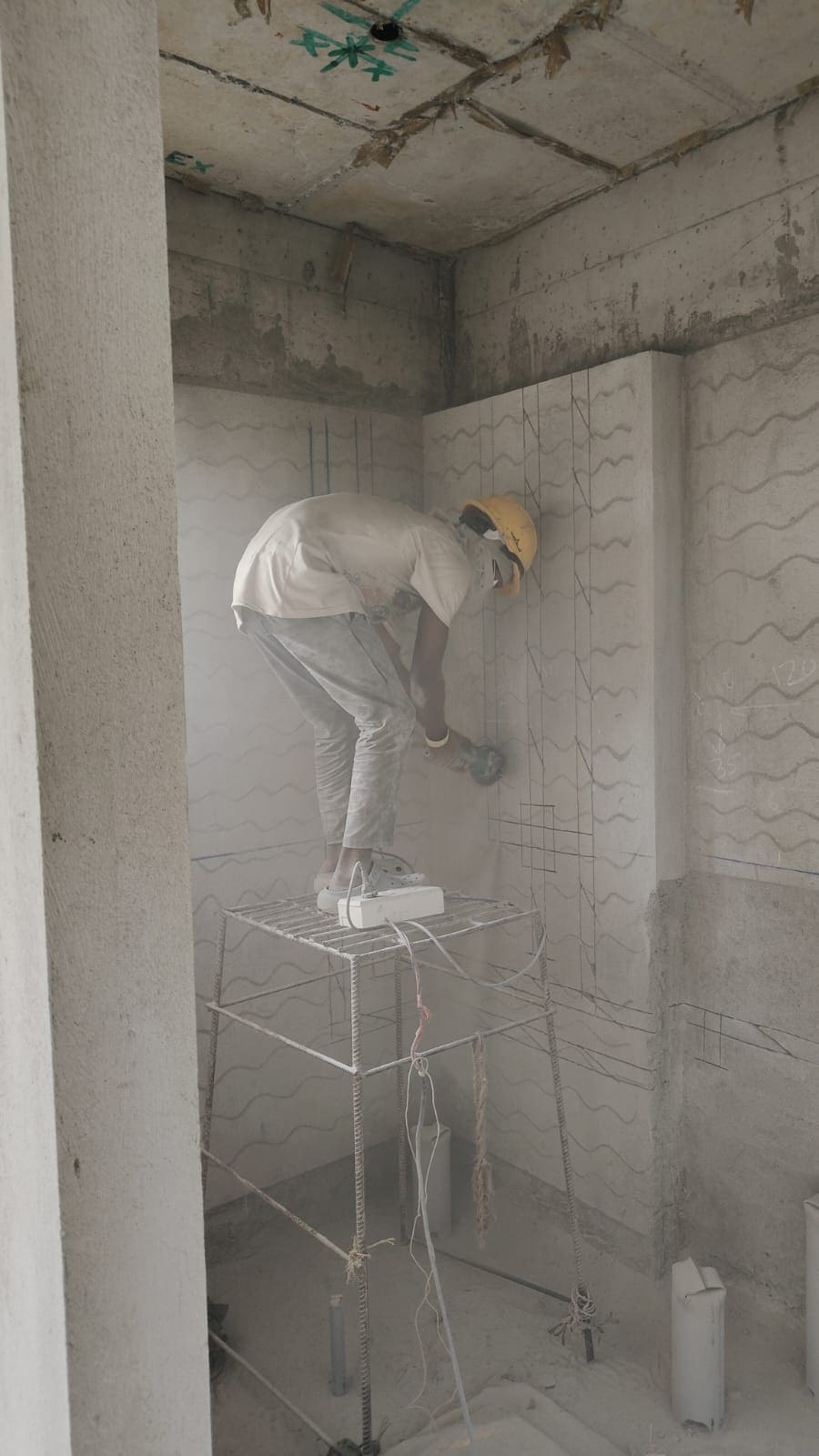

- INTERNAL WALL PLASTERING – 4 APT OUT OF 49 COMPLETED
- ELECTRICAL CHASING AND BOX FIXING – 9 APT OUT OF 49 COMPLETED

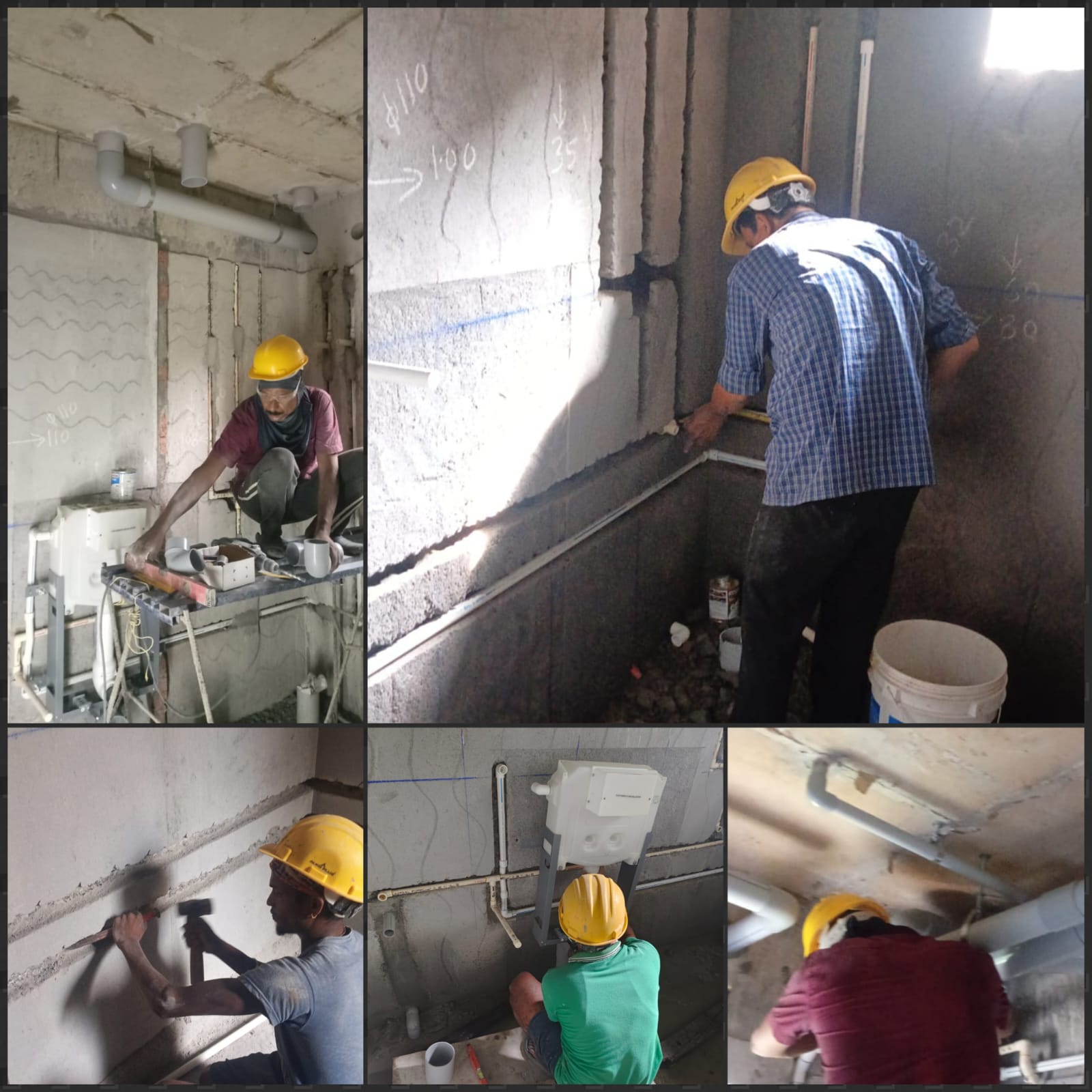

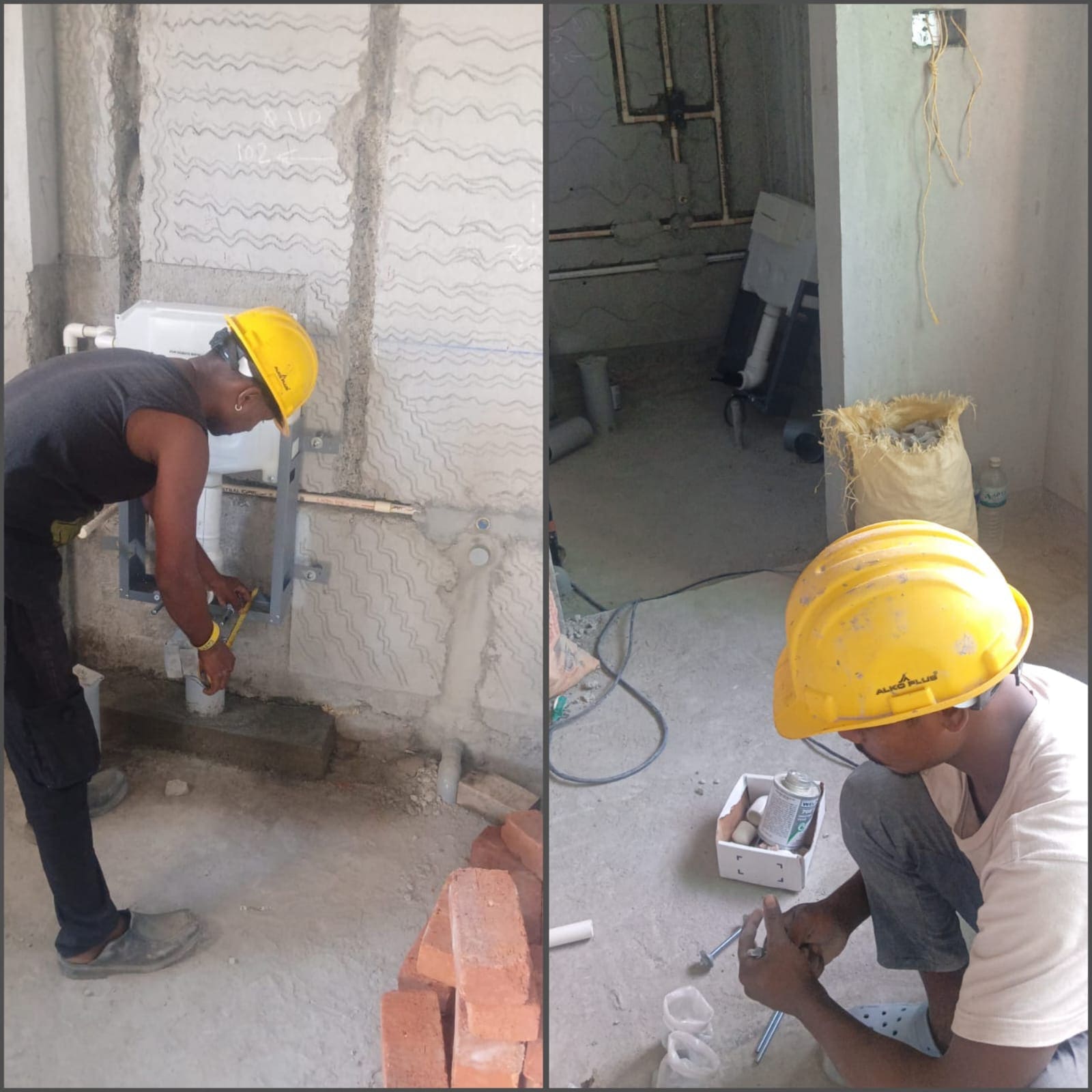

- PLUMBING INTERNAL CHASING & PIPE FIXING – STANDARD APT COMPLETED

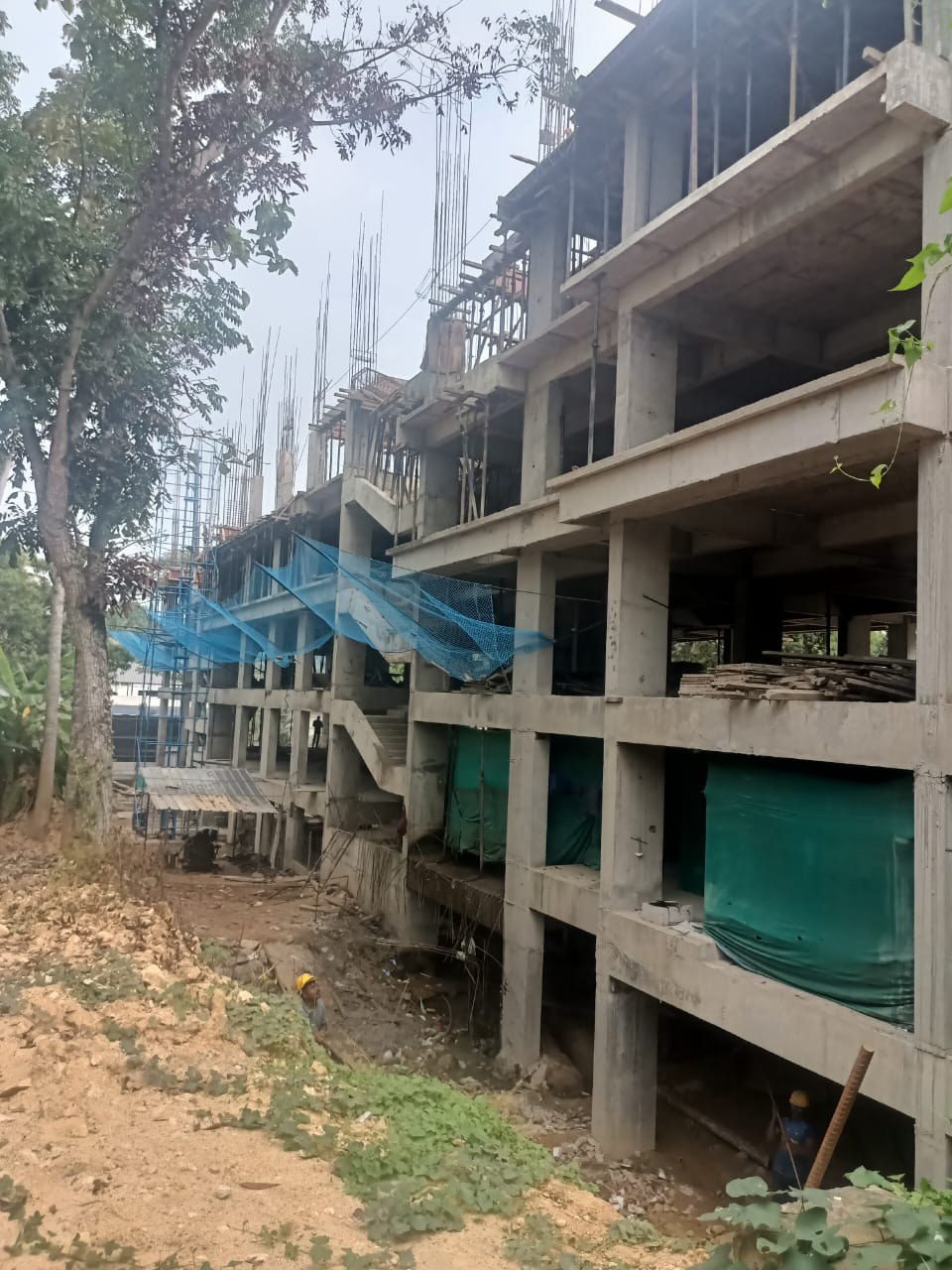

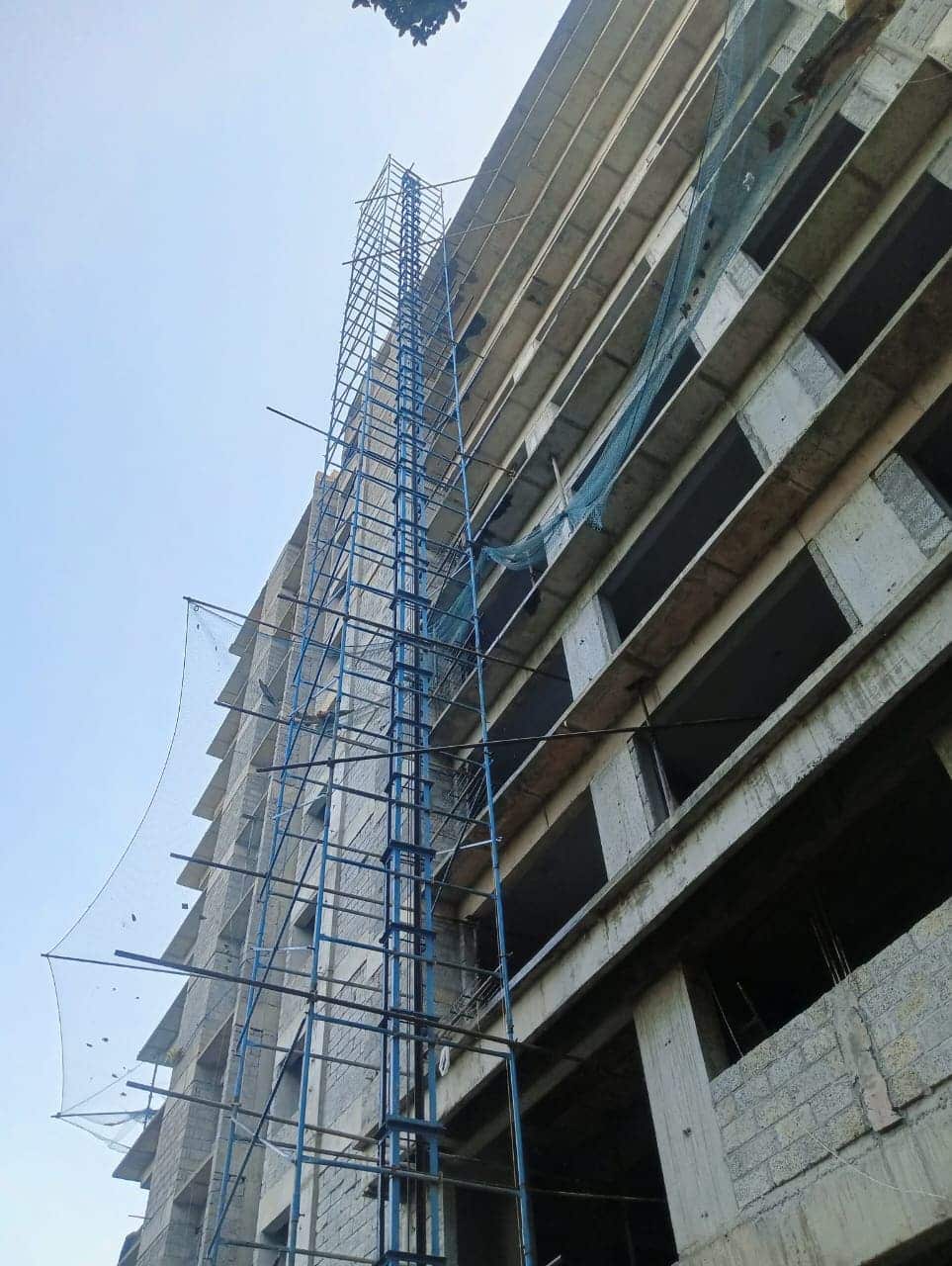

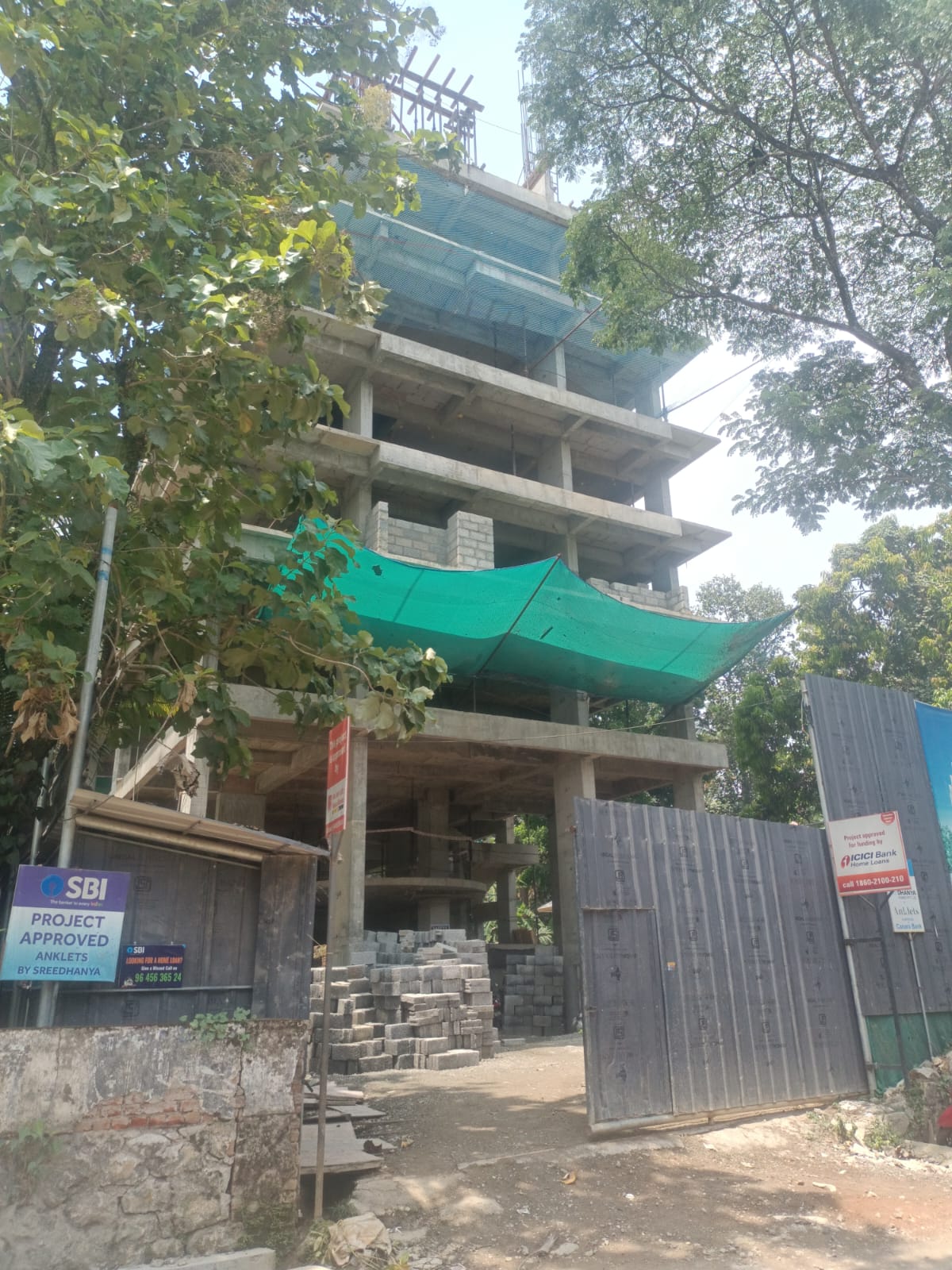

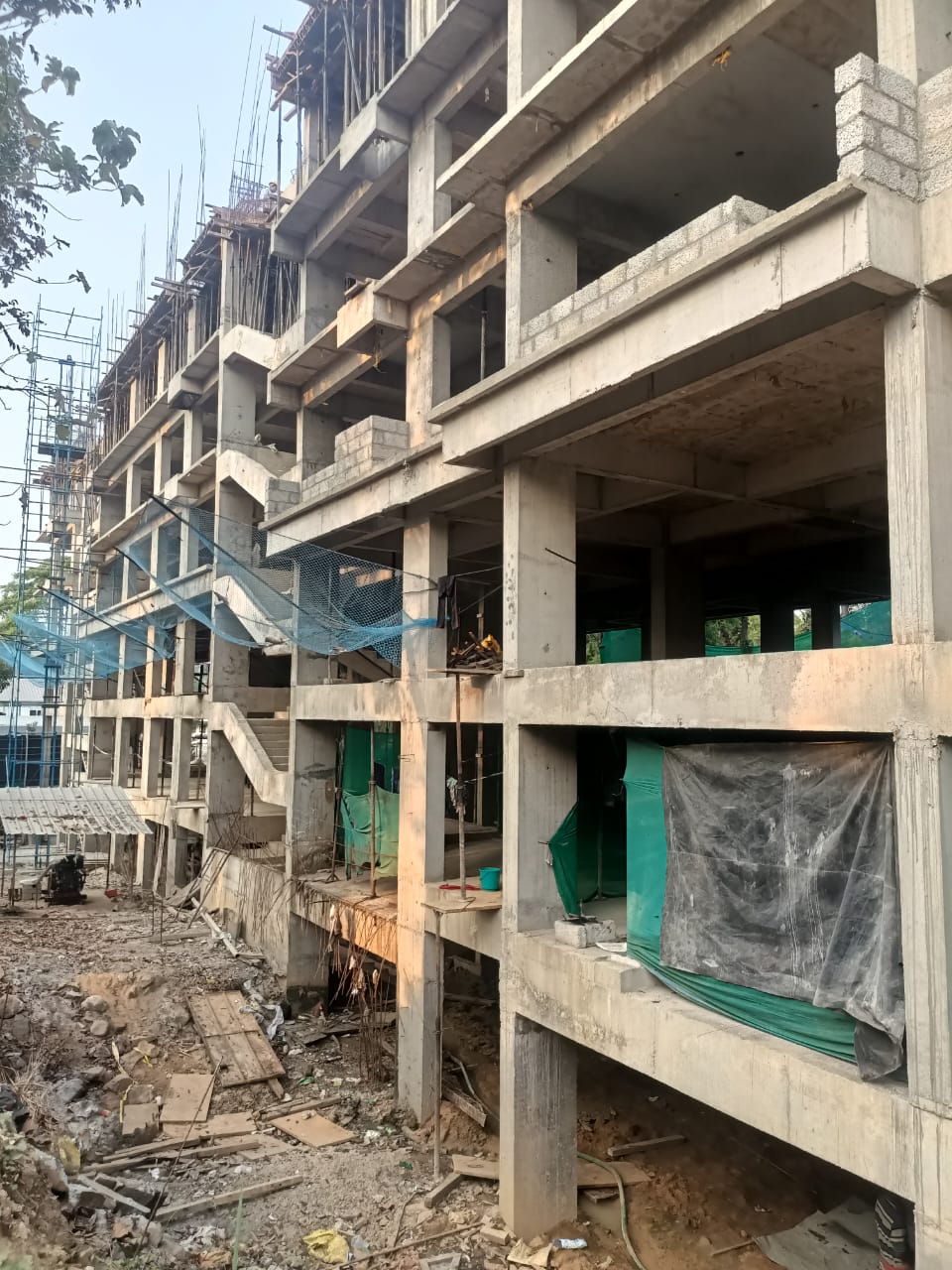

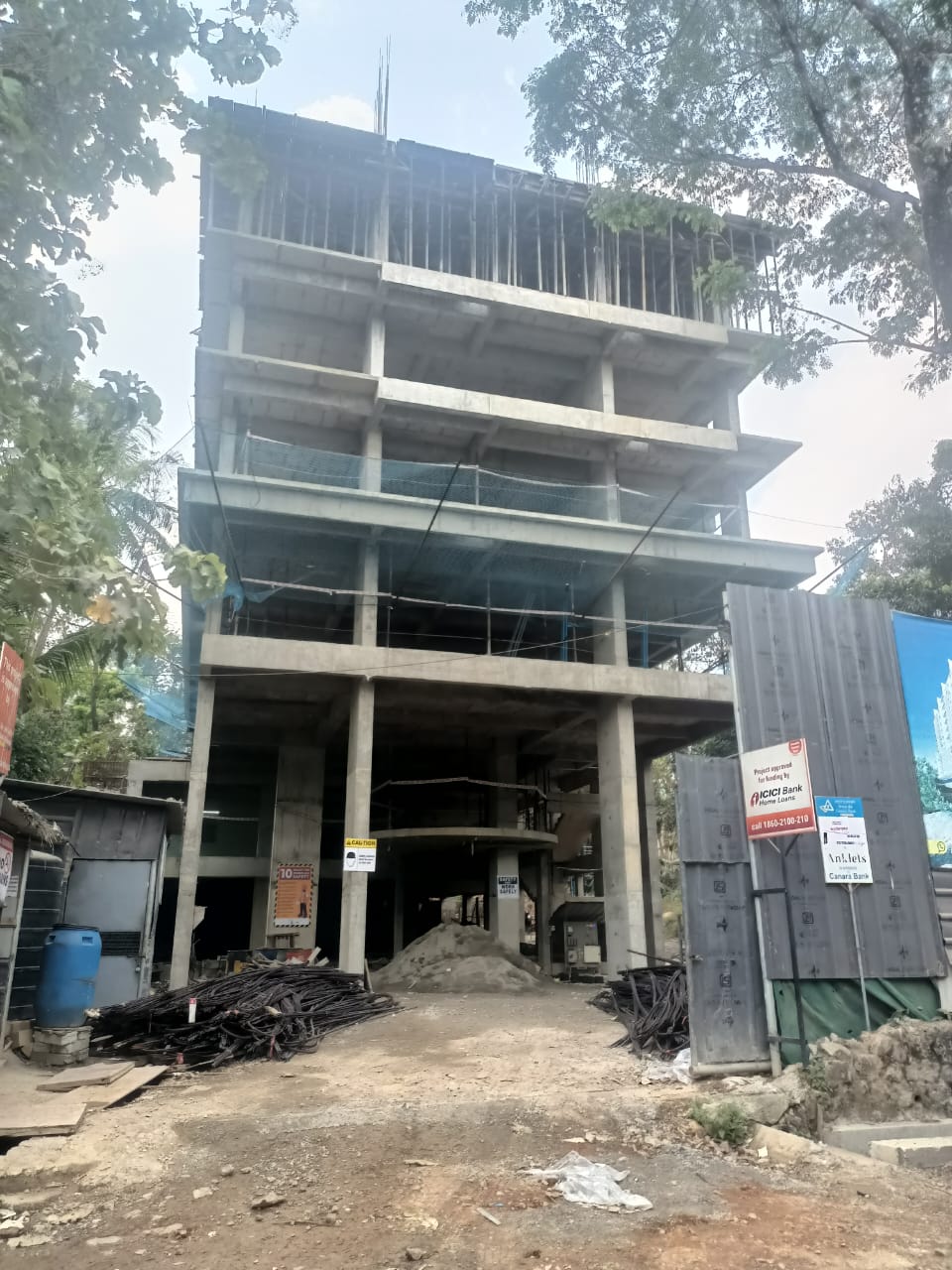

PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 21.06.2024

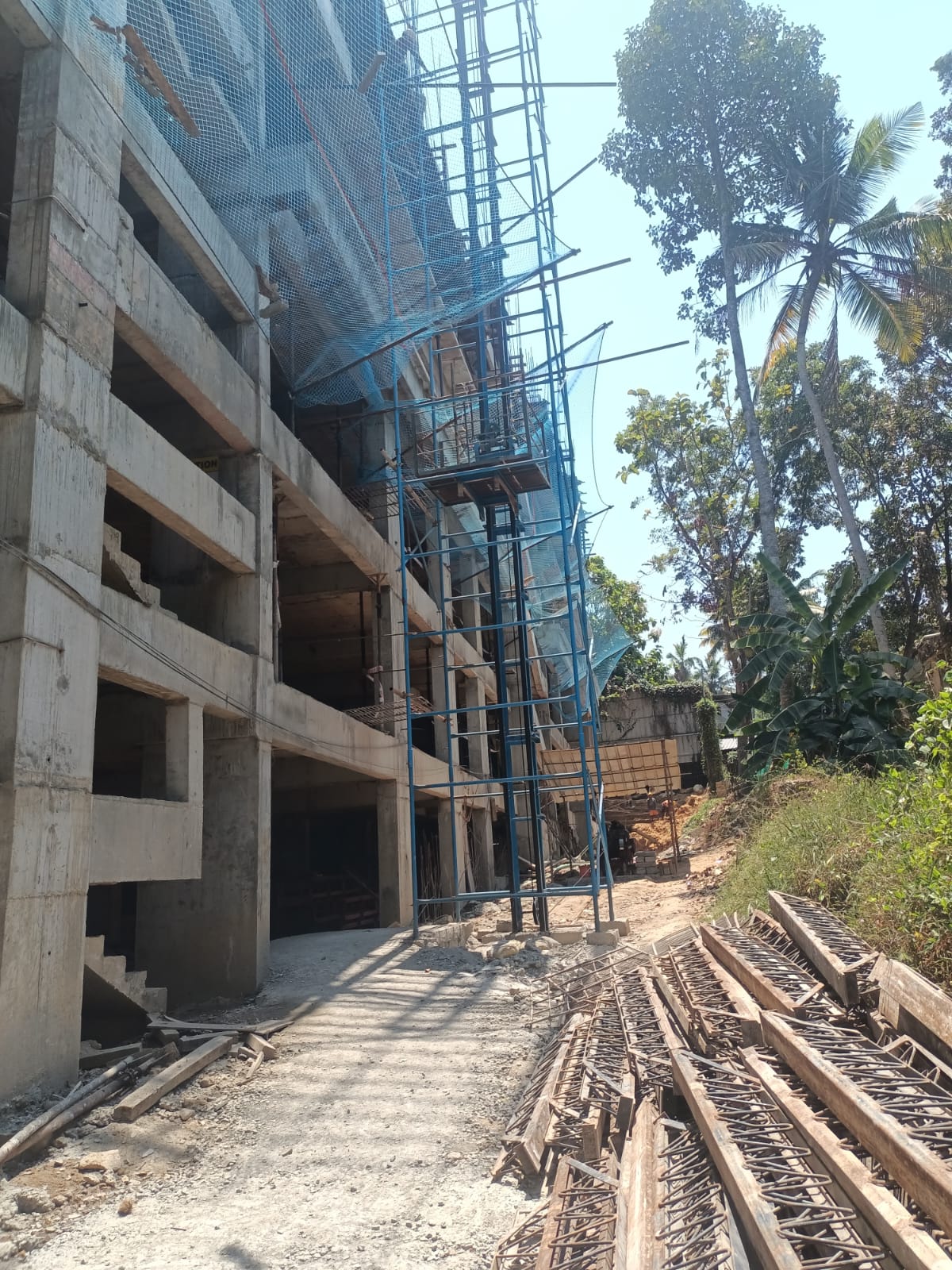

- RCC FOR 5TH FLOOR SLAB – 100% COMPLETED
- FORMWORK FOR 6TH FLOOR SLAB – 100% COMPLETED
- STEEL WORK FOR 6TH FLOOR SLAB – 100% COMPLETED
- RCC FOR 6TH FLOOR SLAB – 100% COMPLETED
- RCC FOR COLUMN – 6TH TO 7TH FLOOR – 100% COMPLETED
- FORM WORK FOR 7TH FLOOR SLAB-35% COMPLETED
- CEILING PLASTERING – 14 OUT OF 49 APTS COMPLETED
- MASONRY WORK – 13 OUT OF 49 APTS COMPLETED
- BALCONY HANDRAIL FIXING – 8 OUT OF 49 APTS COMPLETED

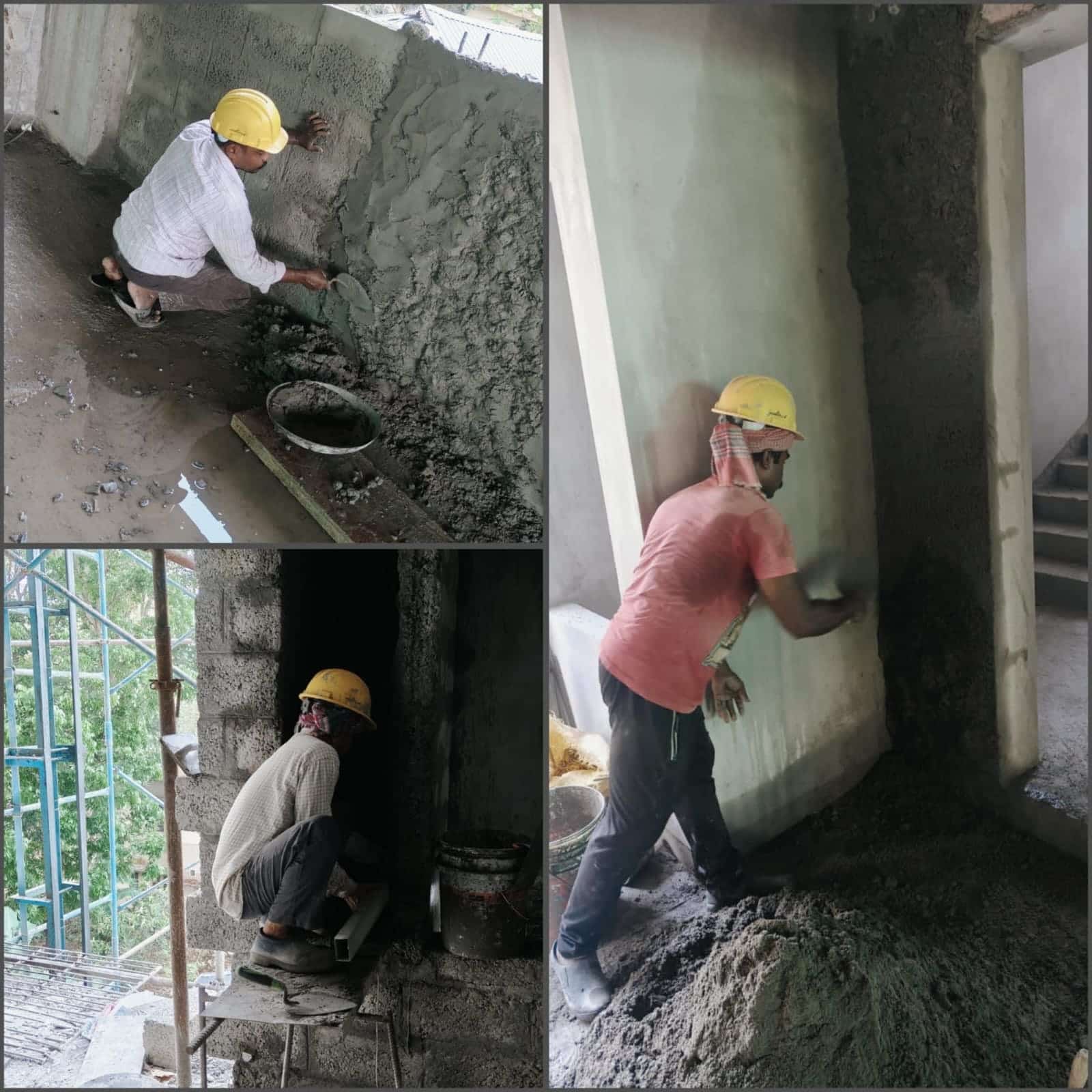

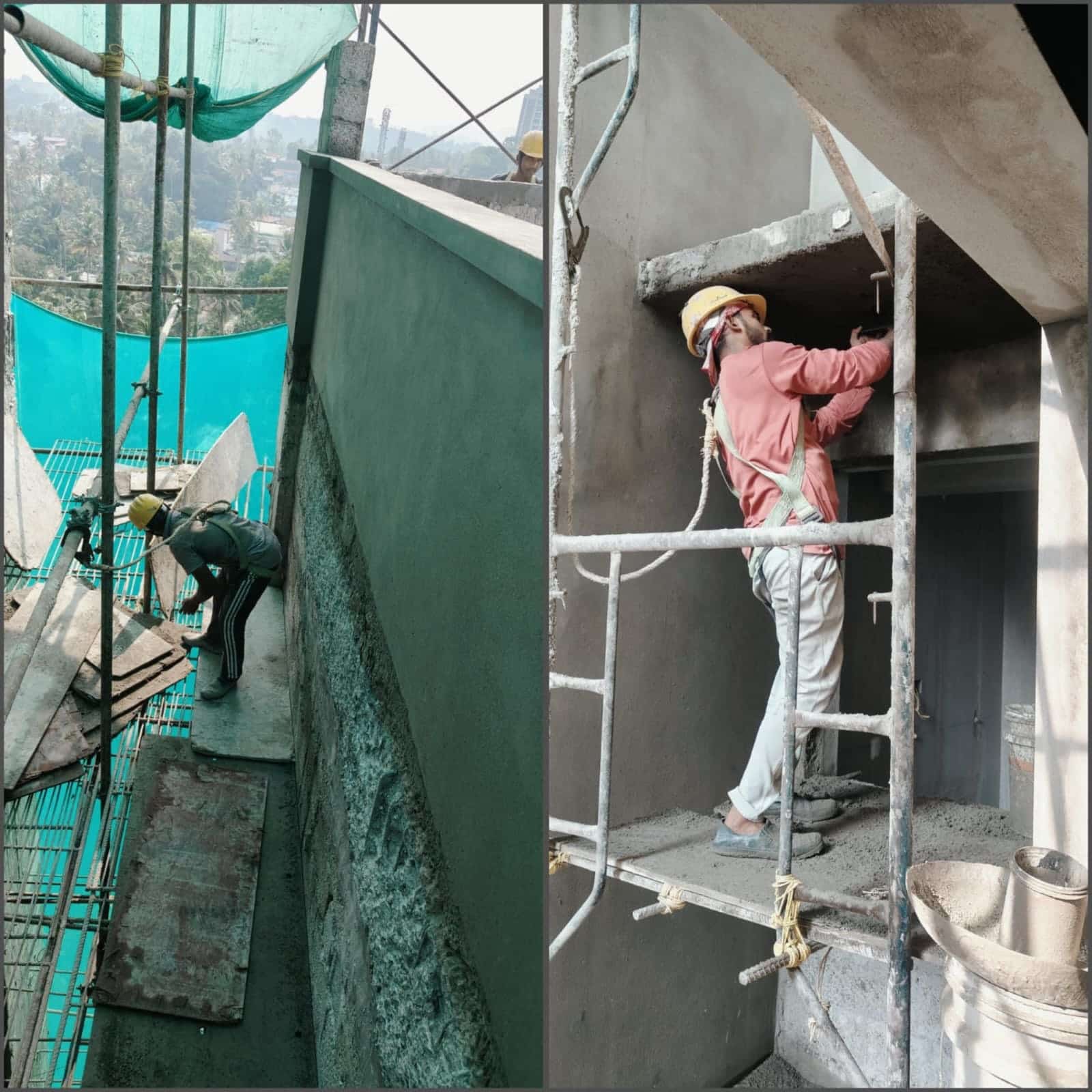

PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 07.05.2024

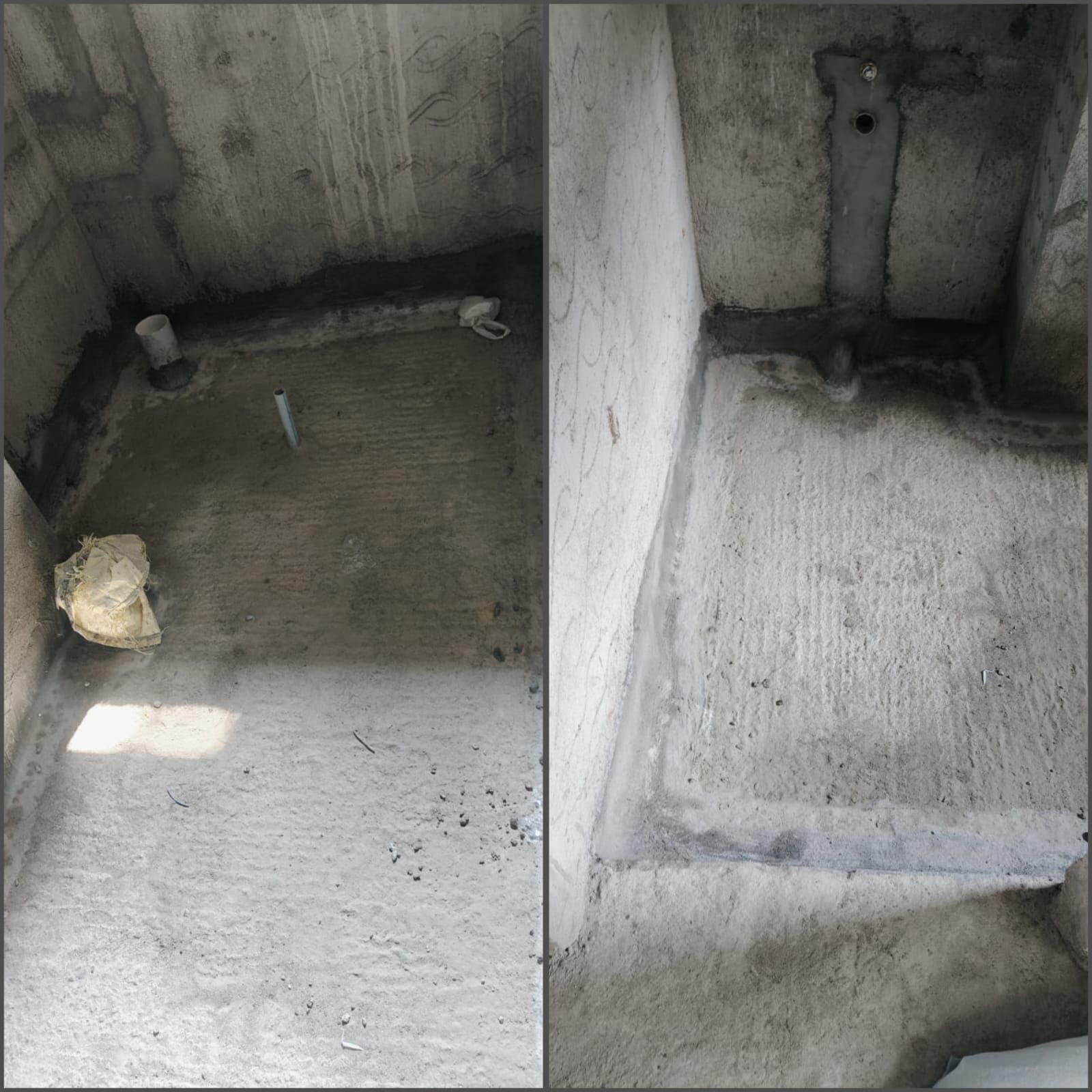

- RCC FOR 4TH FLOOR SLAB – 100% COMPLETED
- FORMWORK FOR 5TH FLOOR SLAB – 95% COMPLETED
- STEELWORK FOR 5TH FLOOR SLAB – 80% COMPLETED
- RCC FOR 5TH FLOOR SLAB – 75% COMPLETED
- RCC FOR COLUMN – 5TH TO 6TH FLOOR – 54% COMPLETED
- CEILING PLASTERING – 5 APT OUT OF 49 COMPLETED
- MASONRY WORK – 6 APT OUT OF 49 COMPLETED

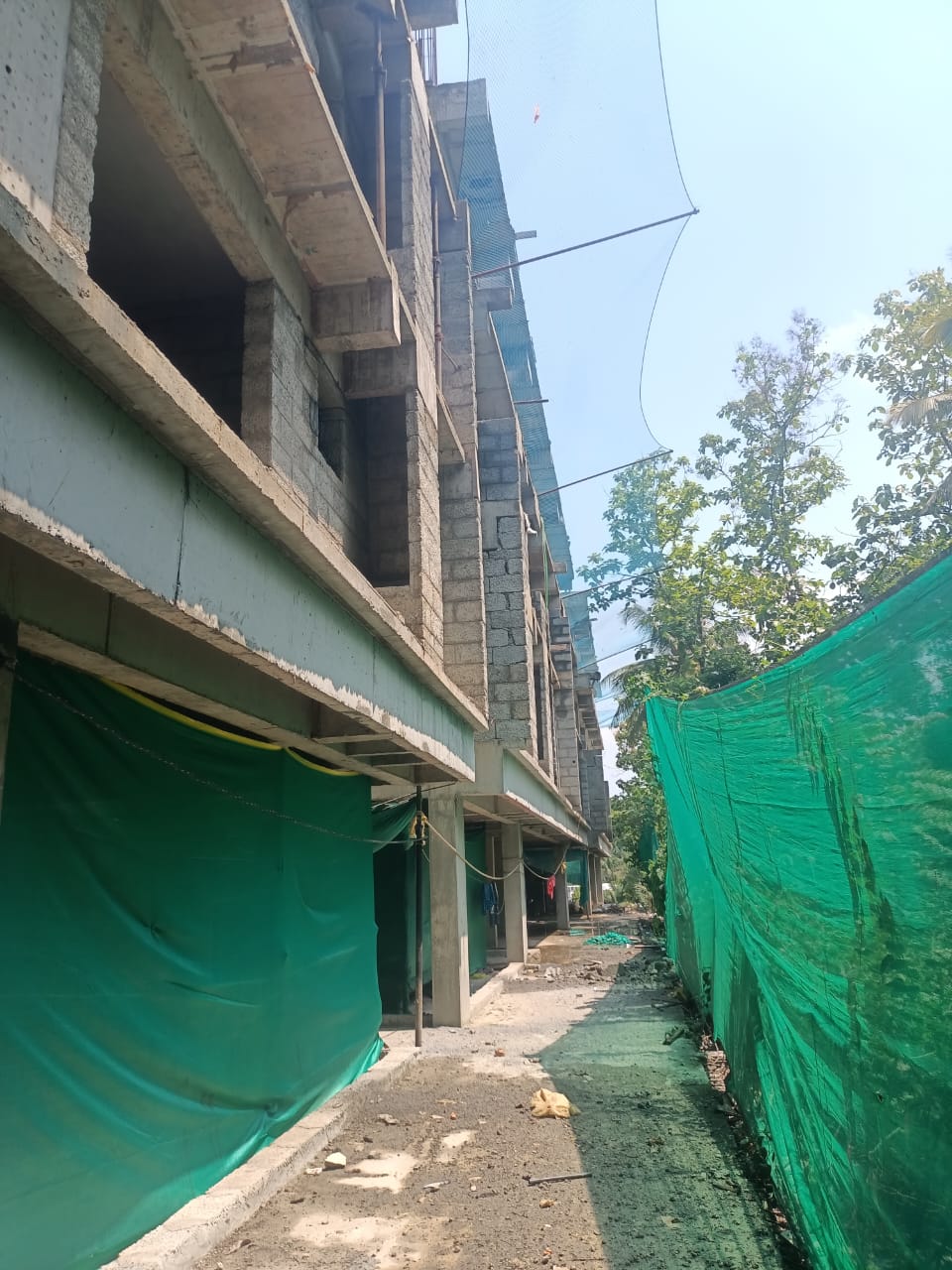

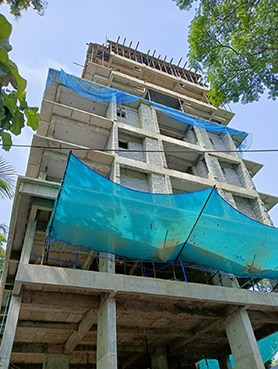

PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 25.03.2024

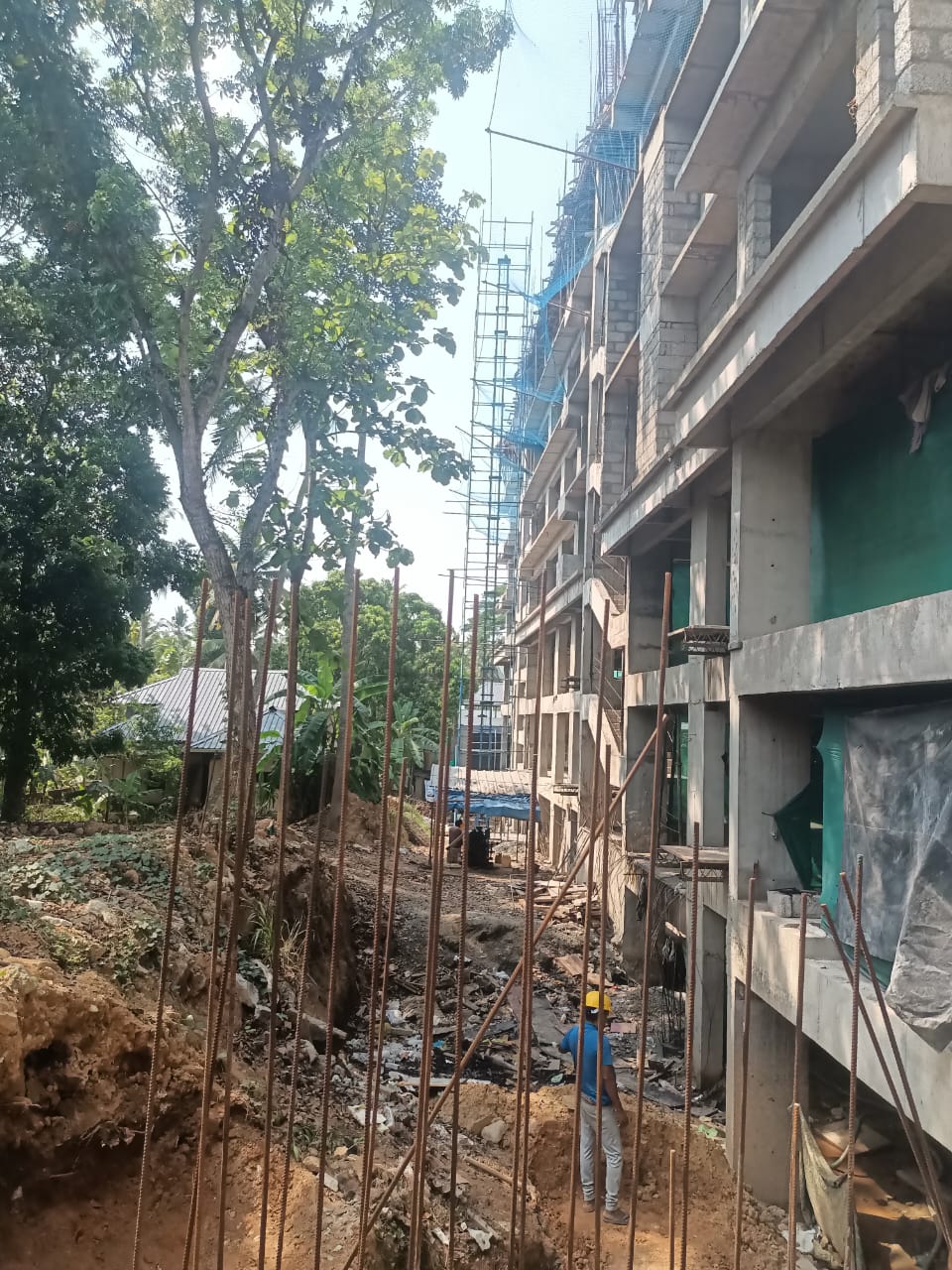

- RCC FOR 3RD FLOOR SLAB – 100% COMPLETED
- RCC FOR COLUMN 3RD – 4TH FLOOR – 100% COMPLETED
- RCC FOR 4TH FLOOR SLAB – 100% COMPLETED

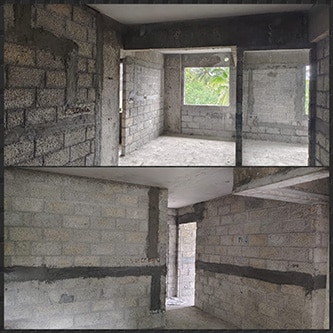

- MASONRY WORK – 2A & 2B STARTED
PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 12.02.2024

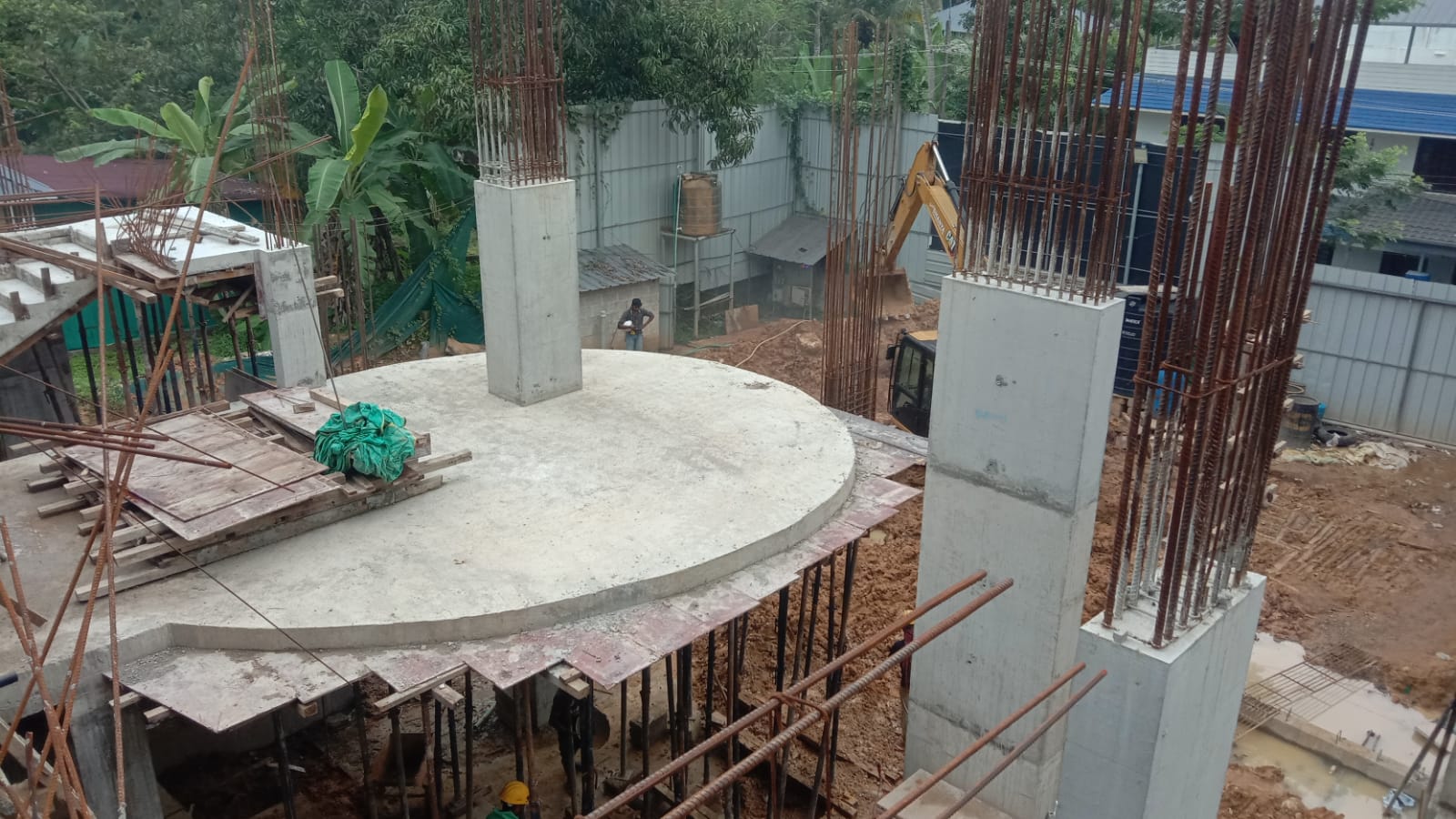

- RCC FOR BF1 SLAB – 100% COMPLETED
- RCC FOR GROUND FLOOR SLAB – 100% COMPLETED
- RCC FOR 1st FLOOR SLAB – 100% COMPLETED
- RCC FOR 2nd FLOOR SLAB – 100% COMPLETED
- RCC FOR COLUMN 2nd – 3rd Floor – 28 NOS OUT OF 46 COMPLETED
- FORMWORK FOR 3rd FLOOR SLAB – 35% COMPLETED
PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 30.12.2023

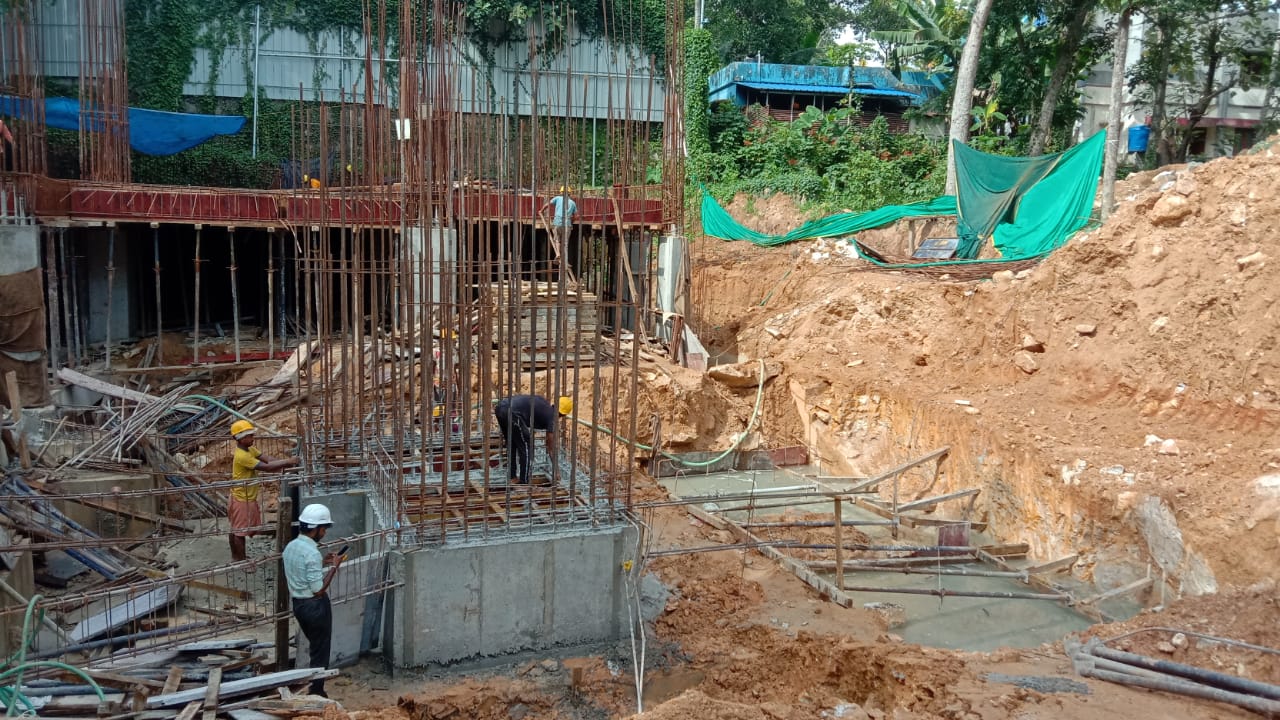

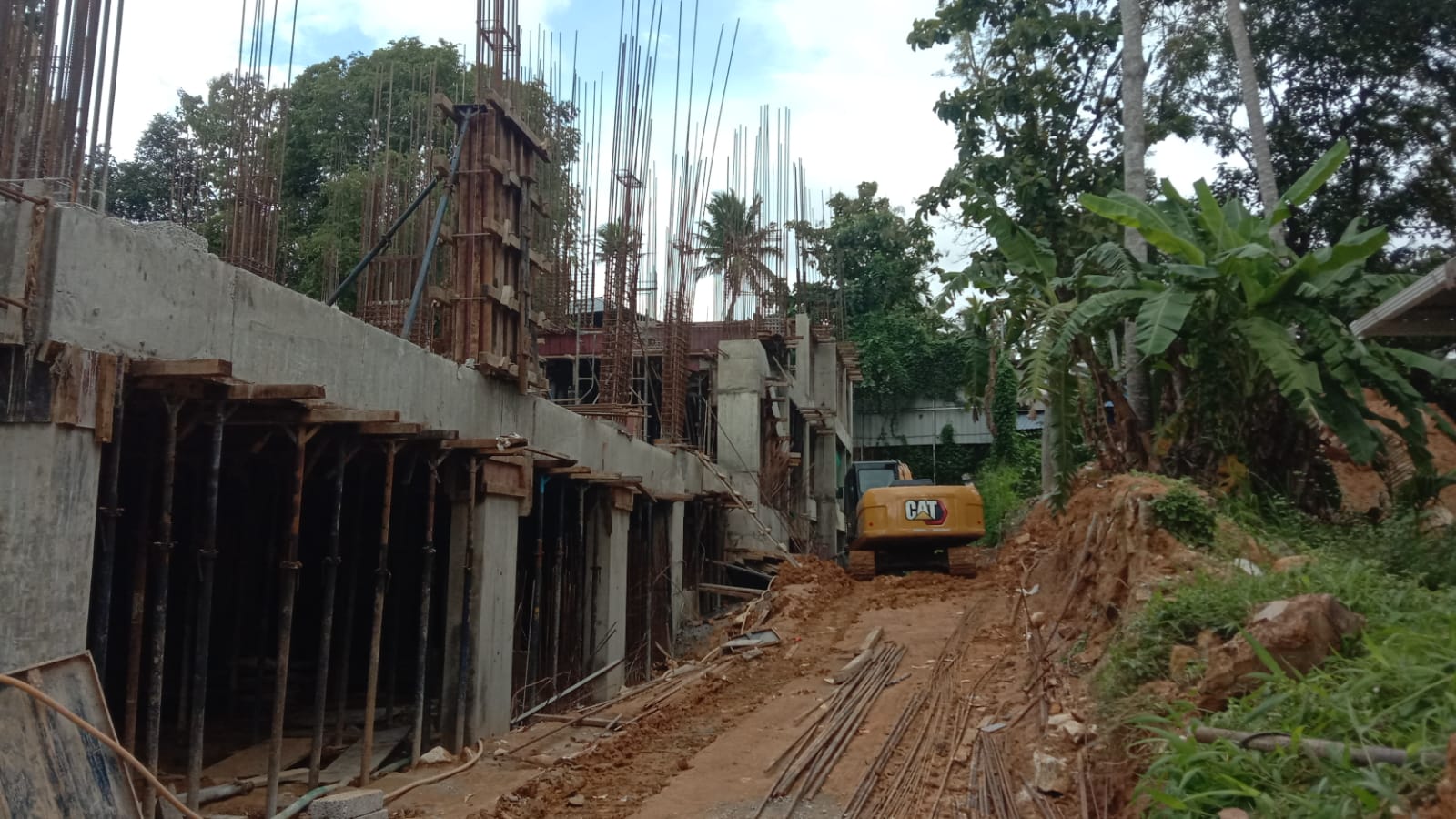

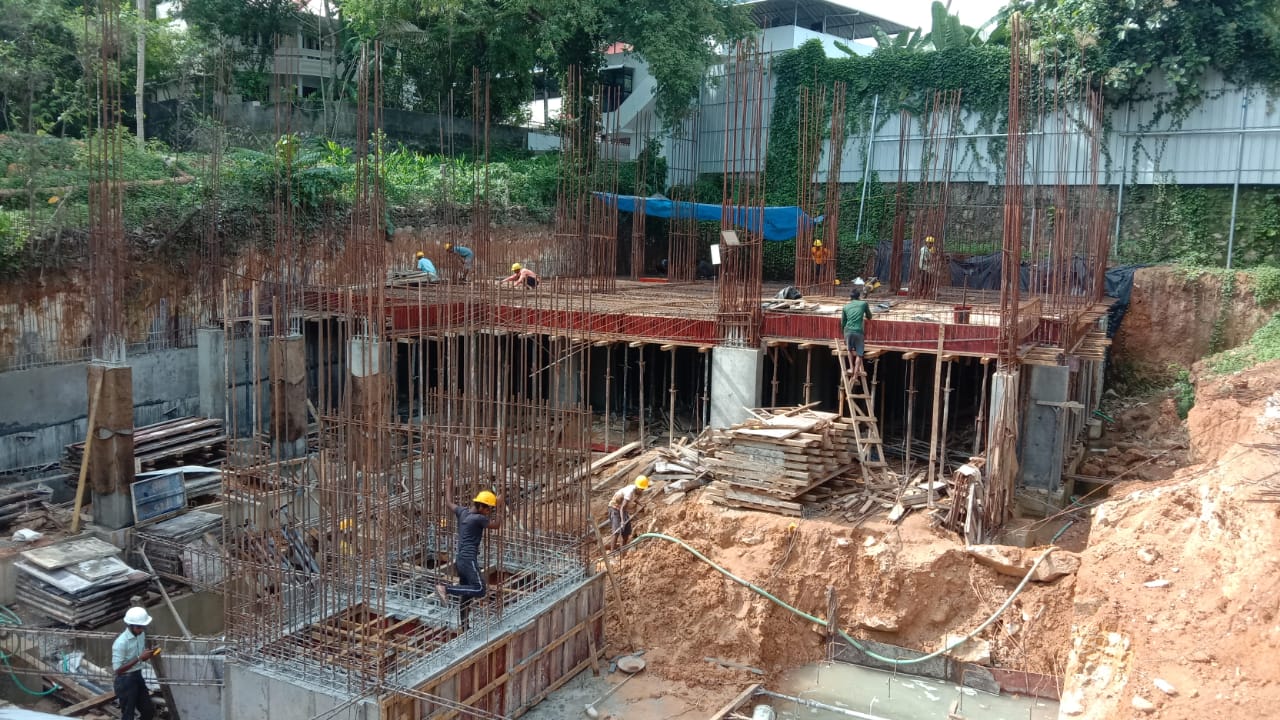

- FOUNDATION EXCAVATION (ROCK CUTTING) – 100% COMPLETED
- PCC FOR COLUMN FOOTING – 100% COMPLETED
- RCC FOR RET WALL (BASEMENT FLOOR 2 – BASEMENT FLOOR 1) – 53 MTR COMPLETED
- RCC FOR BASEMENT FLOOR 1 SLAB – 100% COMPLETED
- RCC FOR BASEMENT TO GROUND FLOOR-100% COMPLETED
- RCC FOR GROUND FLOOR SLAB – 100% COMPLETED
- RCC FOR GROUND FLOOR-1ST FLOOR -100% COMPLETED
- RCC FOR 1st FLOOR SLAB – 100% COMPLETED
- RCC FOR COLUMN 1ST – 2nd Floor – 25 OUT OF 46 COMPLETED
- FORMWORK FOR 2ND FLOOR- 30%

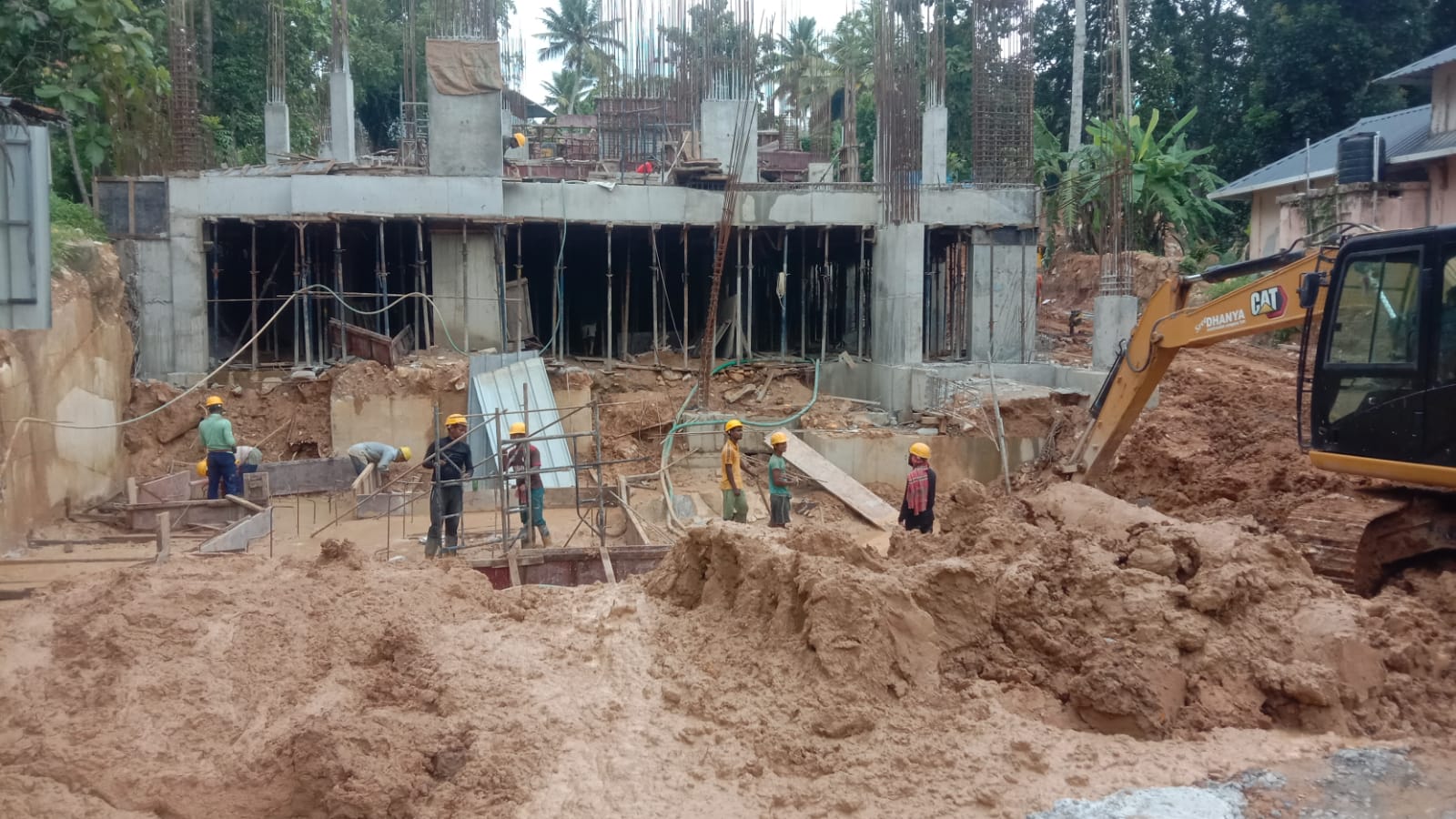

PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 24.11.2023
- FOUNDATION EXCAVATION (ROCK CUTTING) – 99% COMPLETED
- PCC FOR COLUMN FOOTING – 47 OUT OF 47 NOS COMPLETED
- RCC FOR COLUMN FOOTING – 47 OUT OF 47 NOS COMPLETED
- RCC FOR COLUMN (BASEMENT FLOOR 2– BASEMENT FLOOR 1) – 54 OUT OF 54 NOS COMPLETED
- RCC FOR RET WALL (BASEMENT FLOOR 2 – BASEMENT FLOOR 1) – 53 MTR COMPLETED
- RCC FOR BASEMENT FLOOR 1 SLAB –100% COMPLETED
- RCC FOR COLUMN BASEMENT FLOOR 1 – GROUND FLOOR – 50 OUT OF 53 COMPLETED
- RCC FOR GROUND FLOOR SLAB – 80% COMPLETED
- RCC FOR COLUMN GROUND FLOOR-1ST FLOOR – 34 OUT OF 40
- FORMWORK FOR 1ST FLOOR SLAB – 50% COMPLETED
- STEELWORK FOR 1ST FLOOR SLAB – 25% COMPLETED

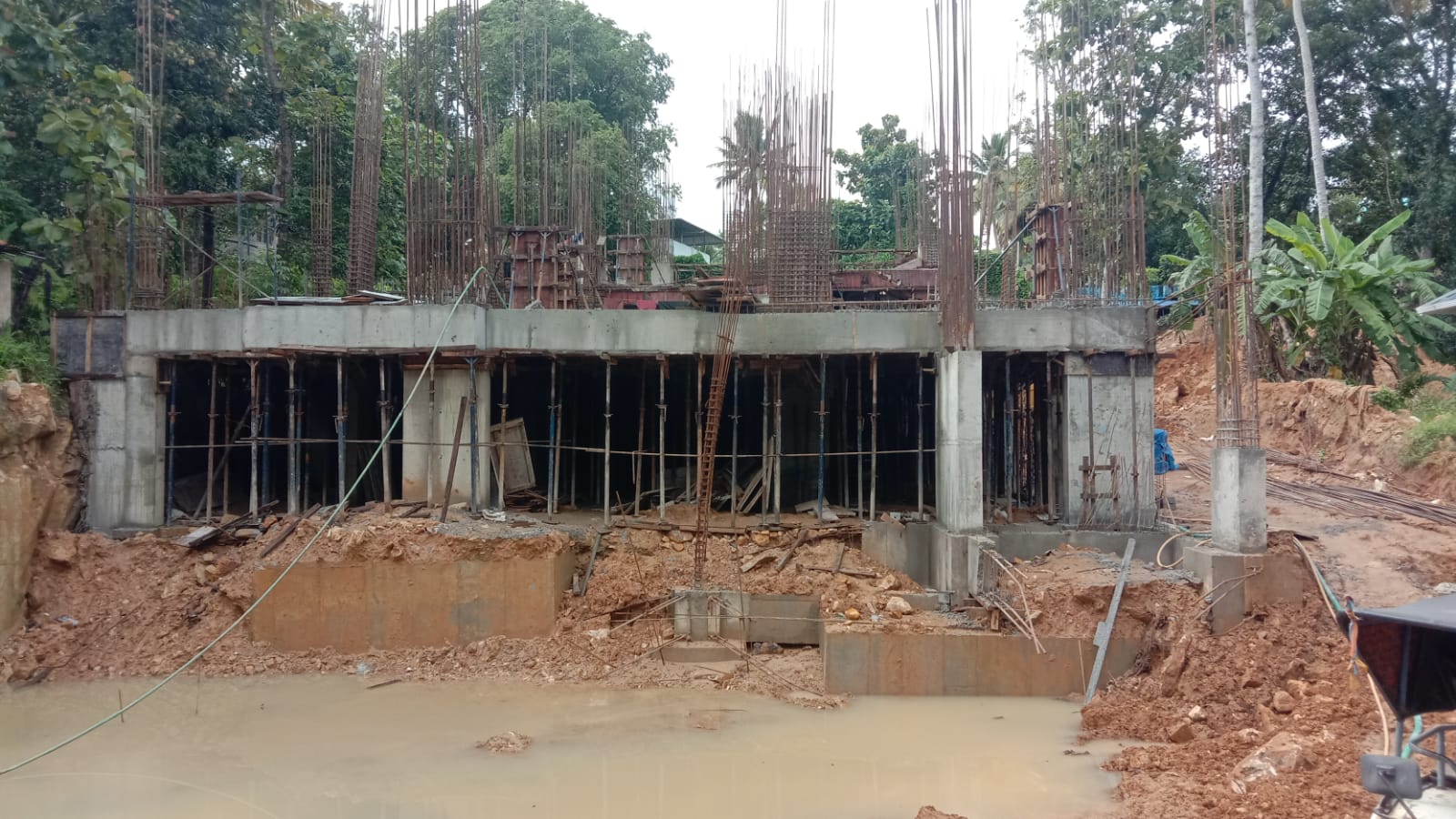

PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 25.09.2023
- FOUNDATION EXCAVATION (ROCK CUTTING) – 95% COMPLETED
- PCC FOR COLUMN FOOTING – 39 OUT OF 47 NOS COMPLETED
- RCC FOR COLUMN FOOTING – 39 OUT OF 47 NOS COMPLETED
- RCC FOR COLUMN (BF2- BF1) – 44 OUT OF 54 NOS COMPLETED
- RCC FOR RET WALL (BF2-BF1) – 53 MTR COMPLETED
- FORMWORK FOR BF1 SLAB – 95% COMPLETED
- STEELWORK FOR BF1 SLAB – 95% COMPLETED
- RCC FOR BF1 SLAB – 95% COMPLETED
- RCC FOR COLUMN BF1 – GF – 40 OUT OF 54 NOS COMPLETED
- RCC FOR GROUND FLOOR SLAB – 40% COMPLETED
PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 14.06.2023
- FOUNDATION EXCAVATION (ROCK CUTTING)- 85% COMPLETED
- PCC FOR COLUMN FOOTING – 28 NOS OUT OF 47 NOS COMPLETED
- RCC FOR COLUMN FOOTING-24 NOS OUT OF 47 NOS COMPLETED
- RCC FOR COLUMN (BF2- BF1)- 24 NOS OUT OF 53 NOS COMPLETED
- RCC FOR RET WALL (BF2-BF1)- 33 MTR COMPLETED
- FORM WORK FOR BF1 SLAB- 35% COMPLETED
- STEEL WORK FOR BF1 SLAB- 30% COMPLETED

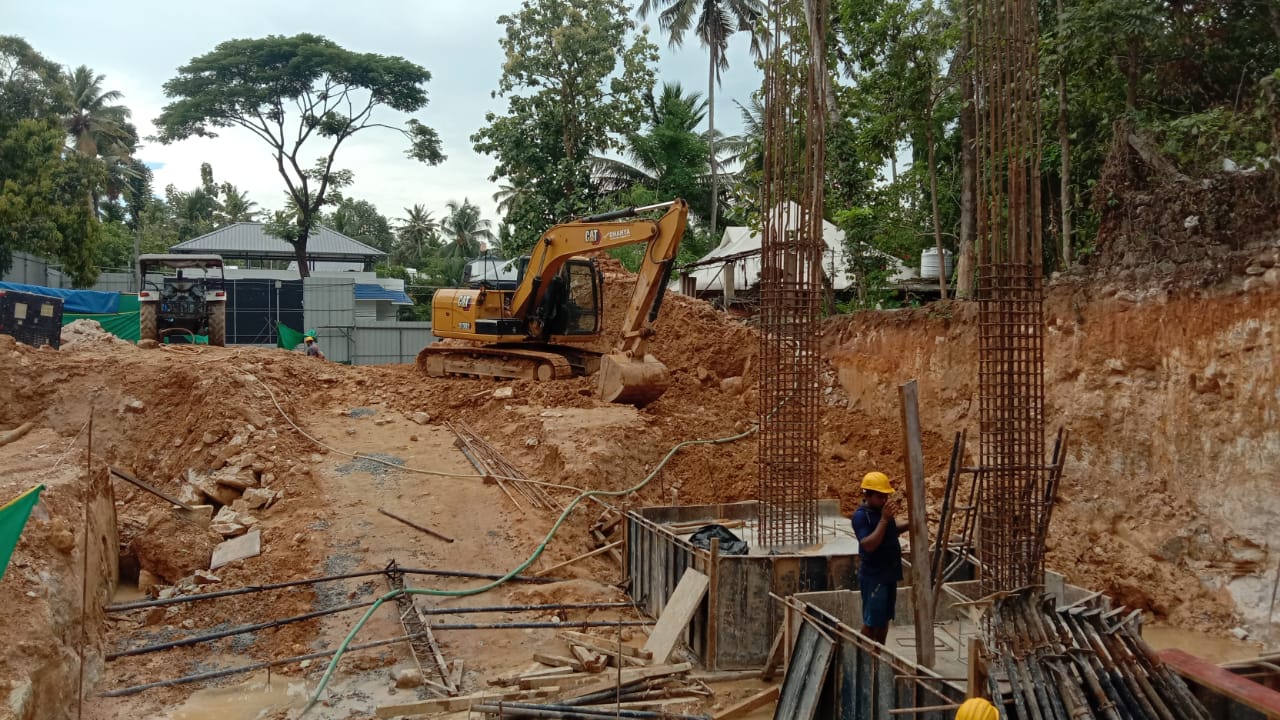

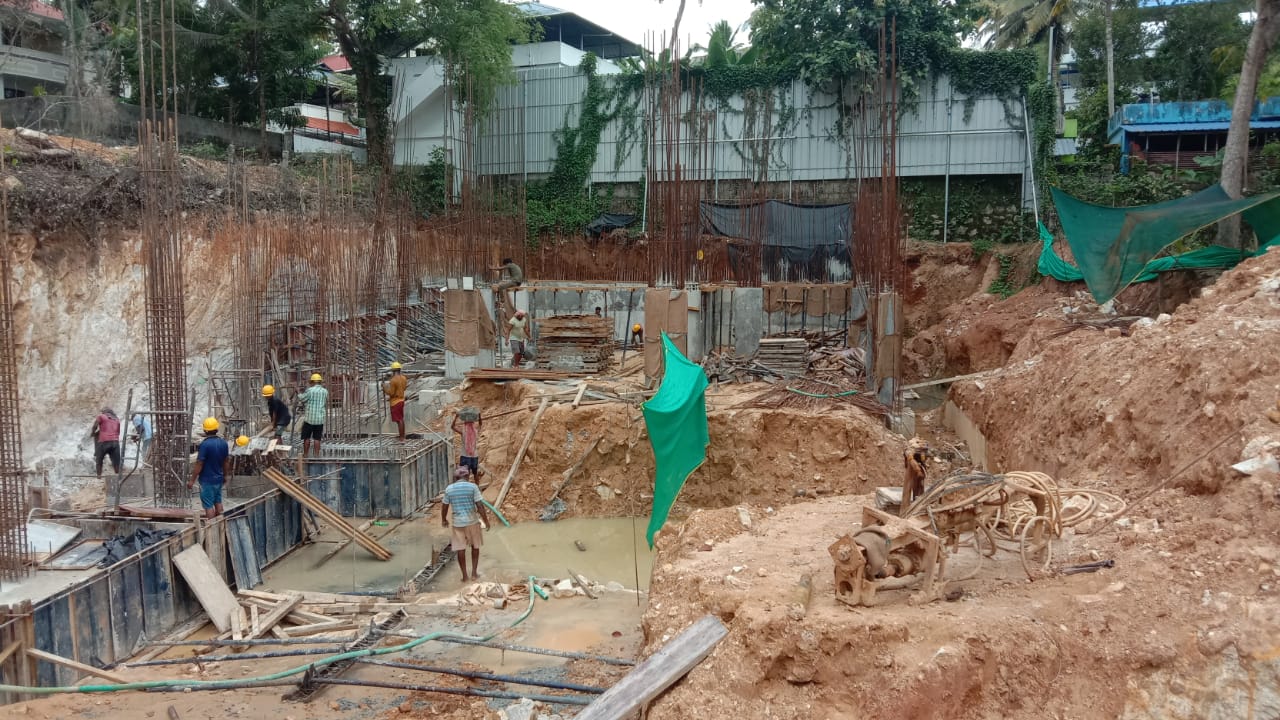

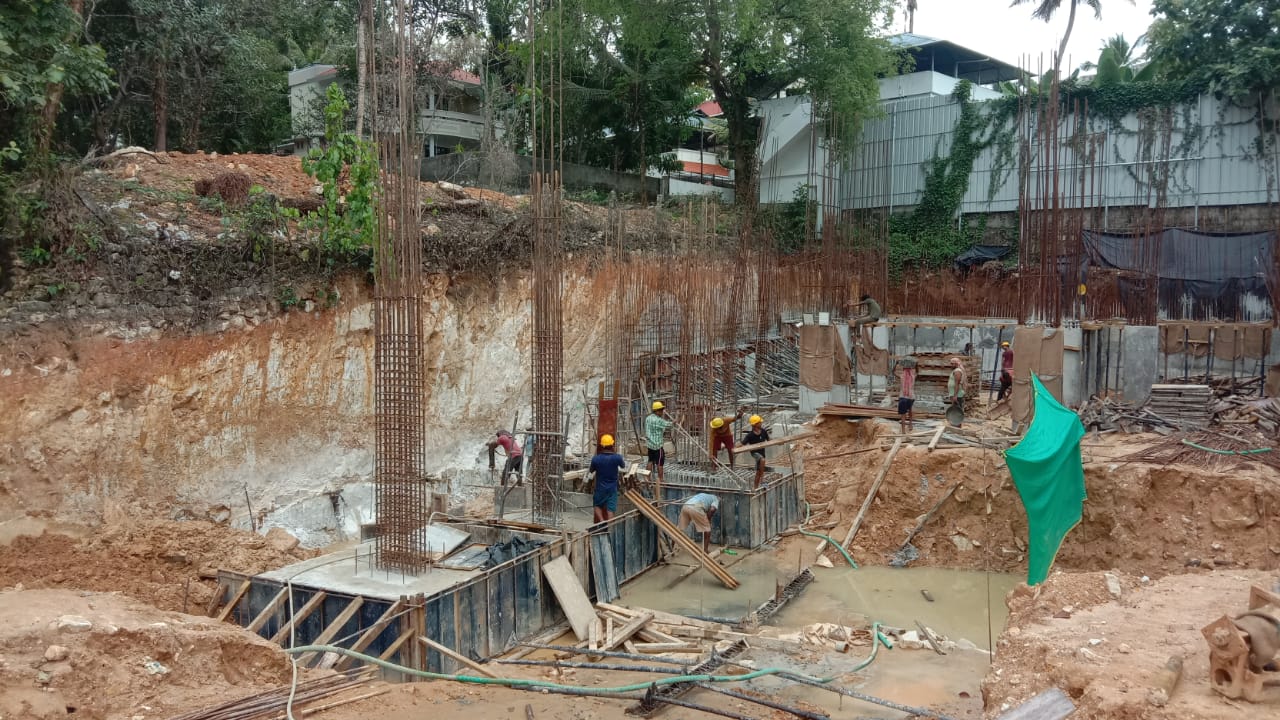

PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 06.05.2023

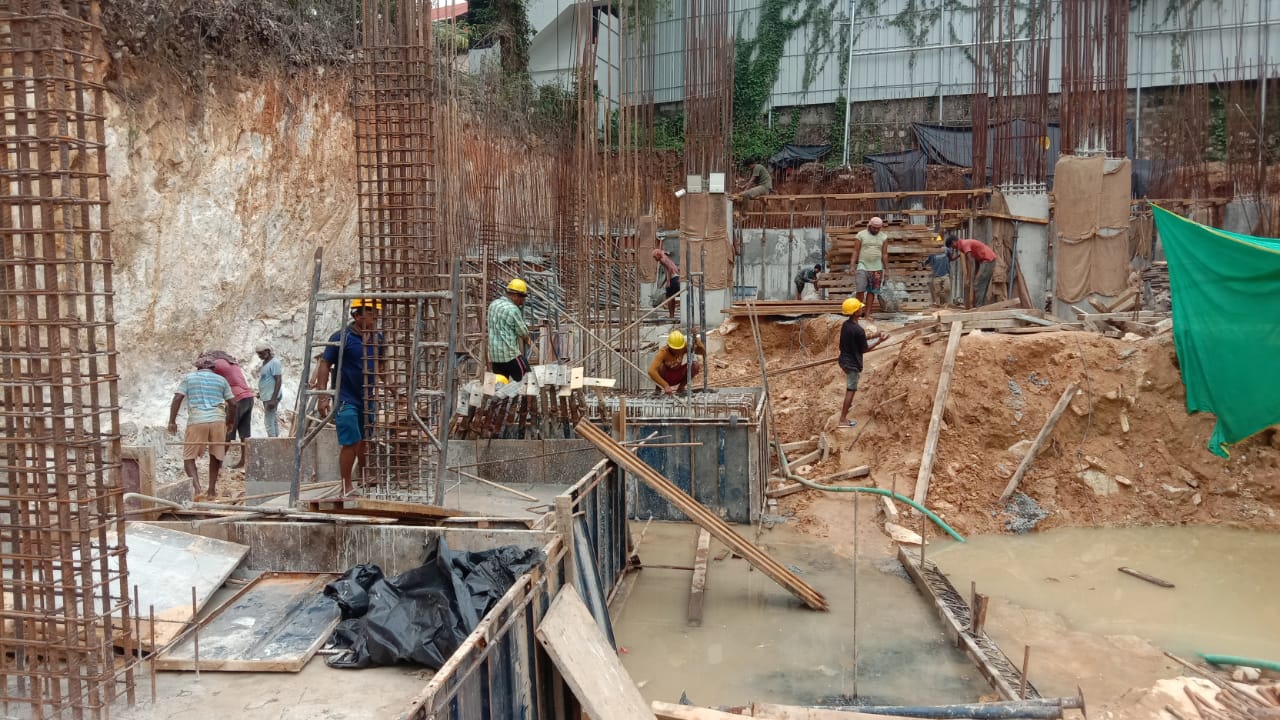

- FOUNDATION EXCAVATION (ROCK CUTTING) – 80% COMPLETED
- PCC FOR COLUMN FOOTING – 16 OUT OF 47 NOS COMPLETED
- RCC FOR COLUMN FOOTING – 16 OUT OF 47 NOS COMPLETED
- RCC FOR COLUMN (BASEMENT FLOOR 2 – BASEMENT FLOOR 1) – 13 OUT OF 47 NOS COMPLETED
- RCC FOR RETAINING WALL (BASEMENT FLOOR 2 – BASEMENT FLOOR 1) – 18 MTR COMPLETED
PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS OF 18.03.2023
- FOUNDATION EXCAVATION (ROCK CUTTING) – 70% COMPLETED
- PCC FOR COLUMN FOOTING – 8 OUT OF 47 NOS COMPLETED

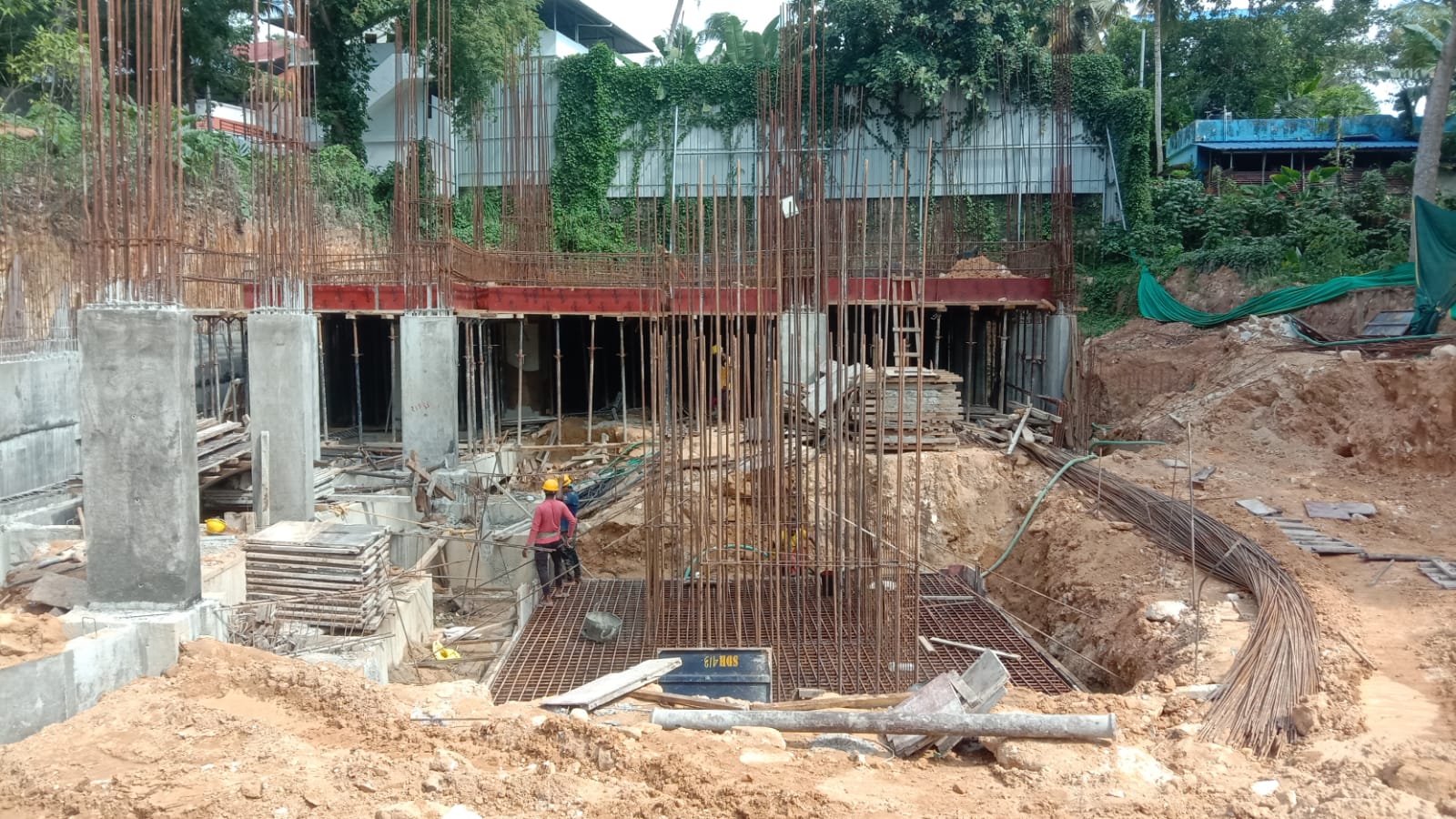

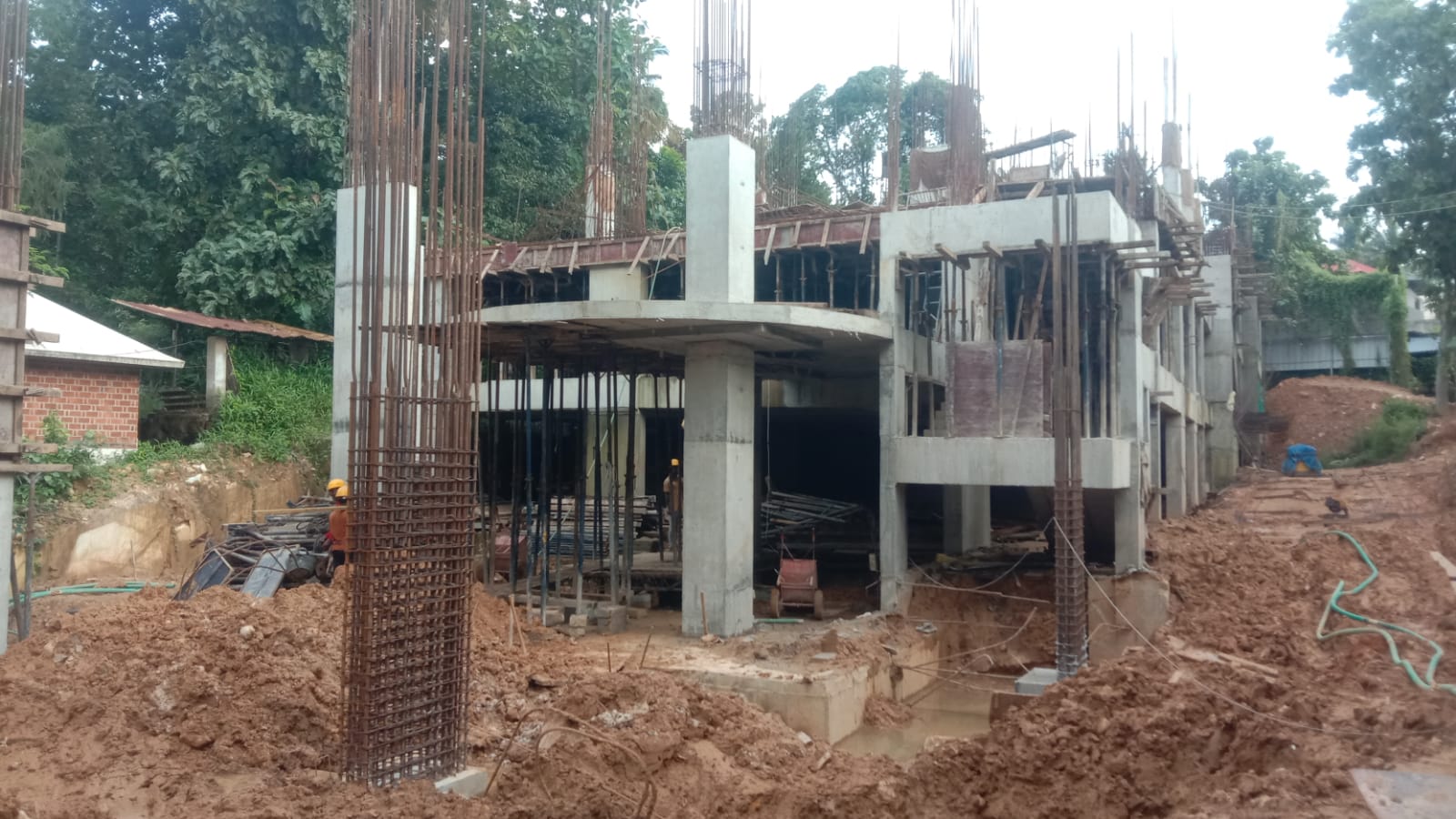

PROJECT STATUS REPORT OF ANKLETS BY SREEDHANYA AS ON 02.02.2023
- FOUNDATION EXCAVATION (ROCK CUTTING) – 30% COMPLETED
