A.I.
A.I.
BY SREEDHANYA HOMES
YOUR ARTIFICIALLY INTELLIGENT HOME
2/3&4 BHK APARTMENTS-KURAVANKONAM
Sree Dhanya Homes proudly introduces Kerala’s first artificially intelligent smart home project in Thiruvananthapuram – A.I. by Sree Dhanya Homes. A block of 17 storeys with 2/3 and 4 BHK homes, this future-proof project comes with the revolutionizing technological advantage accorded by artificial intelligence. It simply rewrites the tales of living space comfort and convenience through a bevy of automated functions. Welcome the pack of luxury that gifts you with more time, more freedom and more convenience.With state-of-the-art screen for complete control of your living and dining room, voice controlled home automation system and guest entry access controlled from inside your home, life at A.I. by Sree Dhanya Homes smart home takes you way ahead to future.
HIGHLIGHTS
LOCATION
Being built at Kuravankonam in the city of Thiruvananthapuram, A.I. by Sree Dhanya Homes presents you with the glamour of a city life with access to all important places including government and private offices, hospitals, schools, colleges, airport, shops and establishments, malls and entertainment facilities. Really a location the elite prefer for a calm and quiet city life.
Features
- AUTOMATED BOOM BARRIER
- ACCESS CONTROLLED LOBBY
- LOBBY WITH MOOD LIGHTING
- SMART LIGHTING IN CAR PARKING
- SMART LIGHTING IN LANDSCAPE AREA
- AUTOMATED LIGHTING IN SWIMMING POOL
- AUTOMATED LIGHTS IN GYM
- AUTOMATED GAS LEAK DETECTOR
- ACCESS CONTROLLED LIFT
- AUTOMATED GARDEN WATERING SYSTEM
- AUTOMATED HAND SANITIZER AT LOBBY ENTRANCE
- WI-FI ENABLED BASEMENT PARKING
- CENTRAL CONTROL PANEL
- AUTOMATED DOOR LOCKS
- AUTOMATED SMOKE DETECTOR
- CENTRALIZED COMMUNICATION HUB
- GUEST ENTRY ACCESS AT LOBBY CONTROLLED FROM APARTMENT
- RETICULATED GAS LINE WITH USAGE MONITOR
- PANIC BUTTON
- COMMON AREA CAMERA ACCESS INSIDE APARTMENT
- ELECTRIC CAR CHARGING PROVISION IN EVERY CAR PARK
- USB PORTS IN EVERY ROOM
- LIFT CALL FEATURE FROM WITHIN APARTMENT
Amenities
- SKY WALK ON TERRACE
- ROOFTOP SWIMMING POOL
- 24 HOUR POWER BACK-UP
- WASTE MANAGEMENT SYSTEM
- ROUND THE CLOCK SECURITY
- FITNESS CENTER
- ROOFTOP PARTY AREA
- RECREATION ROOM
- CRÈCHE
- ASSOCIATION HALL
- KID’S PLAY AREA
- NET CRICKET
- INDOOR BADMINTON COURT
- SERVANTS TOILET ON EVERY FLOOR

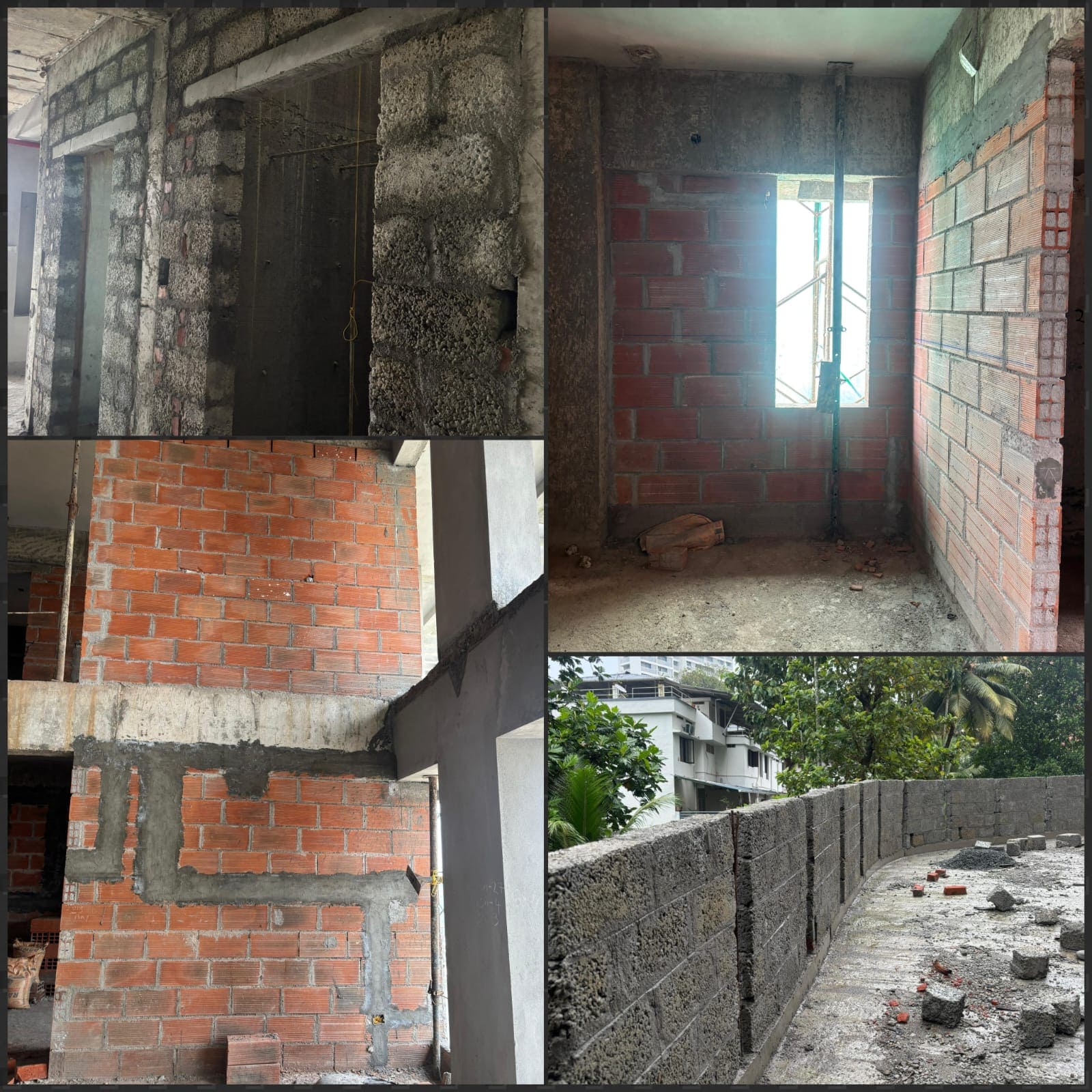

Foundation and structure
RCC Framed structure with Pile foundation
Doors
Front Door: Engineered Wood Pre-hung doors of Jac Wood/Jacson/ferro or equivalent make with digital lock(Yale/ Godrej/ Dorset/ Equivalent
Internal Doors: Hard wood Frame & semi solid Flush door shutters / Pre hung door Make (Fero/ Jac/ Jacson/Equivalent with Mortice lock(Yale/ Godrej/ Dorset/ Equivalent)
Balcony door: UPVC door frame& shutter with Saint-Gobain glass.
Hardware
Godrej/Dorset/Solex /Yale/Equivalent for hinges, tower bolt, magic eye, door catcher etc.
Windows
UPVC frame & shutters saint-Gobain Glass, with MS Grill with painted finish
Flooring

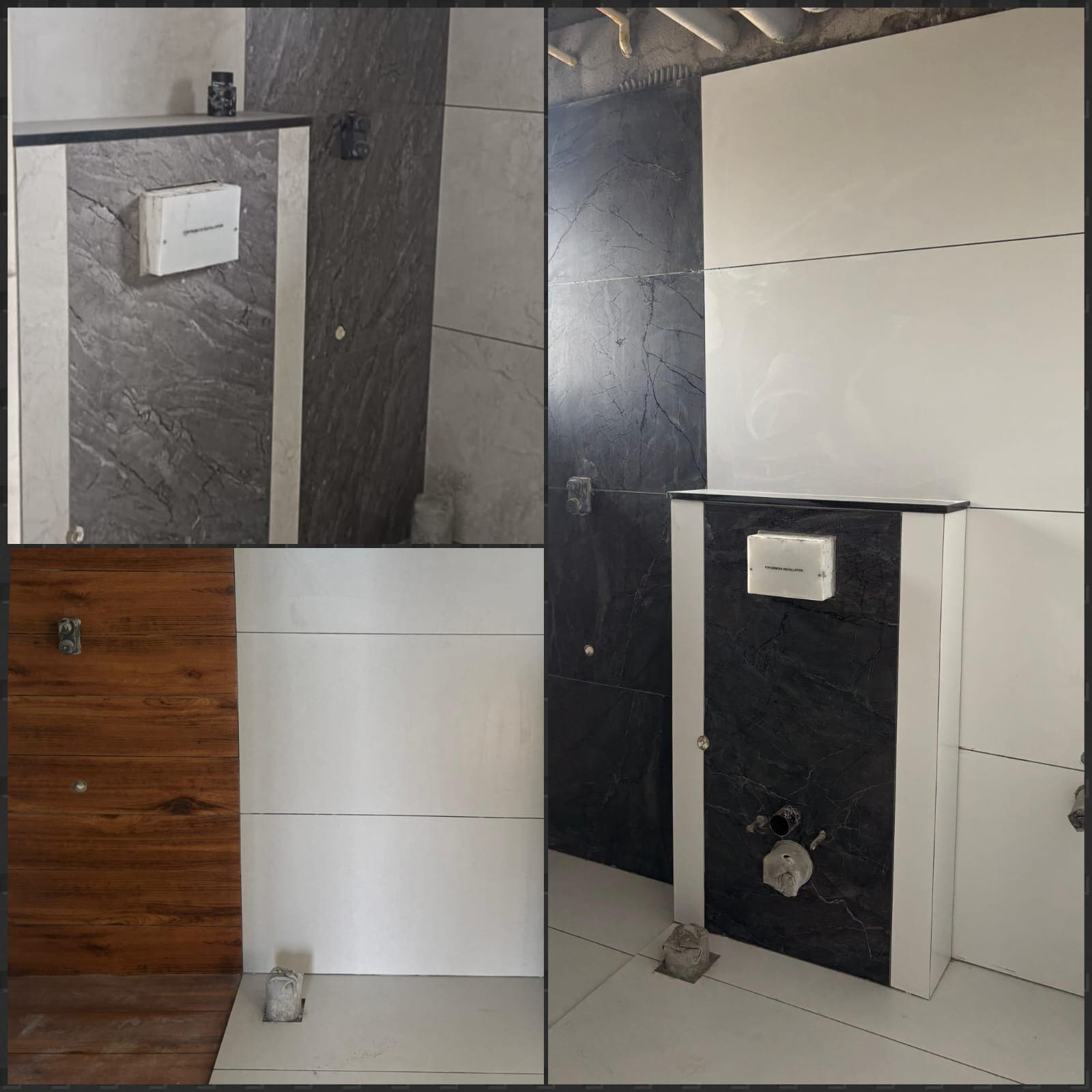

Living/Dining/Bedrooms: Vitrified tiles of size 80cm x 80cm Make: (Johnson/Kajaria/ Nitco/Somany/Asian/ Equivalent
Kitchen: Vitrified tile Flooring of size 60cm x 60cm, Dado Tiles – Ceramic/ Vitrified tiles 60cm height, Quality Black Granite counter top, Stainless steel sink with single drain board Make: (Franke/Reginox/Equivalent), Provision for water purifier.
Work Area: Counter top Granite slab with Single bowl sink, Washing Machine provision
Balcony: Anti-skid tiles Make: (Johnson/Kajaria/Nitco/ Somany/Asian/ Equivalent)

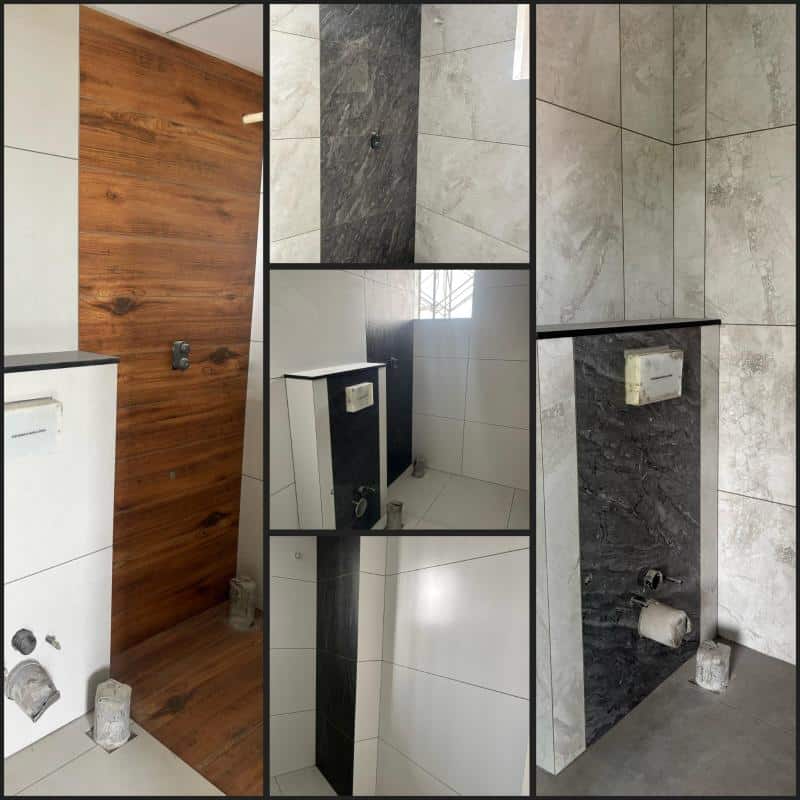

Toilet: Virtified/ceramic wall tile upto the false ceiling height and for flooring Vitrified/ ceramic tile of size 30cm x 30cm Make: (Johnson/Kajaria/Nitco/Somany/Asian/ Equivalent). Provision for Geyser
Common Wash: Counter top wash basin Make: (Vitra/Kohler/ equivalent)
Lift
10 Passenger -3no, 13 passenger/ Bed lift- 1 no with Automatic Rescue Device Make: (Johnson/ Kone/ Mitsubishi/ equivalent)
Electrical
Independent 3 phase wiring Make: (Havells/ V-Guard/Polycab/Finolex/ Equivalent)with ELCB/MCB. Switches of make (Legrand/Havells/Equivalent)
Air-Condition
AC provision shall be given in all bedrooms, Dummy points shall be provided in Living area
Generator
Automatic Changeover to Generator supply for common Lights and Lifts. Power backup for designated points inside of each flat Make: (Cummins/Kirloskar/ Equivalent).
Gas Supply
Reticulated gas supply with individual meters
Telephone and broadband
Concealed connections for telephone in Living and Master bedroom along with provision for broad band connectivity
Sanitary ware/ CP fittings
CP fixtures and sanitaryware of Kohler/Hindware/ Vitra/ Equivalent
Water supply
Round the Clock water supply through sump and overhead tank source from corporation water connection
Painting
Premium emulsion paint for inside walls Make: (Asian/ Berger/ Jotun/ Equivalent) Exterior: Premium exterior paint for external walls make (Asian/ Berger/Jotun / equivalent

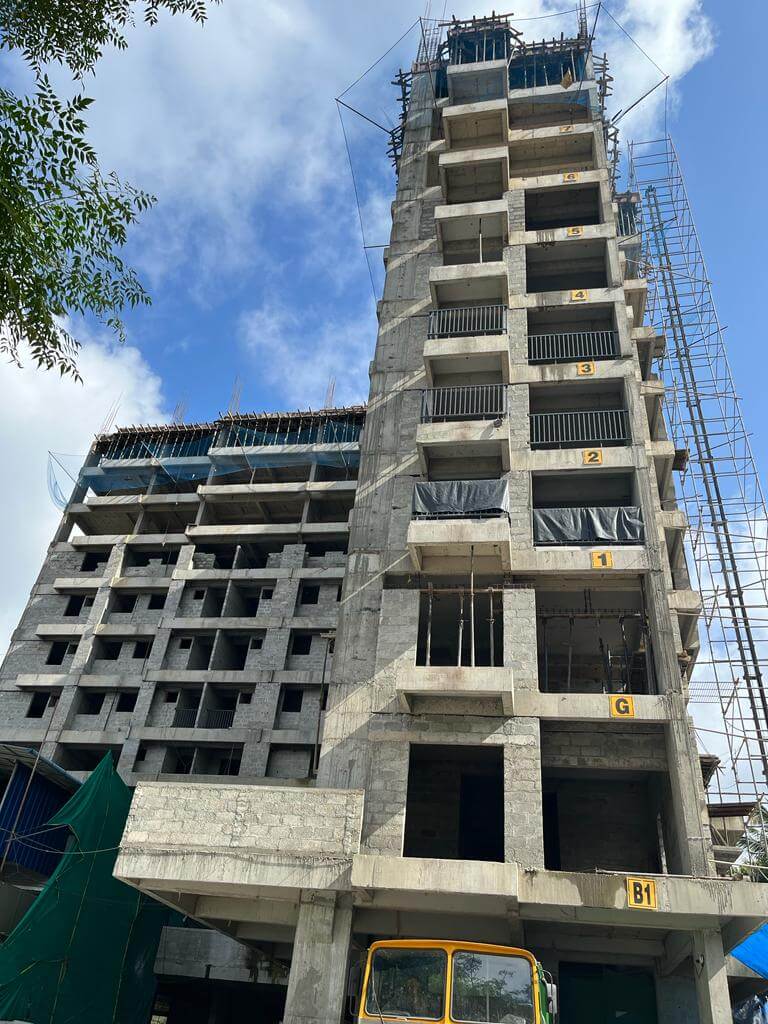

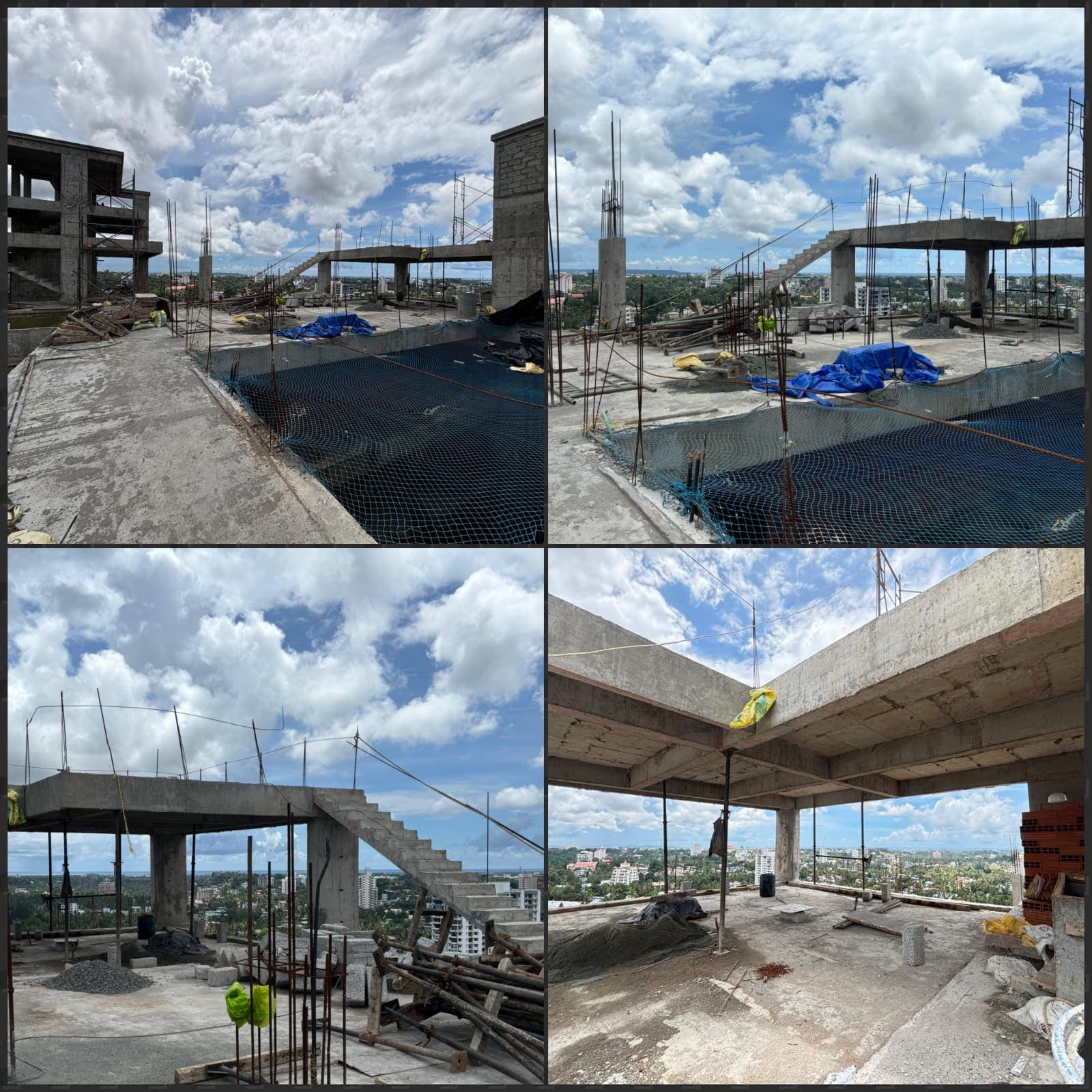

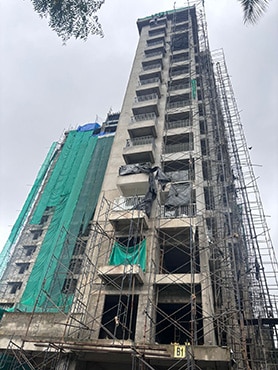

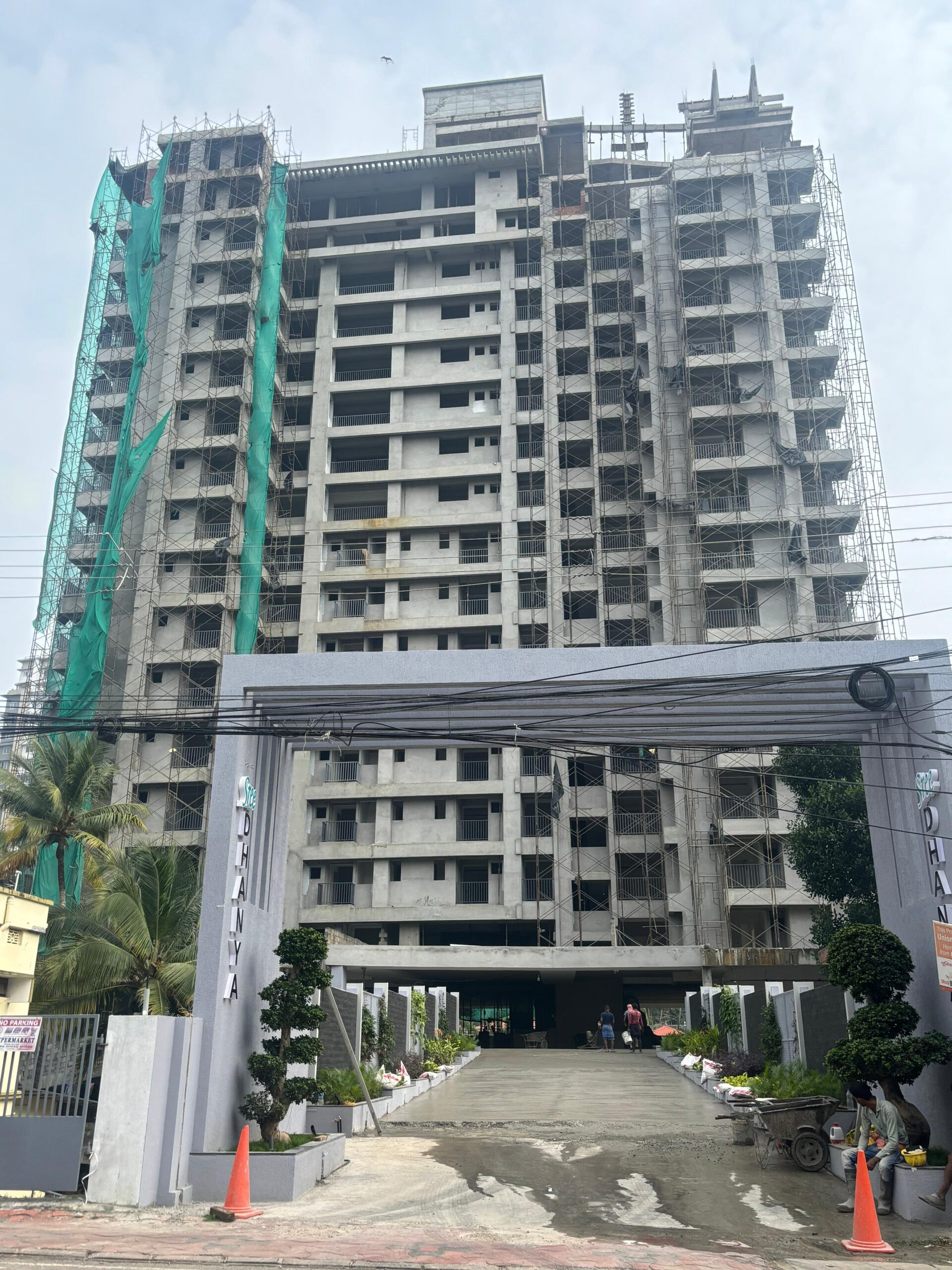

PROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 17th December 2024

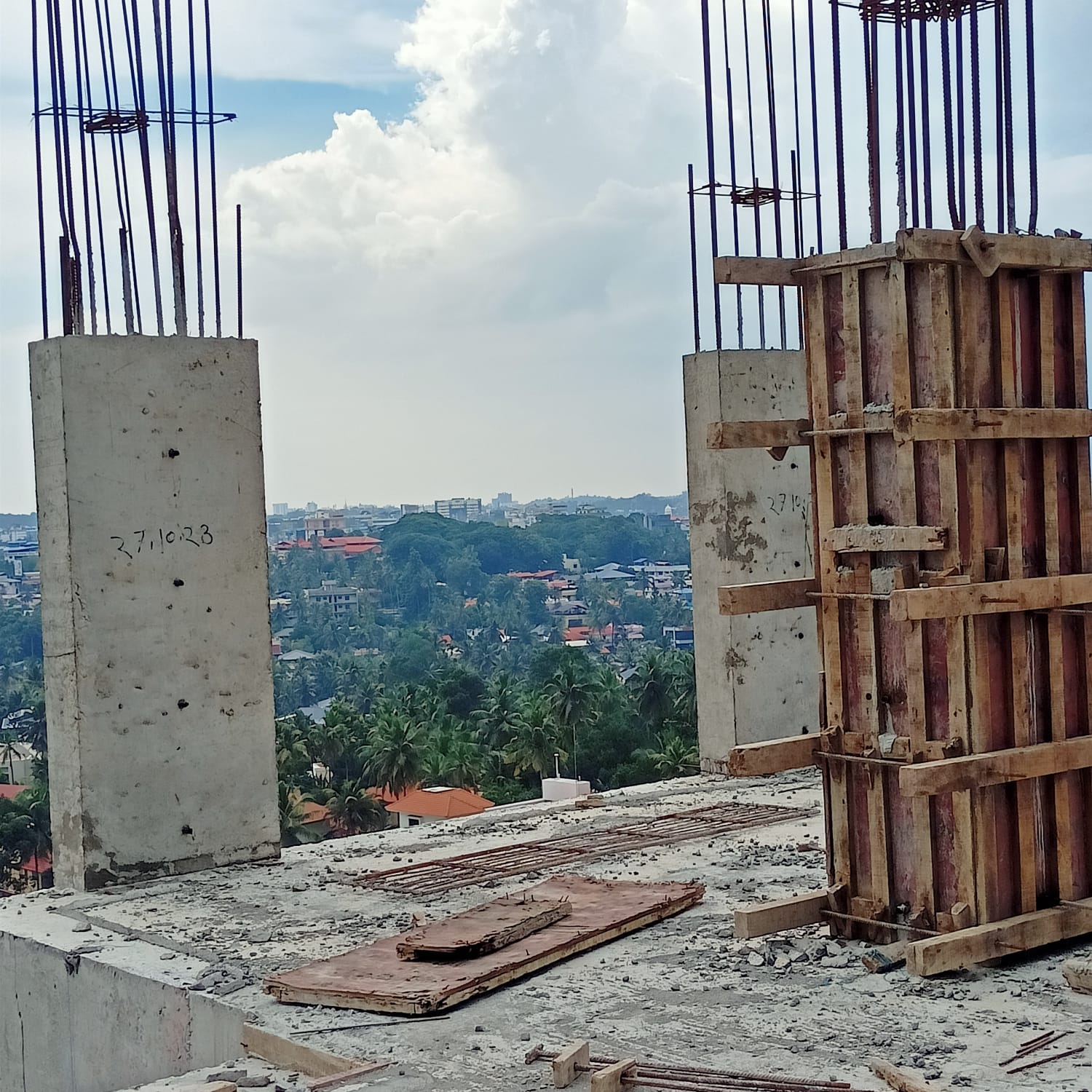

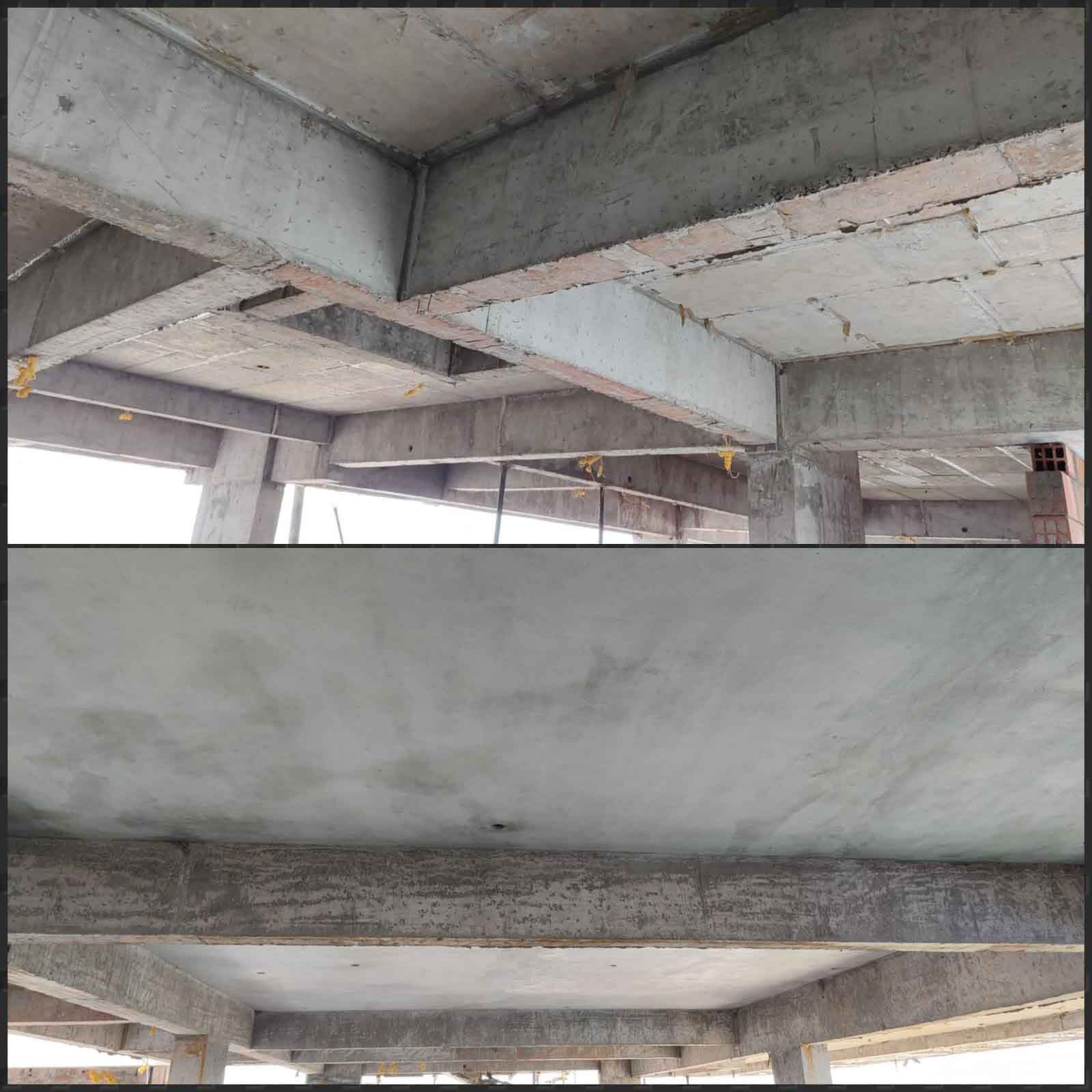

- RCC for Terrace Floor Slab: 100% Completed
- Column Work Above Terrace Floor: 100% Completed

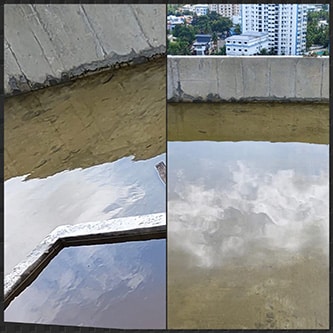

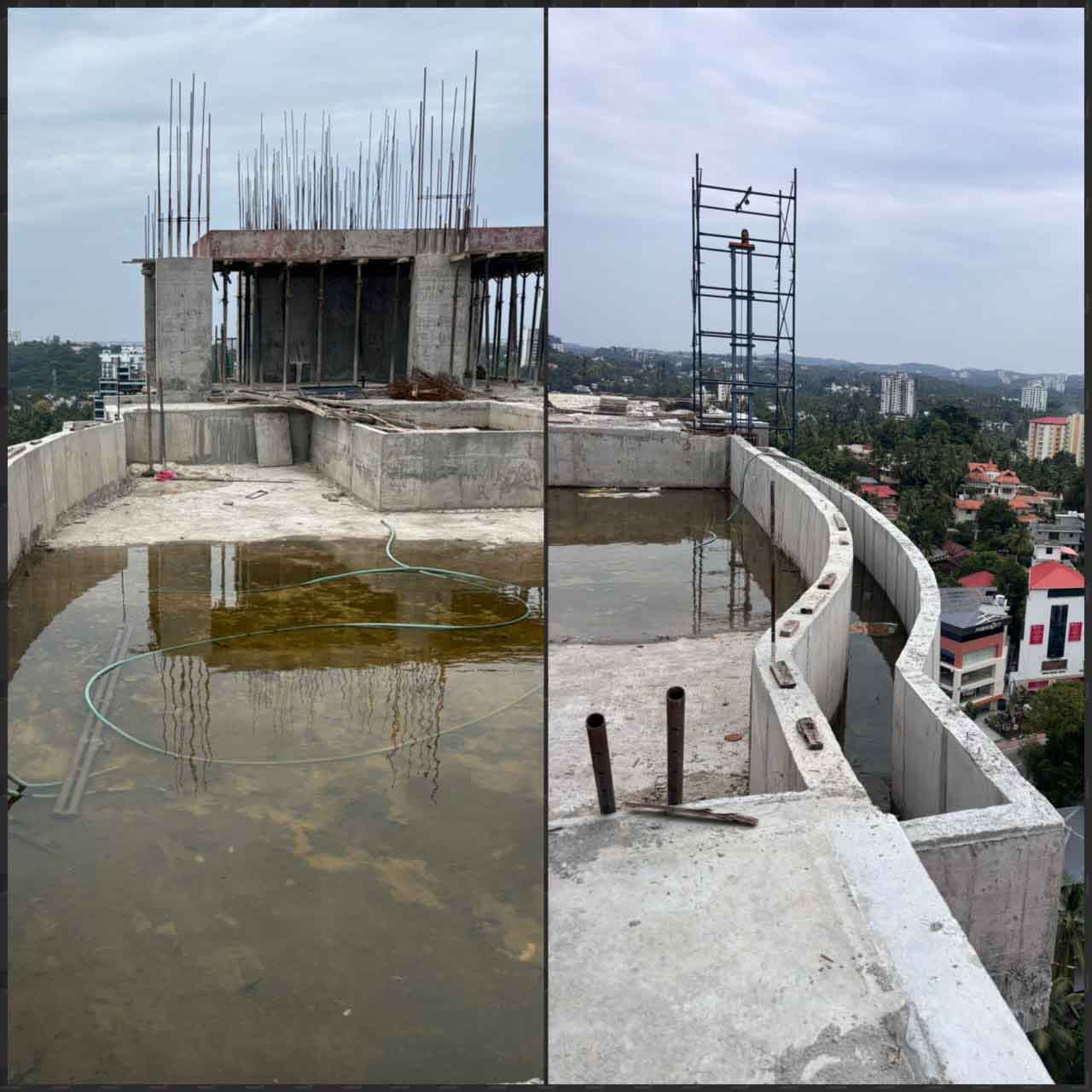

- RCC for Swimming Pool: 100% Completed
- RCC for OHT: 100% Completed

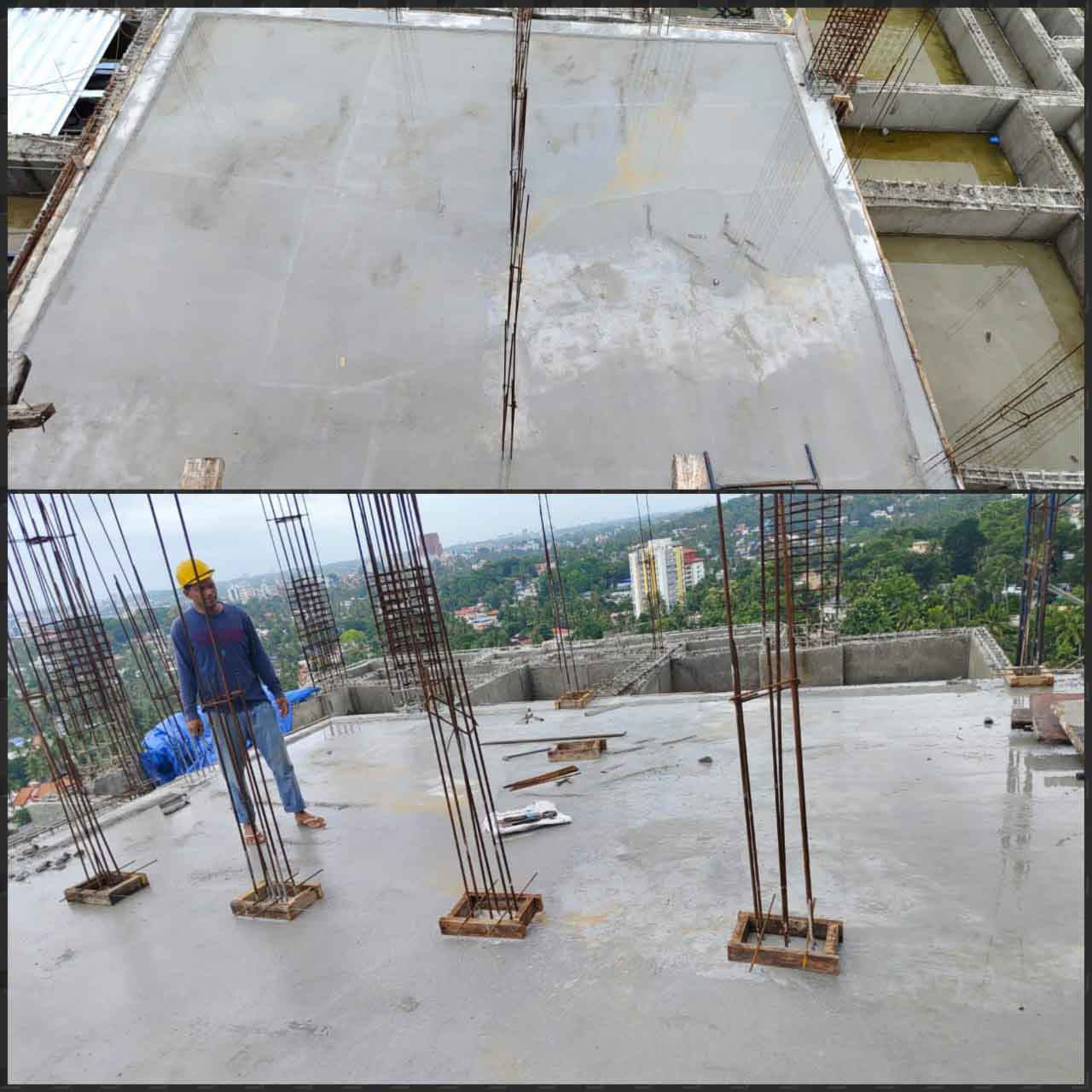

- RCC for Badminton Court & Gym Floor: 100% Completed
- RCC for Home Theatre Floor Slab: 100% Completed
- UG Sump Work: 100% Completed

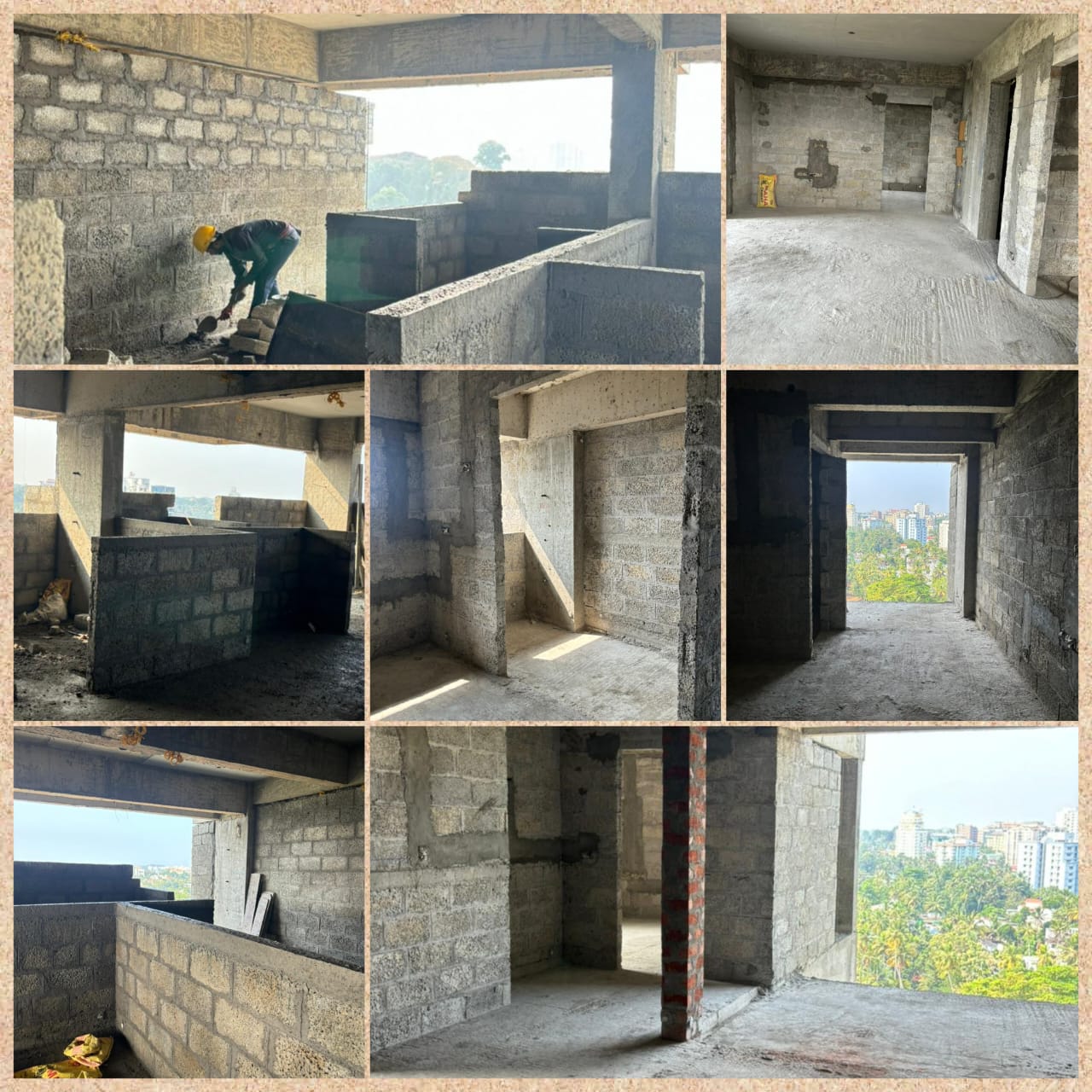

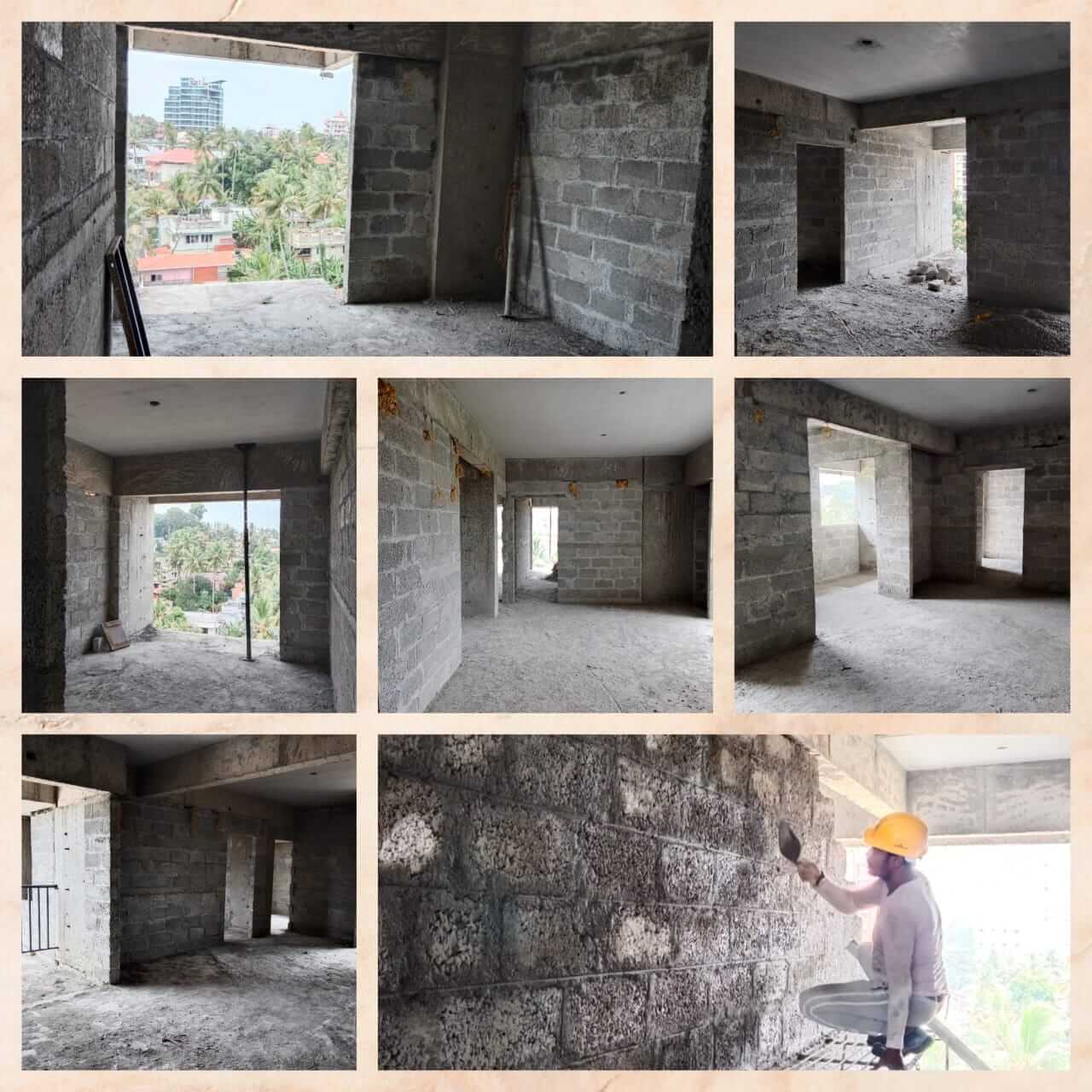

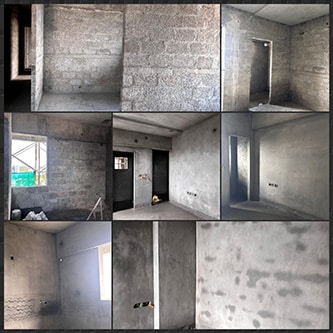

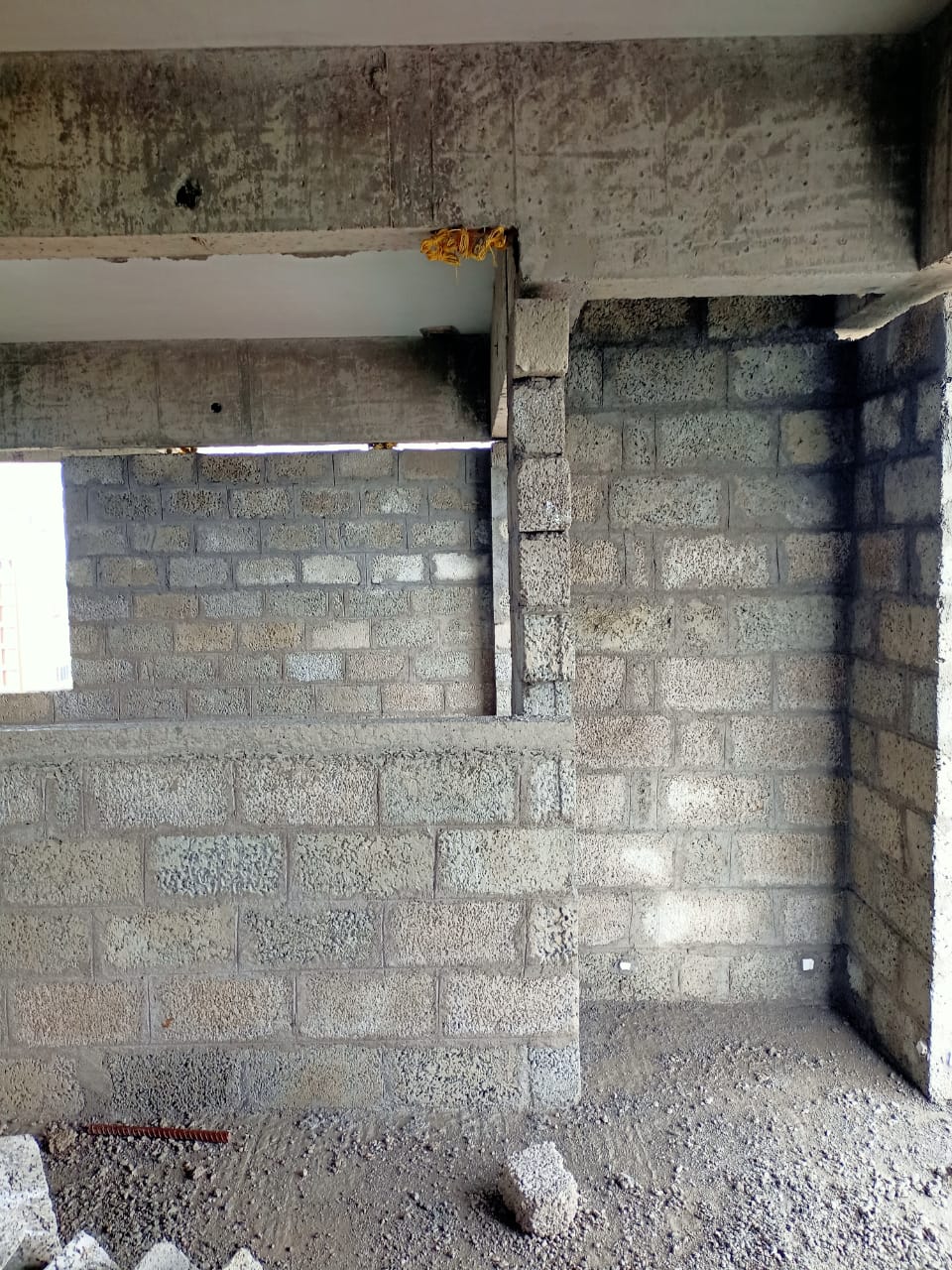

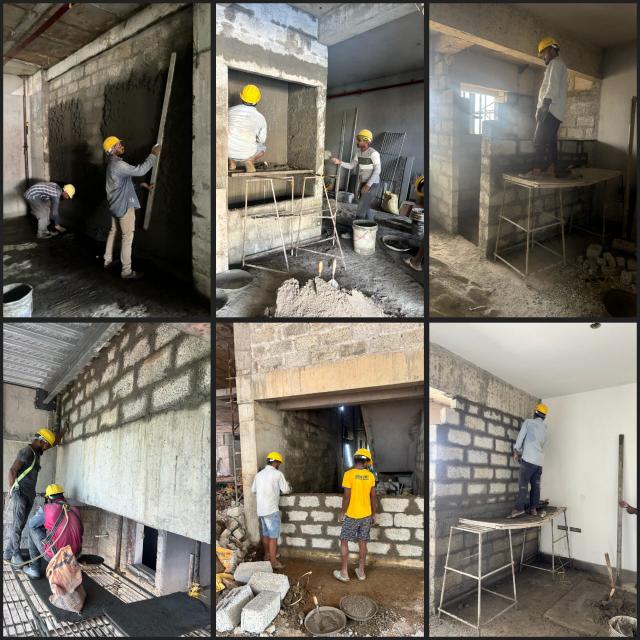

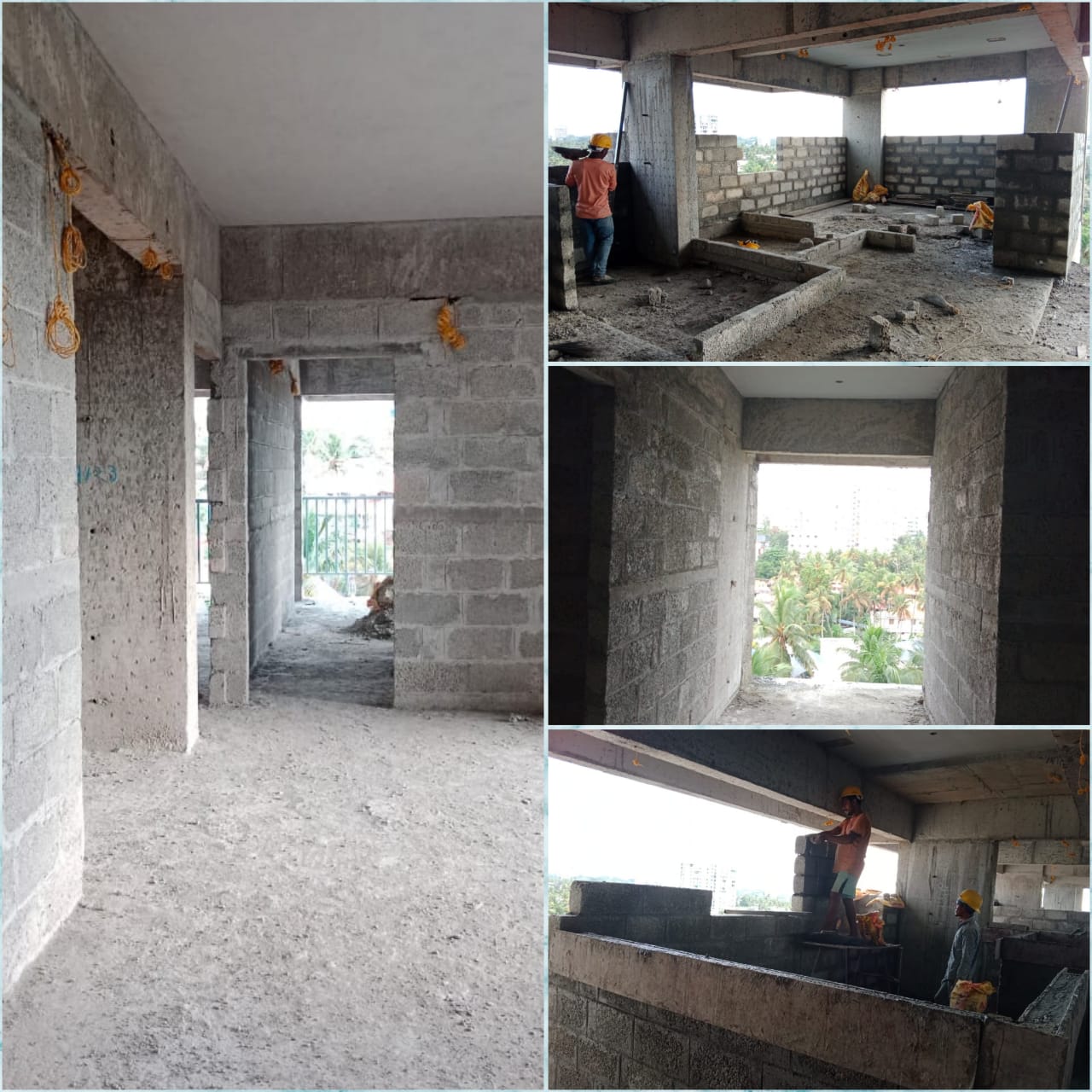

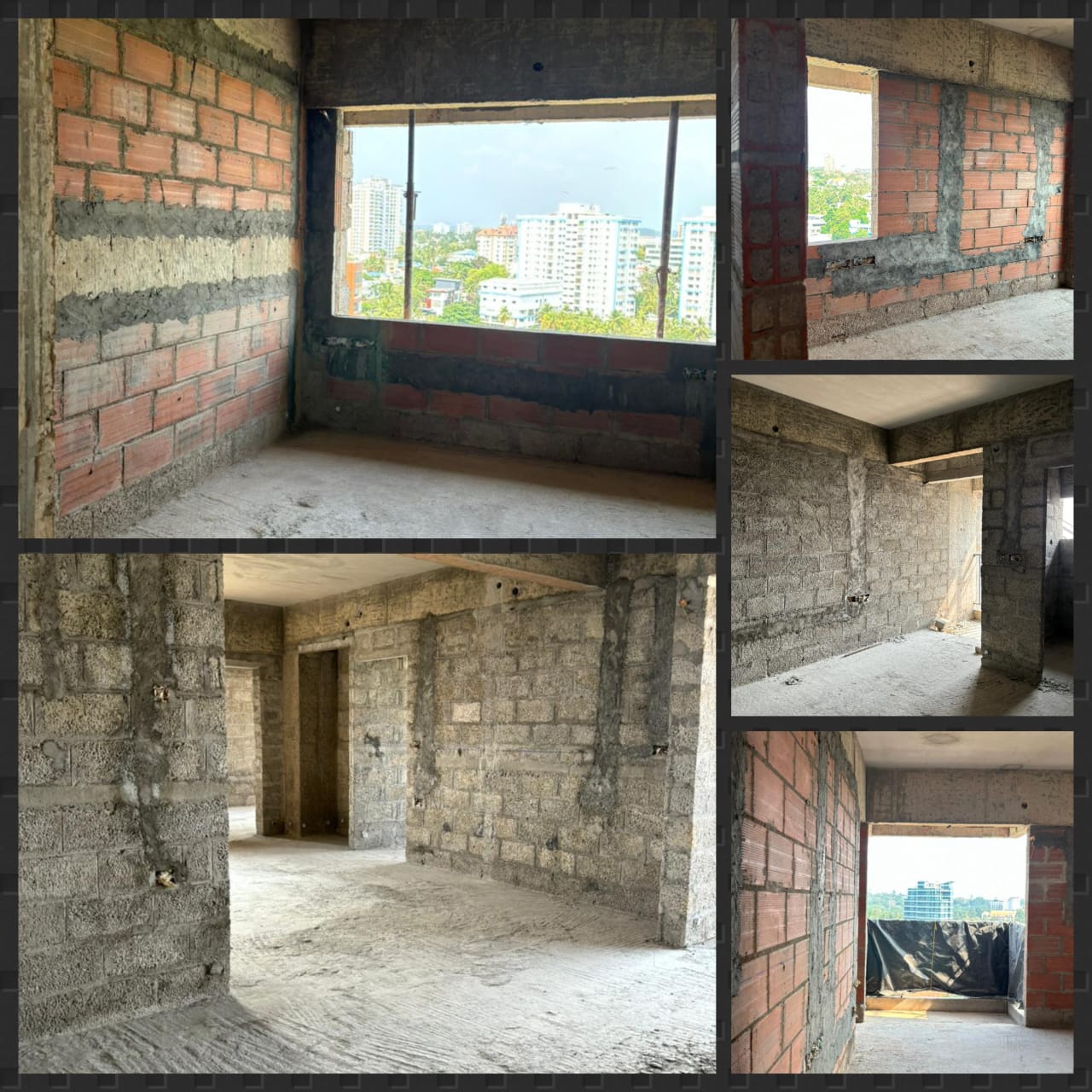

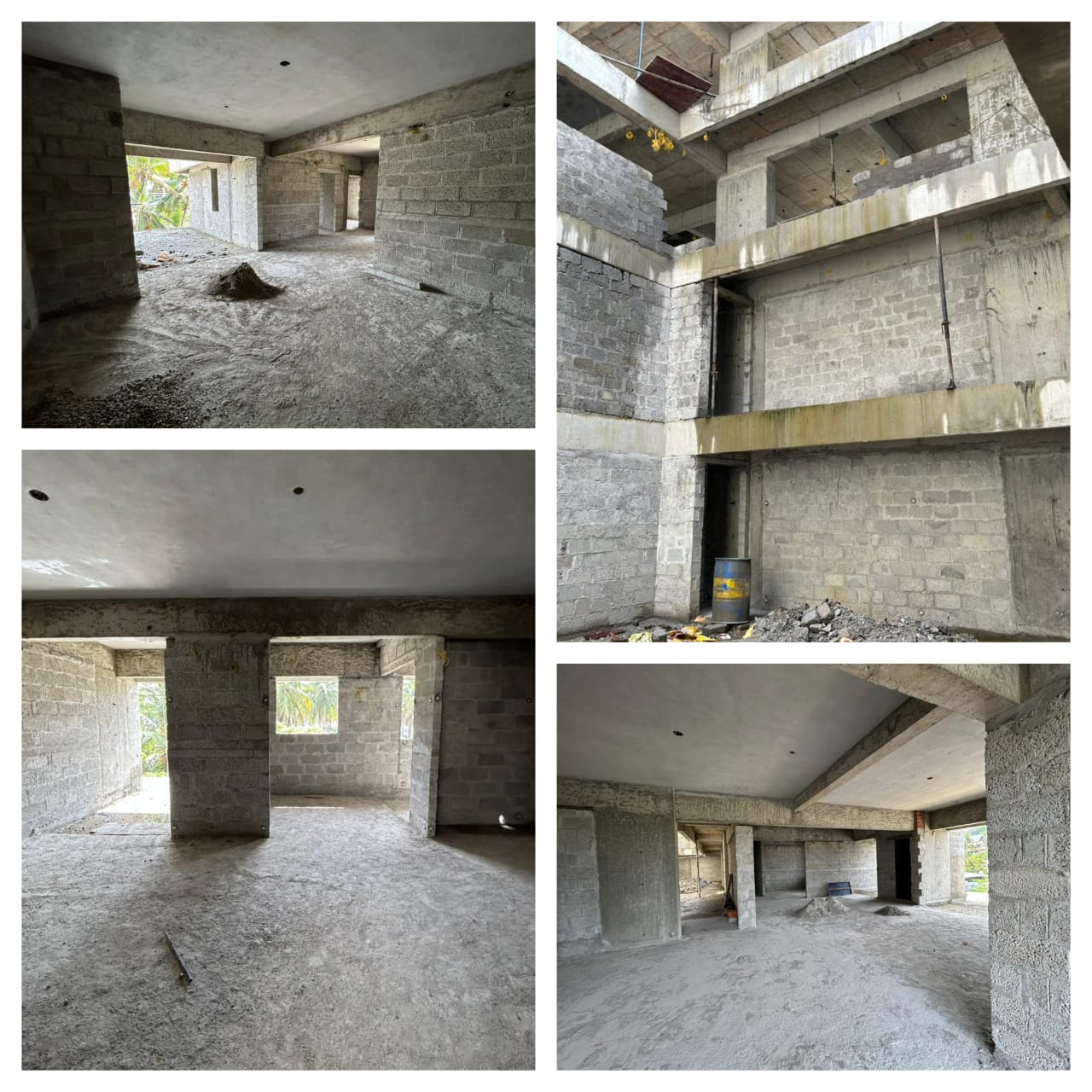

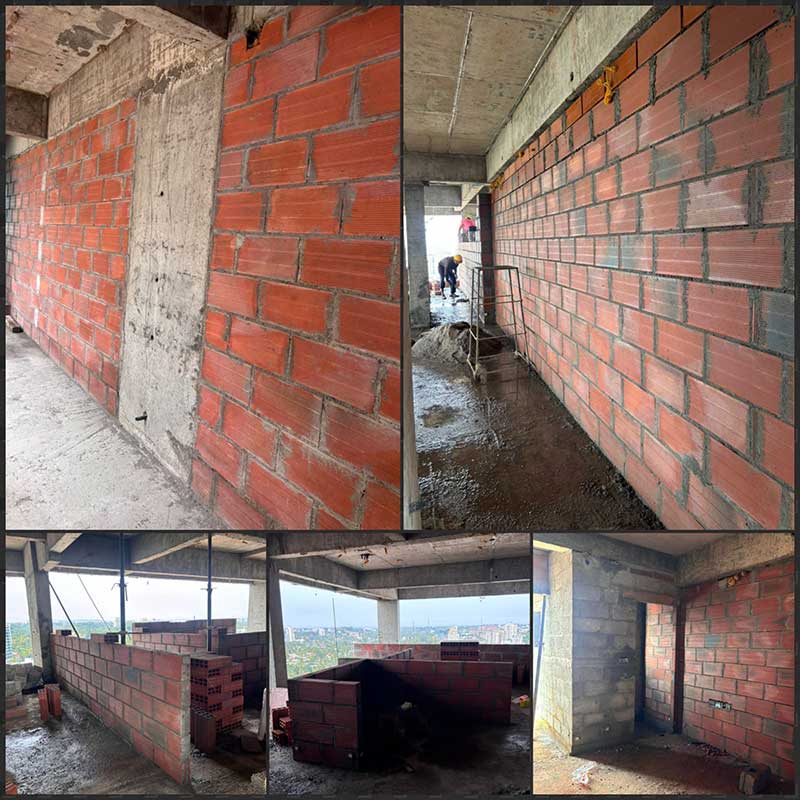

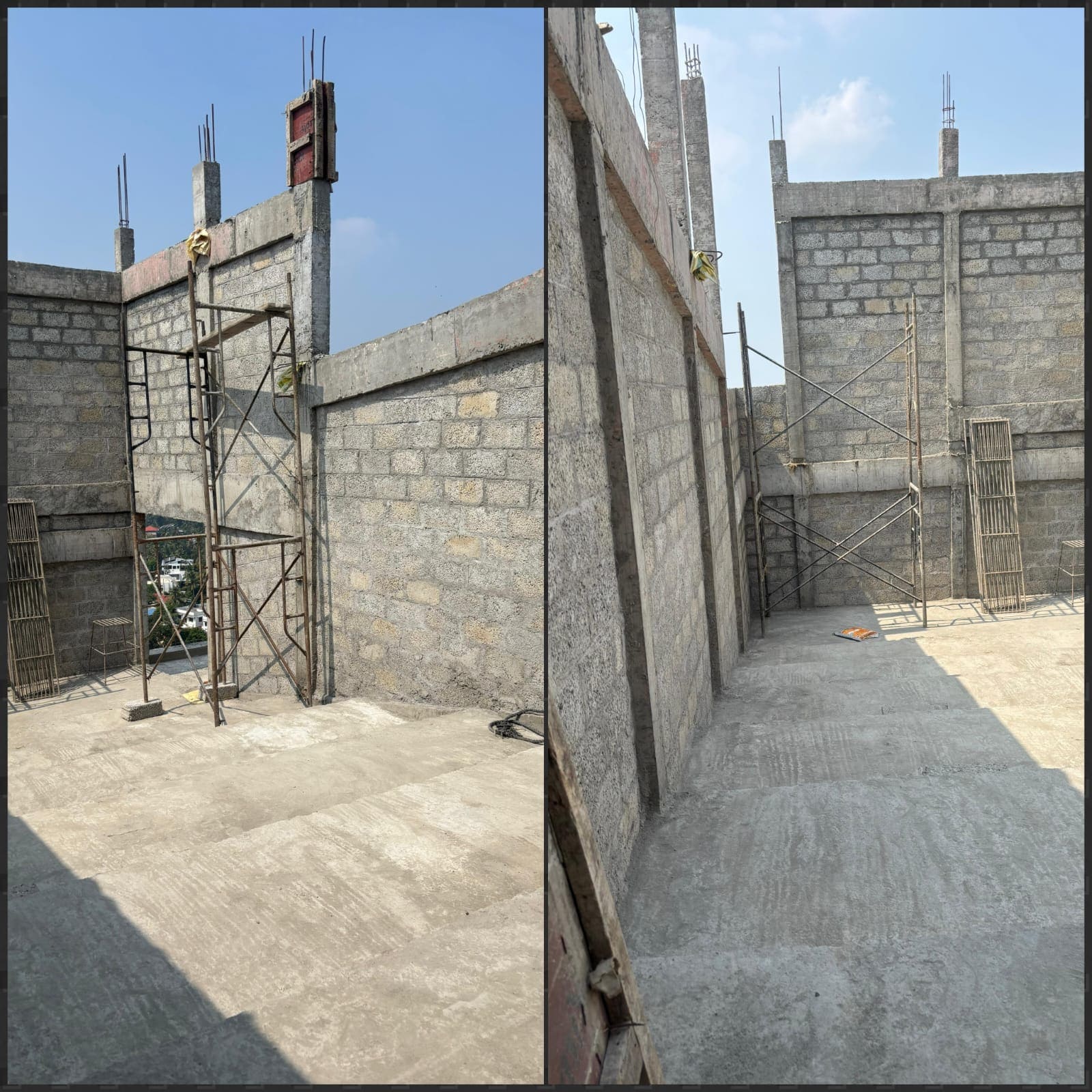

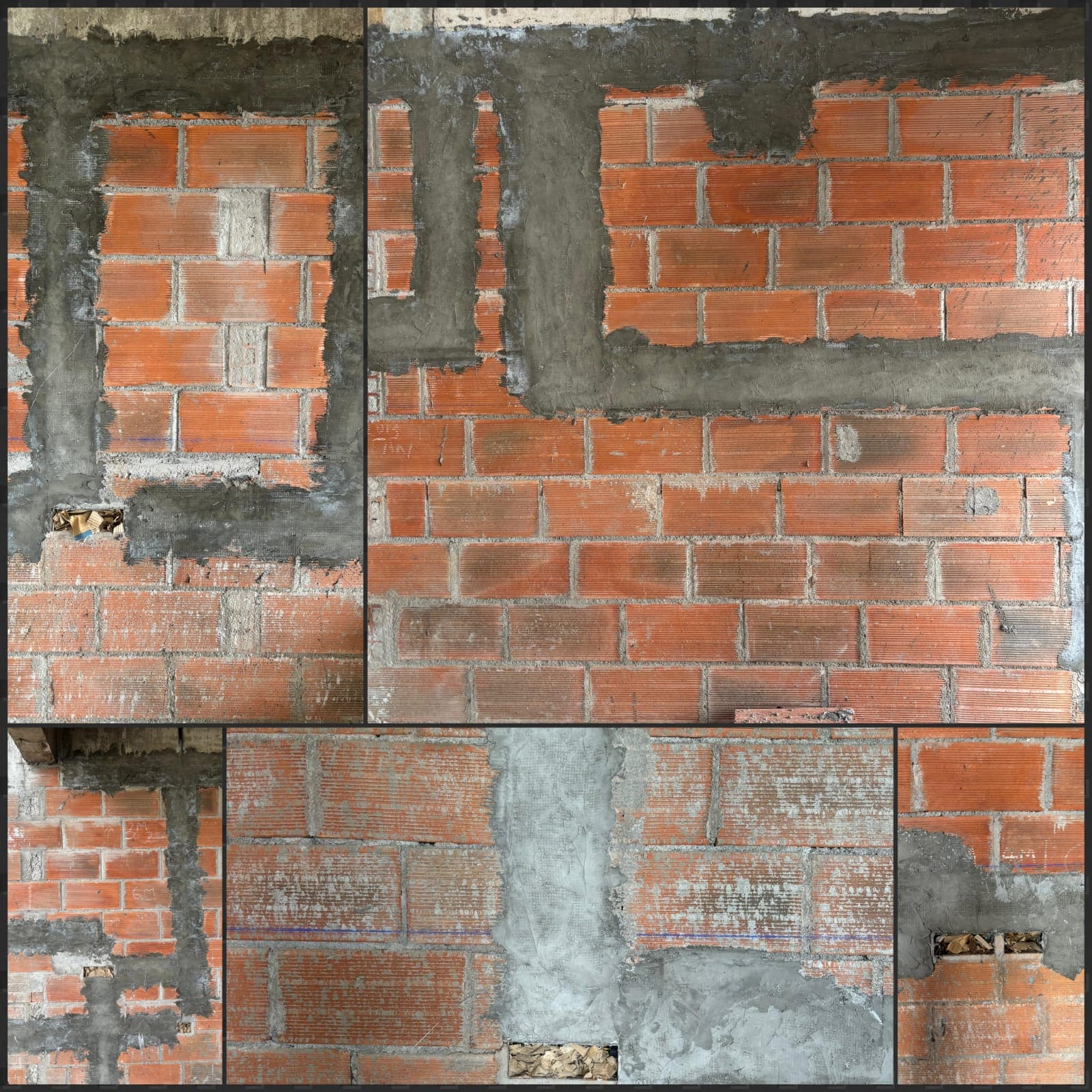

- Block Work: 92/92 Apartments Completed

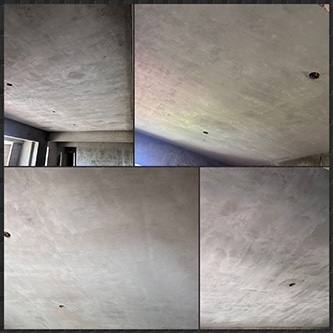

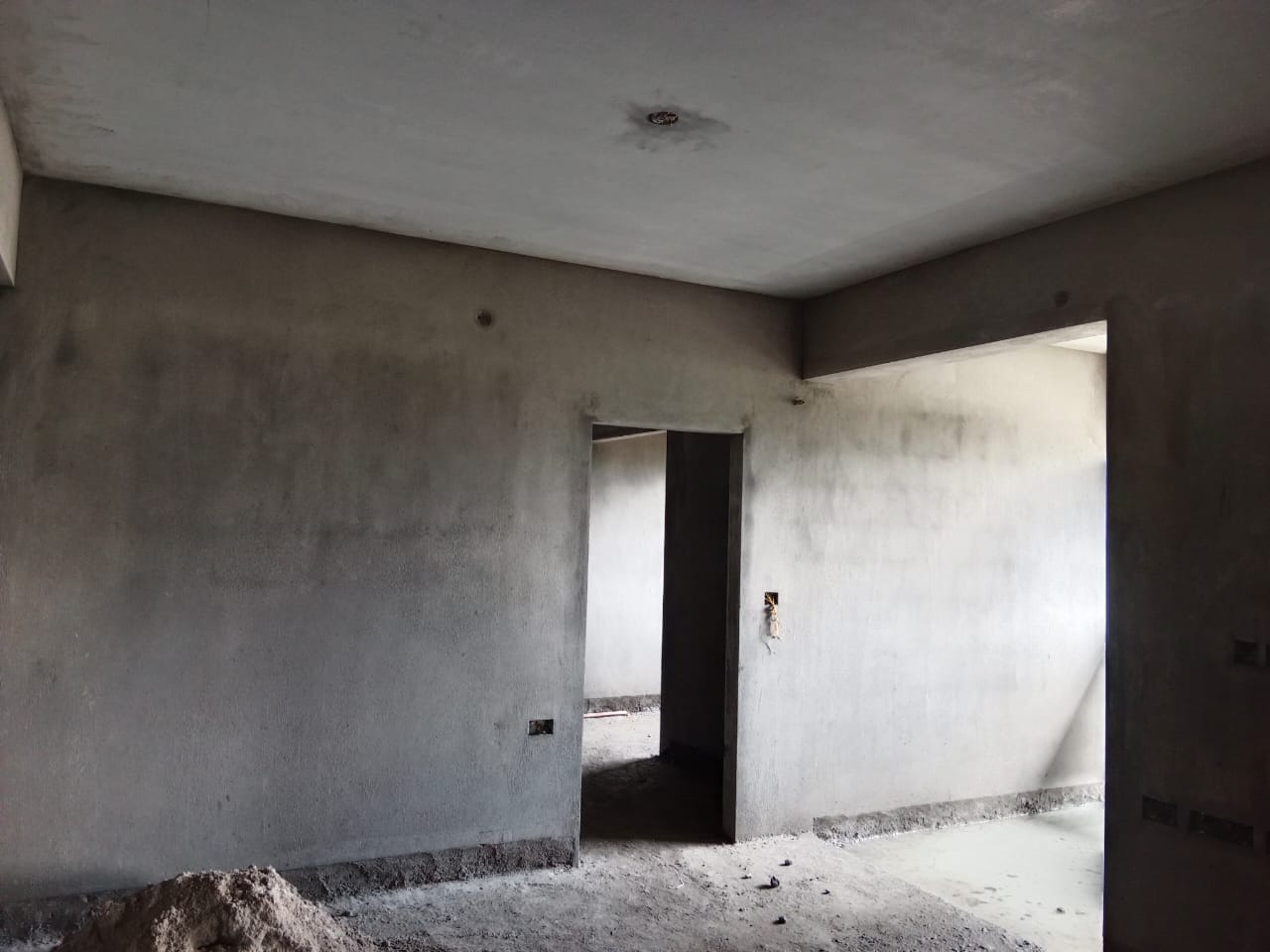

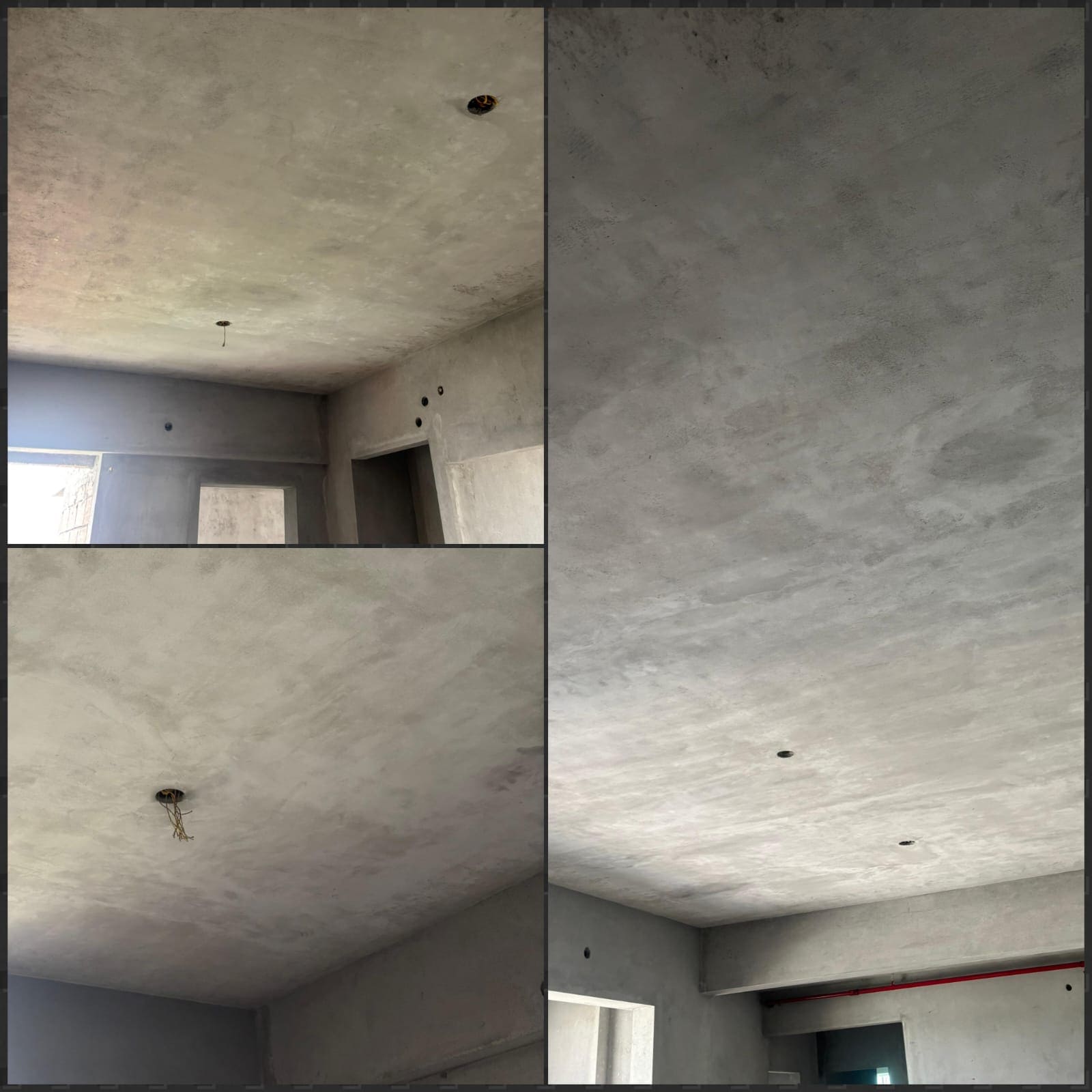

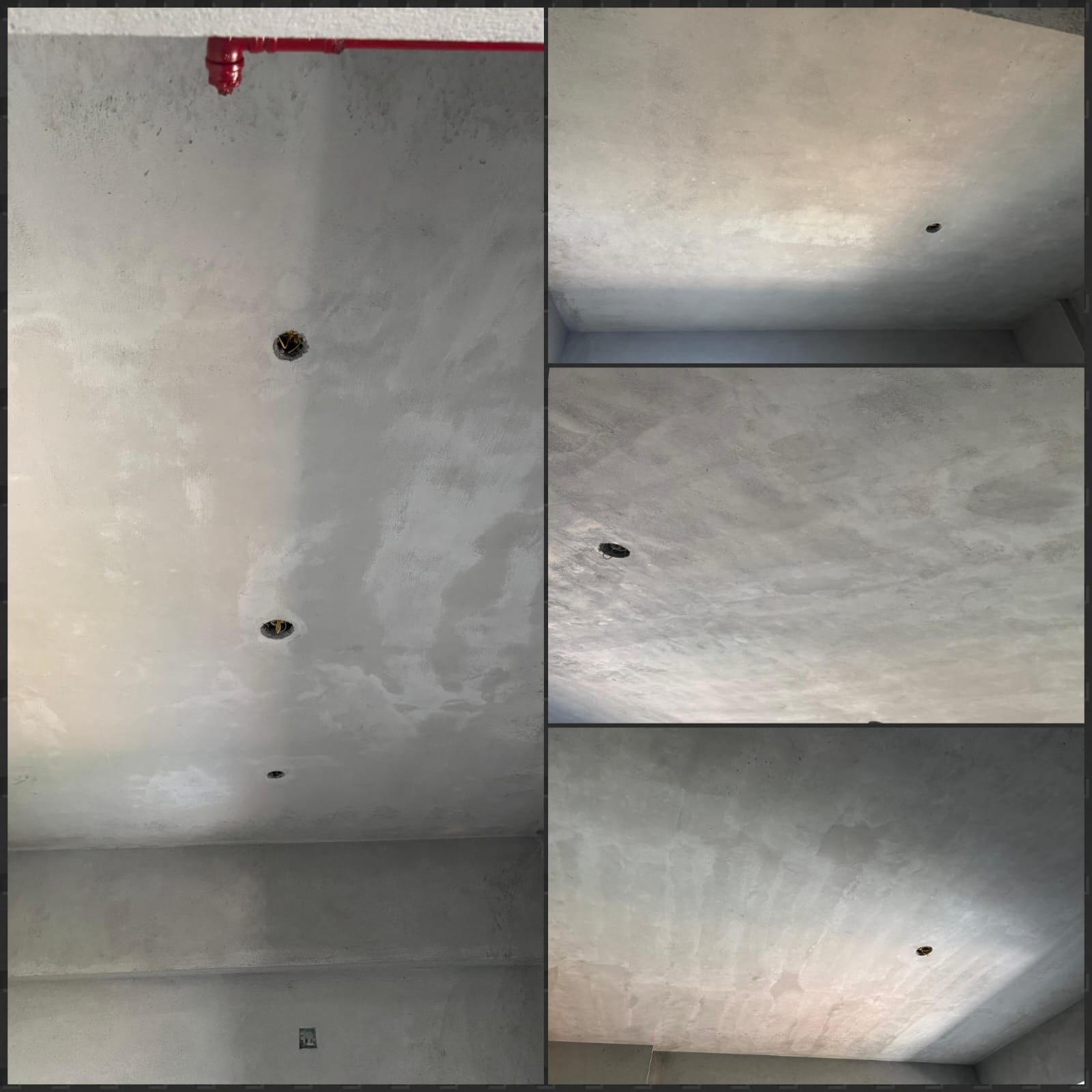

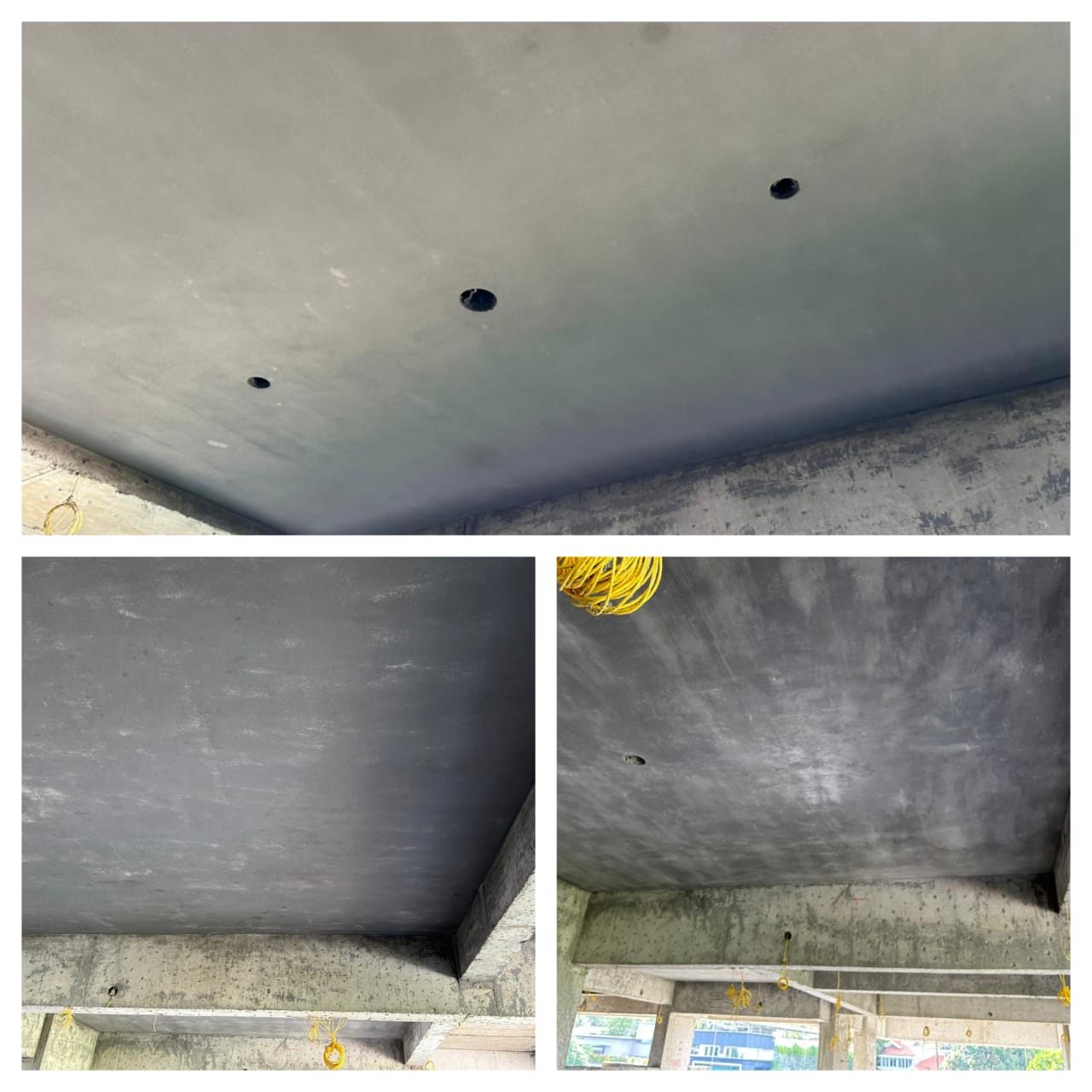

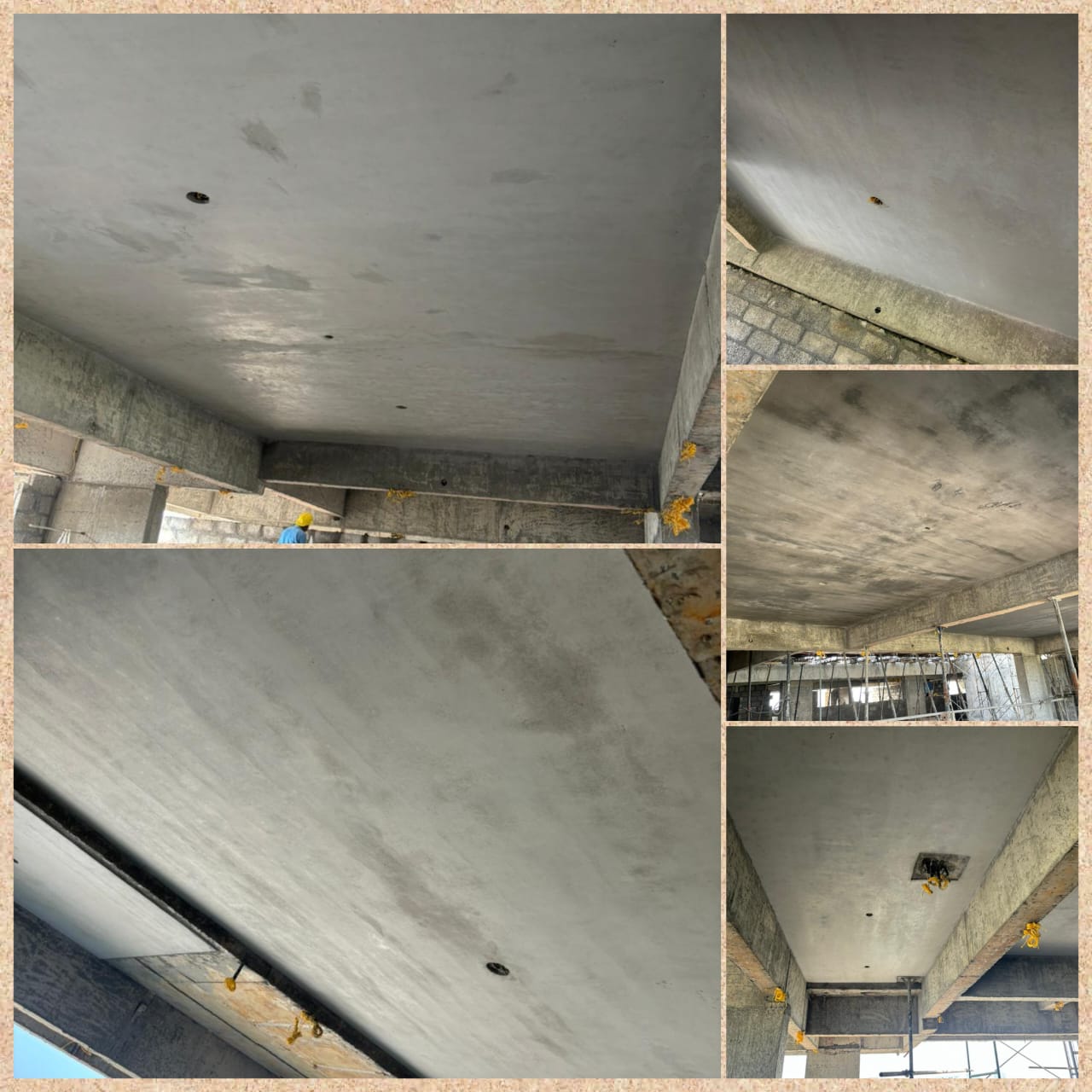

- Ceiling Plastering: 92/92 Apartments Completed

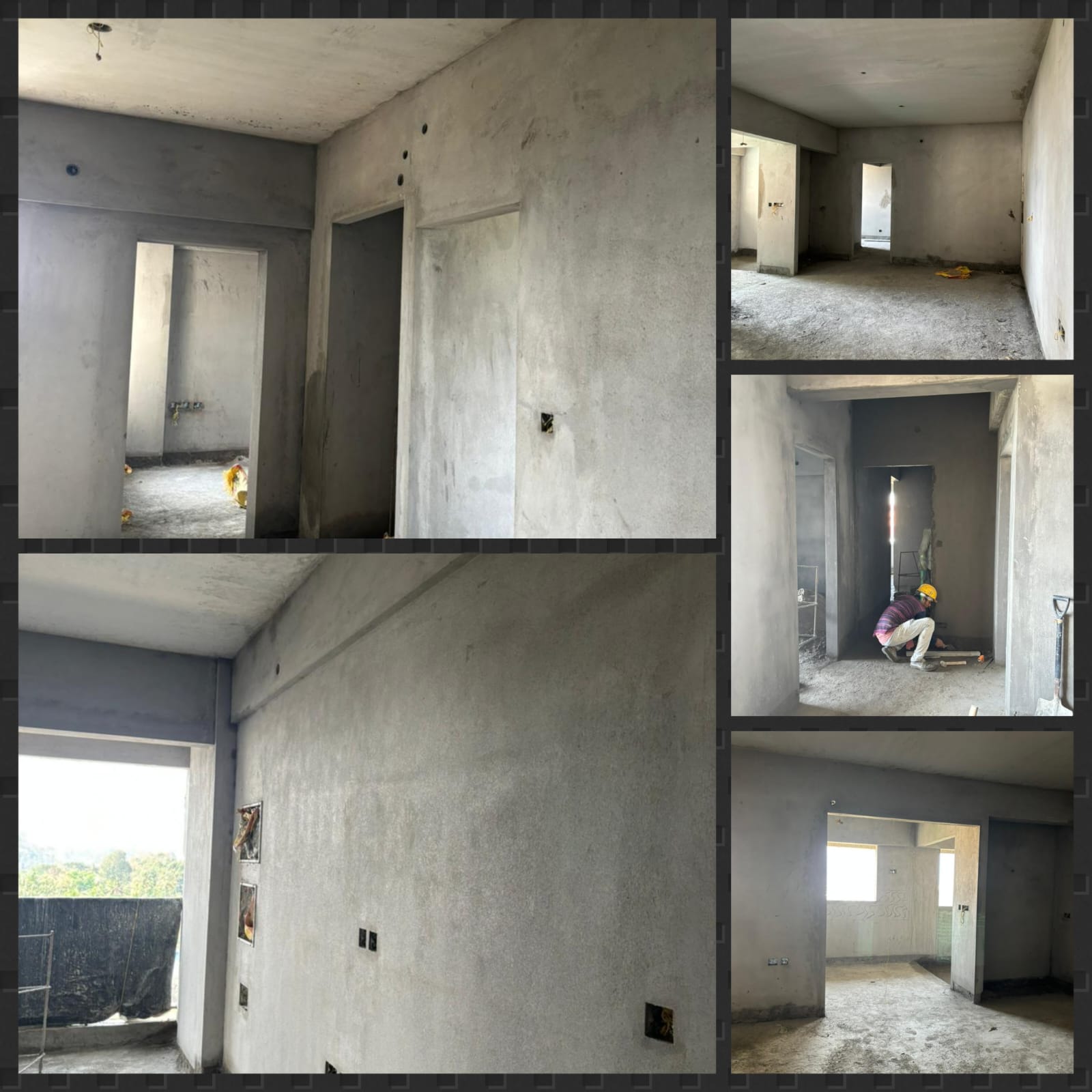

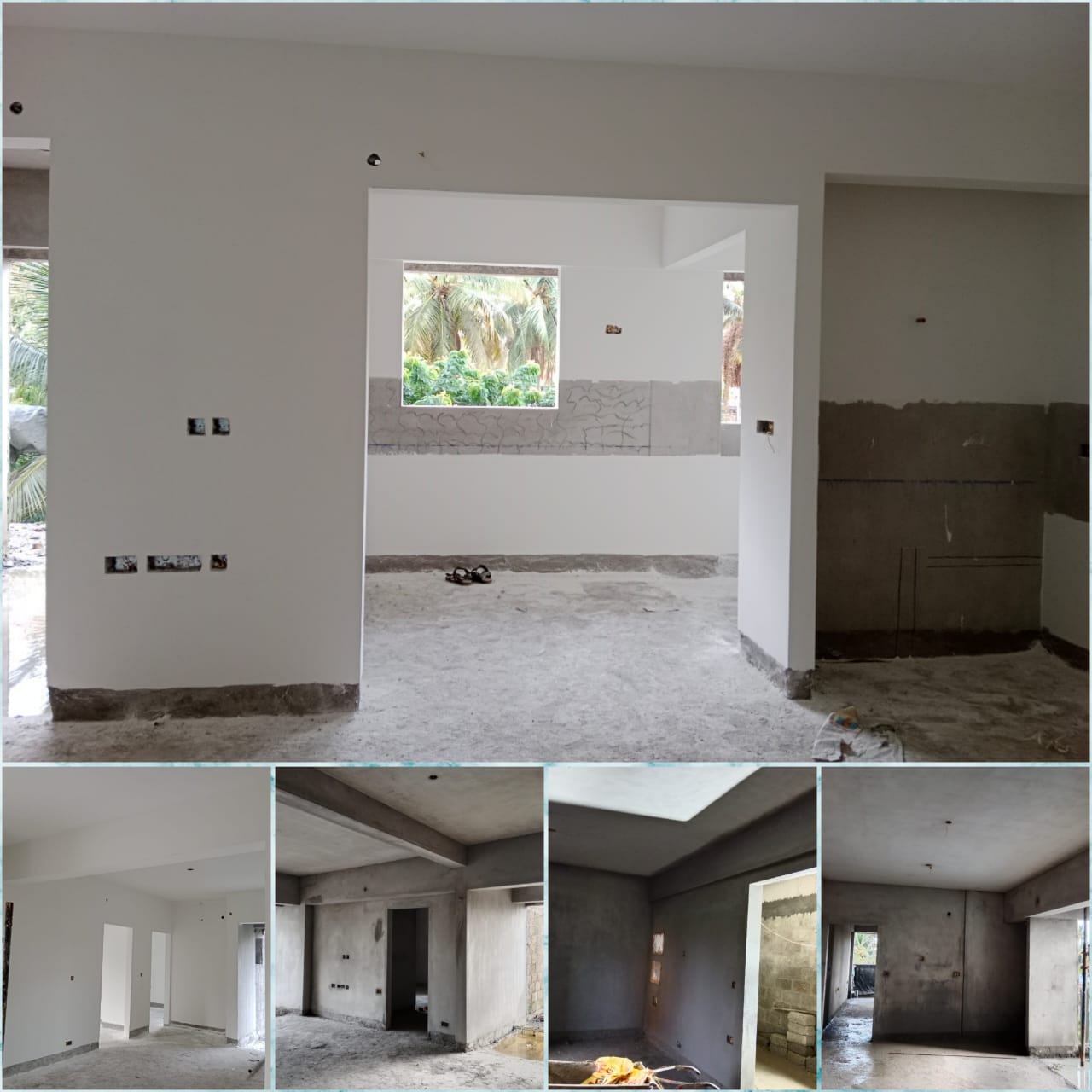

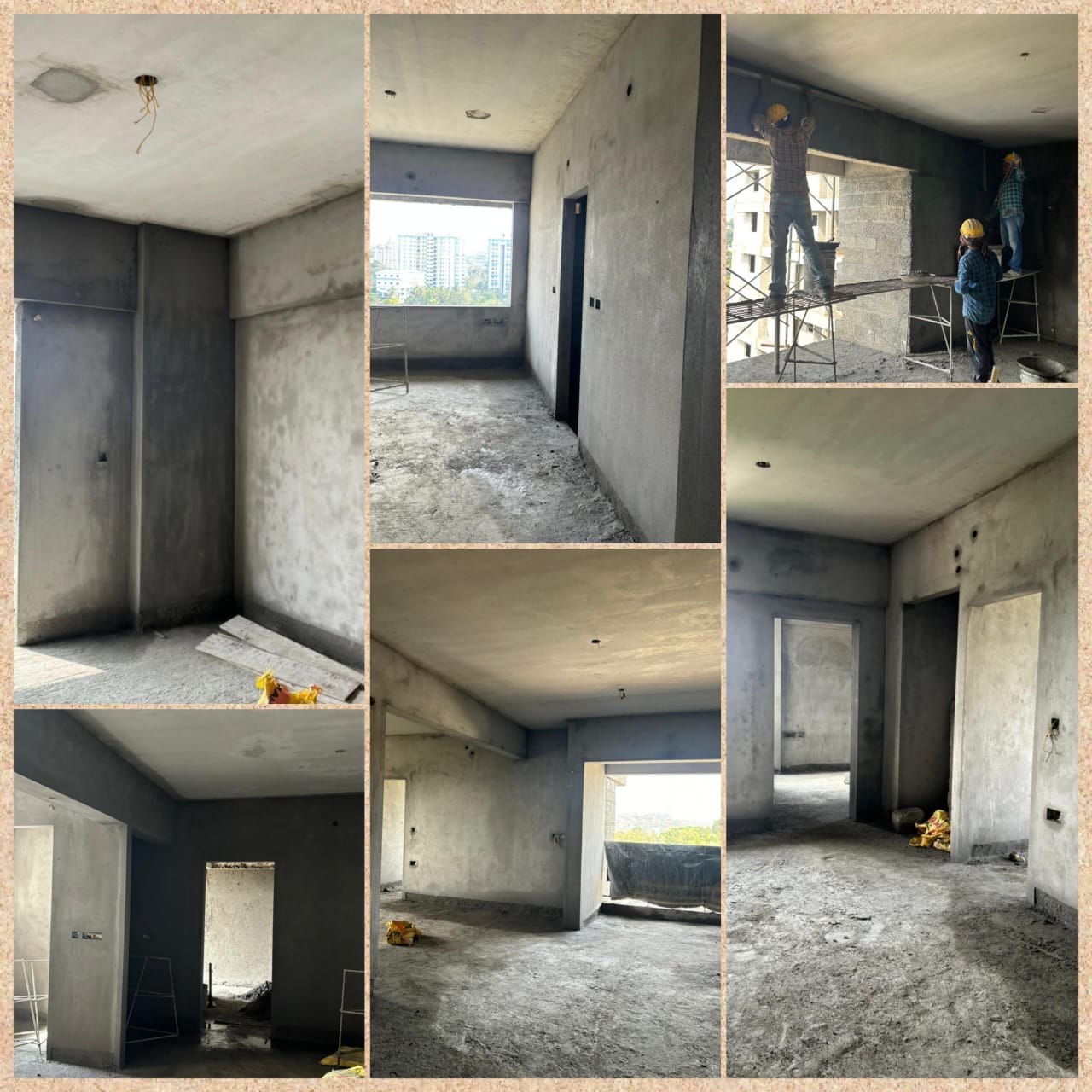

- Inside Wall Plastering: 90/92 Apartments Completed

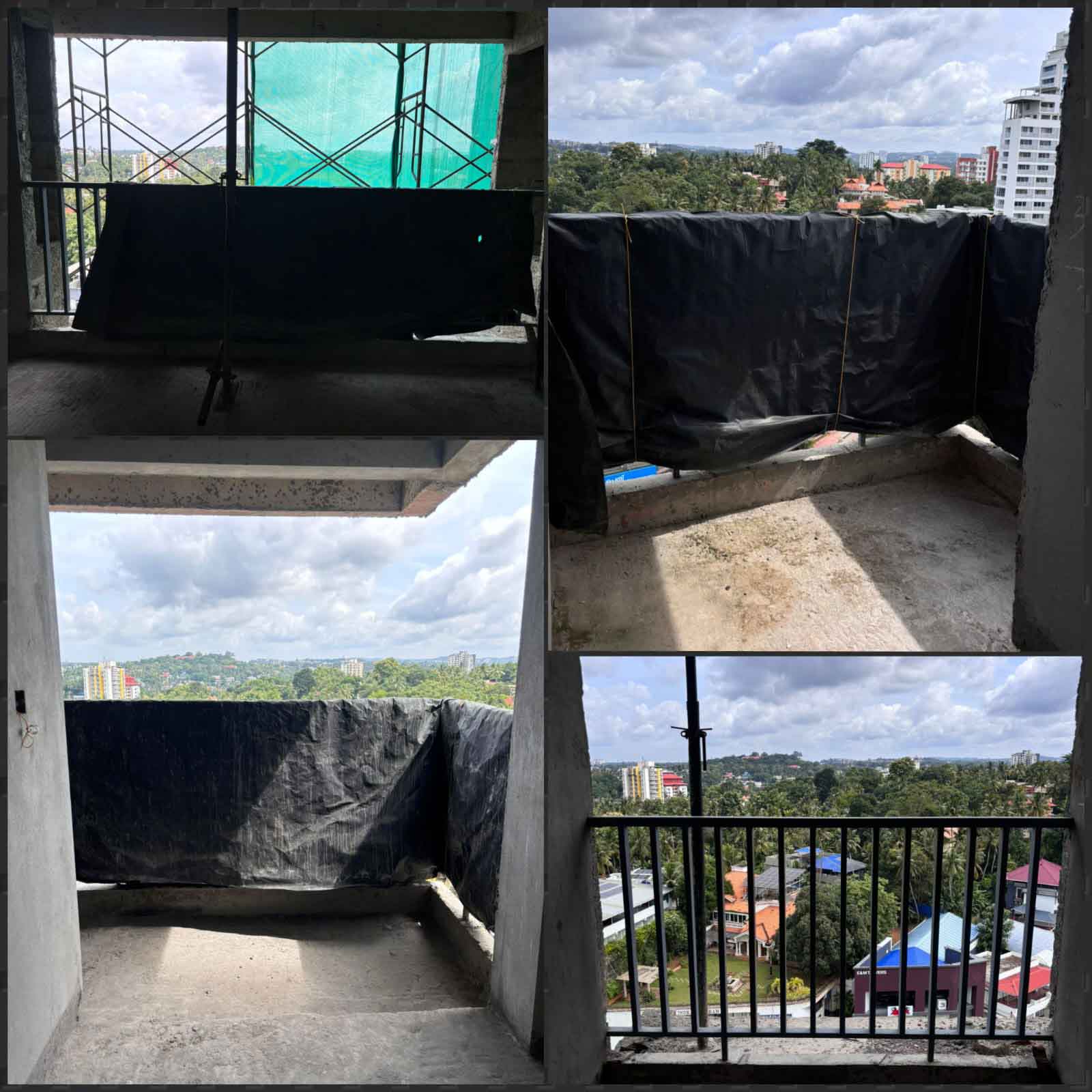

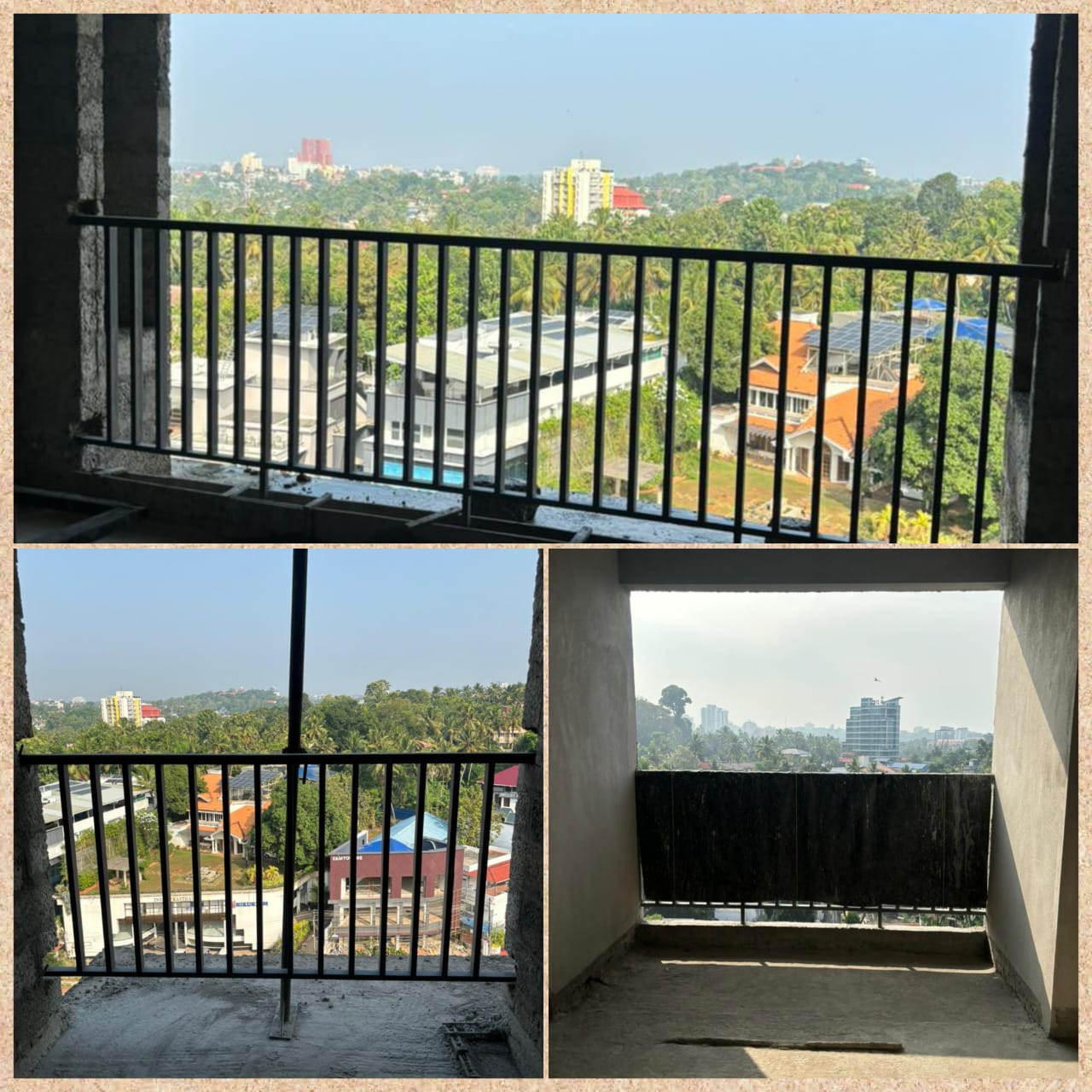

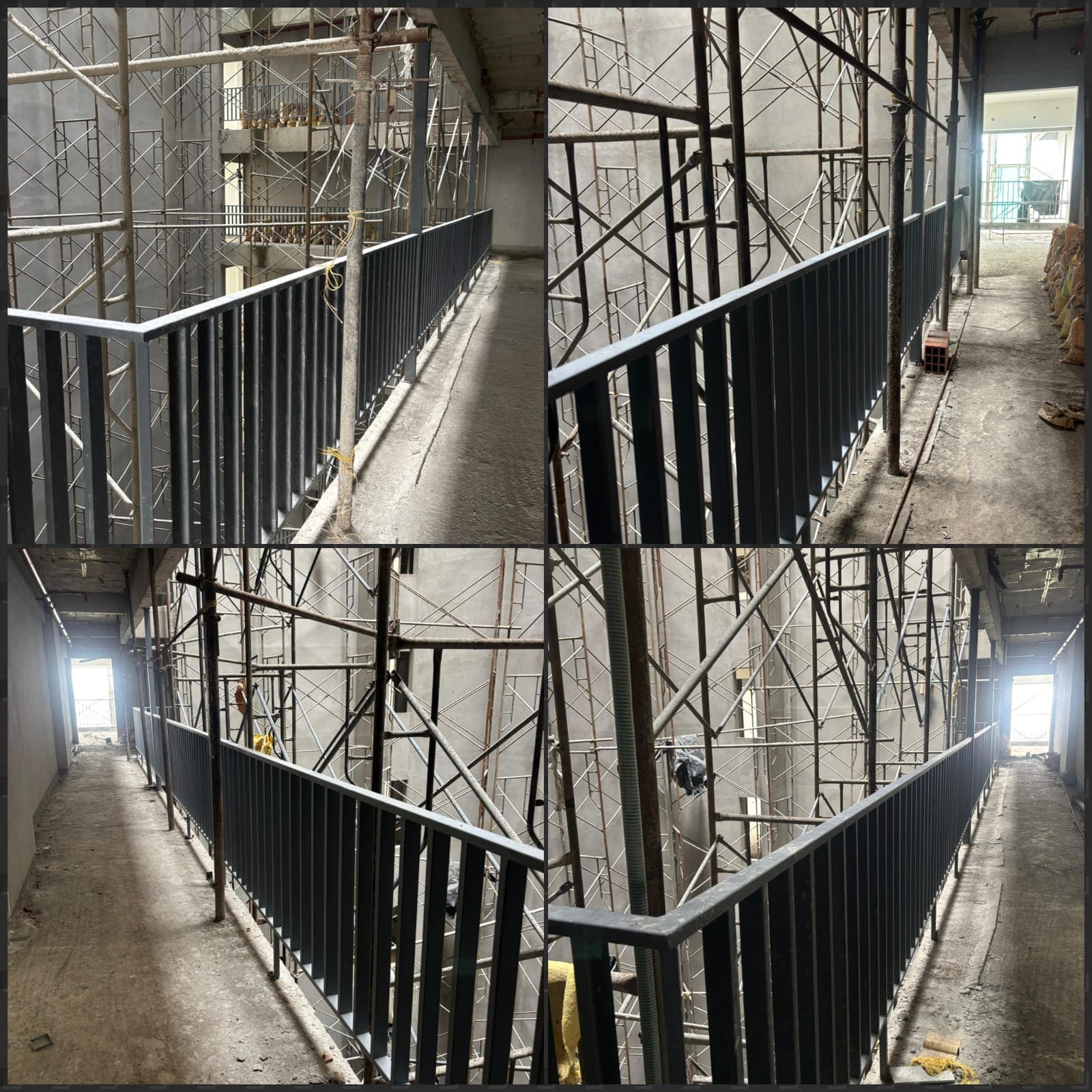

- Balcony Handrail Fixing: 91/92 Apartments Completed

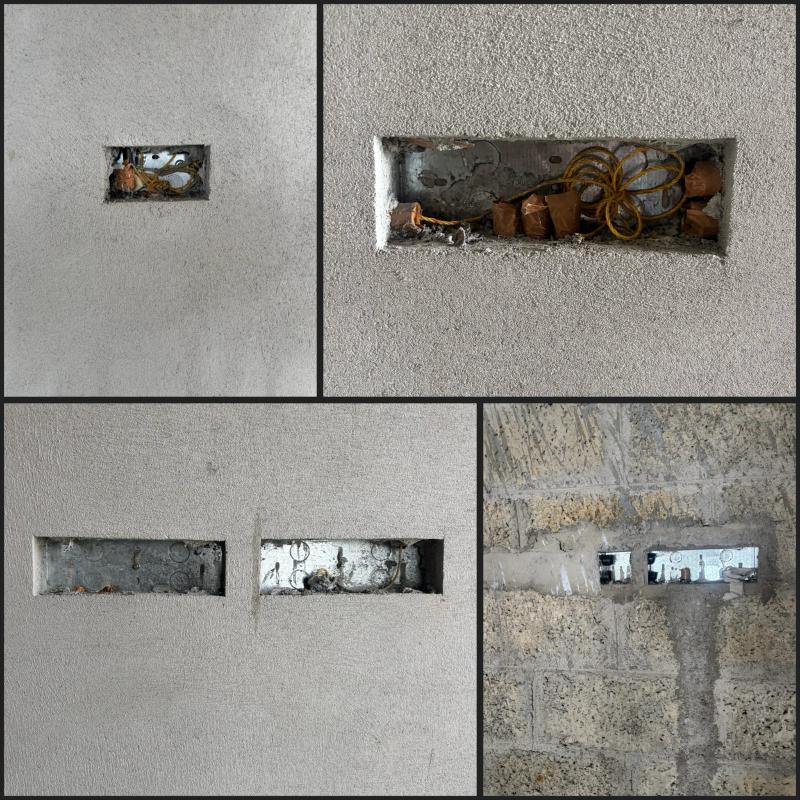

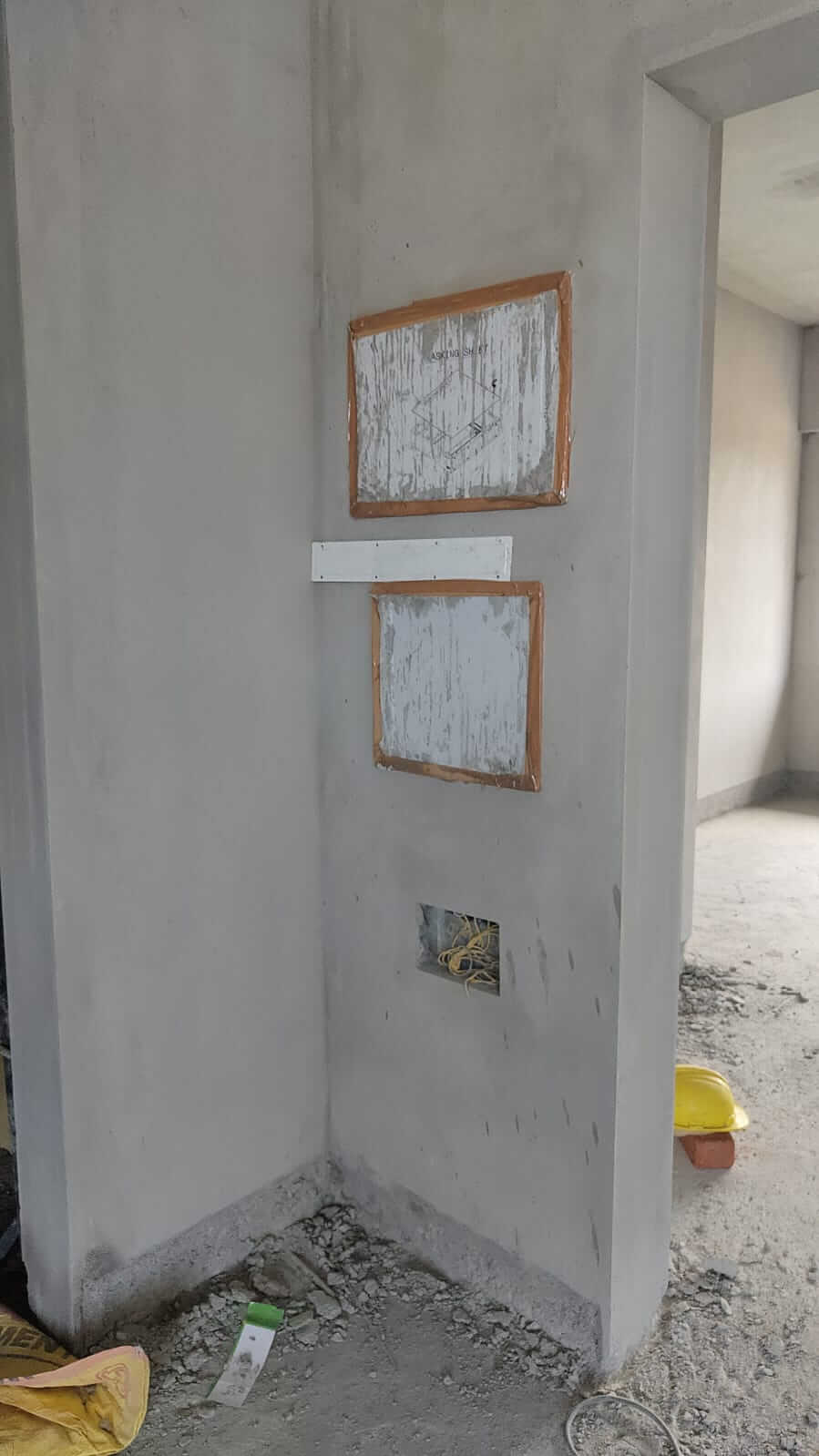

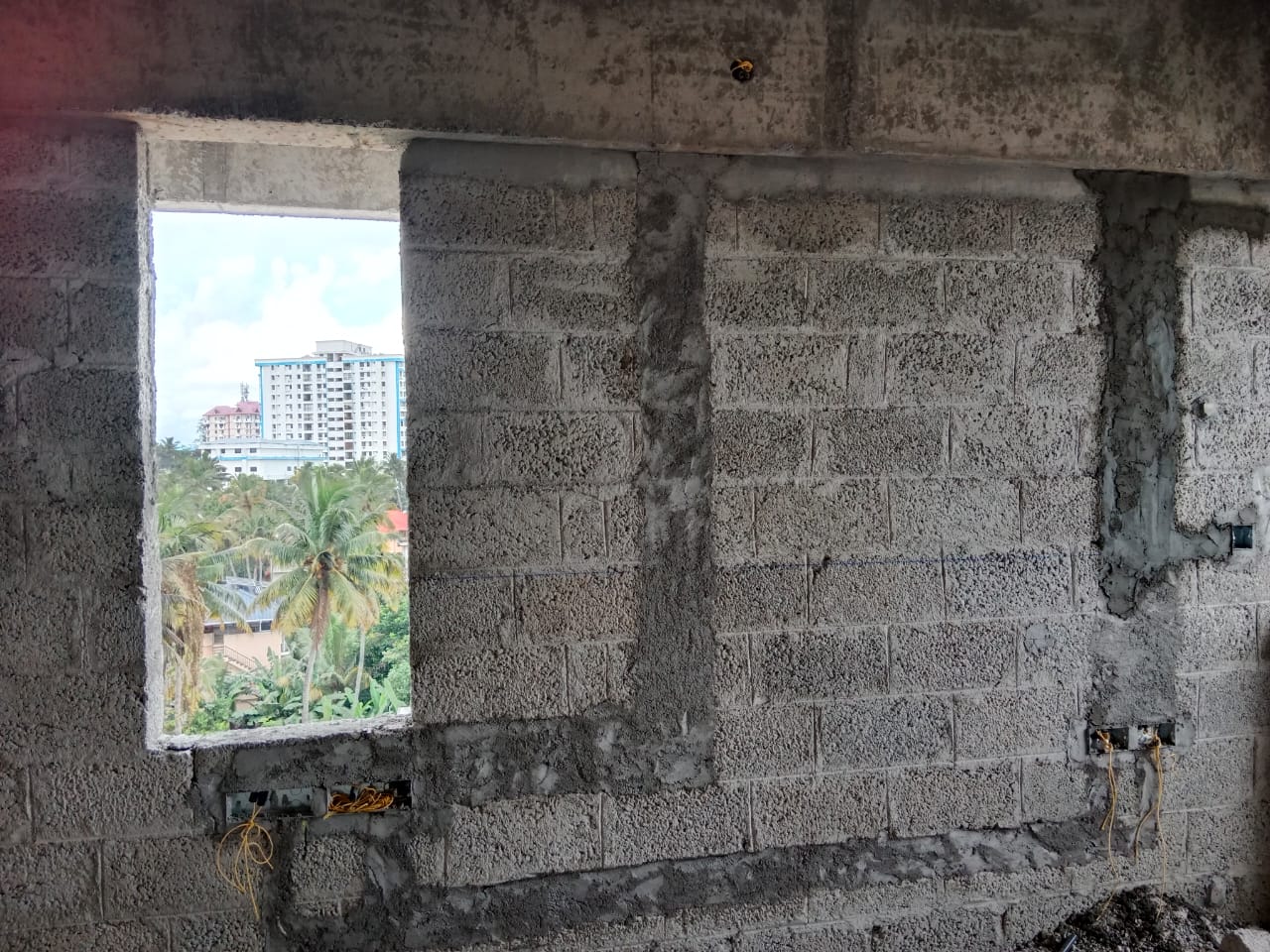

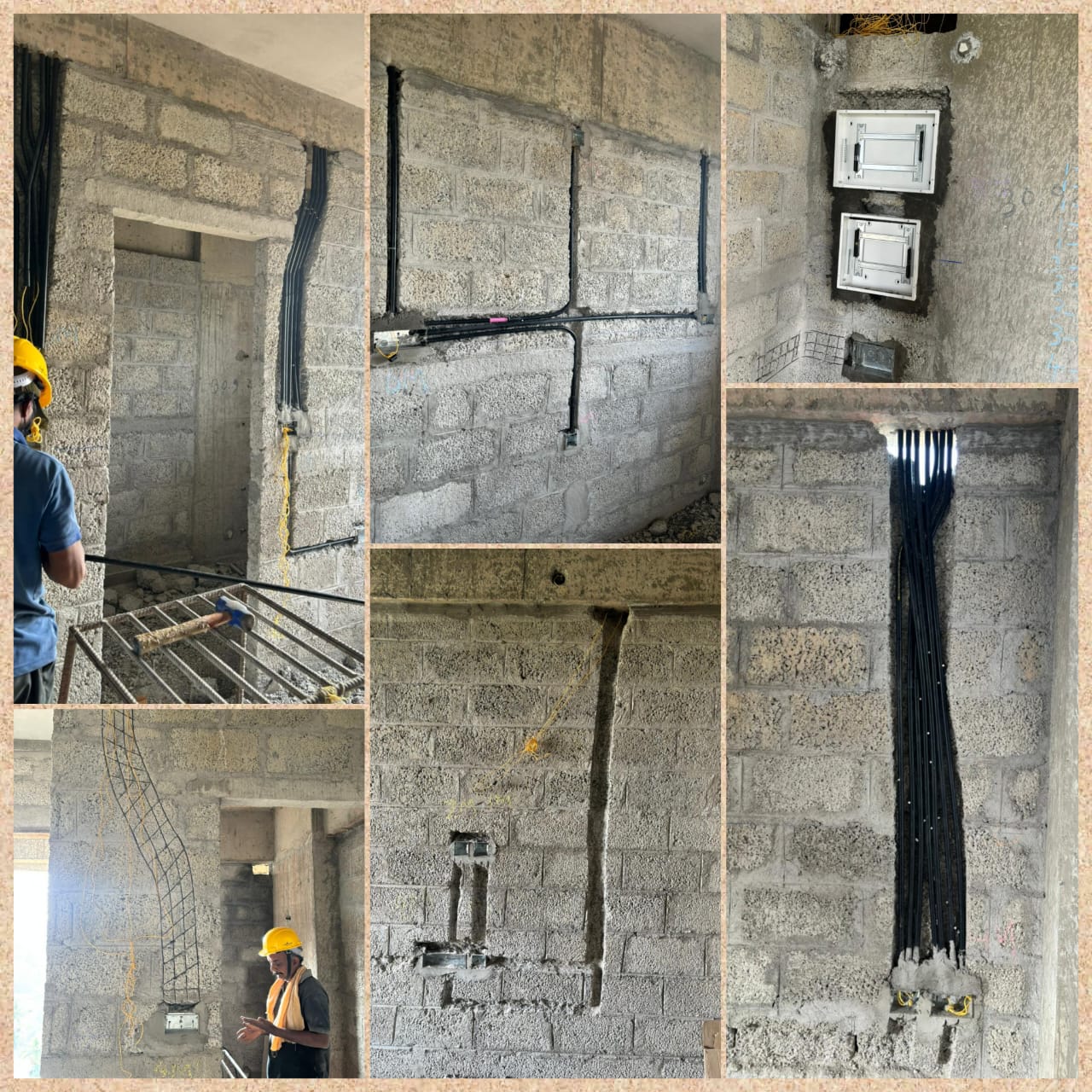

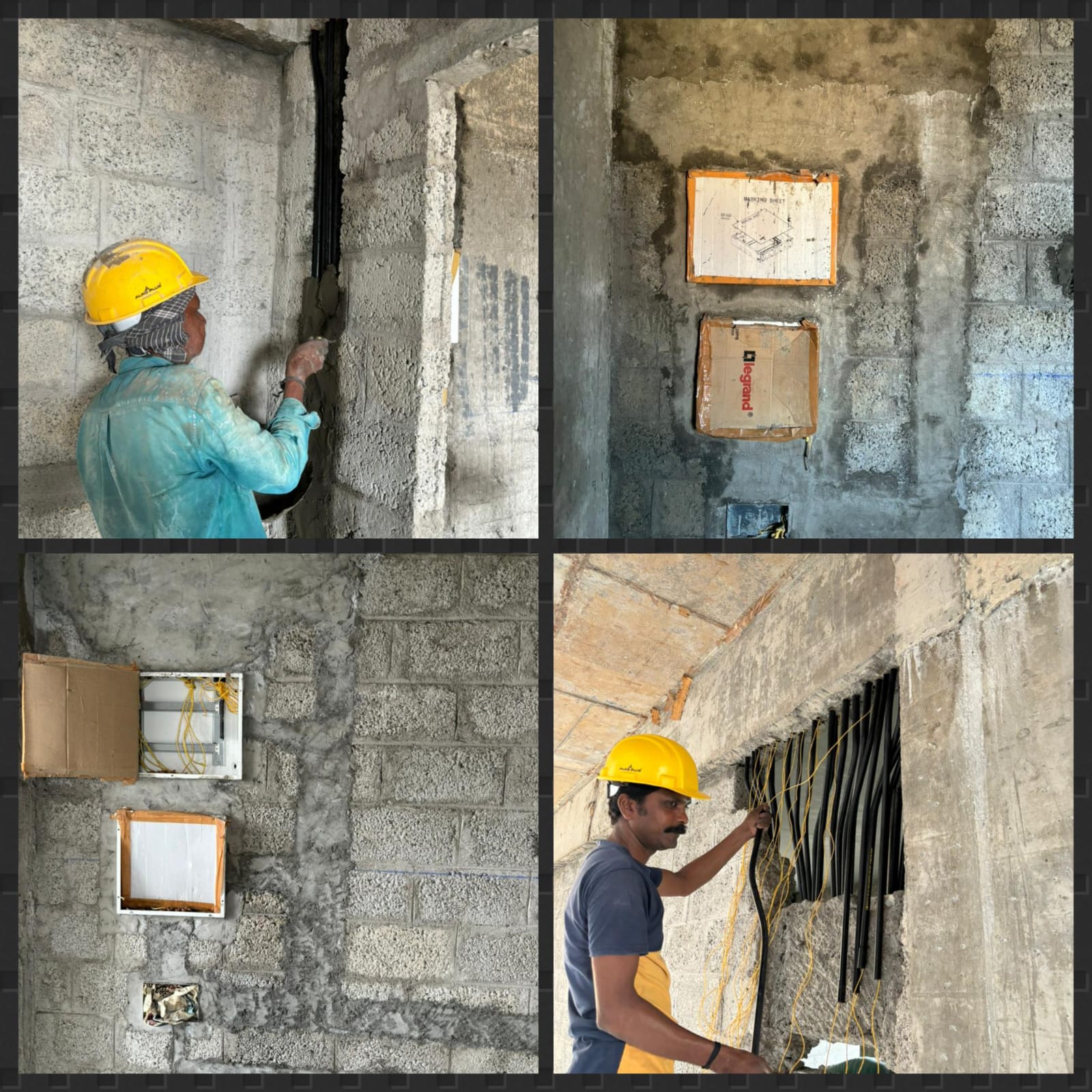

- Electrical Wall Chasing & Box Fixing: 91/92 Apartments Completed

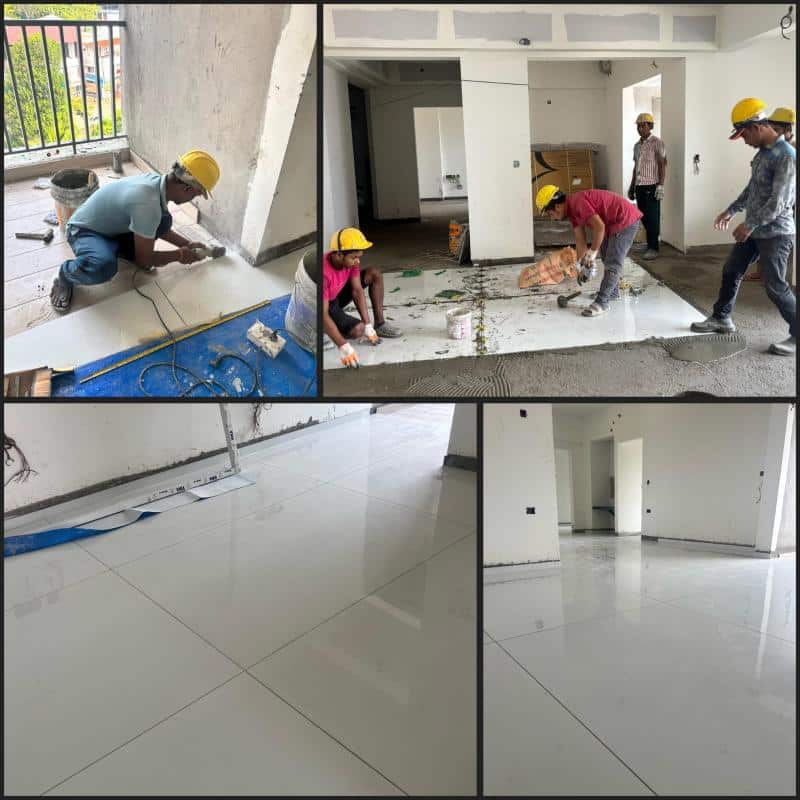

- Wall & Floor Tiling: Completed in Sample Apartments (1F & 2E)
- Wall Tiling: 68/92 Apartments Completed

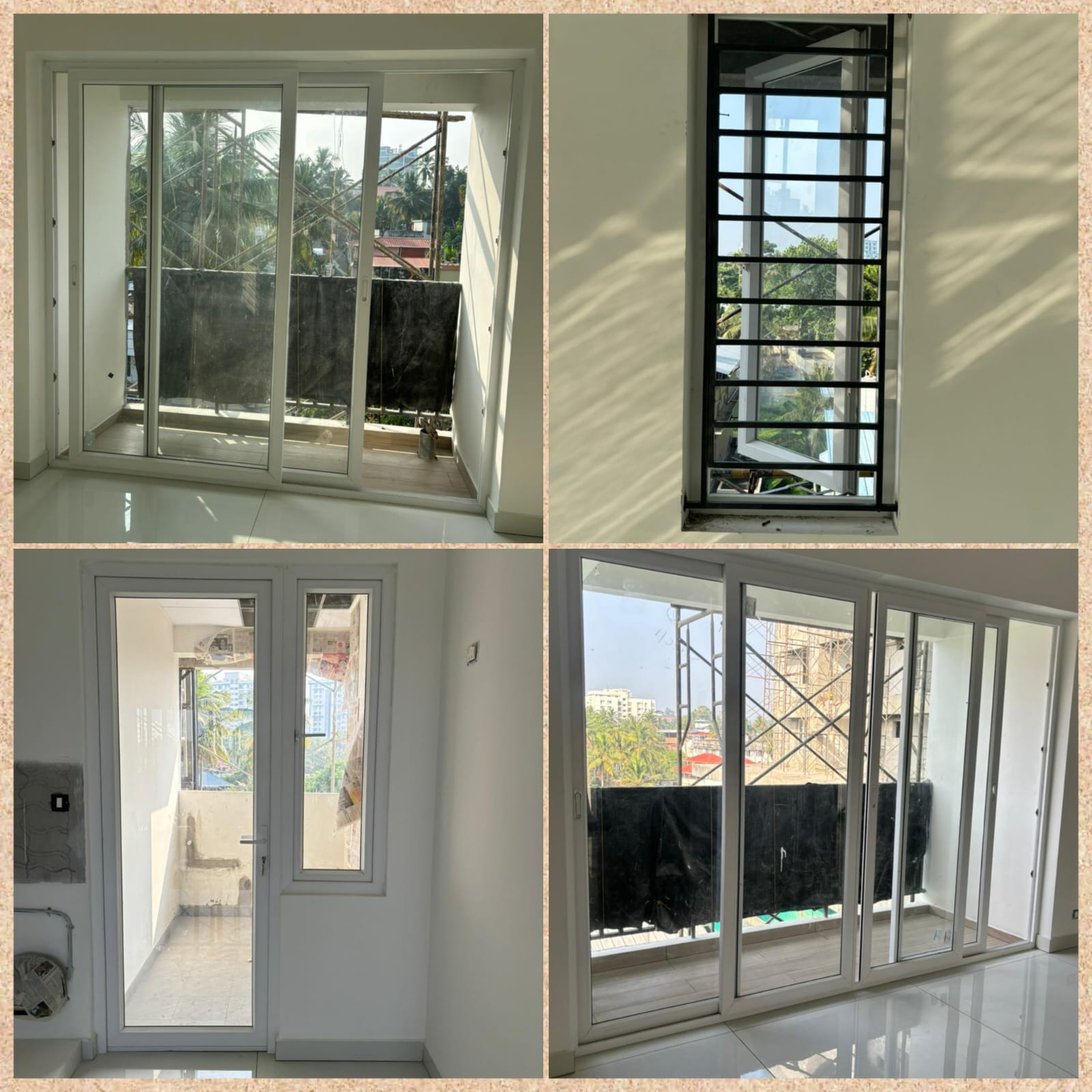

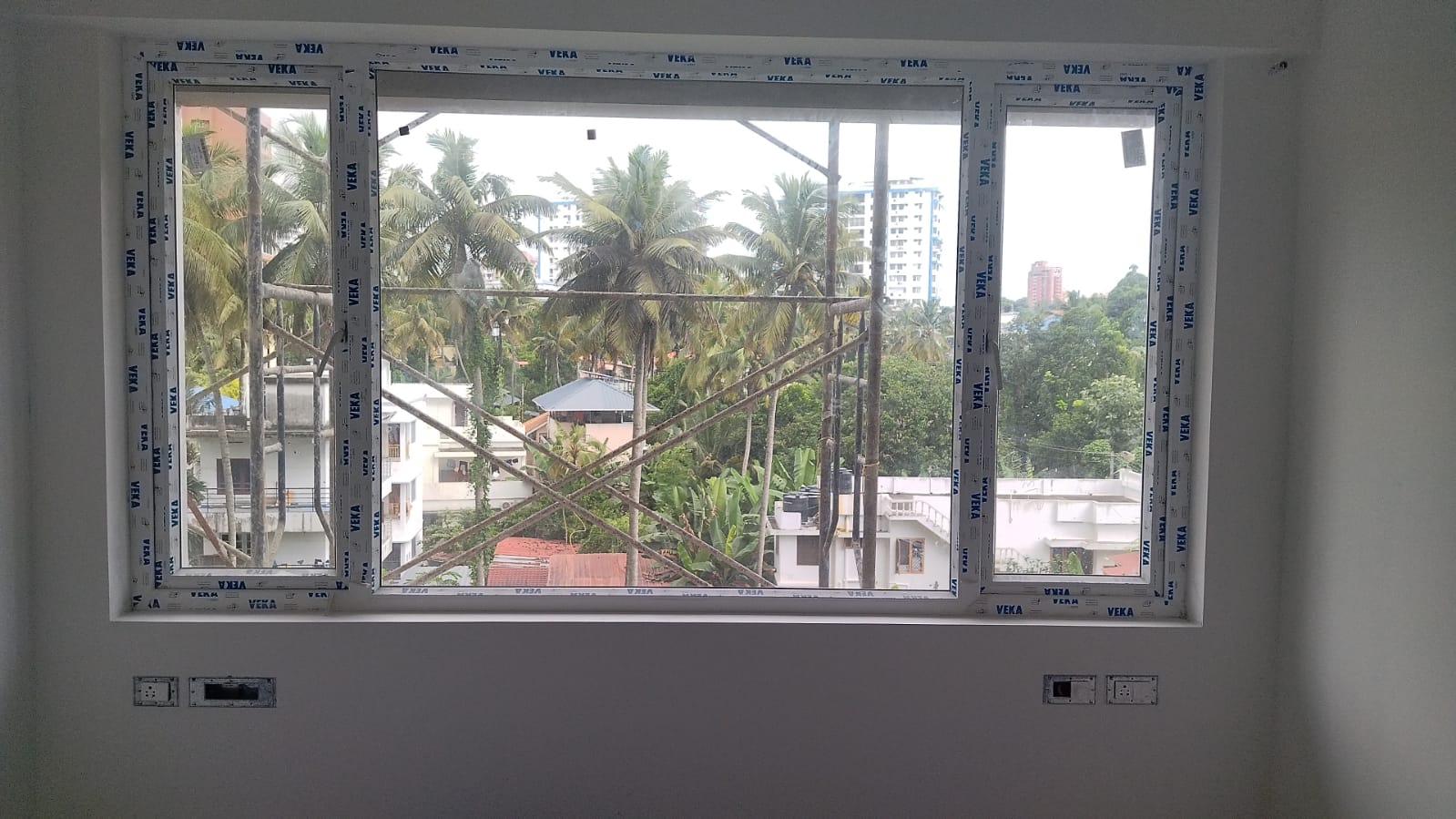

- UPVC Doors & Windows Fixing: Completed in Sample Apartments (1F & 2E)

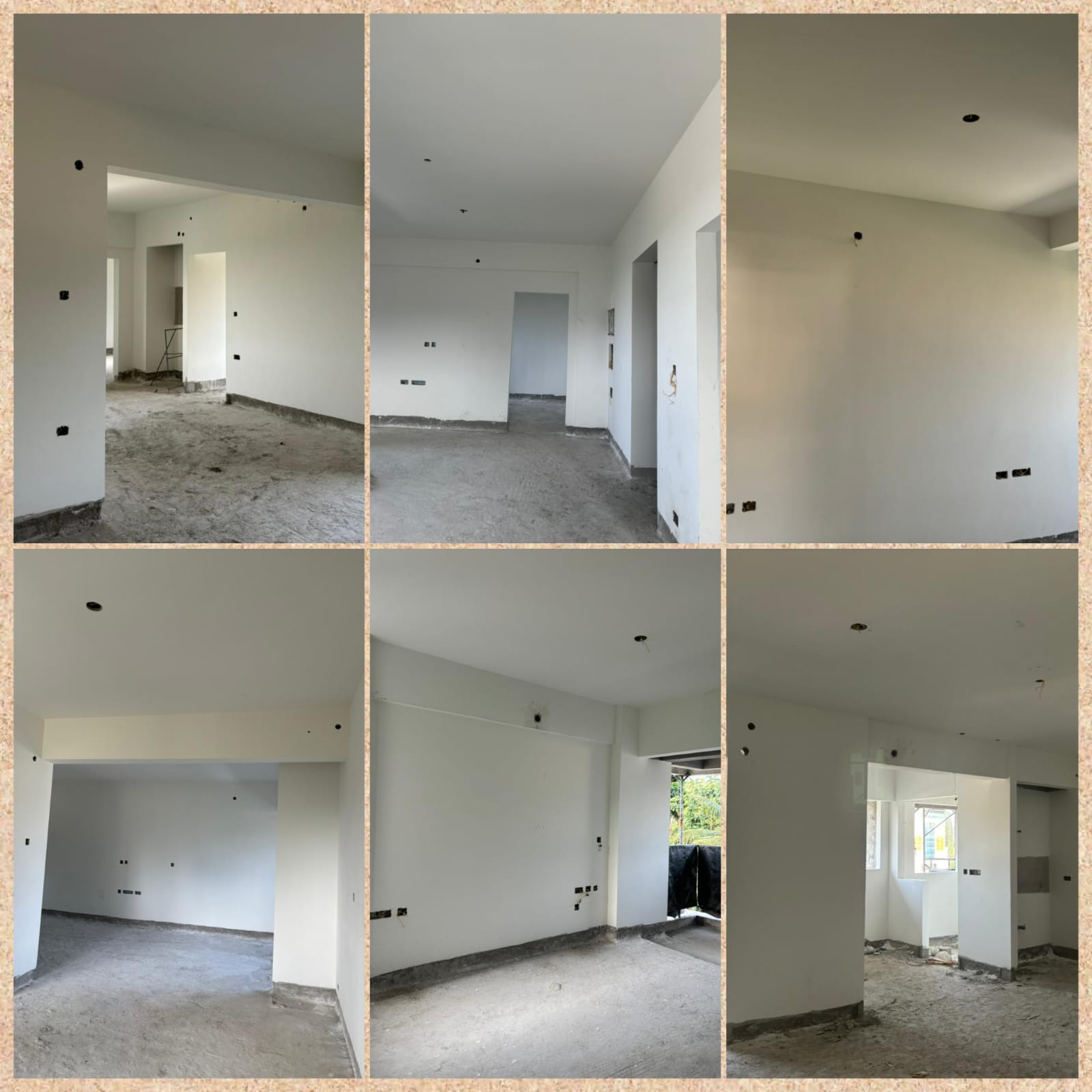

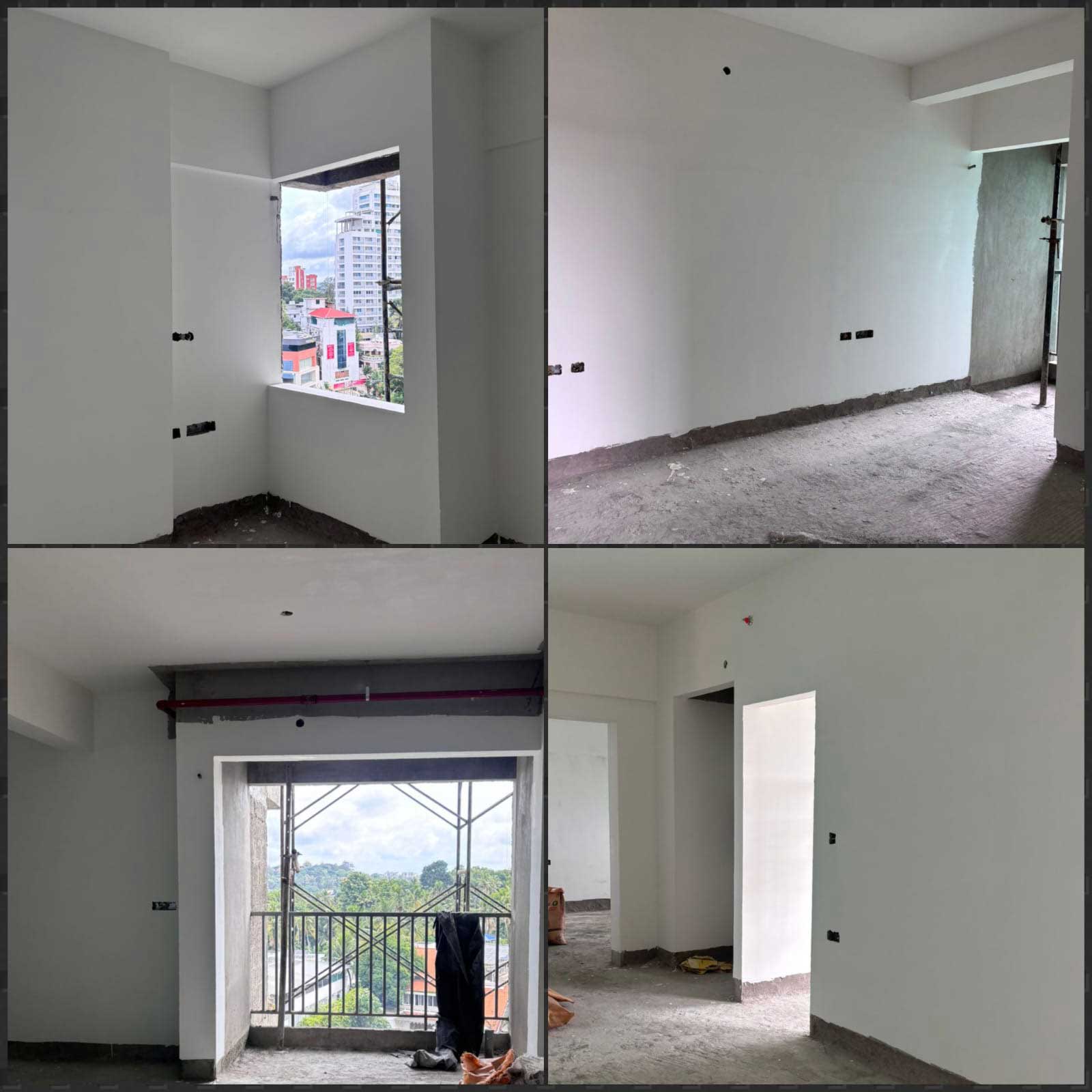

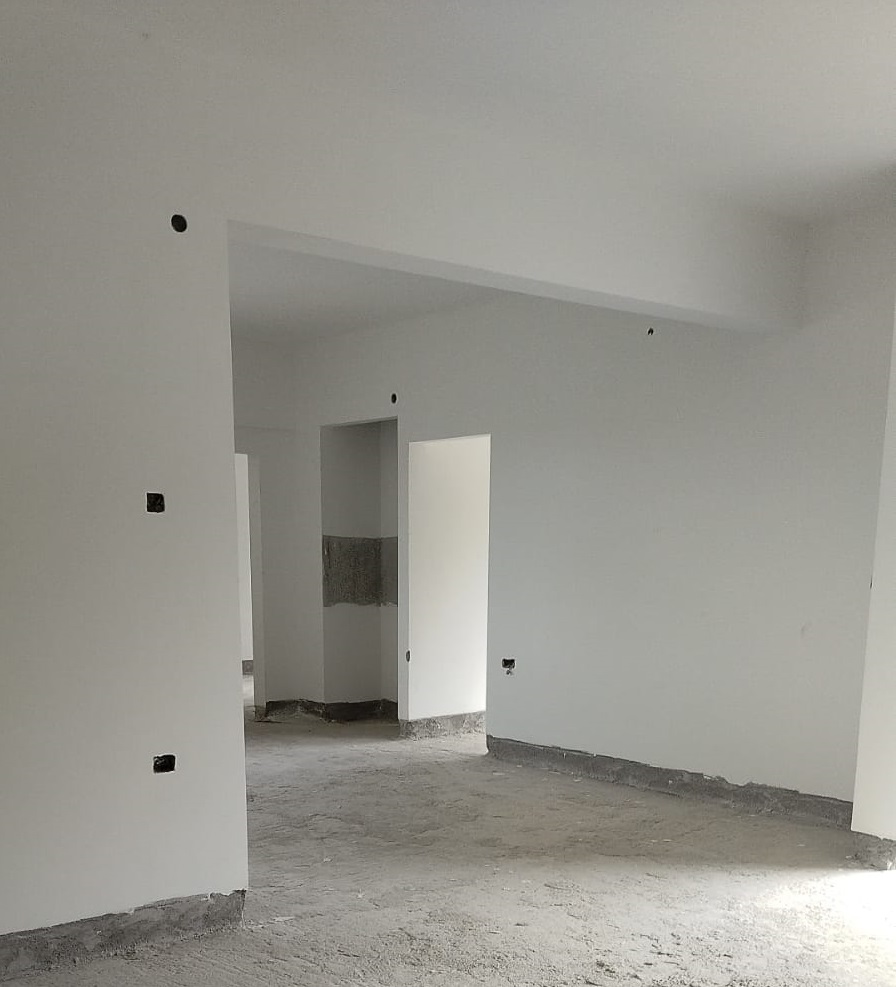

- Wall Putty Work: 68/92 Apartments Completed

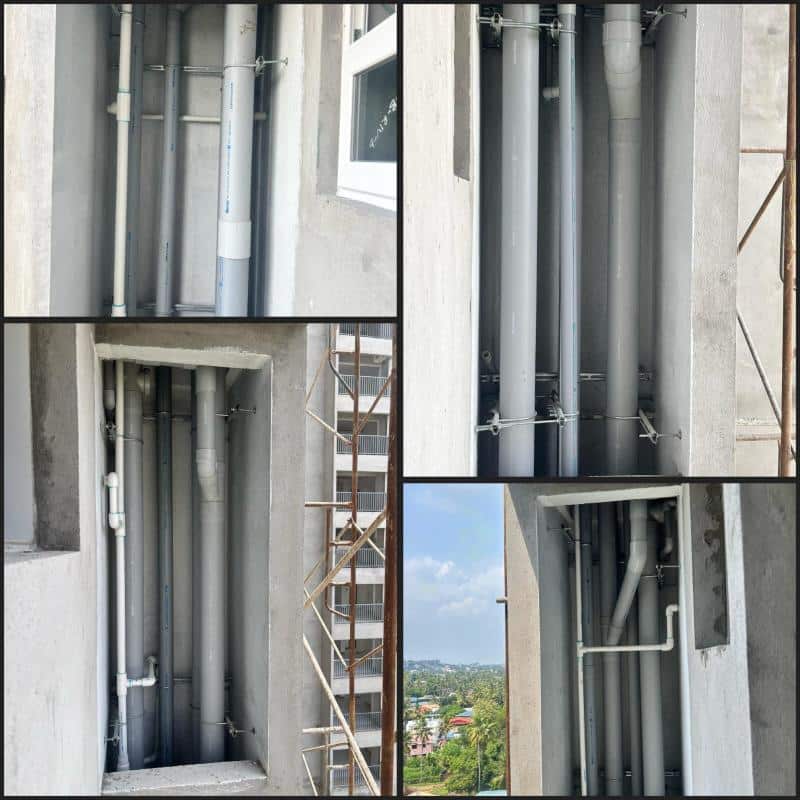

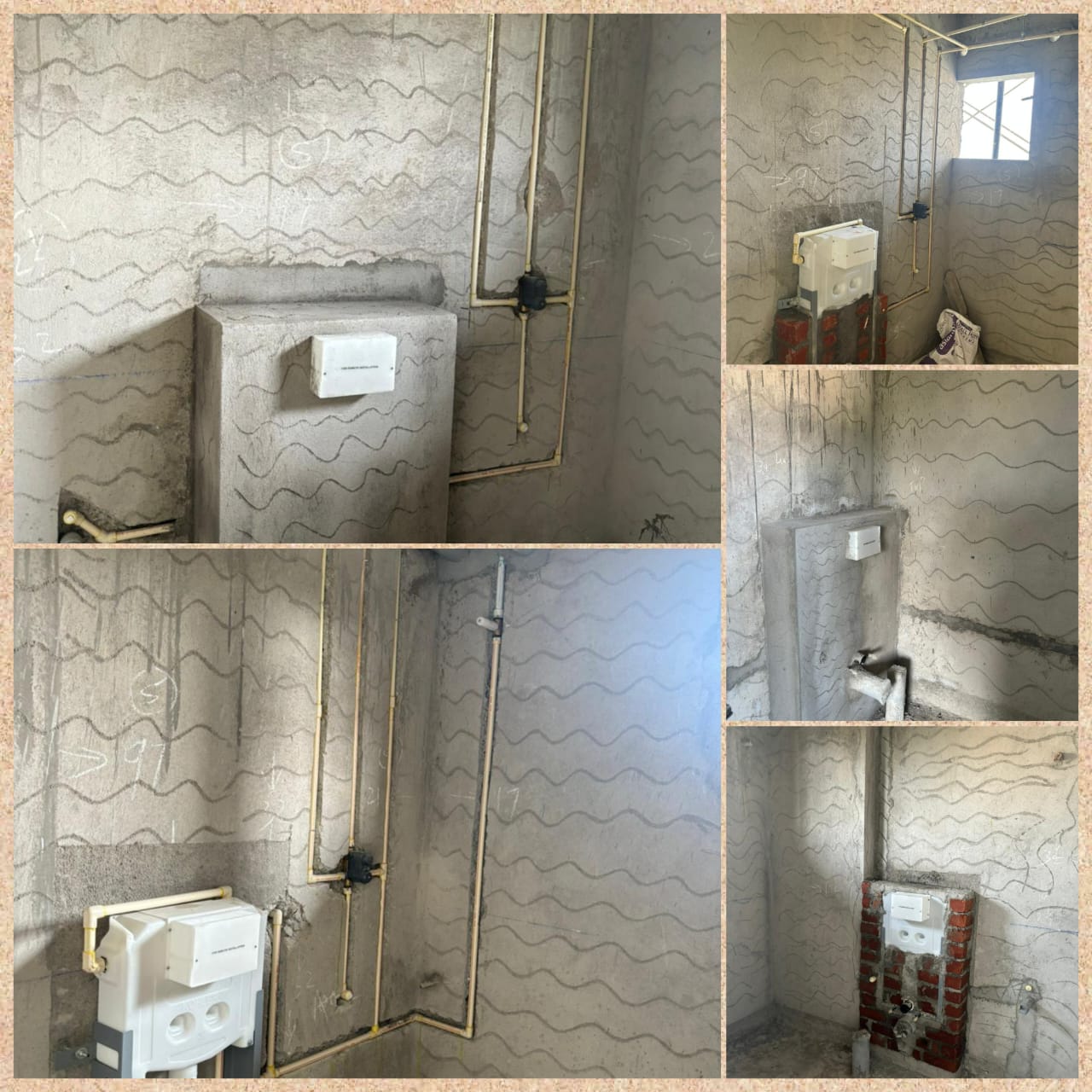

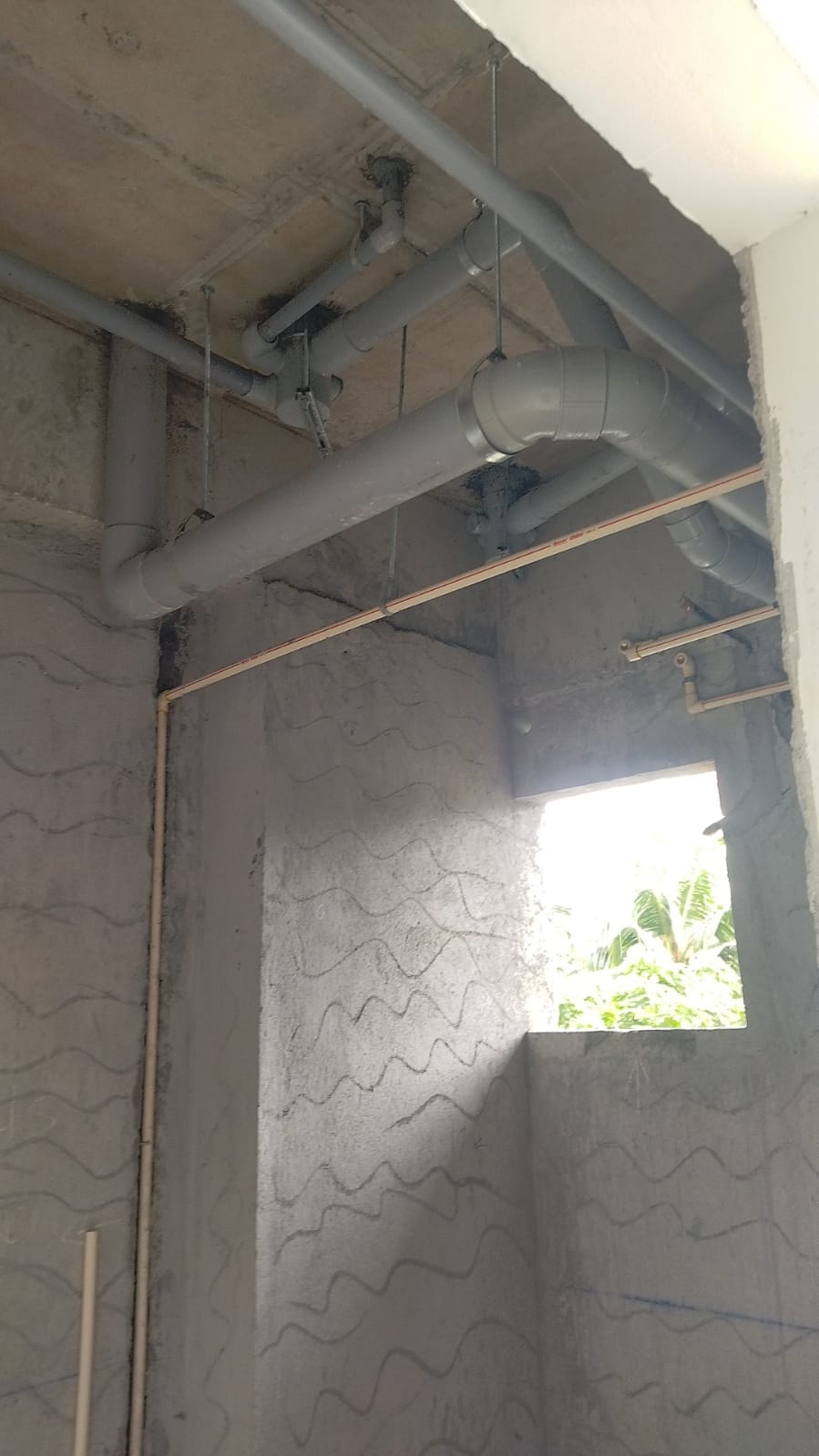

- Apartment Internal Plumbing Work: 79/92 Apartments Completed

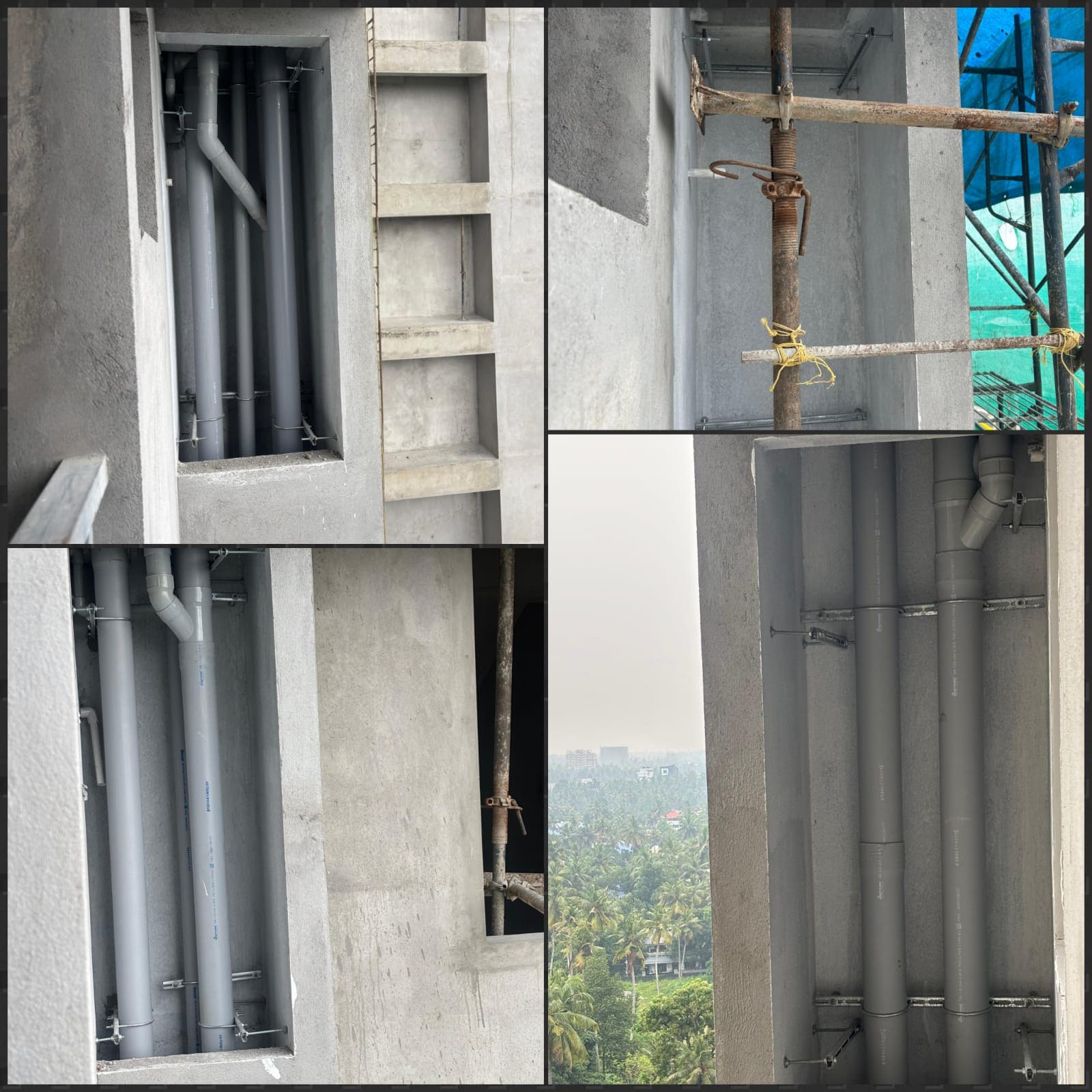

- Duct Plumbing Work: 10/23 Completed
- Cut-Out Handrail Work: 8/15 Completed

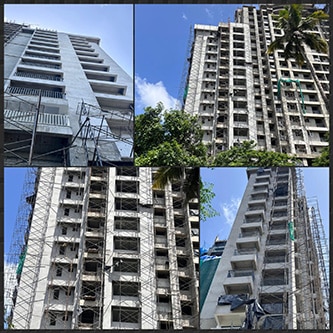

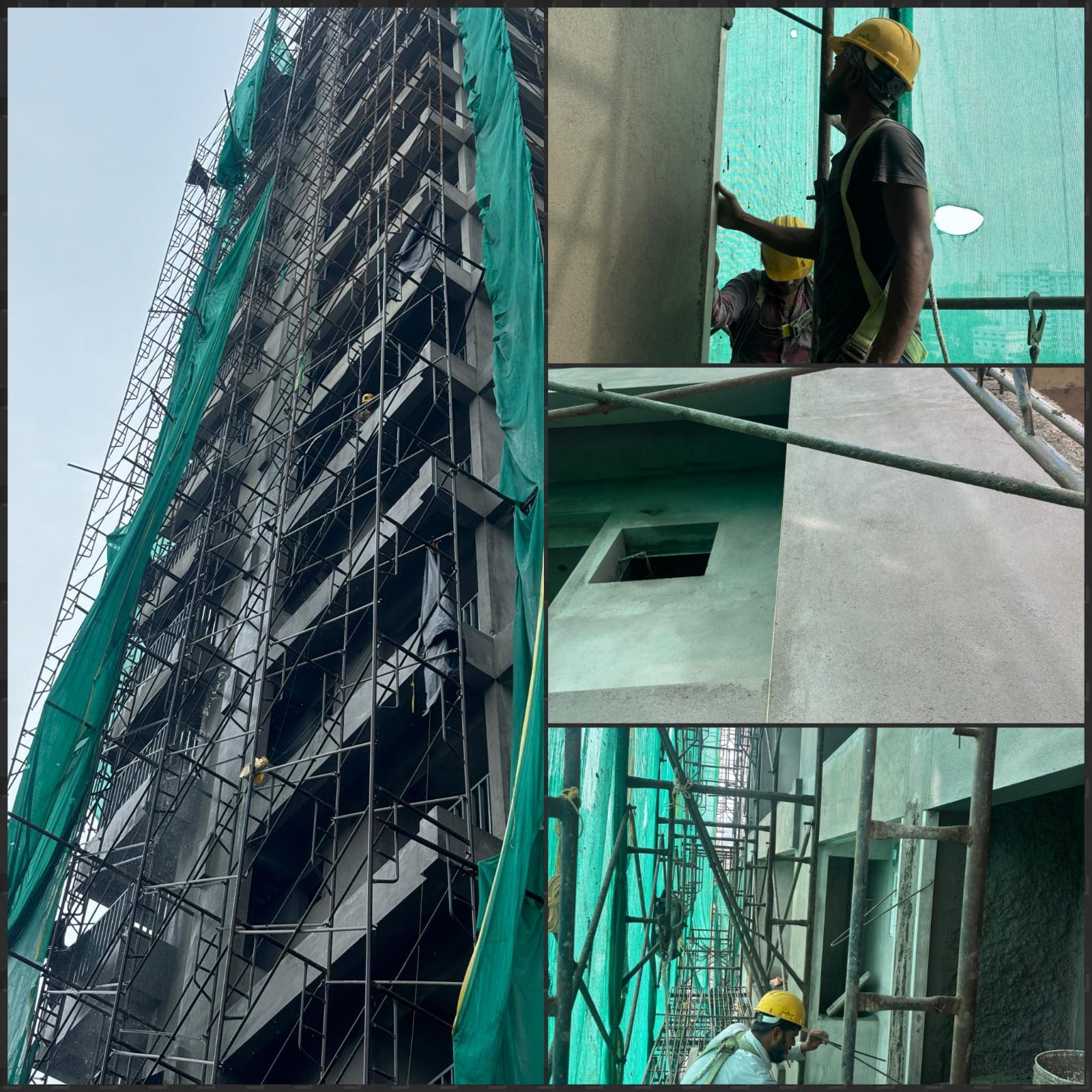

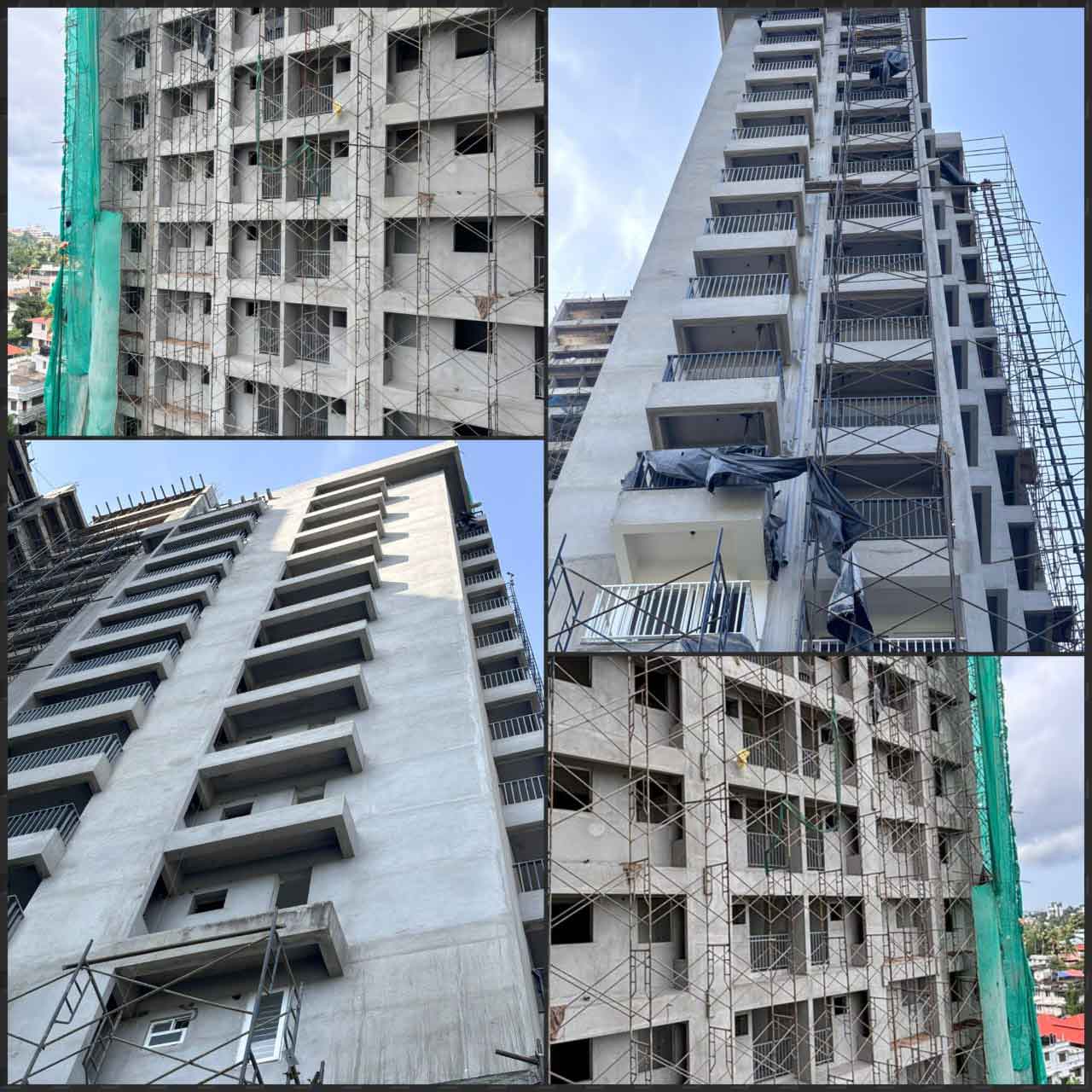

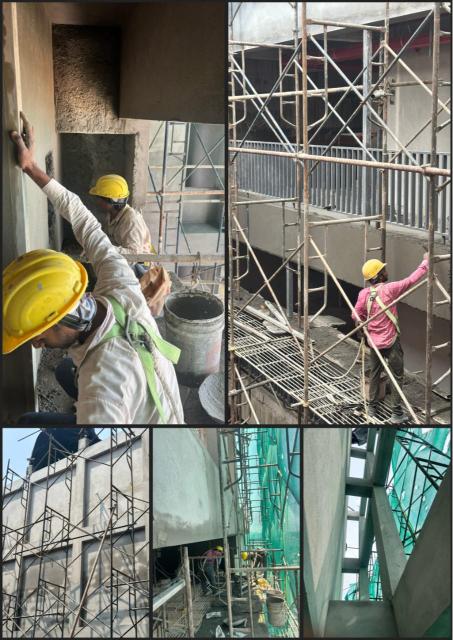

- External Wall Plastering: 80% Completed

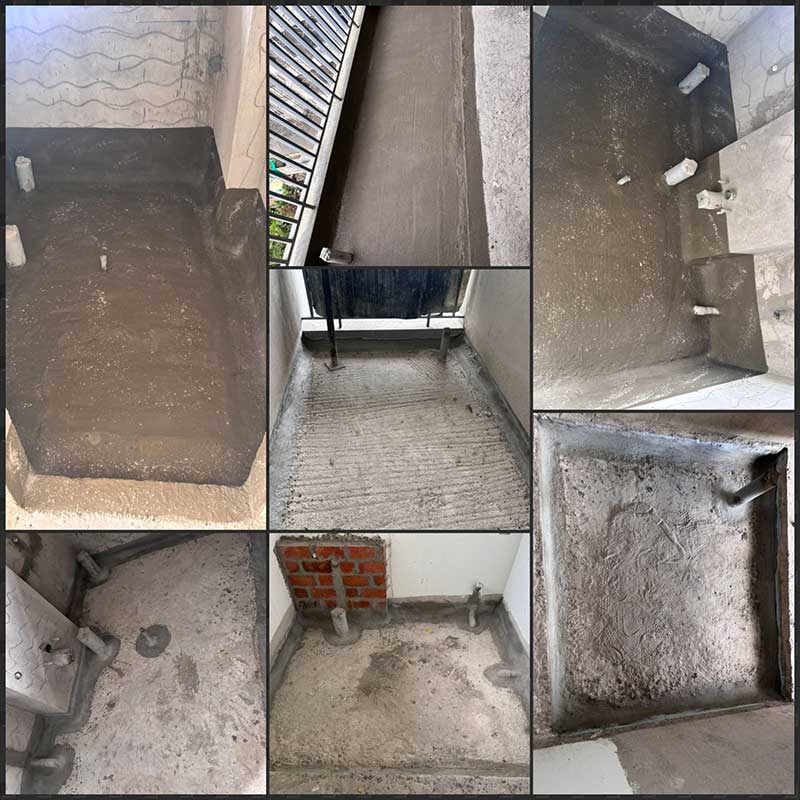

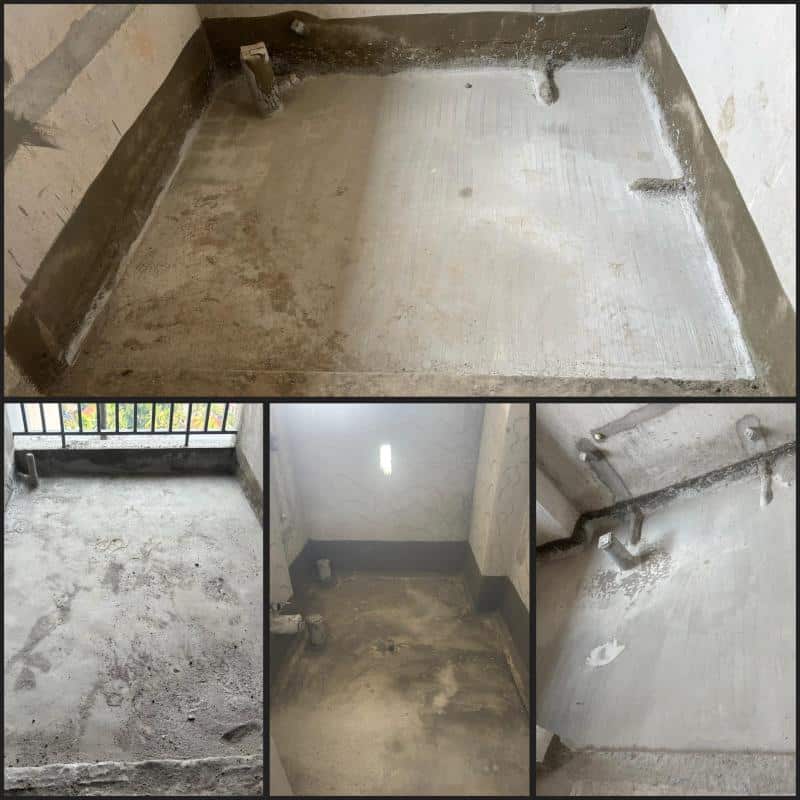

- Inside Apartment Waterproofing: 70/92 Apartments Completed

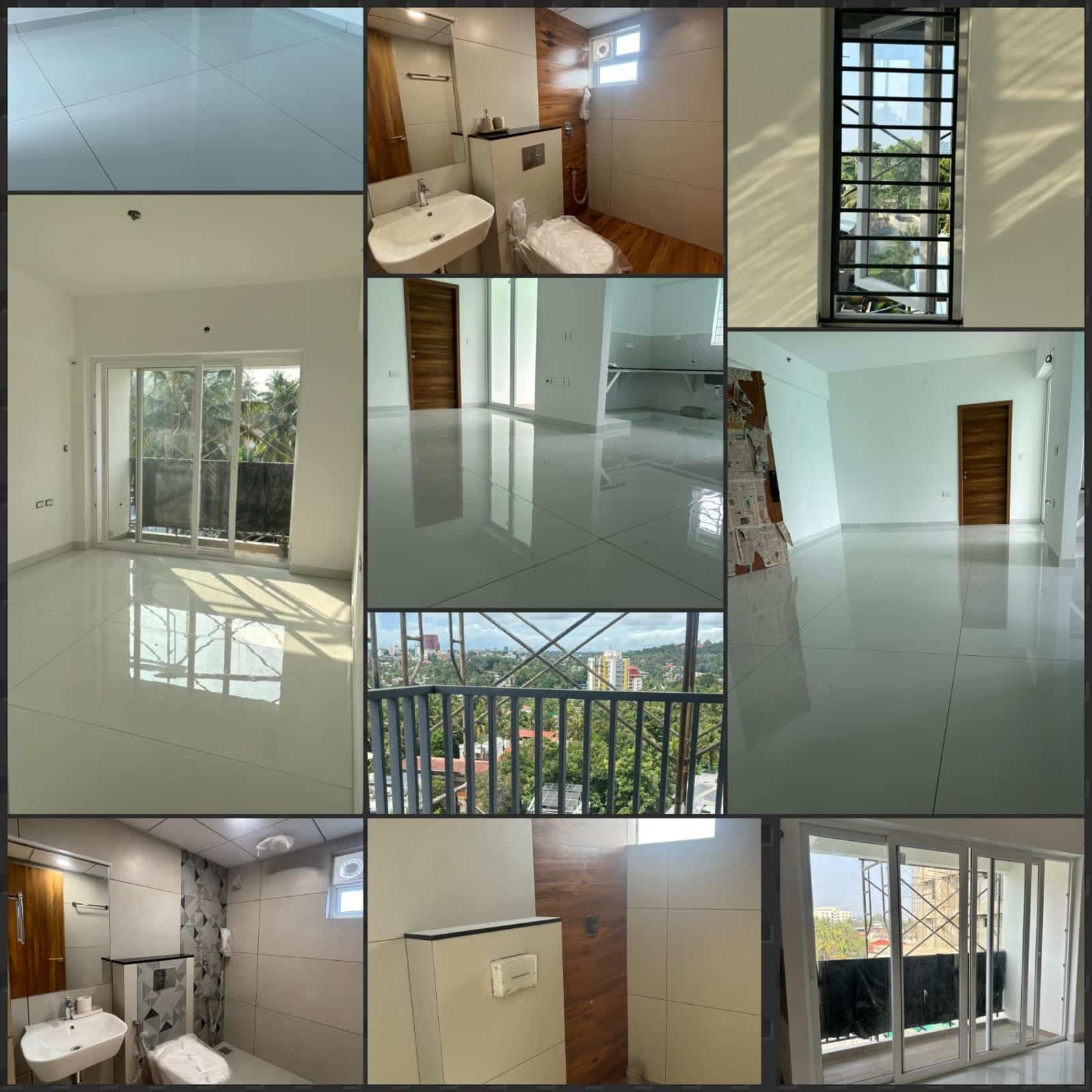

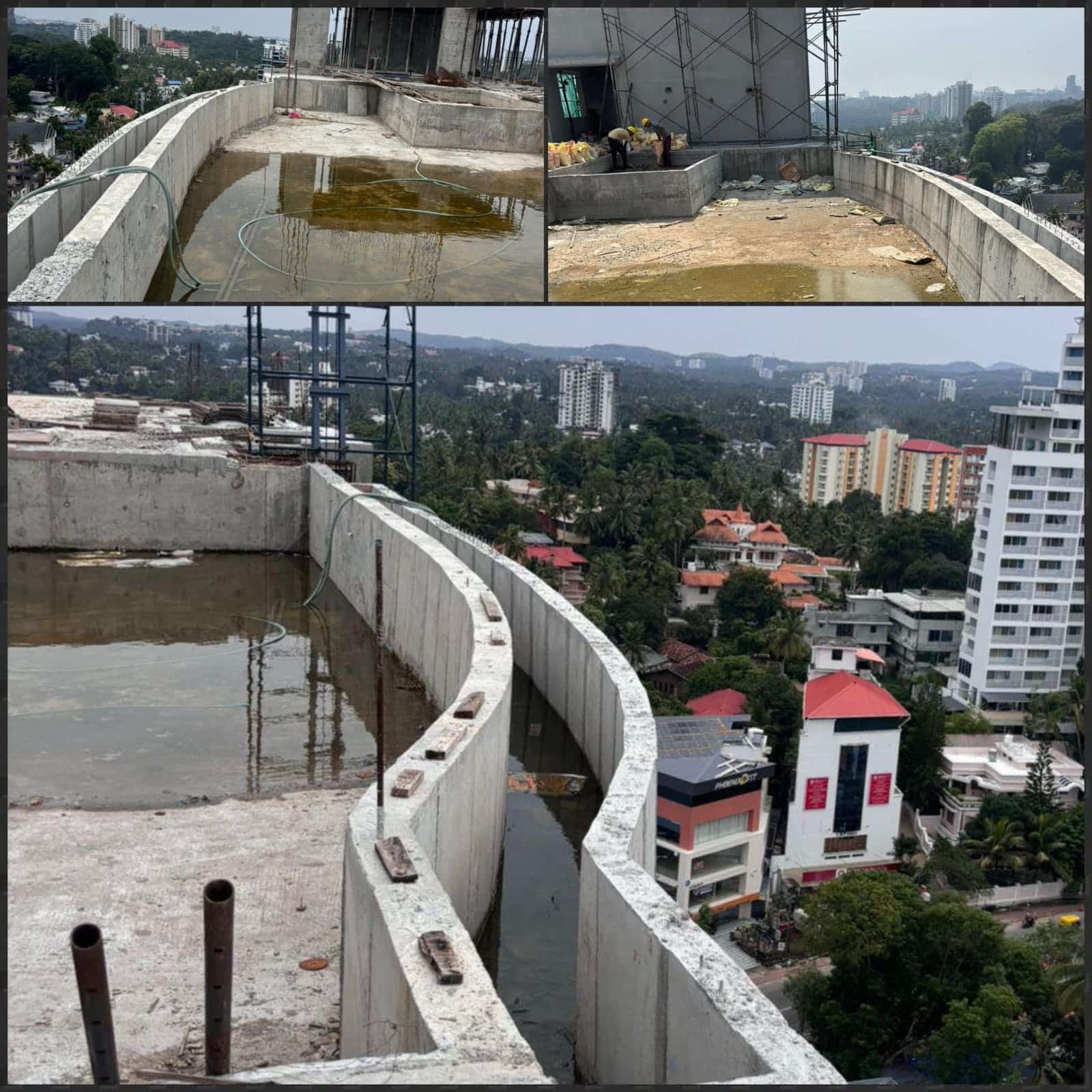

- Mock Up (1F) – Ready to Visit

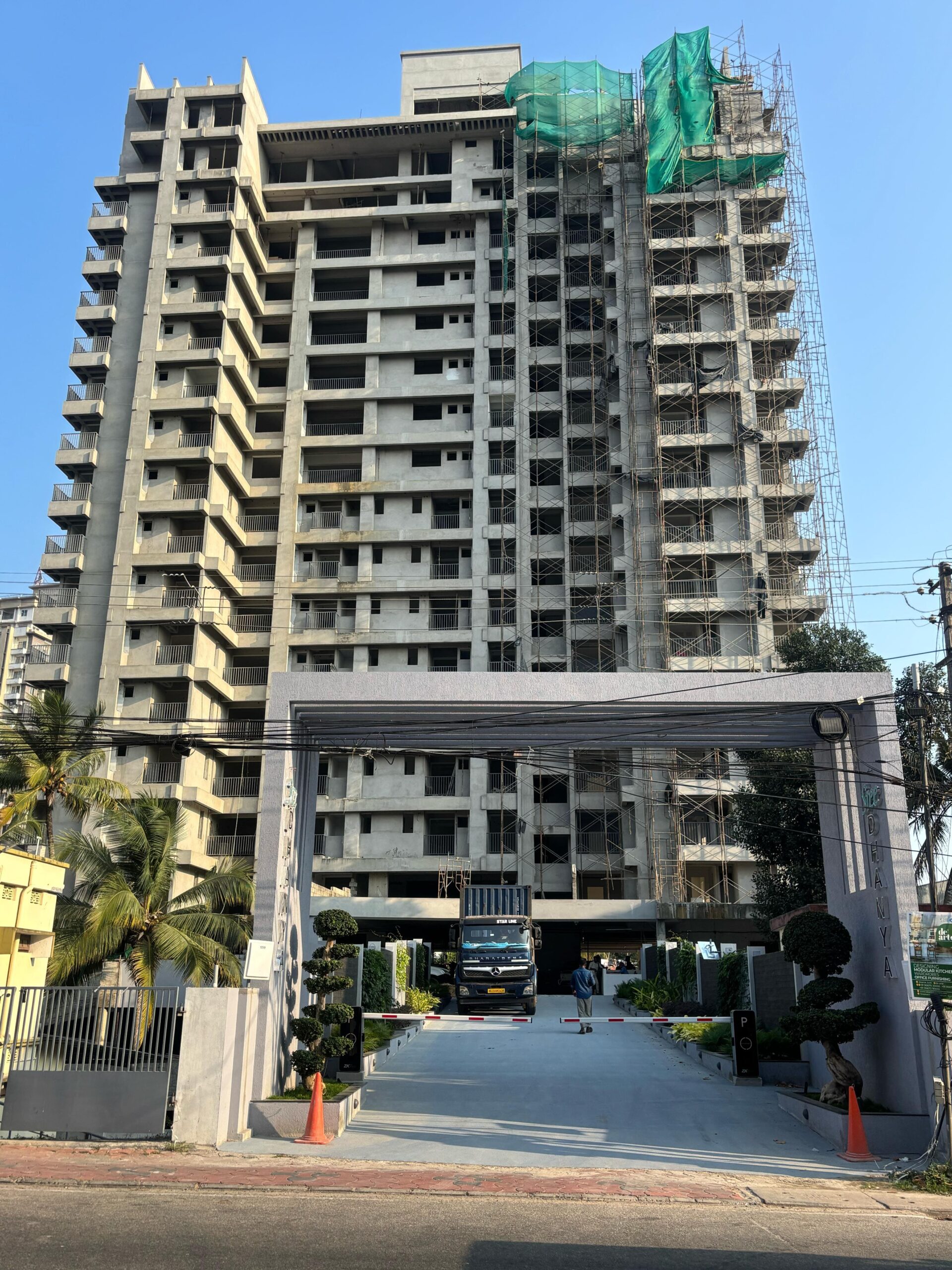

PROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 29.07.2024
- RCC FOR TERRACE FLOOR SLAB – 100% COMPLETED
- COLUMN WORK ABOVE TERRACE FLOOR – 100% COMPLETED
- RCC FOR SWIMMING POOL – 100% COMPLETED

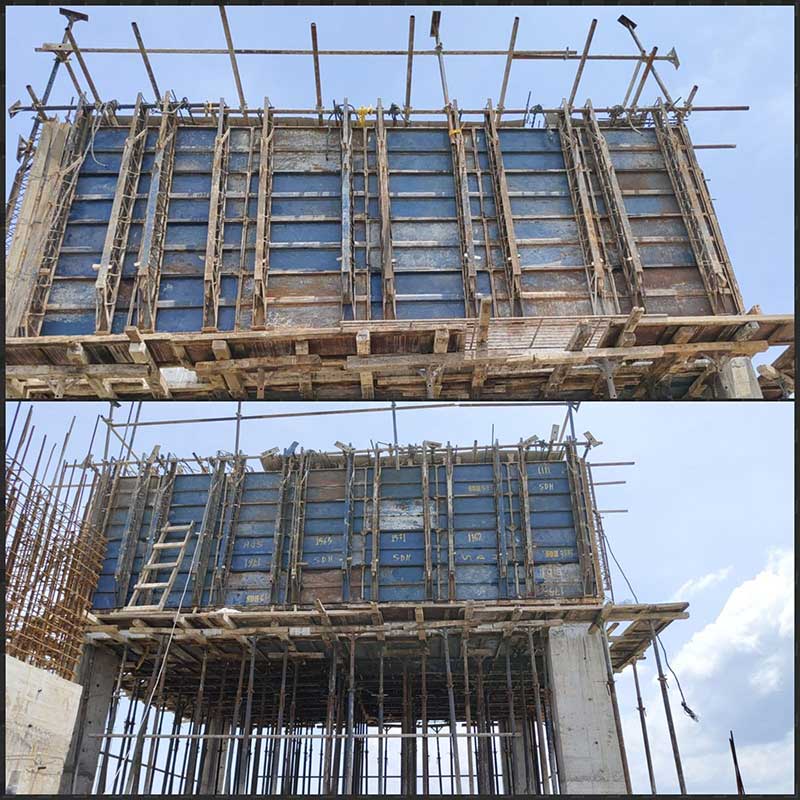

- RCC FOR OHT BASE SLAB – 100% COMPLETED
- RCC FOR BADMINTON COURT & GYM FLOOR – 100% COMPLETED
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 89 APT OUT OF 92 COMPLETED
- CEILING PLASTERING – 91 APT OUT OF 92 COMPLETED.
- INSIDE WALL PLASTERING – 88 APT OUT OF 92 COMPLETED.

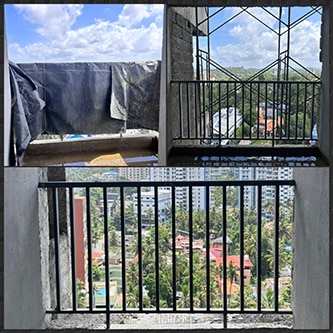

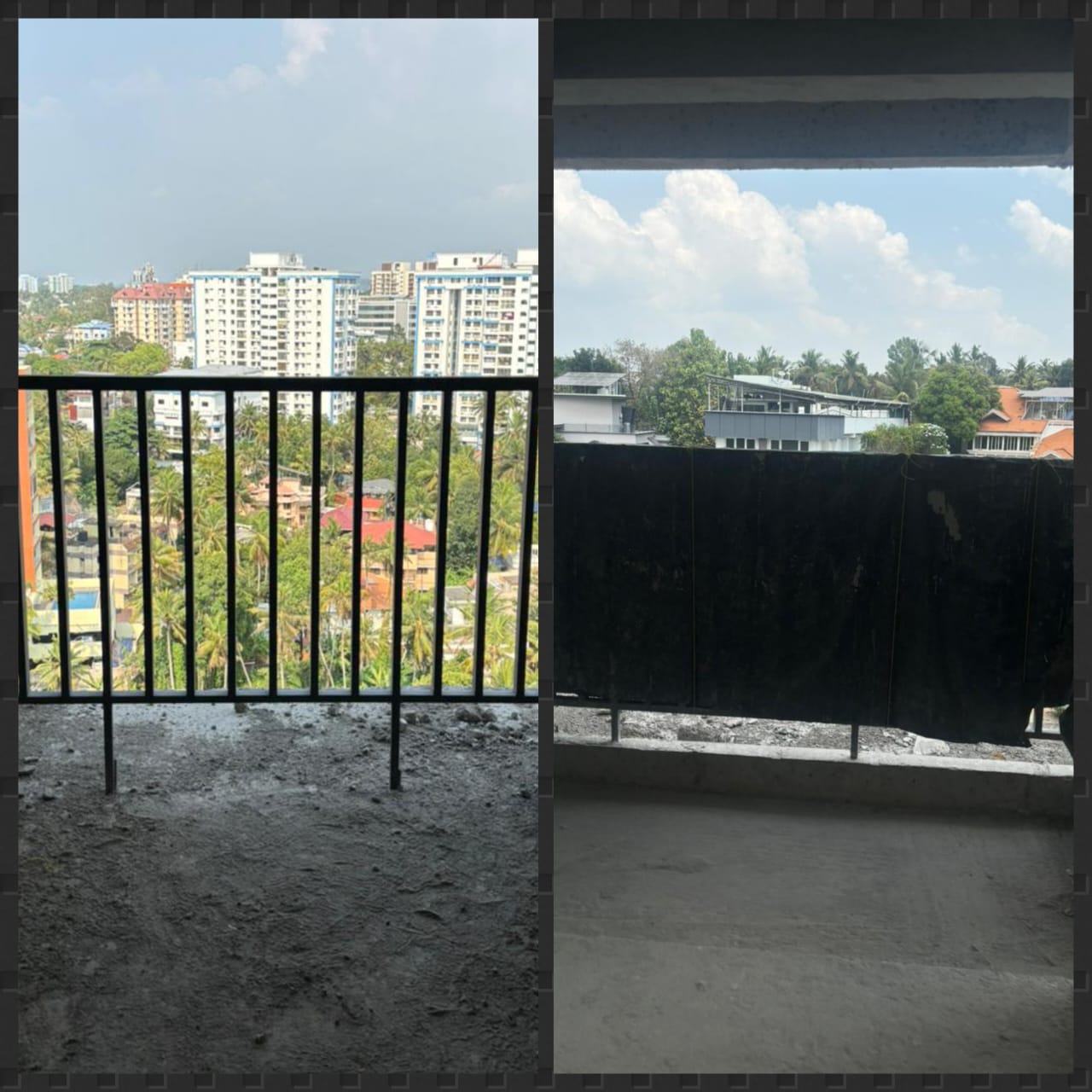

- BALCONY HANDRAIL FIXING – 88 APT OUT OF 92 COMPLETED.
- ELECTRICAL WALL CHASING & BOX FIXING – 89 APT OUT OF 92 COMPLETED.

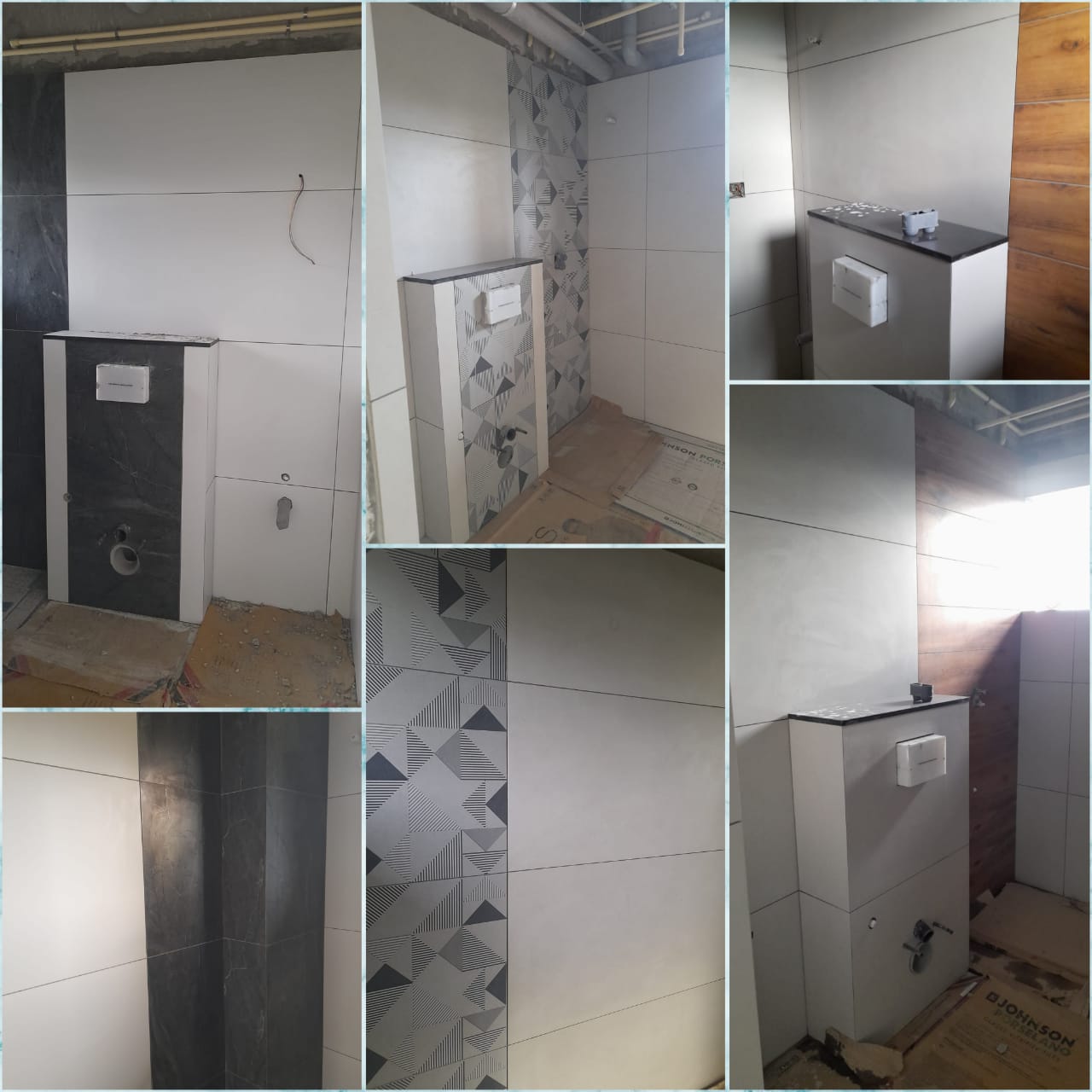

- WALL & FLOOR TILING COMPLETED IN SAMPLE APT – (1F & 2E )
- UPVC DOORS & WINDOWS FIXING COMPLETED IN SAMPLE APT – (1F & 2E)
- WALL PUTTY WORK – APT 54 APT OUT OF 92 COMPLETED
- APT INTERNAL PLUMBING WORK-78 APT OUT OF 93 COMPLETED
- EXTERNAL WALL PLASTERING- 40% COMPLETED

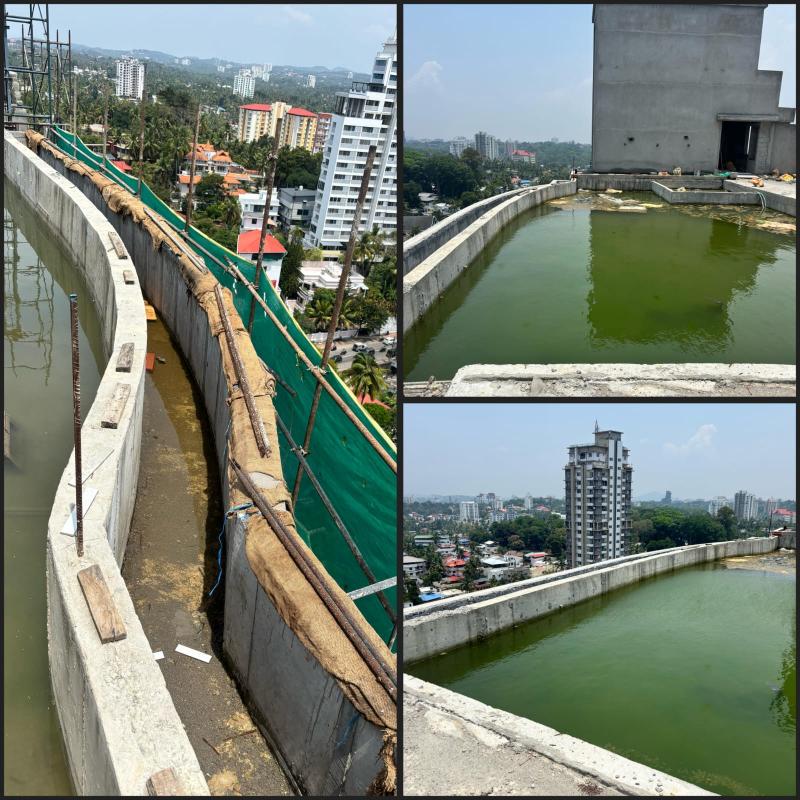

- INSIDE APT WATERPROOFING- 4 APT OUT OF 92 COMPLETED
ROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 21.06.2024
- RCC FOR TERRACE FLOOR SLAB – 100% COMPLETED
- COLUMN WORK ABOVE TERRACE FLOOR – 30% COMPLETED
- RCC FOR SWIMMING POOL – 100% COMPLETED
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 88 OUT OF 93 APTS COMPLETED
- CEILING PLASTERING – 90 OUT OF 93 APTS COMPLETED
- INSIDE WALL PLASTERING – 86 OUT OF 93 APTS COMPLETED.
- BALCONY HANDRAIL FIXING – 88 OUT OF 93 APTS COMPLETED.
- ELECTRICAL WALL CHASING & BOX FIXING – 87 OUT OF 93 APTS COMPLETED
- WALL & FLOOR TILING COMPLETED IN SAMPLE APT – (1F)
- UPVC DOORS & WINDOWS FIXING COMPLETED IN SAMPLE APT – (1F)
- WALL PUTTY WORK – 47 OUT OF 93 APTS COMPLETED
- APT INTERNAL PLUMBING WORK – 63 OUT OF 93 APTS COMPLETED
- EXTERNAL WALL PLASTERING – 25% COMPLETED
PROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 25.03.2024

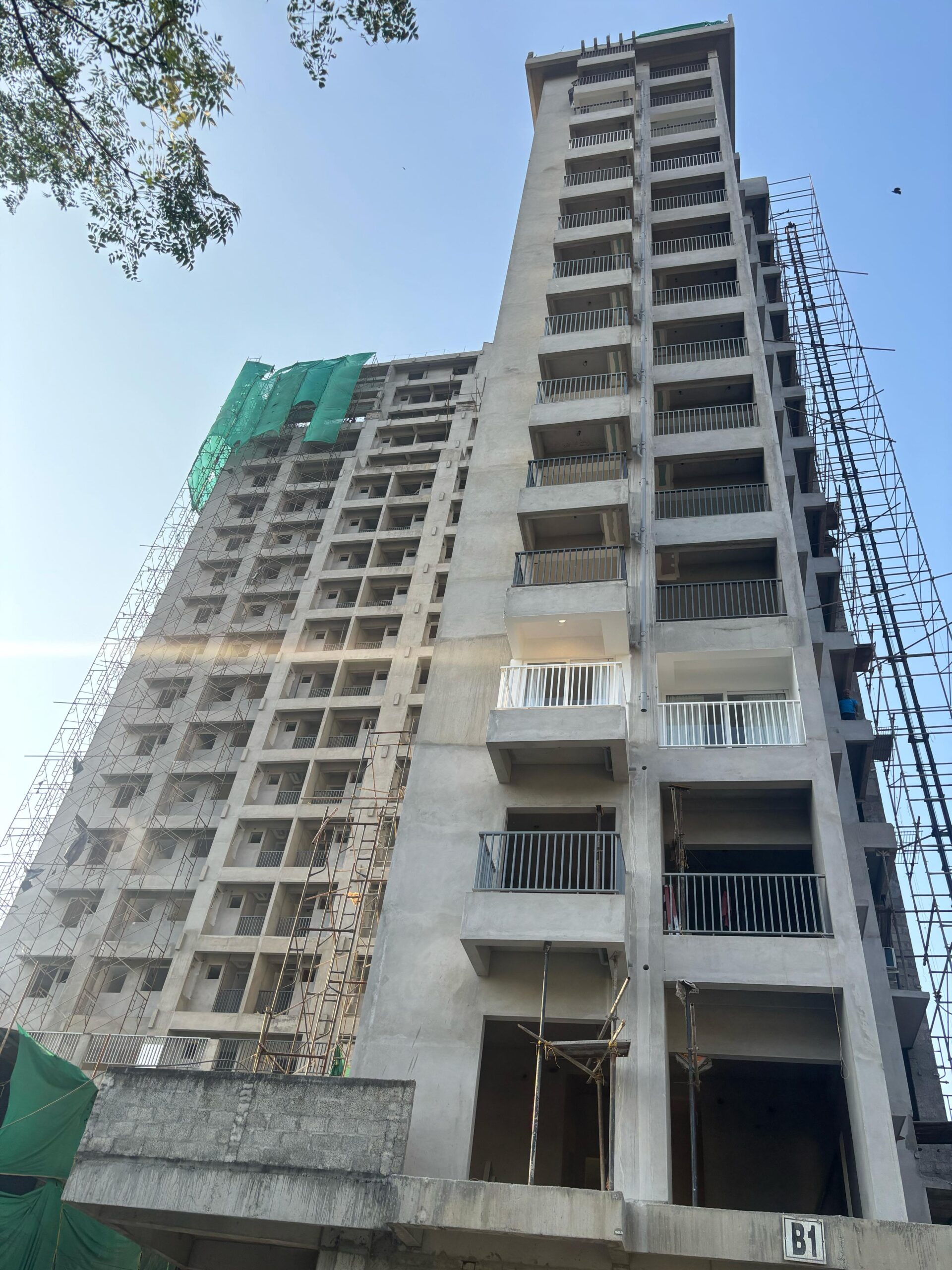

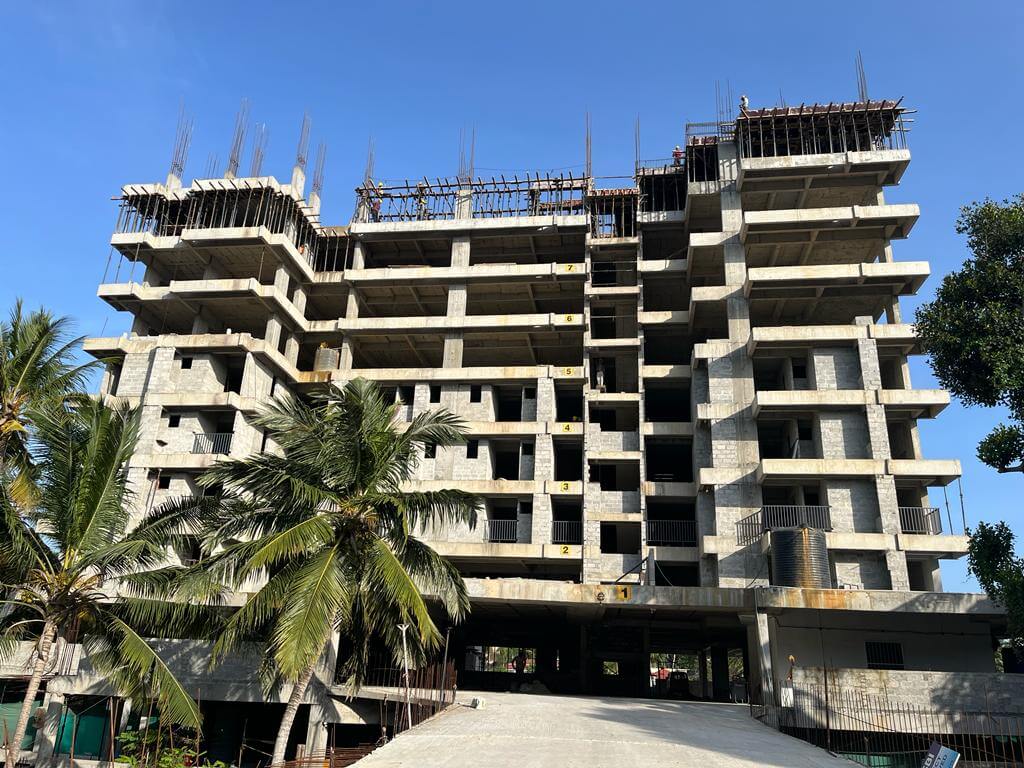

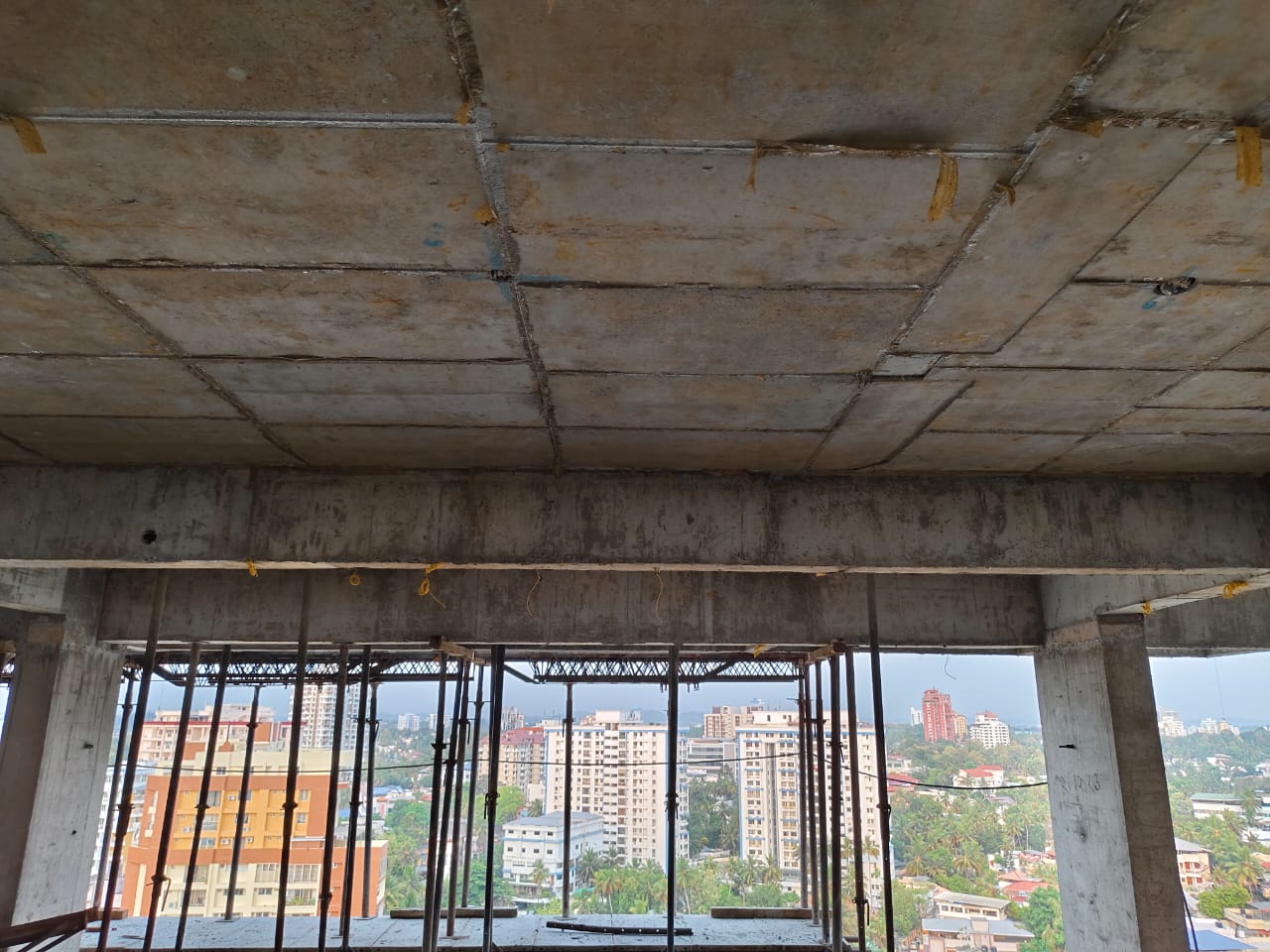

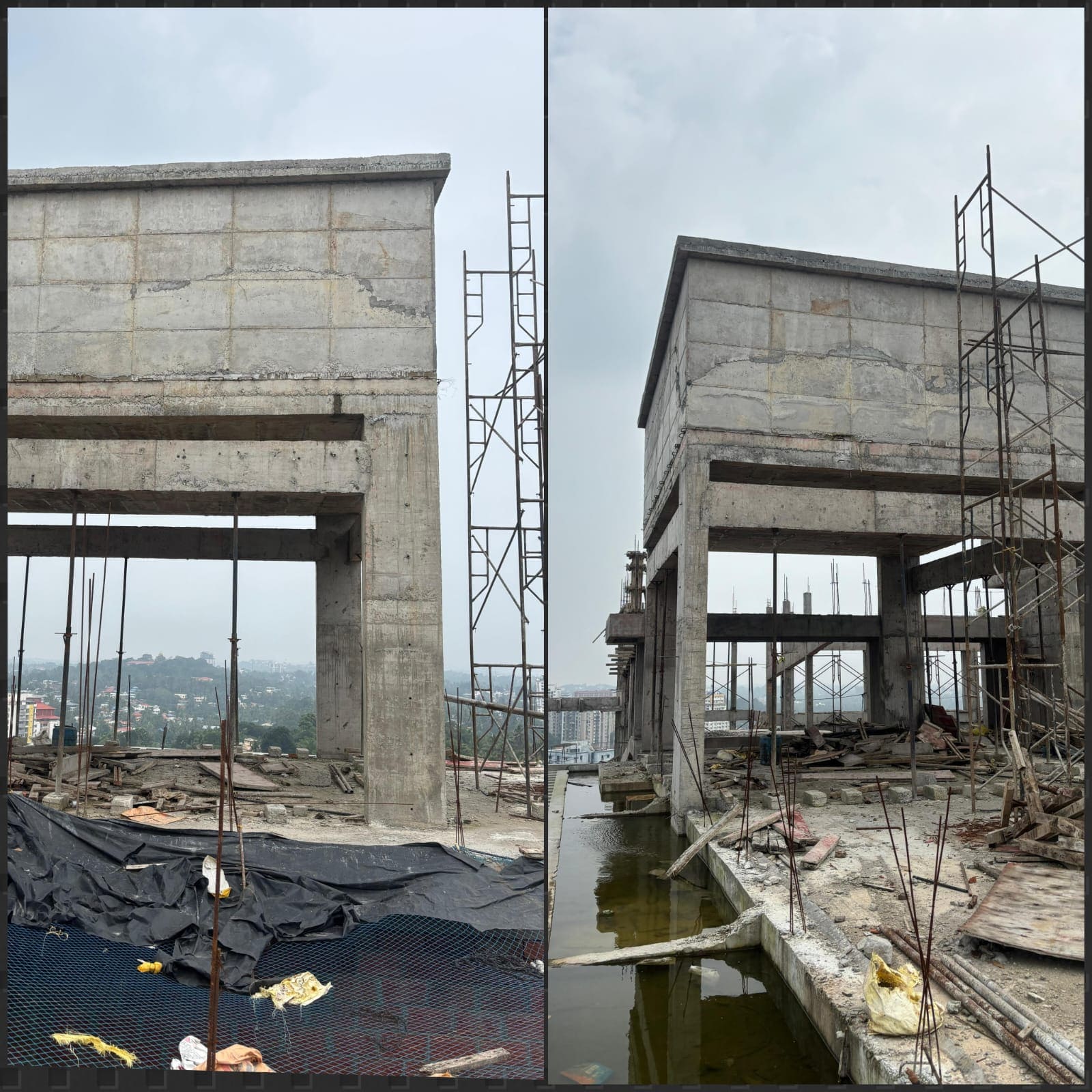

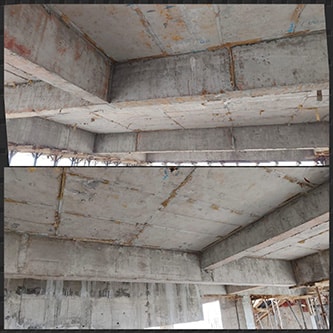

- RCC FOR 15TH FLOOR SLAB – 100% COMPLETED

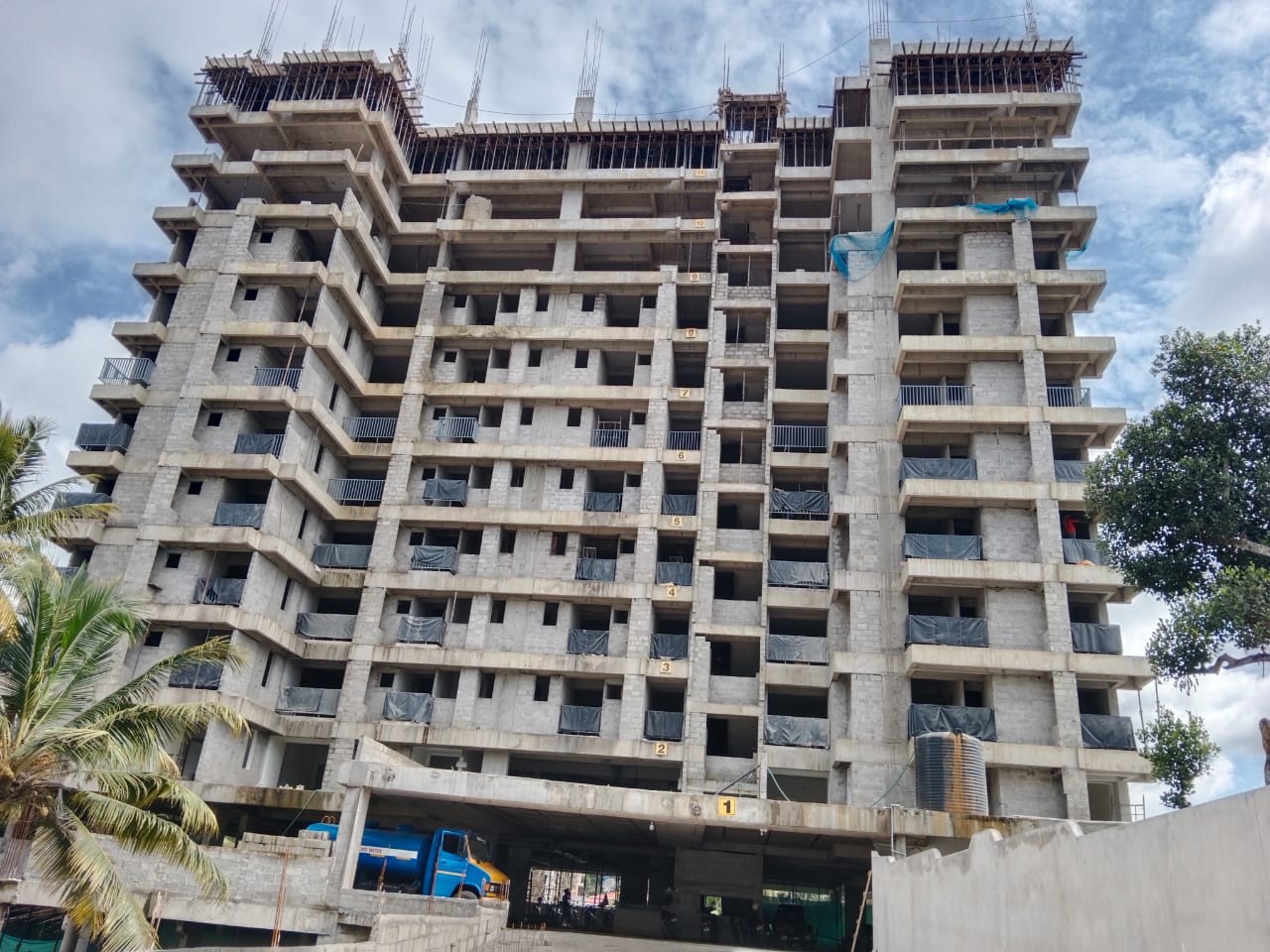

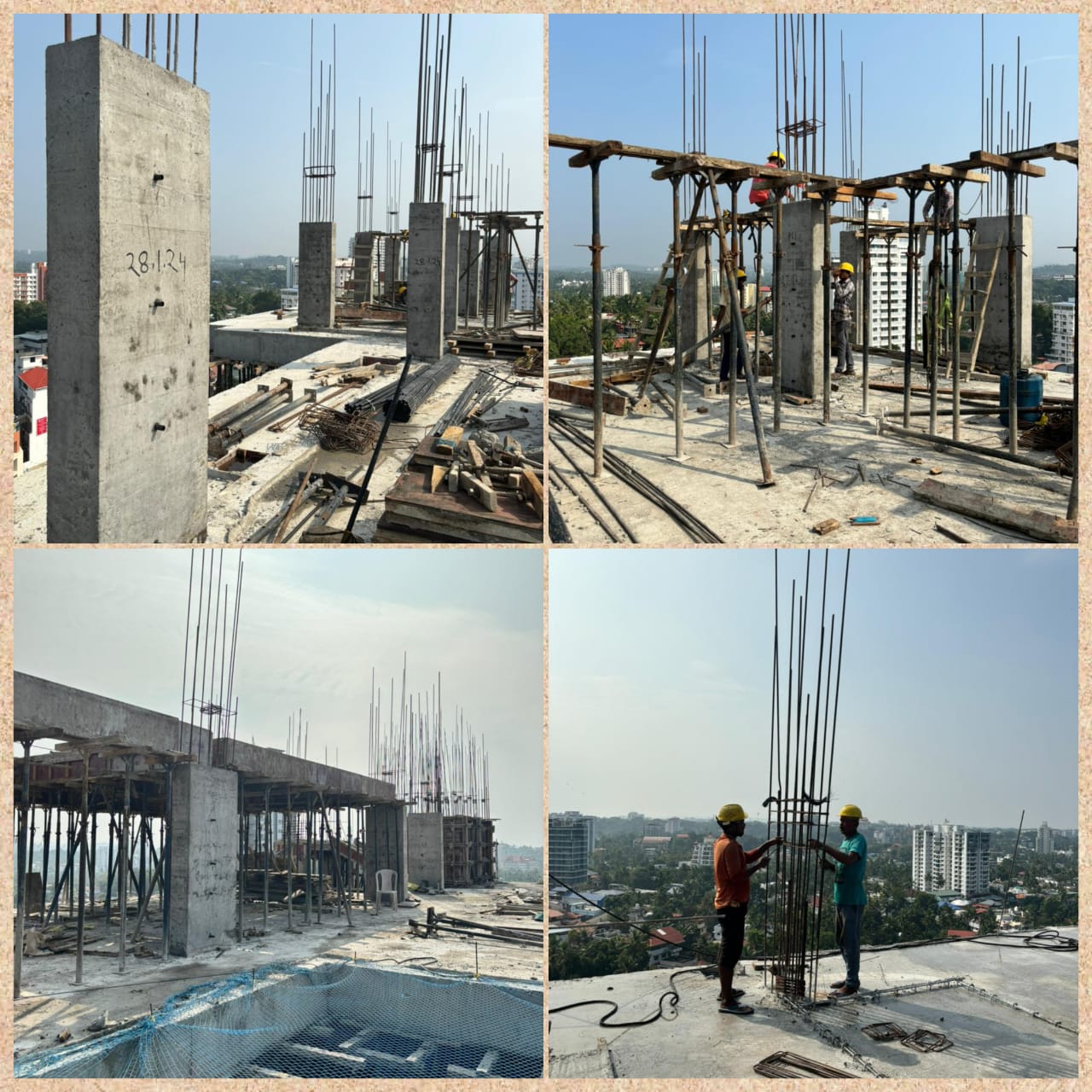

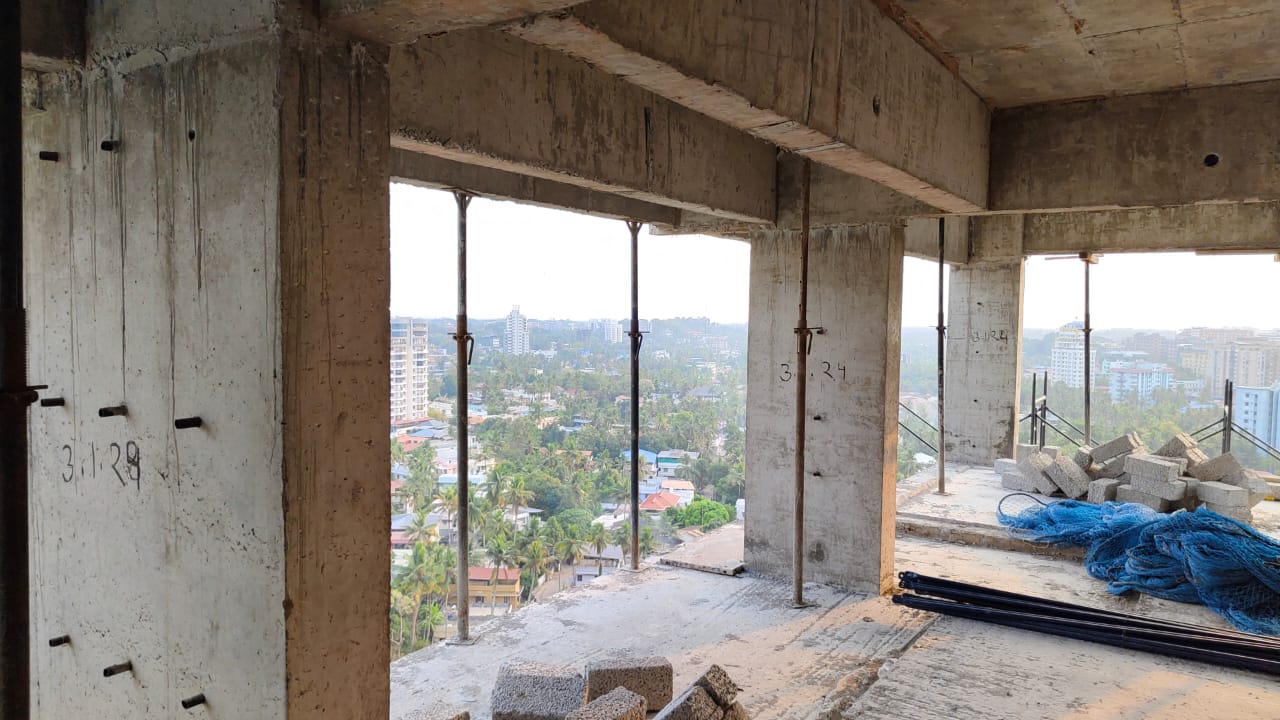

- COLUMN WORK FOR 15TH TO 16TH FLOOR – 78% COMPLETED

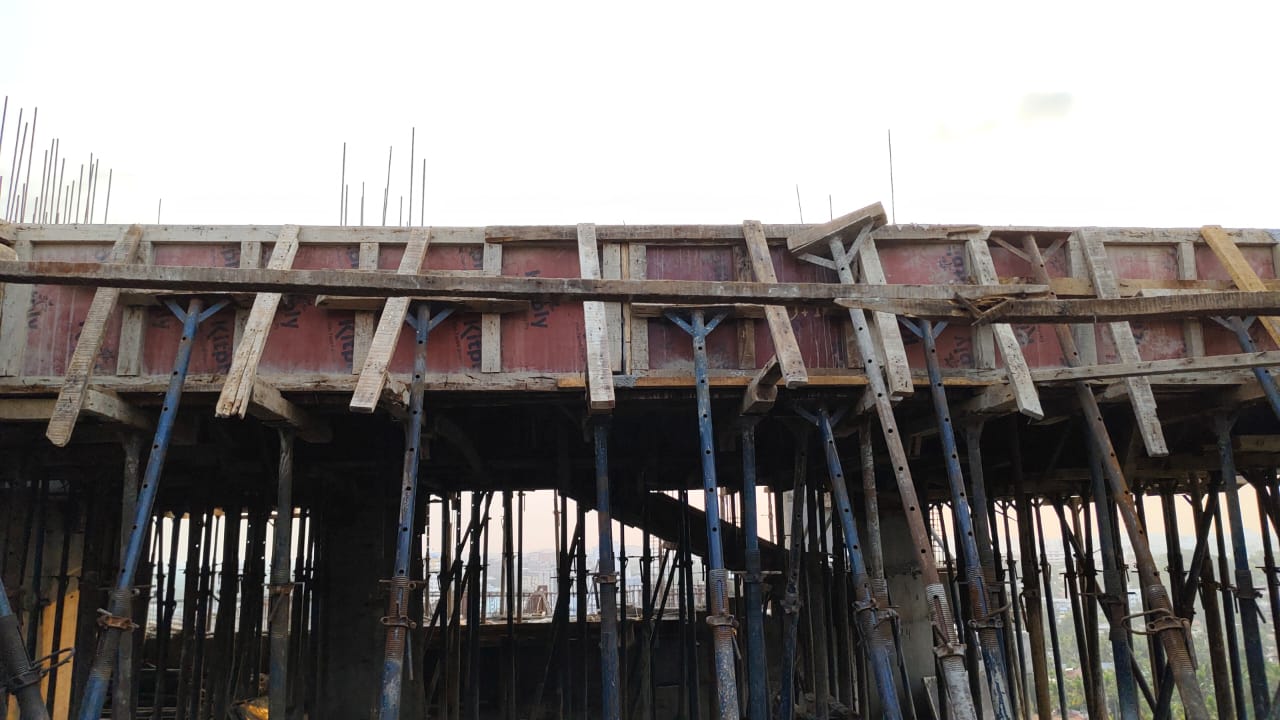

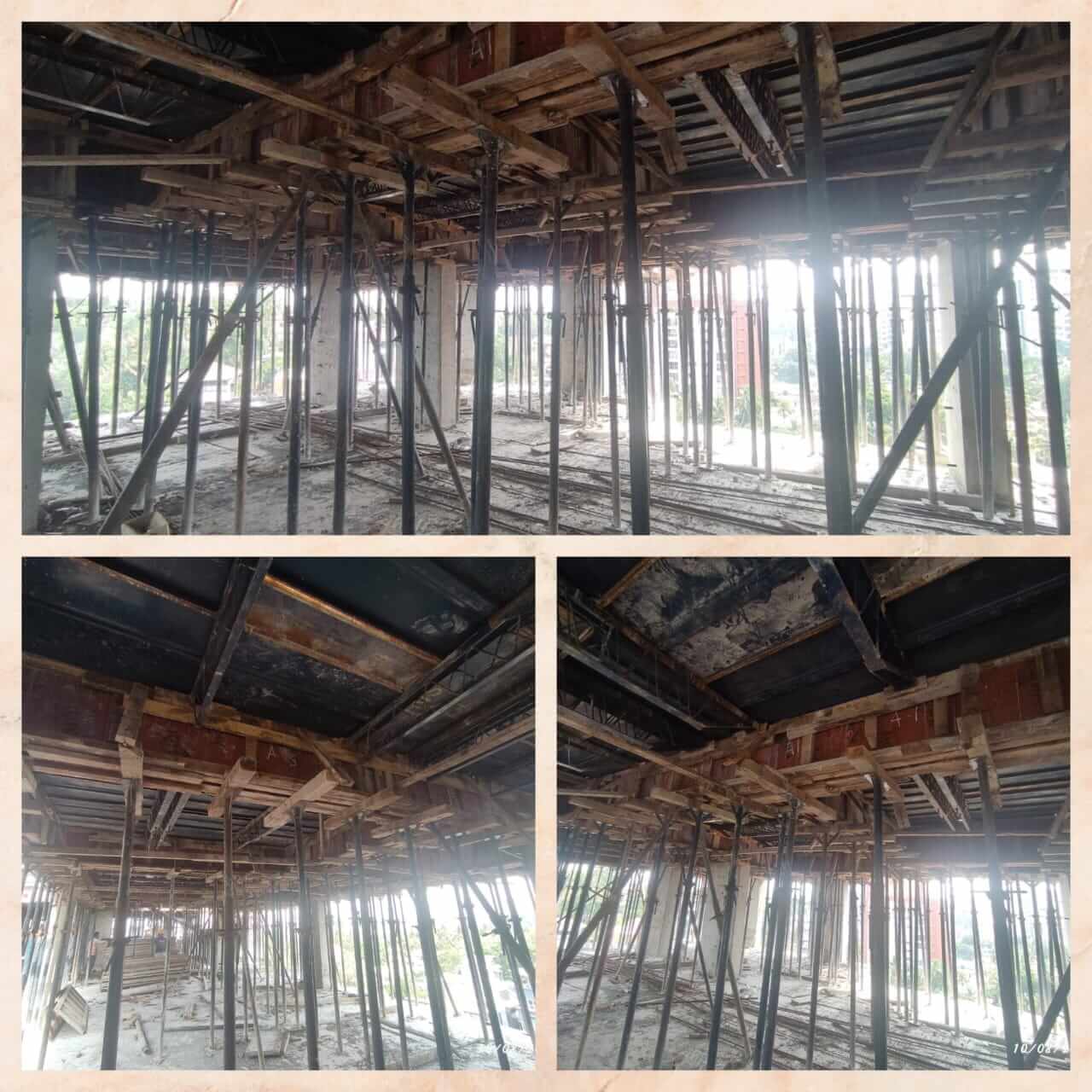

- FORMWORK FOR 16TH FLOOR – 80% COMPLETED
- STEELWORK FOR 16TH FLOOR – 100% COMPLETED
- RCC FOR 16TH FLOOR – 70% COMPLETED
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 85 APT OUT OF 93 COMPLETED
- CEILING PLASTERING -85 APT OUT OF 93 COMPLETED

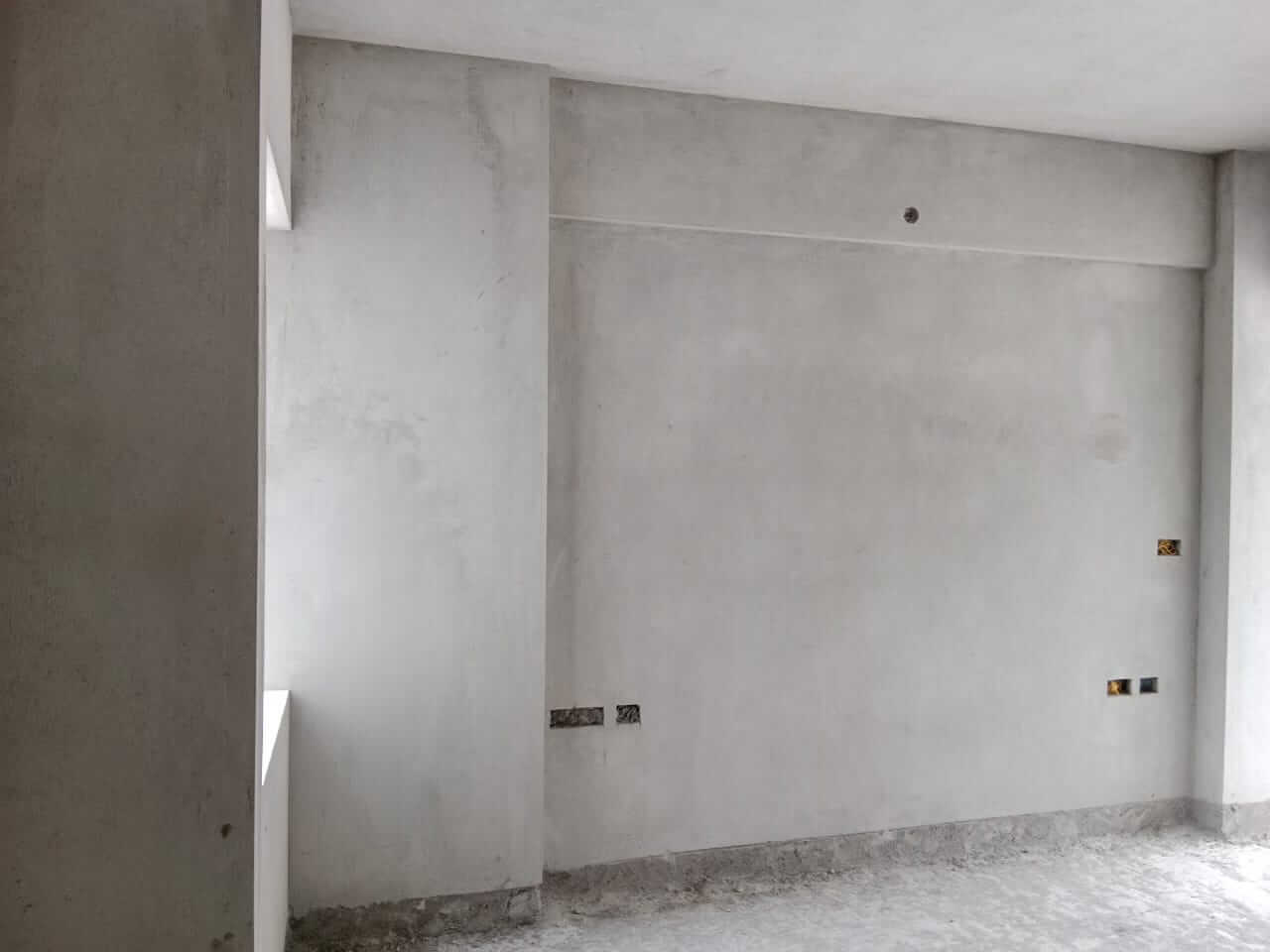

- INSIDE WALL PLASTERING – 68 APT OUT OF 93 COMPLETED.
- BALCONY HANDRAIL FIXING – 77 APT OUT OF 93 COMPLETED.
- ELECTRICAL WALL CHASING & BOX FIXING – 76 APT OUT OF 93 COMPLETED.
- WALL & FLOOR TILING COMPLETED IN MOCK UP APT- (1F)
- UPVC DOORS & WINDOWS FIXING COMPLETED IN MOCK UP APT – (1F)
- WALL PUTTY WORK – 40 APT OUT OF 93 COMPLETED
- APT INTERNAL PLUMBING WORK – 36 APT OUT OF 93 COMPLETED

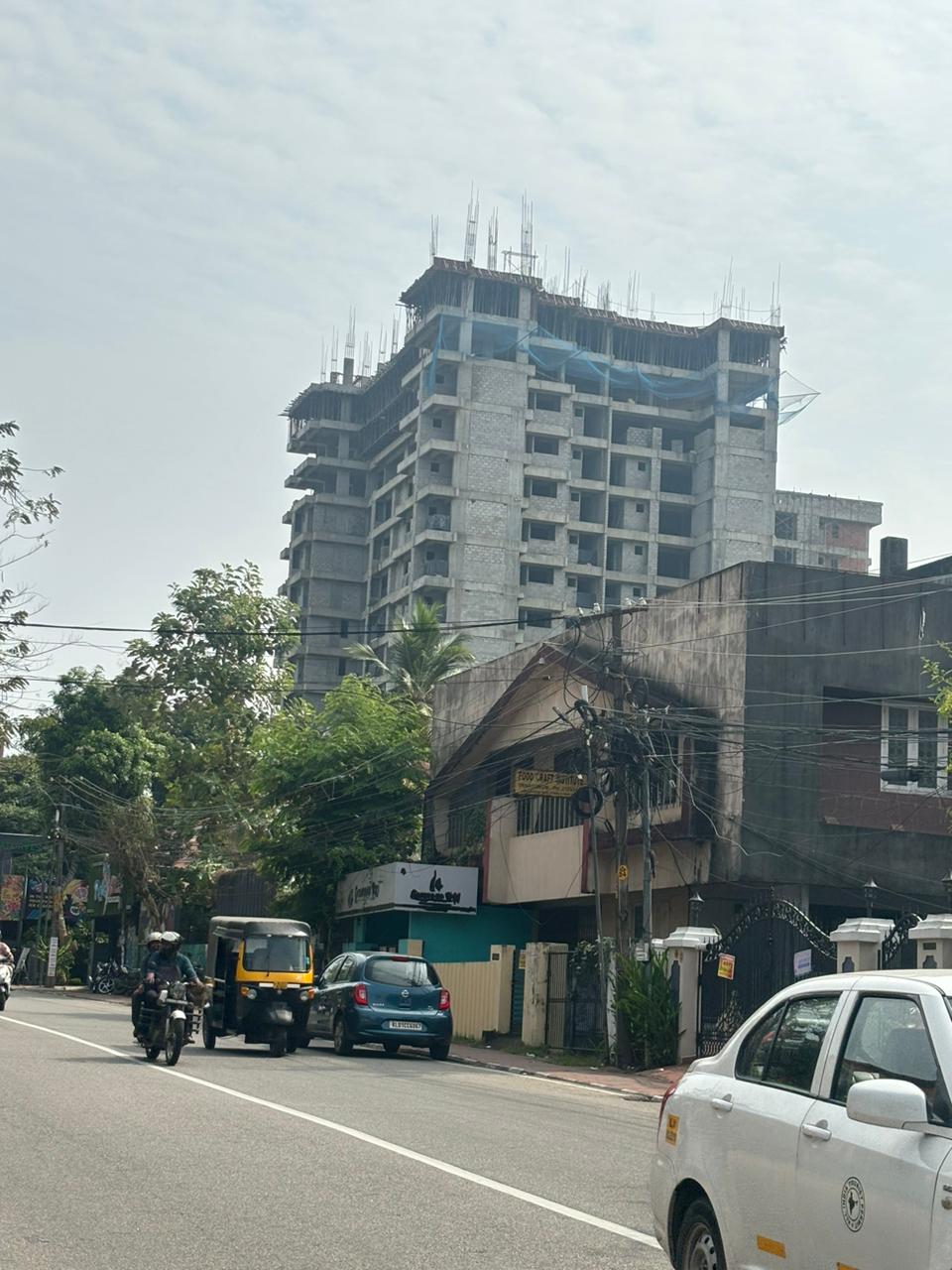

PROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 12.02.2024
- RCC FOR 15TH FLOOR SLAB – 100% COMPLETED
- COLUMN WORK FOR 15TH TO 16TH FLOOR –50% COMPLETED
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 75 APT OUT OF 93 COMPLETED
- CEILING PLASTERING -76 APT OUT OF 93 COMPLETED
- INSIDE WALL PLASTERING – 54 APT OUT OF 93 COMPLETED.
- BALCONY HANDRAIL FIXING – 55 APT OUT OF 93 COMPLETED.
- ELECTRICAL WALL CHASING & BOX FIXING – 66 APT OUT OF 93 COMPLETED.
- WALL & FLOOR TILING COMPLETED IN SAMPLE APT – (1F)
- UPVC DOORS & WINDOWS FIXING COMPLETED IN SAMPLE APT – (1F)
- WALL PUTTY WORK – 26 APT OUT OF 93 COMPLETED
- APT INTERNAL PLUMBING WORK – 22 APT OUT OF 93 COMPLETED
PROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 30.12.2023
- RCC FOR 14TH FLOOR SLAB – 100% COMPLETED
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 66 OUT OF 93 COMPLETED
- CEILING PLASTERING – 71 OUT OF 93 COMPLETED
- INSIDE WALL PLASTERING – 40 OUT OF 93 COMPLETED.
- BALCONY HANDRAIL FIXING – 54 OUT OF 93 COMPLETED.
- ELECTRICAL WALL CHASING & BOX FIXING – 48 OUT OF 93 COMPLETED.
- WALL & FLOOR TILING COMPLETED IN SAMPLE APT – (1F)
- UPVC DOORS & WINDOWS FIXING COMPLETED IN SAMPLE APT – (1F)
- WALL PUTTY WORK – 10 OUT OF 93 COMPLETED
- APT INTERNAL PLUMBING WORK – 12 OUT OF 93 COMPLETED
PROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 24.11.2023

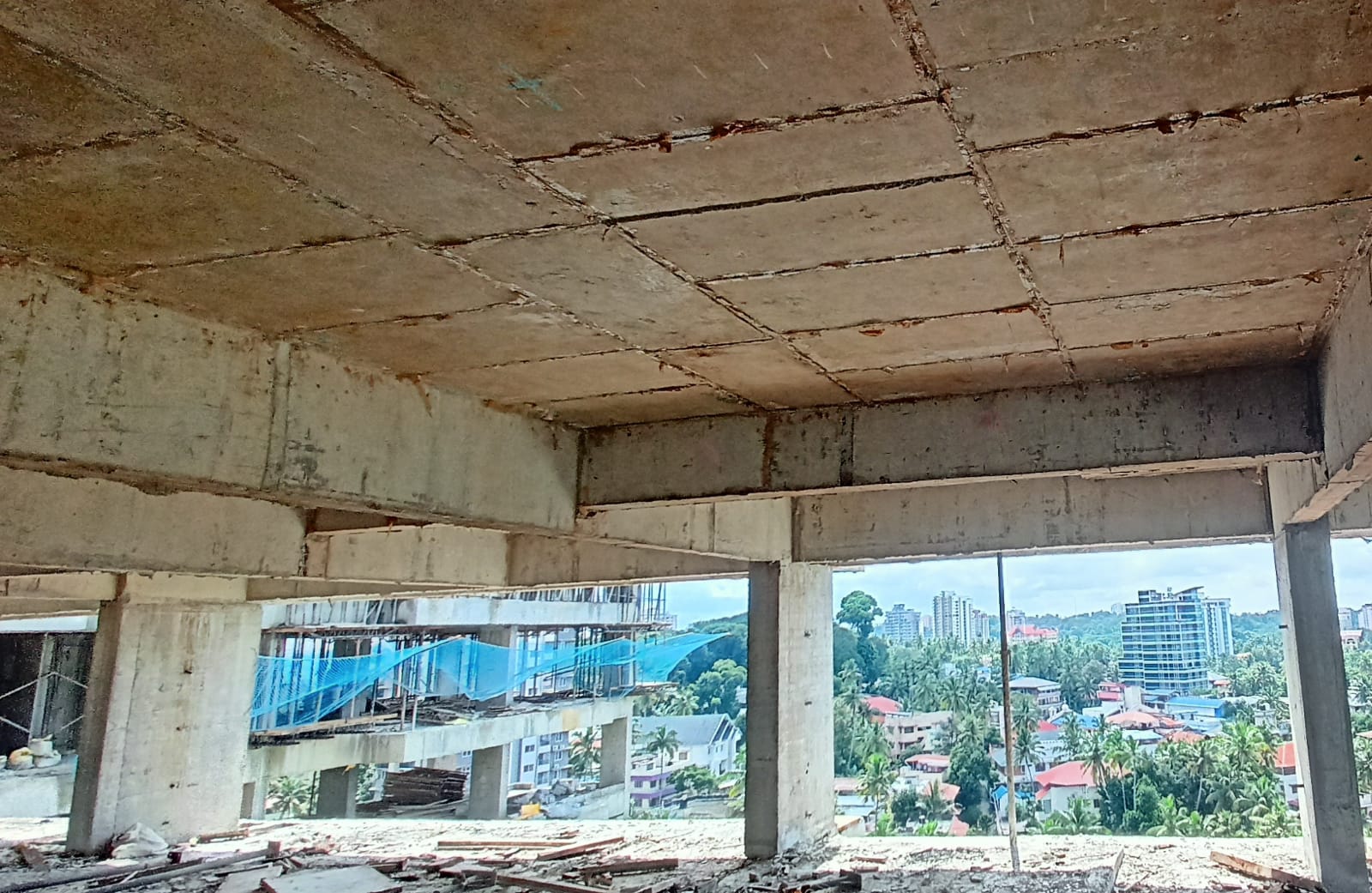

- RCC FOR 12TH FLOOR SLAB – 100% COMPLETED
- COLUMN WORK FOR 12TH TO 13TH FLOOR – 100% COMPLETED
- FORMWORK FOR 13TH FLOOR – 100% COMPLETED
- STEELWORK FOR 13TH FLOOR – 100% COMPLETED
- RCC FOR 13TH FLOOR – 60 % COMPLETED
- COLUMN WORK FOR 13TH TO 14TH FLOOR – 50% COMPLETED
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 57 OUT OF 93 COMPLETED
- CEILING PLASTERING – 69 OUT OF 93 COMPLETED
- INSIDE WALL PLASTERING – 28 OUT OF 93 COMPLETED.
- BALCONY HANDRAIL FIXING – 40 OUT OF 93 COMPLETED.
- ELECTRICAL WALL CHASING & BOX FIXING – 37 OUT OF 93 COMPLETED.
- WALL & FLOOR TILING COMPLETED IN SAMPLE APT – (1F)
- UPVC DOORS & WINDOWS FIXING COMPLETED IN SAMPLE APT – (1F)
- WALL PUTTY WORK – 7 OUT OF 93 COMPLETED
- APT INTERNAL PLUMBING WORK – 15 OUT OF 93 COMPLETED

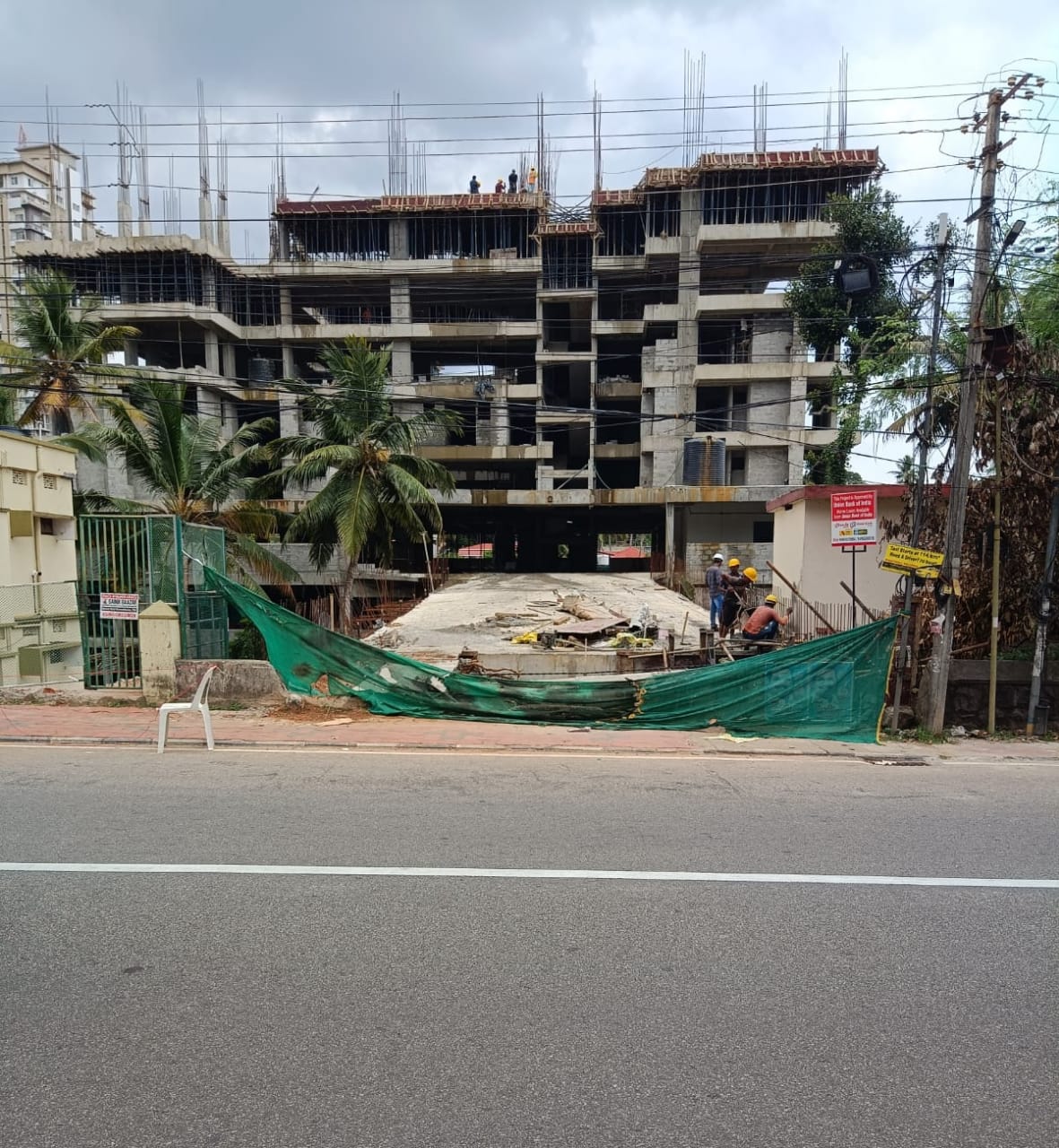

PROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 25.09.2023
- RCC FOR 10TH FLOOR SLAB – 100% COMPLETED
- COLUMN WORK FOR 10TH TO 11TH FLOOR – 100% COMPLETED

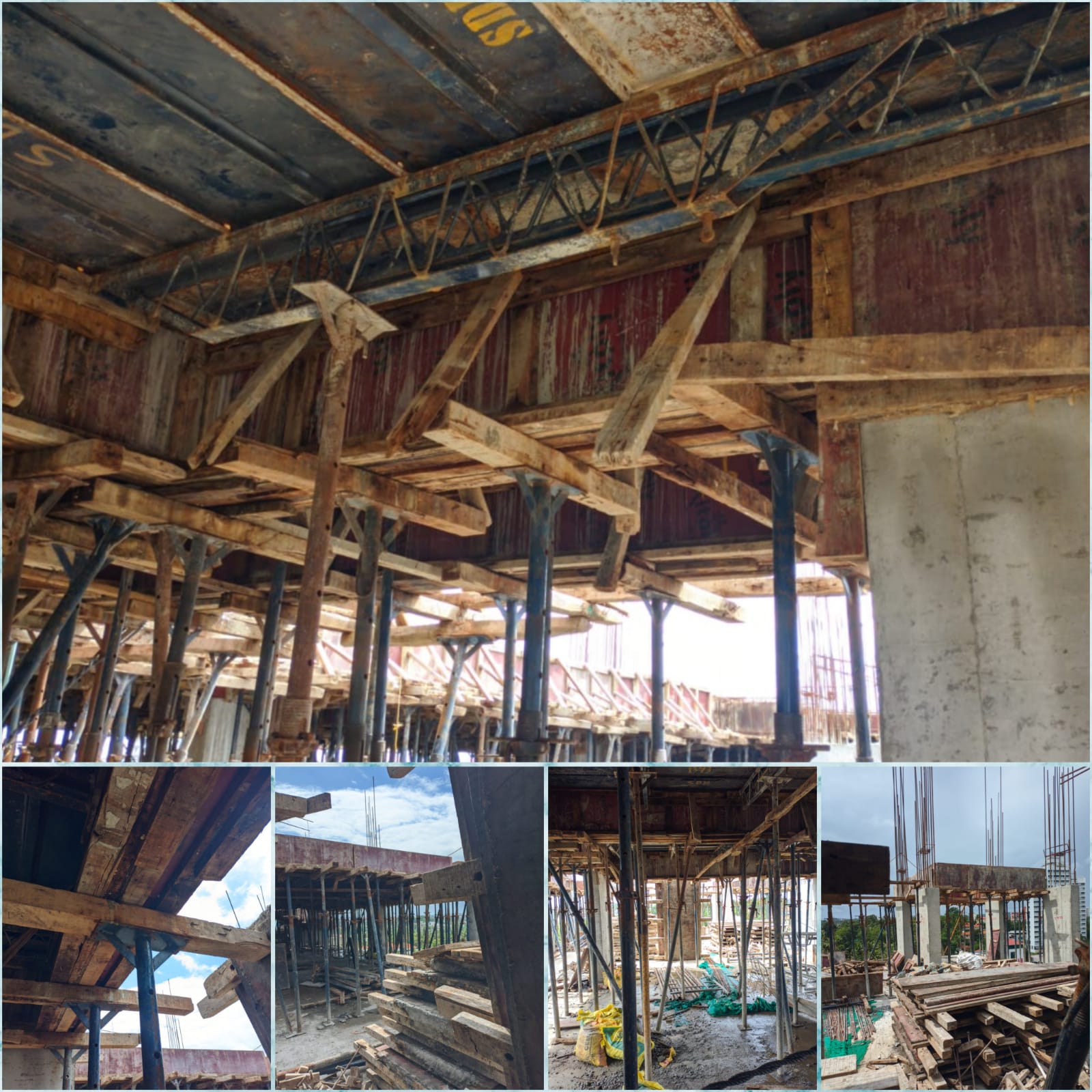

- FORMWORK FOR 11TH FLOOR – 100% COMPLETED

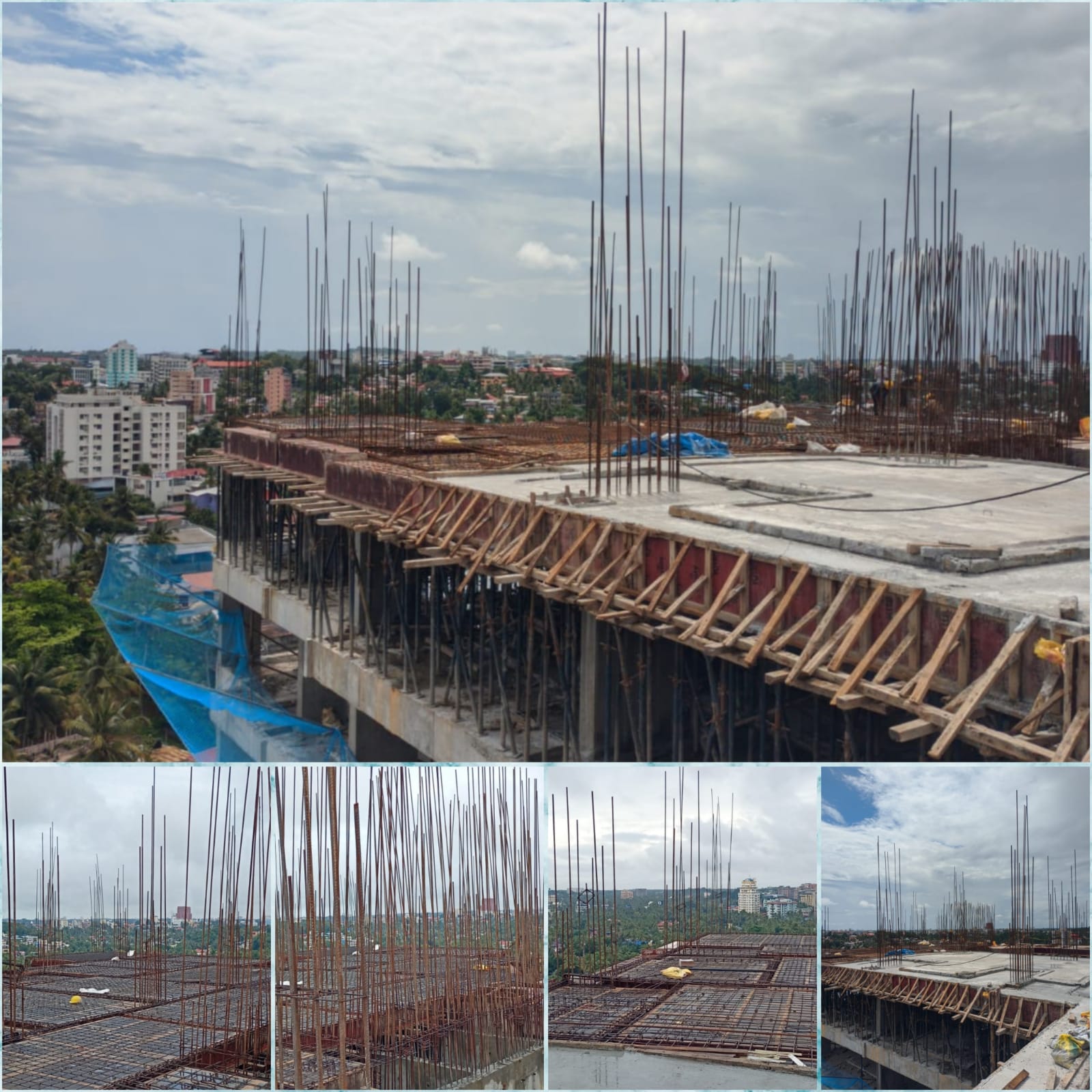

- STEELWORK FOR 11TH FLOOR – 80% COMPLETED
- RCC FOR 11TH FLOOR SLAB –30% COMPLETED

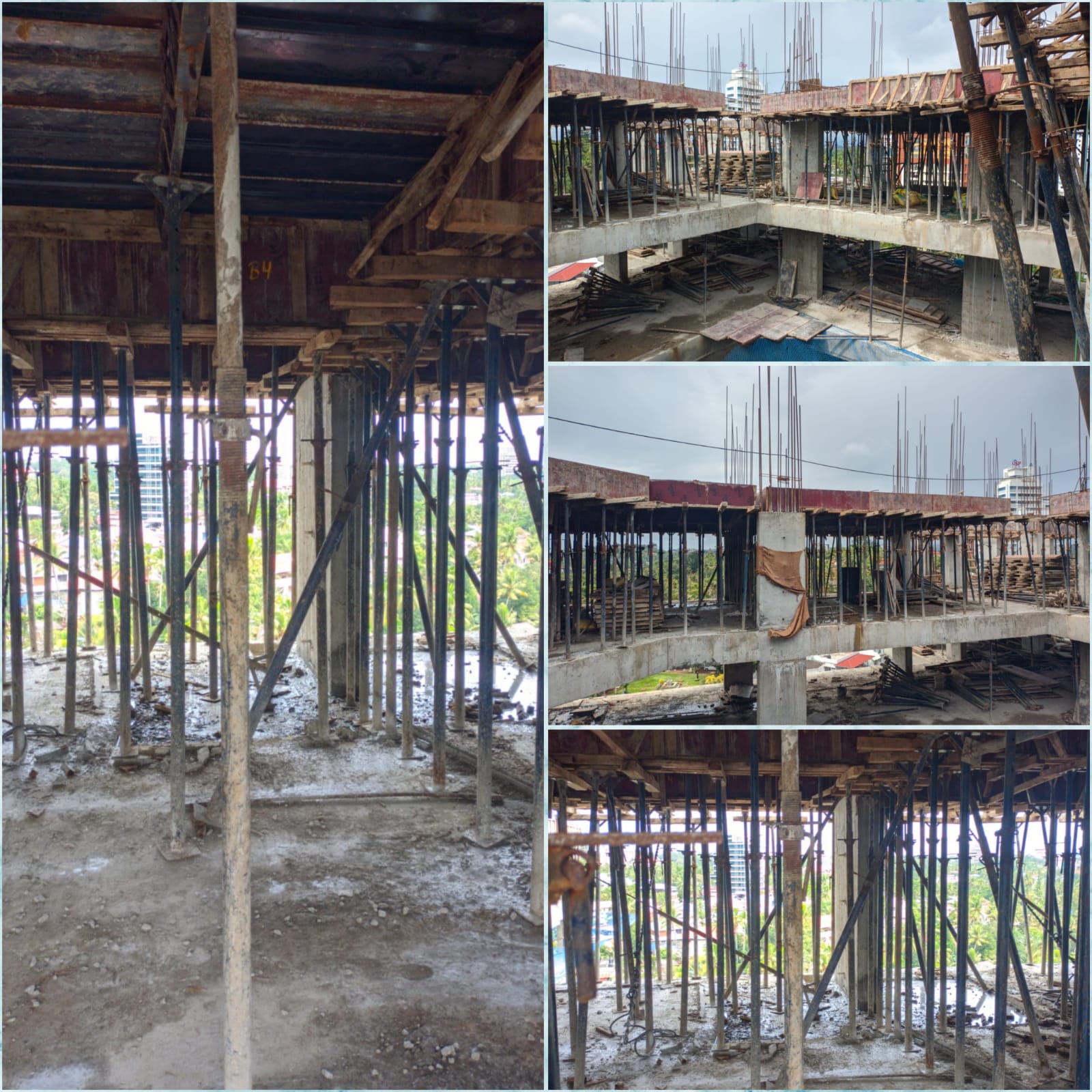

- COLUMN WORK FOR 11TH TO 12TH FLOOR -12 out of 5
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 42 APT OUT OF 93 COMPLETED
- CEILING PLASTERING – 54 APT OUT OF 93 COMPLETED
- INSIDE WALL PLASTERING – 8 APT OUT OF 93 COMPLETED.
- BALCONY HANDRAIL FIXING – 19 APT OUT OF 93 COMPLETED.
- ELECTRICAL WALL CHASING & BOX FIXING – 11 APT OUT OF 93 COMPLETED.
- TOILET WALL TILING STARTED IN SAMPLE APT (1F)
PROJECT STATUS REPORT OF AI BY SREEDHANYA AS OF 11.08.2023
- RCC FOR 8TH FLOOR SLAB – 100% COMPLETED
- COLUMN WORK FOR 8TH & 9TH FLOOR – 100% COMPLETED
- FORMWORK FOR 9TH FLOOR – 90% COMPLETED

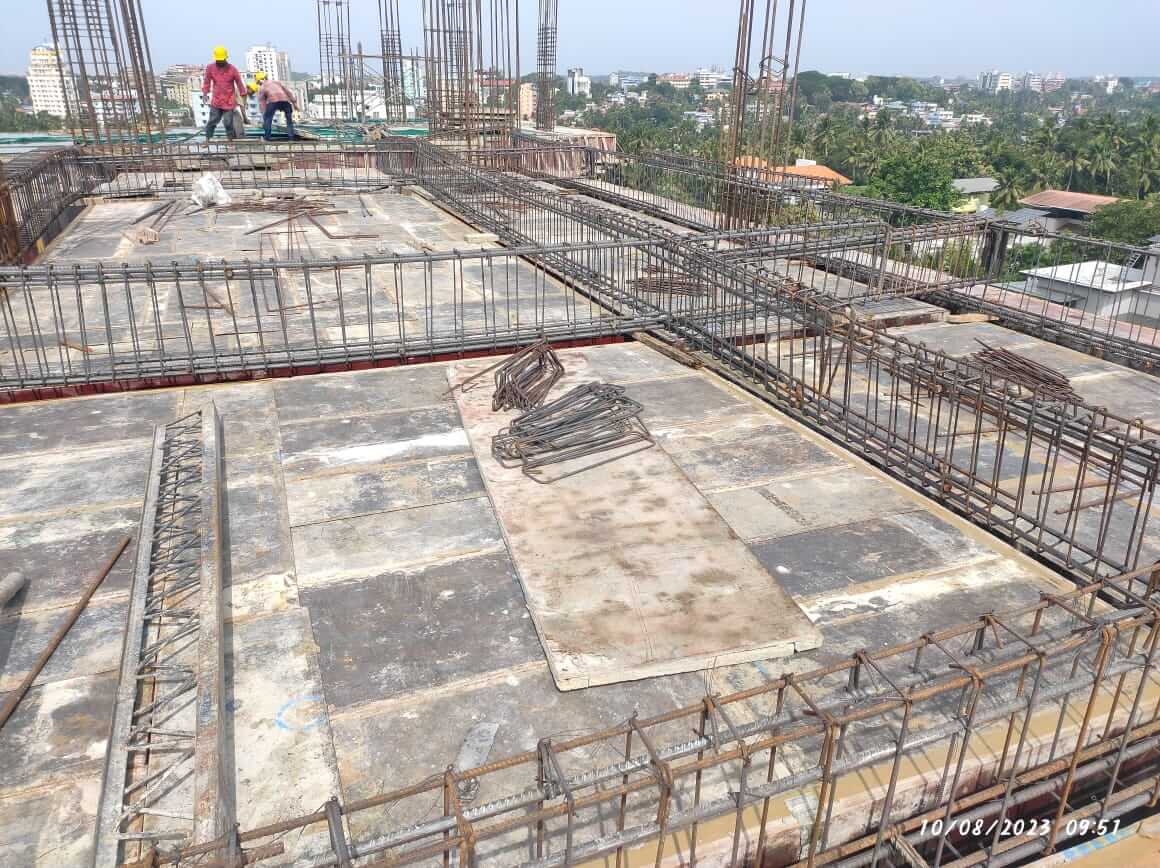

- STEELWORK FOR 9TH FLOOR – 80% COMPLETED

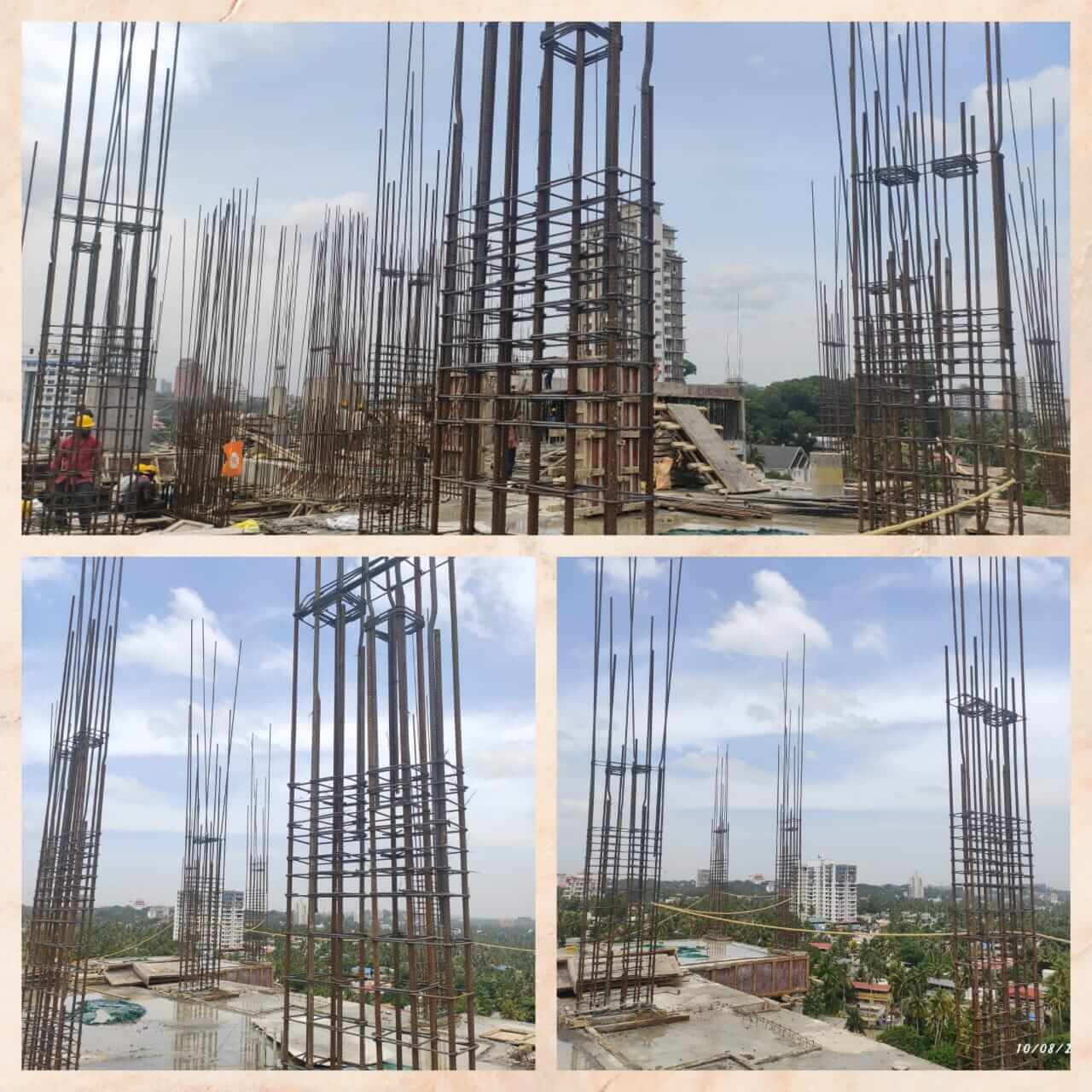

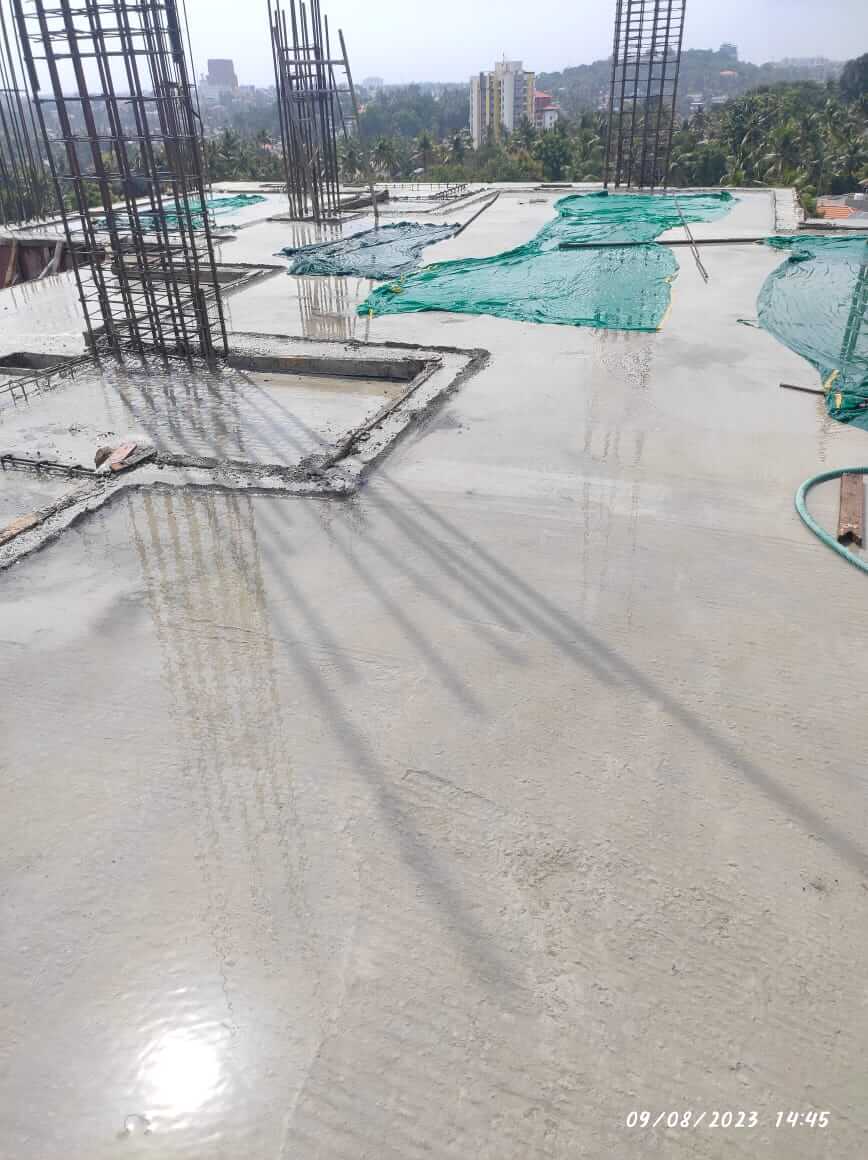

- RCC FOR 9TH FLOOR SLAB – 40% COMPLETED
- COLUMN STEELWORK FOR 9TH TO 10TH STARTED AND 3 COMPLETED
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 26 APT OUT OF 93 COMPLETED
- CEILING PLASTERING – 29 APT OUT OF 93 COMPLETED
- INSIDE WALL PLASTERING – 3 APT OUT OF 93 COMPLETED.
- BALCONY HANDRAIL FIXING – 12 APT OUT OF 93 COMPLETED.
- ELECTRICAL WALL CHASING & BOX FIXING – 4 APT OUT OF 93 COMPLETED.
PROJECT STATUS REPORT OF AI BY SREEDHANYA AS ON 14.06.2023
- RCC FOR 5TH FLOOR SLAB – 100% COMPLETED
- FORM WORK FOR 6TH FLOOR SLAB – 100% COMPLETED
- STEEL WORK FOR 6TH FLOOR ROOF – 90% COMPLETED
- RCC FOR 6TH FLOOR SLAB – 80% COMPLETED
- UG SUMP WORK – 100% COMPLETED
- BLOCK WORK – 14 APT OUT OF 92 COMPLETED
- CEILING PLASTERING – 21 APT OUT OF 92 COMPLETED

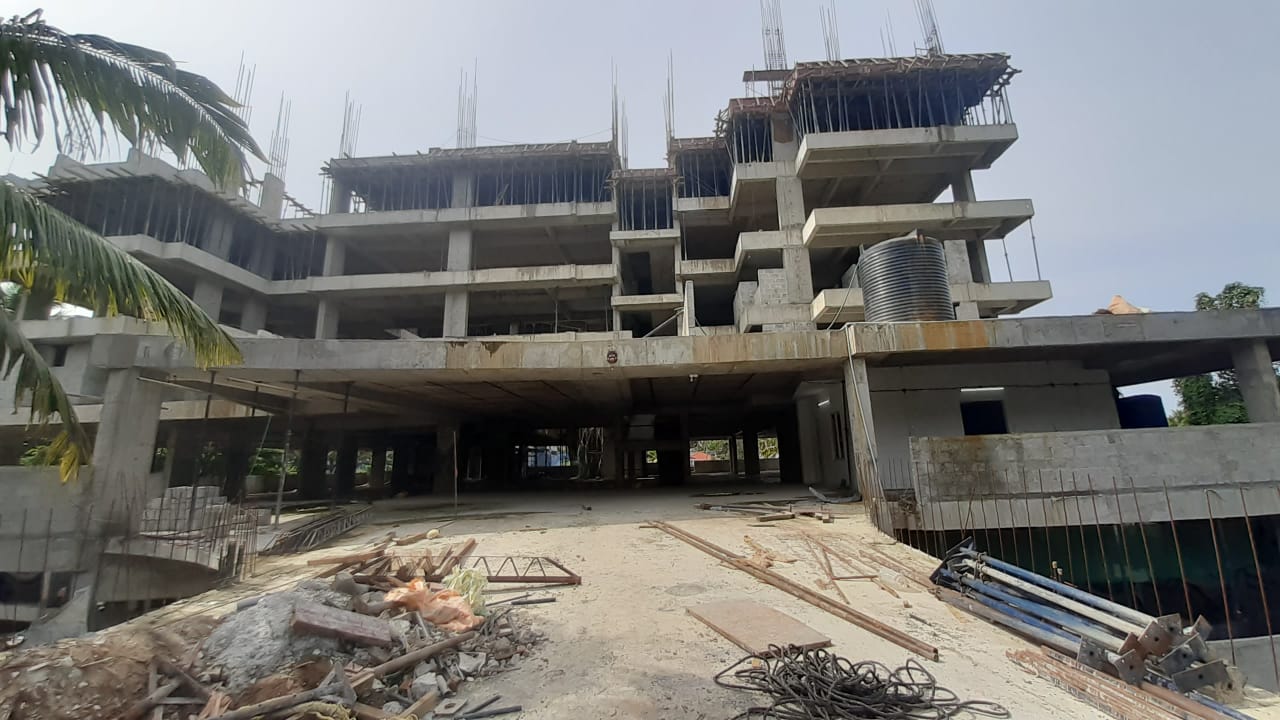

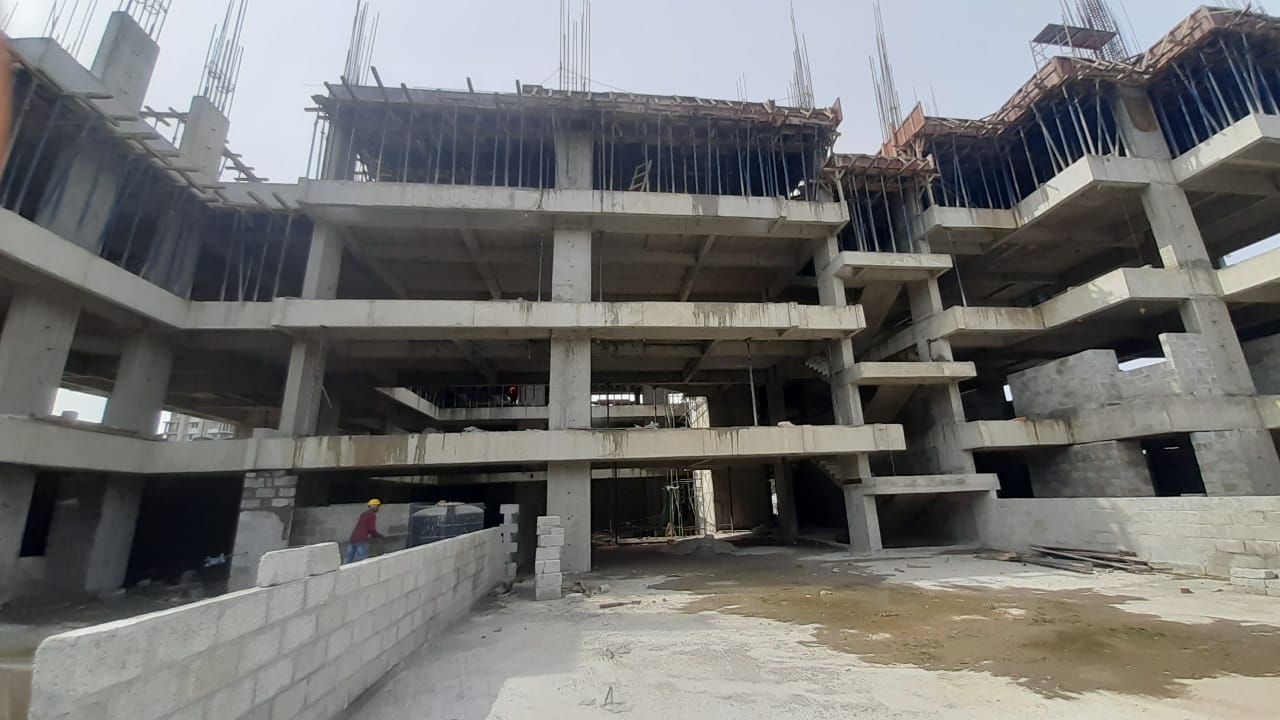

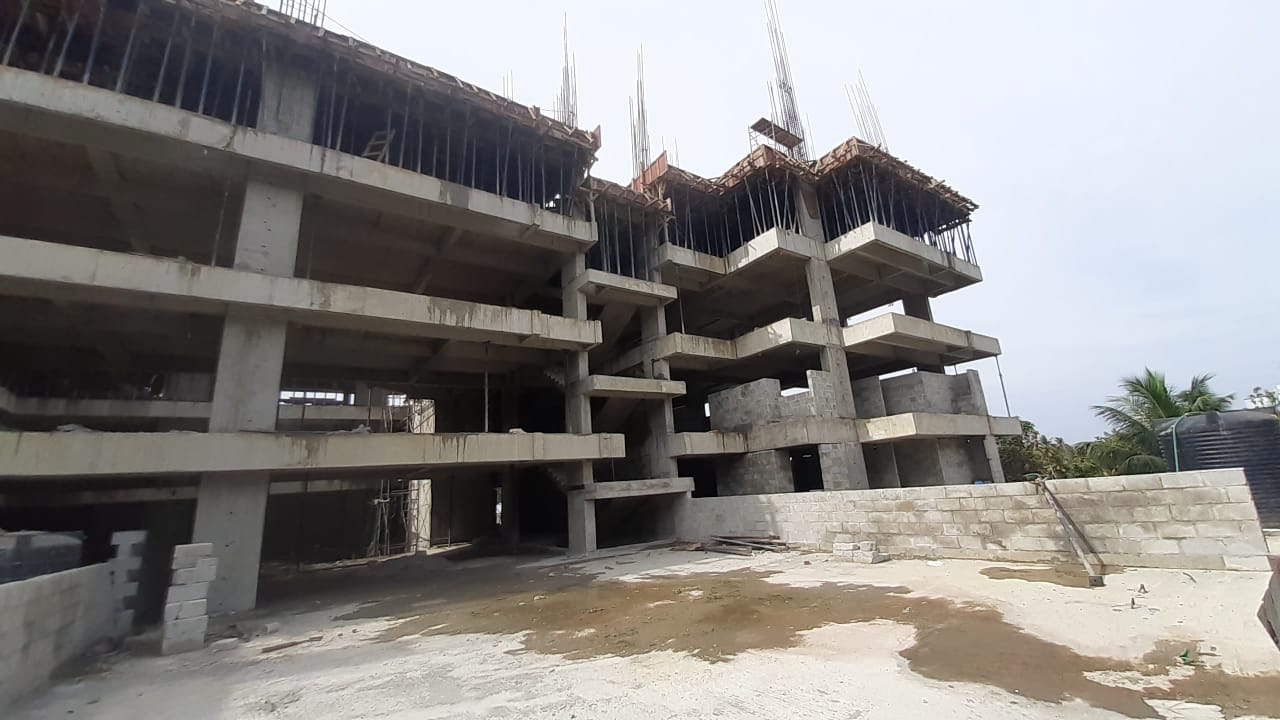

PROJECT STATUS REPORT OF AI BY SREEDHANYA AS ON 06.05.2023

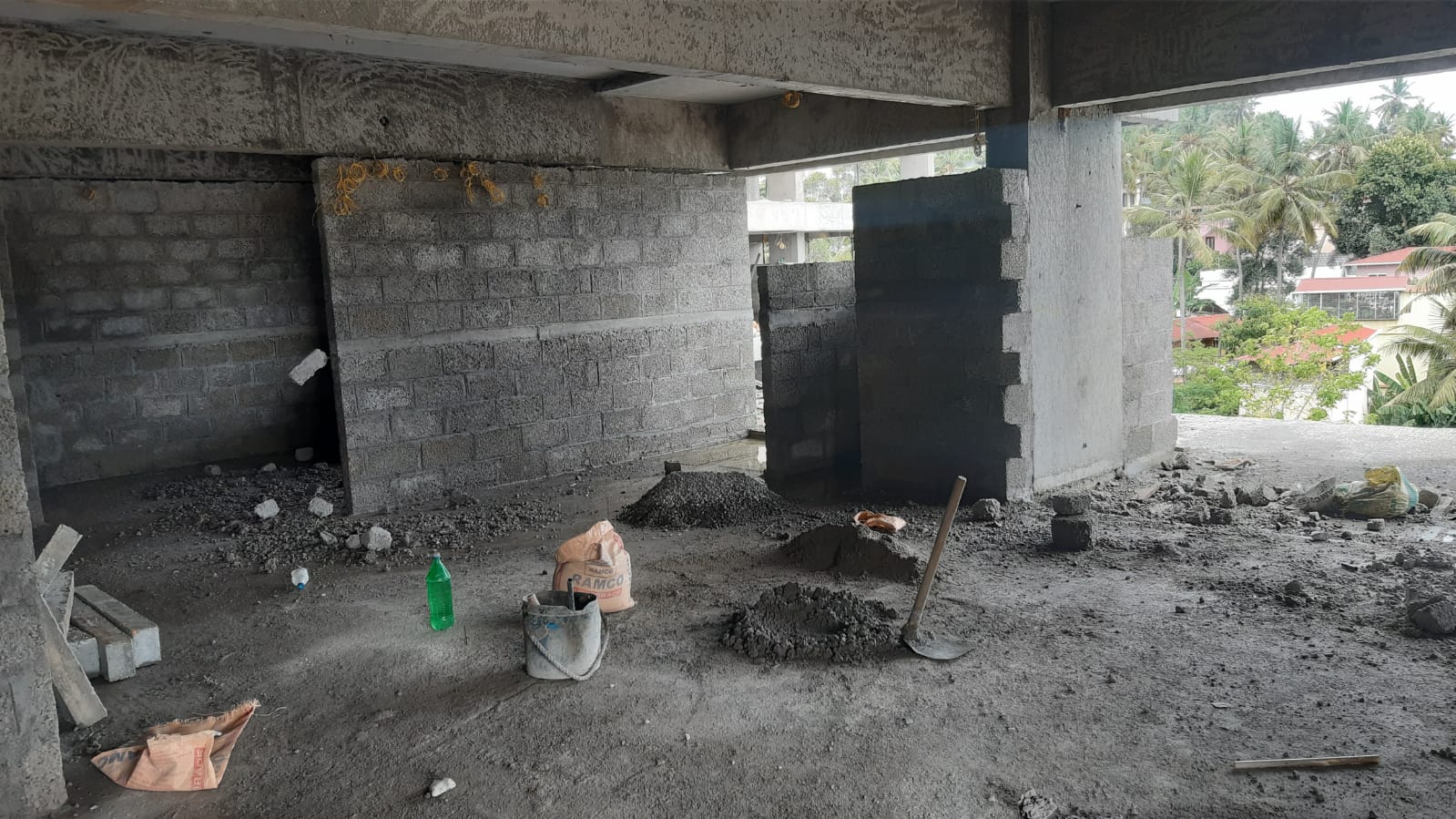

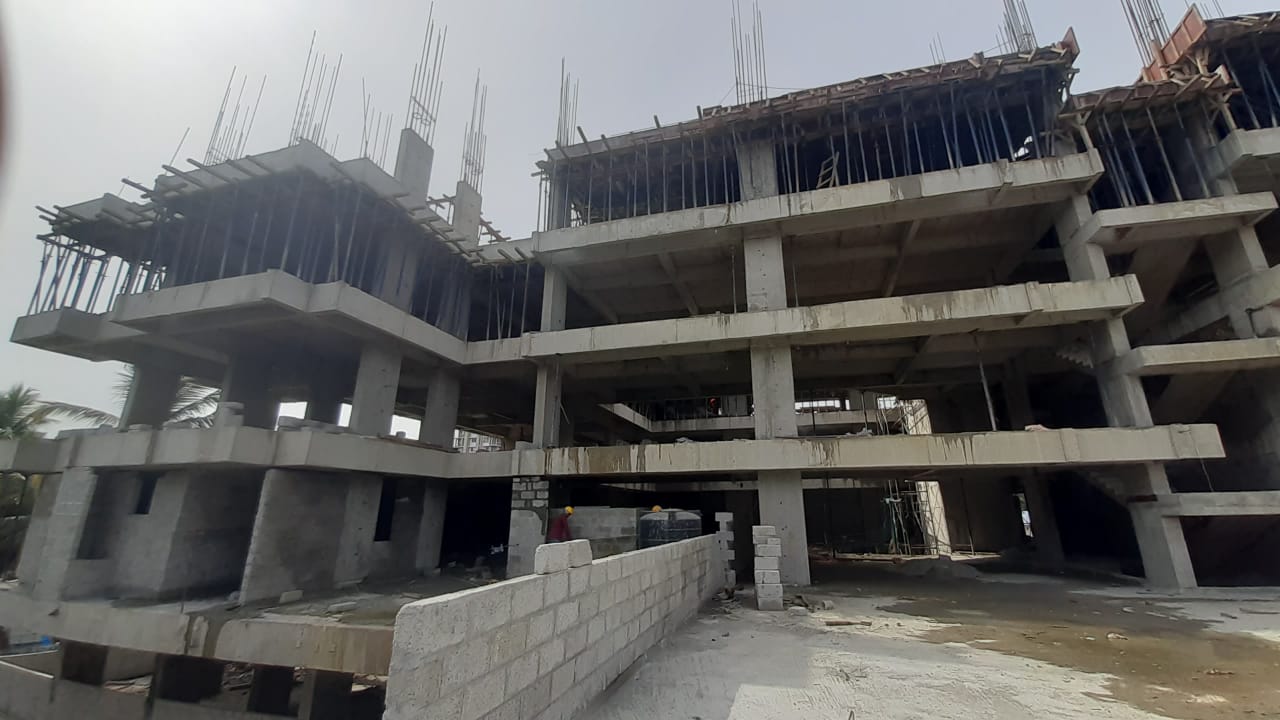

- RCC FOR 4TH FLOOR SLAB – 100% COMPLETED
- FORM WORK FOR 5TH FLOOR SLAB – 75% COMPLETED
- STEEL WORK FOR 2ND FLOOR ROOF – 60% COMPLETED
- RCC FOR 5TH FLOOR SLAB – 35% COMPLETED
- UG SUMP WORK – 70% COMPLETED
- BLOCK WORK – 7 APT OUT OF 92 APARTMENTS COMPLETED
- CEILING PLASTERING – 12 APT OUT OF 92 APARTMENTS COMPLETED
PROJECT STATUS REPORT OF AI BY SREEDHANYA AS ON 02.02.2023
- RCC FOR B2 FLOOR ROOF – 100% COMPLETED
- RCC FOR B1 FLOOR ROOF – 100% COMPLETED
- RCC FOR GROUND FLOOR ROOF – 100% COMPLETED
- RCC FOR COLUMN (FF TO 2ND FLOOR) – 20% COMPLETED
- FORM WORK FOR FIRST FLOOR ROOF – 5% COMPLETED
PROJECT STATUS REPORT OF AI BY SREEDHANYA, AS ON 20.12.2022
- RCC FOR COLUMN (BASEMENT -2 TO BASEMENT-1) -100% COMPLETED

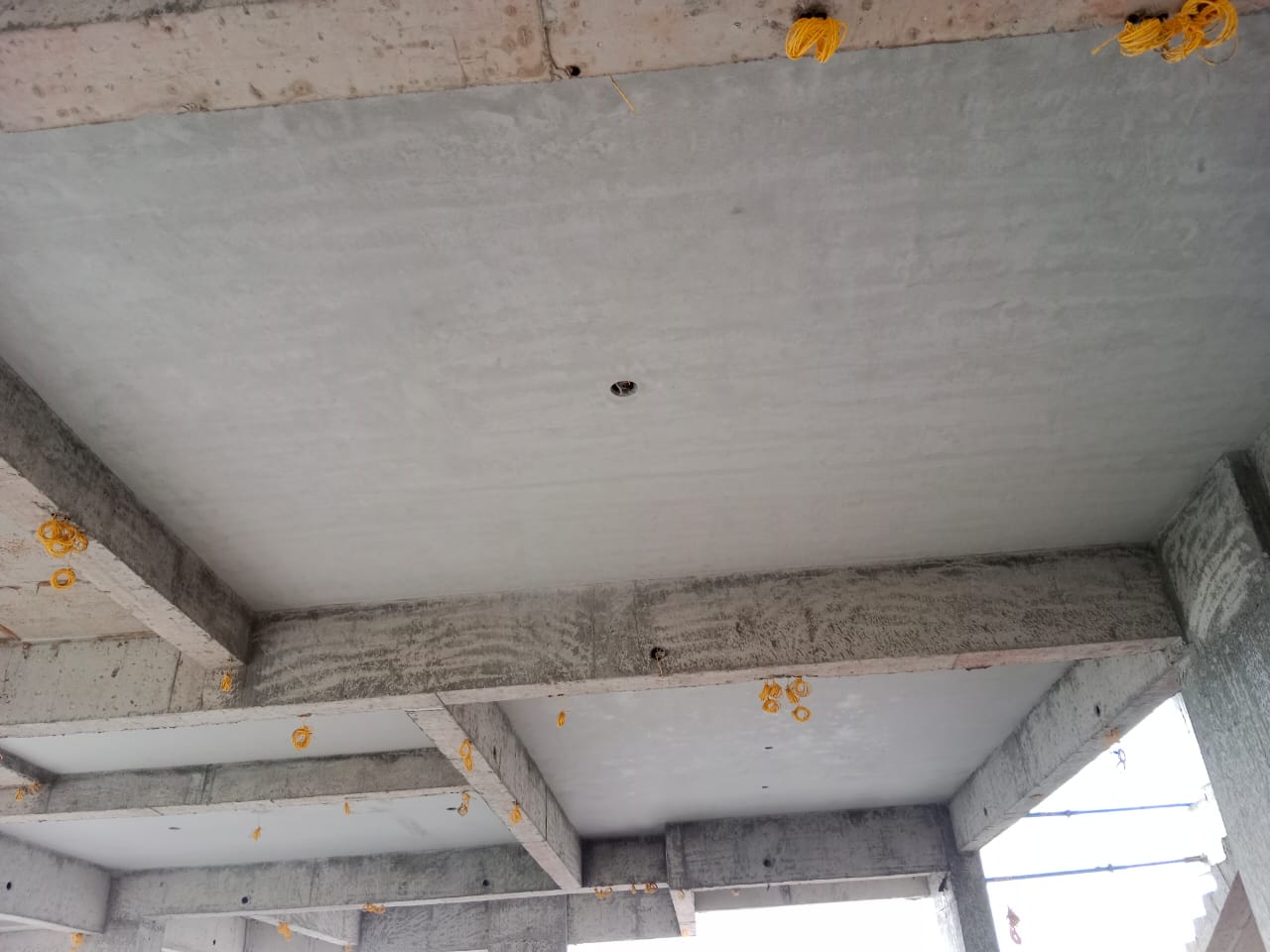

- RCC FOR BASEMENT-2 ROOF- 100% COMPLETED

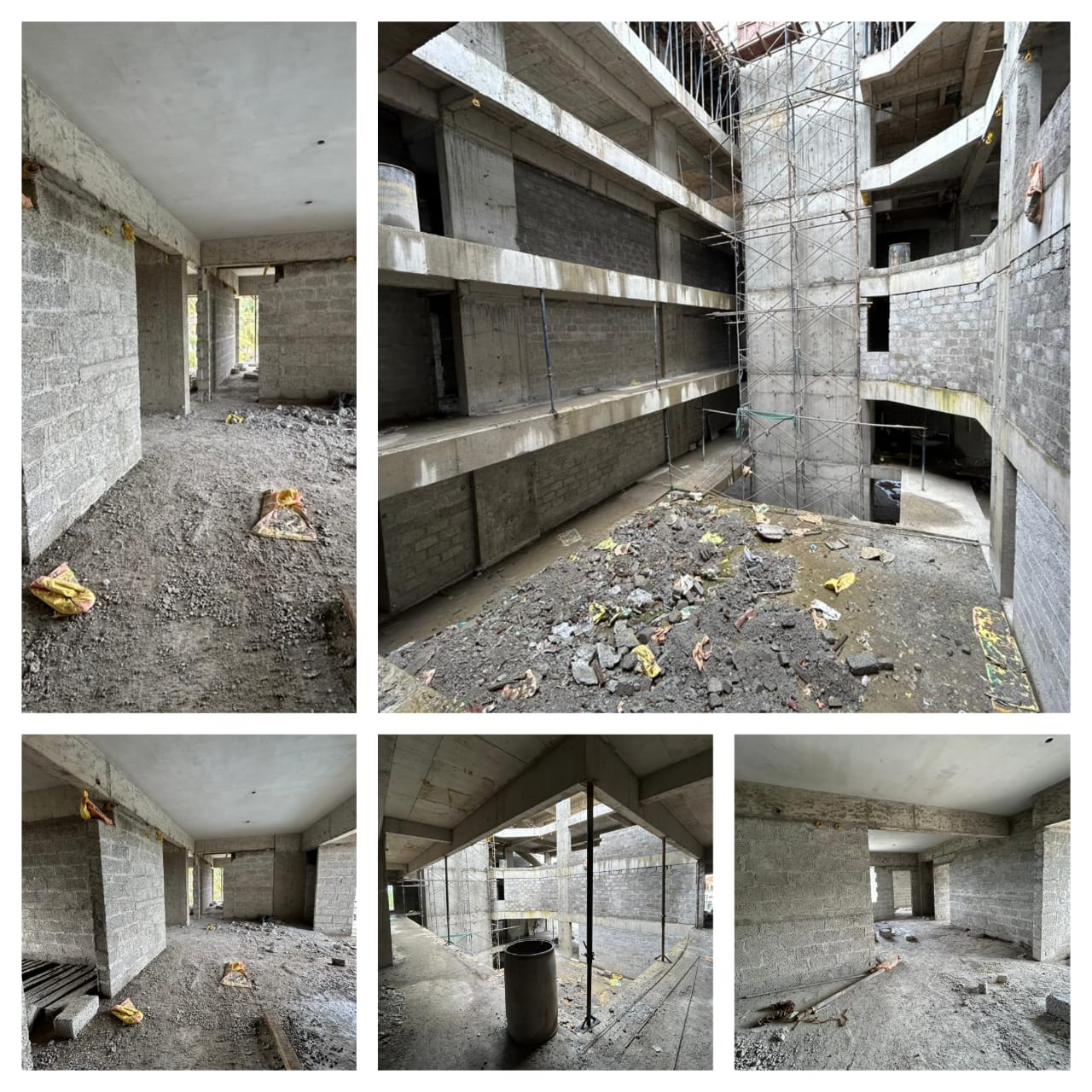

- FORM WORK FOR BASEMENT-1 ROOF – 95% COMPLETED

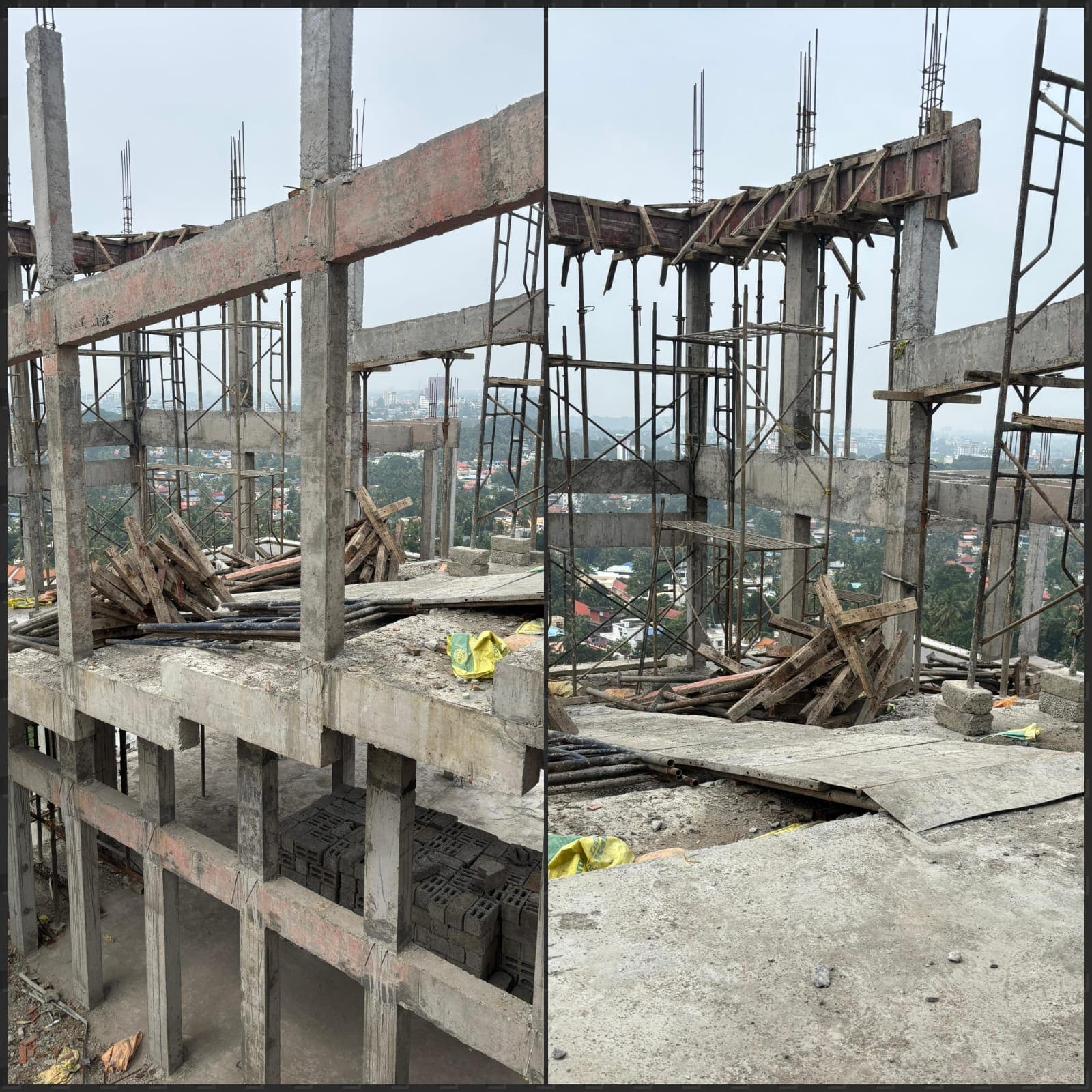

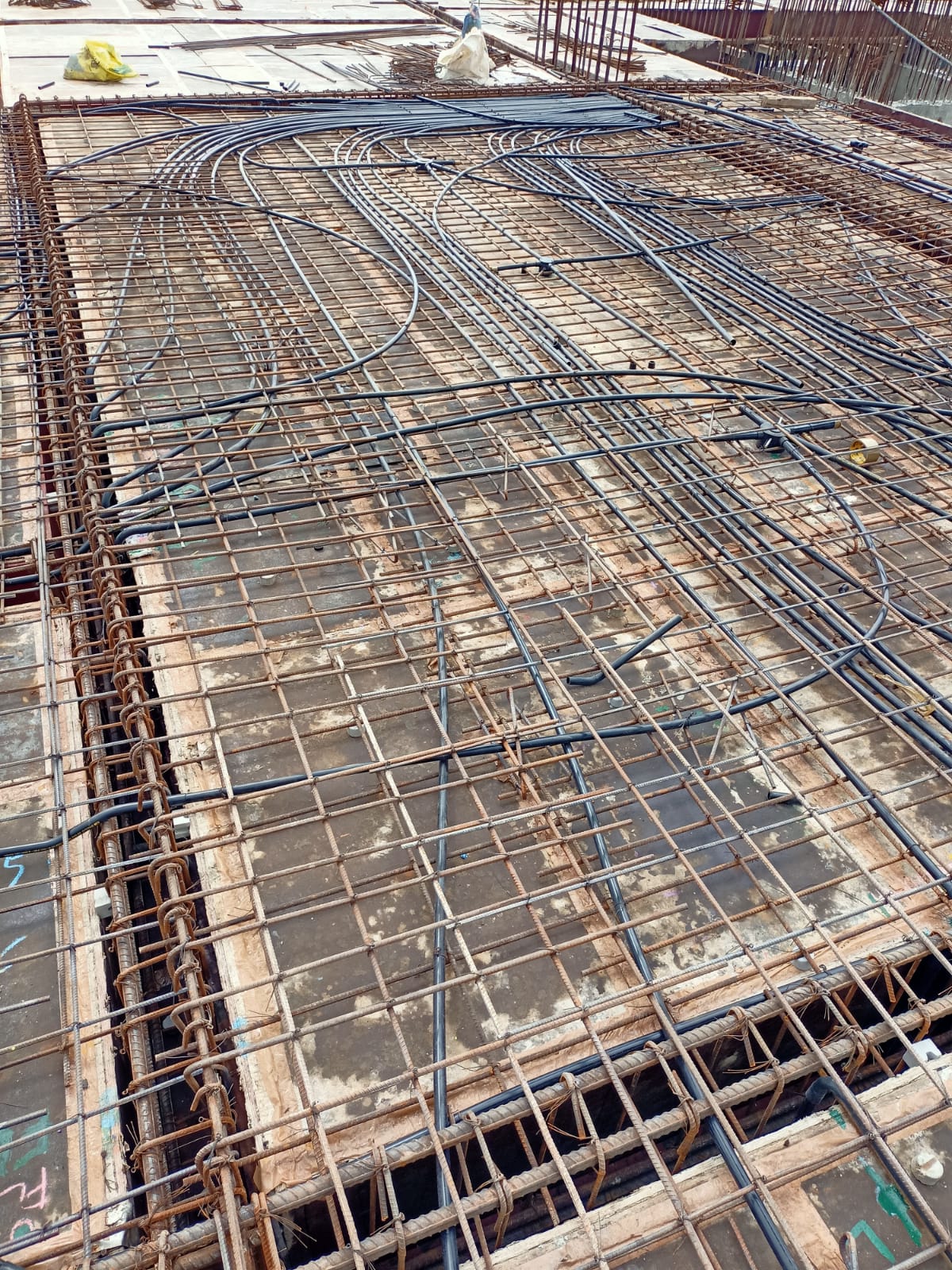

- STEEL WORK FOR BASEMENT 1 ROOF-80% COMPLETED

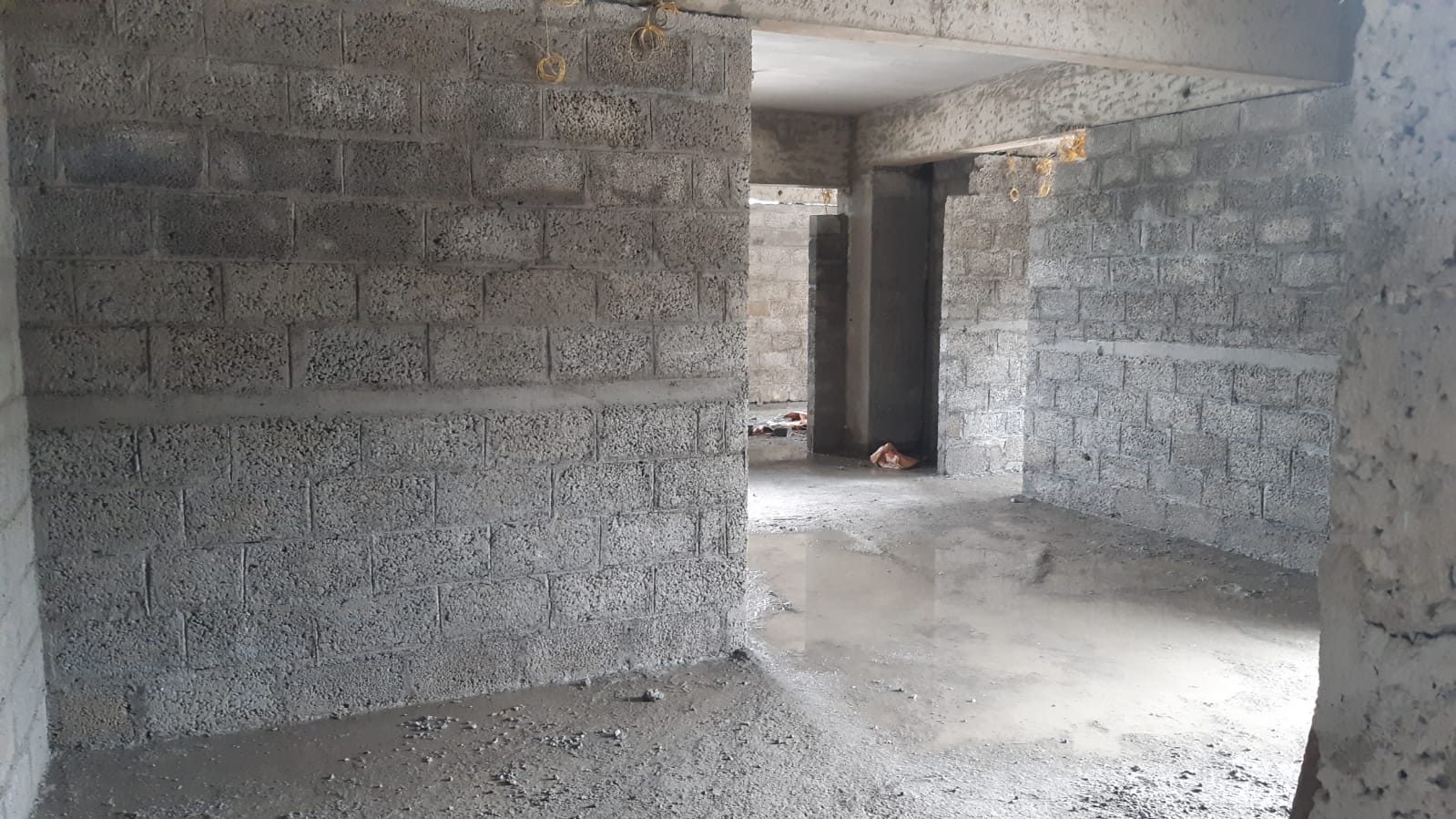

- RCC FOR BASEMENT-1 ROOF- 45% COMPLETED

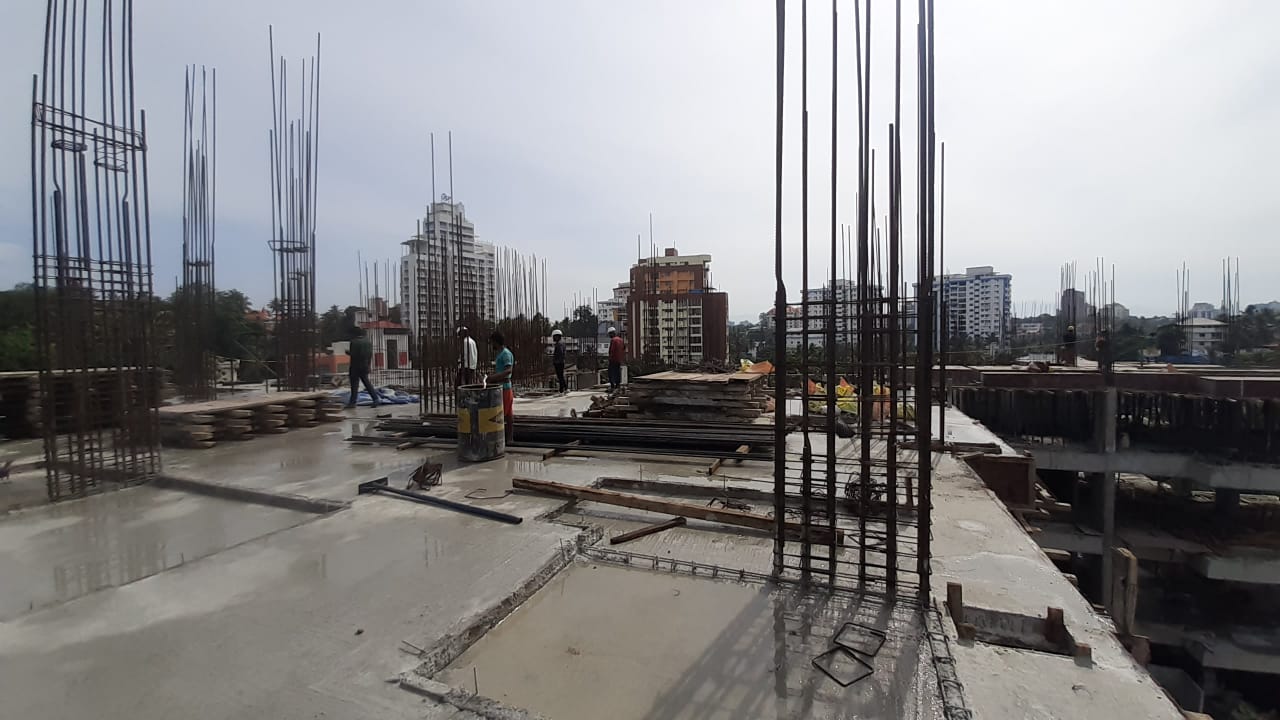

- RCC FOR COLUMN (GROUND TO FF ) -40% COMPLETED
